Data Centres · M&A

GCC Data-Centre M&A: Diligencing Power Rights, Tenant Options and Expansion Capacity

A GCC acquisition-diligence framework for converting power, lease and expansion claims into a capacity ledger, rights map, capex bridge and valuation waterfall.

GCC Data-Centre M&A: Diligencing Power Rights, Tenant Options and Expansion Capacity
Quick answer

Deal value becomes clearer when power rights, capacity states, tenant options, expansion dependencies and capex are reconciled in one acquisition model.

Abstract

Gulf Cooperation Council data-centre transactions combine real estate, regulated electricity, digital infrastructure, long-dated customer contracts and technology-intensive operating systems. Headline capacity can obscure material differences between a power application, a utility reservation, an executed connection agreement, energised capacity, commissioned IT load and capacity that is contractually occupied and producing collected cash.

Similar ambiguity affects expansion land, tenant options and capital expenditure. This paper develops an acquisition-diligence framework for buyers, sellers, infrastructure funds, sovereign investors, lenders and operators. It converts opaque power, lease and expansion claims into five linked schedules: a capacity ledger, a power-rights map, a tenant-option matrix, a capex-to-complete bridge and a rights-adjusted valuation waterfall.

The schedules create a common evidence base for commercial, legal, technical, financial, tax, regulatory, cyber and operational workstreams. Current authoritative evidence supports the need for this approach. The International Energy Agency reports that global data-centre electricity use was about 415 terawatt-hours in 2024 and projects around 945 terawatt-hours in 2030; it also estimates that grid constraints could delay a material share of planned projects.

Dubai Electricity and Water Authority's 2025 guidance requires major projects to identify data-centre load, expected maximum demand and realistic phasing. Abu Dhabi and Saudi electricity codes define connection, operating and information obligations. Listed operators disclose that capacity, leasing, development, technology transition and power availability affect operating and development value. UAE and Saudi competition rules add transaction-specific review requirements.

The central conclusion is that an acquirer should purchase evidenced rights and controlled cash rather than a marketing description of future megawatts. Every capacity claim should connect to an enforceable right, funded delivery path, technical acceptance state, tenant obligation and model line. Missing or conditional links should be resolved through price, conditions precedent, covenants, holdbacks, indemnities, earn-outs, seller completion obligations or exclusion from value.

All capacities, prices, probabilities, capital costs, yields, discounts, timelines and valuation amounts in worked examples are hypothetical modelling assumptions used to demonstrate the method. They are not forecasts, appraisals, offers or descriptions of an identified transaction. A live acquisition requires current site-specific legal, competition, regulatory, technical, environmental, cyber, insurance, accounting, tax, valuation and financing advice.

JEL Classification: G24, G31, G32, G34, L86, L94, Q48

Keywords: GCC, data centres, mergers and acquisitions, power rights, tenant options, expansion capacity, due diligence, valuation, digital infrastructure

This Matchpoint Insight presents the web edition of Matchpoint Partners' research. The supporting paper contains the full framework, structures, worked examples and source material.

Read the full research paper   Explore our None practice

1. Define the asset being acquired

A data-centre acquisition can involve shares in an operating company, property companies, a development platform, individual sites, customer contracts, utility rights, equipment, intellectual property, employees and operating licences. These elements can sit in different legal entities and jurisdictions. The first diligence task is therefore to define the transaction perimeter and trace each source of value to the entity and contract that controls it.

The perimeter should distinguish owned land, leased land, subleases, easements, buildings, substations, generation assets, network routes, cooling and water assets, customer agreements, licences, software, operating data and development rights. It should also identify joint ventures, minority interests, related-party arrangements and services supplied by the seller after closing. A capacity claim held by an excluded affiliate should not enter the buyer's valuation without a binding transfer or replacement arrangement.

The operating model matters. Retail colocation, wholesale capacity, hyperscale build-to-suit, enterprise hosting and sovereign cloud can use similar physical infrastructure while producing different contract terms, fit-out obligations, concentration, margins and renewal risk. A buyer should segment revenue and capacity by service rather than applying one portfolio multiple.

The deal team should create one transaction data model. Legal entities, sites, megawatts, customers, contracts, assets, capital expenditure and valuation lines need stable identifiers. This allows legal, technical, commercial and financial findings to reconcile. It also limits the risk that several workstreams count the same future capacity or overlook the same condition.

Property diligence should follow the same perimeter logic. The buyer should review title or lease term, permitted use, renewal, rent review, access, easements, utility corridors, mortgage or assignment restrictions, reinstatement, environmental liability and rights over substations, generators and rooftop equipment. Expansion land can support value only when the operating entity can use it for the intended duration and the required access and infrastructure rights survive closing. A long customer contract against a short or conditional property term creates a duration mismatch that should be resolved in the documents and model.

Shared services require a separation test. Network operations, security monitoring, procurement, billing, customer support, software licences, insurance and utility contracting can be provided centrally by the seller. The buyer should identify the people, systems, contracts, data and licences required to operate independently. A transition-services agreement should specify scope, service levels, cost, data access, cyber controls, termination assistance and the target operating model. The separation cost belongs in the purchase-price and integration bridge.

2. Build the capacity ledger before accepting headline megawatts

Capacity should be recorded as a sequence of evidence states. Requested capacity represents an application. Reserved capacity may depend on milestones, deposits and network work. Contracted capacity reflects an executed agreement but can remain subject to conditions. Energised capacity is available at the connection point. Commissioned capacity has passed required tests. IT load deducts facility use and technical constraints. Customer-committed capacity reflects enforceable contracts. Revenue-producing capacity has met acceptance, billing and collection rules.

The ledger should show gross and net measures. Utility supply, backup generation, uninterruptible power supply, cooling, power-usage effectiveness and redundancy determine the IT load that can be sold. A site marketed at 100 megawatts of utility supply may support a different billable IT load depending on design and operating conditions. The ledger should identify the measurement basis for every number.

Timing is part of capacity. Each row requires the current state, next milestone, responsible party, evidence, required spend, earliest credible date and downside date. DEWA's 2025 major-project guidance specifically asks for total connected load, expected maximum demand and realistic power phasing, including data-centre load. That discipline is equally useful in M&A because value can depend on when capacity becomes usable and billable.

The ledger should reconcile three reporting systems. Engineering records describe physical and commissioned capacity. Commercial records describe reserved, contracted and billable capacity. Finance records describe recognised revenue, invoices and collections. Differences should remain visible. A hall can be technically commissioned while customer acceptance is pending; a contract can reserve capacity that is not ready; an invoice can include power and services unrelated to one hall. The buyer should establish rules for allocating each contract and cash flow to the relevant site, phase and capacity block.

Portfolio totals should avoid aggregation traps. Capacity at different redundancy standards, voltages, cooling designs and readiness states cannot always be substituted. The buyer should tag the technical and contractual characteristics of each block before presenting a group total. A sale process that reports all future phases as one buildable number can create false comparability with an operator reporting only installed IT load. Comparable-company and precedent-transaction analysis should therefore use aligned definitions or disclose the remaining difference.

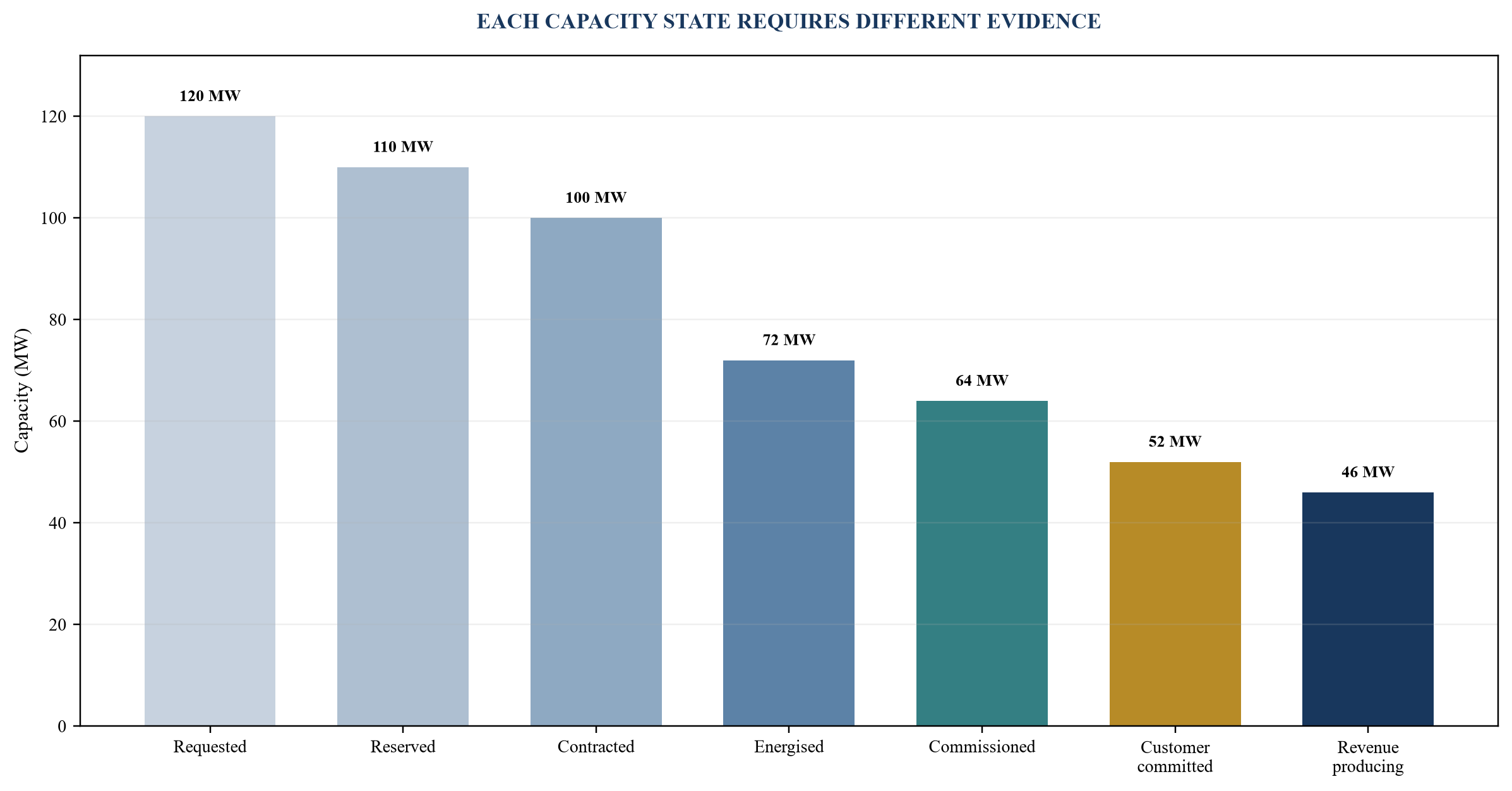

Figure 1. Capacity ledger from application to collected cash
Figure 1. Capacity ledger from application to collected cash

The evidence state narrows the capacity that can support purchase price; values are hypothetical.

Table 1. Minimum capacity-ledger fields

FieldRequired evidencePrincipal riskDeal treatment
site and phasetitle, lease, plan and entity mapcapacity outside perimetertransfer condition or exclusion
utility stateapplication, offer, agreement and invoiceheadline exceeds enforceable rightprobability weighting
delivery pathnetwork study, works, permits and schedulegrid or substation delayseller obligation or holdback
technical statedesign, tests, commissioning and incidentssupply cannot support billable IT loadcapex and availability adjustment
customer stateexecuted order, acceptance and billingreserved capacity lacks durable revenuecontract-specific value
expansion stateland, power, design, equipment and capitaloption presented as committed growthstage-gated value

Each row should link capacity, rights, technical state, customer use and value.

3. Map power rights as a chain of obligations

Power is a bundle of rights, obligations, assets and dependencies. The map begins with the applicant and utility, then traces the connection point, network reinforcement, substation, transformers, cables, protection, metering, backup, generation, storage and internal distribution. It records ownership, funding, construction, testing, operation and maintenance for each component.

The legal review should test whether the agreement is binding, transferable and durable through a change of control. It should identify long-stop dates, milestone obligations, deposits, security, termination, reduction, suspension, curtailment, force majeure, liability and dispute provisions. A buyer also needs the tariff basis, demand charges, escalation, taxes, connection costs and liabilities for reinforcement or relocation.

The technical review should reconcile the agreement with drawings, load studies, equipment ratings, redundancy, harmonic limits, power factor, protection settings, outage records and measured demand. Abu Dhabi's transmission and supply codes and the Saudi grid code establish technical and information obligations at connection points. Those rules make the operating state and compliance record part of the acquired right.

The commercial model should then translate the right into capacity, cost and timing. A low tariff with delayed energisation may have less value than available power at a higher price. A firm connection and a curtailable block should be modelled separately. Renewable certificates, behind-the-meter generation and power-purchase arrangements require separate ownership, volume, tenor, basis, curtailment and transfer tests.

Deposits and reinforcement payments need accounting and recovery analysis. A utility payment can be refundable, offset against future charges, non-refundable or forfeitable after a missed milestone. The buyer should reconcile payment evidence, balance-sheet classification, contractual status and forecast treatment. If the seller has capitalised costs that do not transfer or cannot support future service, they should not enter the acquired asset base without an explicit rationale.

Power quality and resilience also affect value. The review should capture historical interruptions, voltage events, protection trips, maintenance outages, generator tests, fuel arrangements, battery condition and single points of failure. Contractual redundancy labels should be tested against actual topology and operating procedures. The resulting service risk connects directly to tenant credits, renewal, insurance, capital expenditure and valuation.

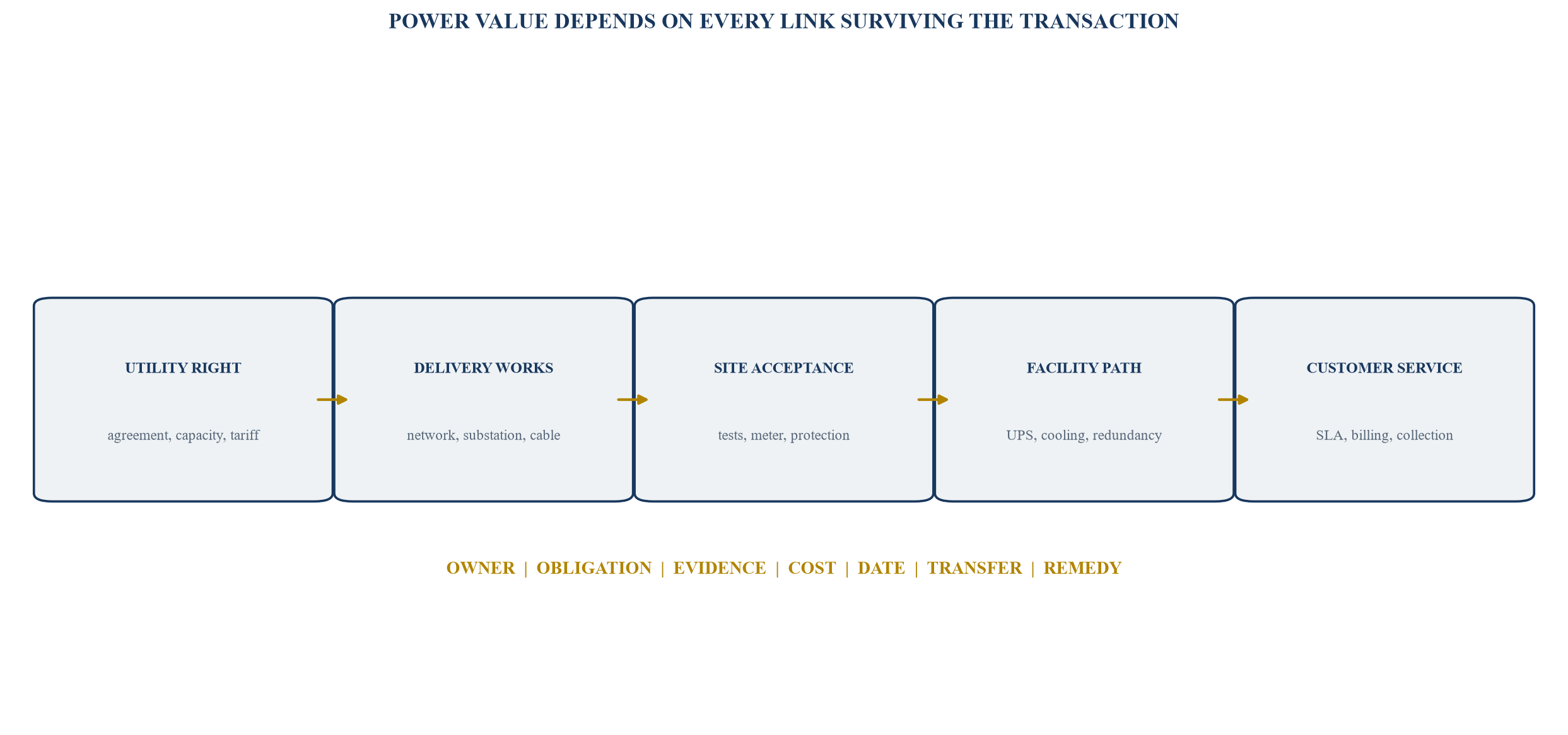

Figure 2. Power-rights map
Figure 2. Power-rights map

Value requires an enforceable and funded path from utility commitment to customer service.

4. Test transfer, change of control and security

An acquisition can change the legal, credit and operational facts on which a utility or landlord relied. The diligence list should identify every consent, notice, novation, licence amendment, lender approval, landlord waiver and government approval triggered by the proposed structure. Silence in a data room does not establish transferability.

Share and asset deals create different paths. A share acquisition may preserve the contracting entity while triggering change-of-control provisions. An asset acquisition can require assignment or novation of each right. A pre-closing reorganisation can create tax, licensing, security and continuity risks. The conditions-precedent schedule should identify the exact document, authority, filing date, dependency and closing consequence.

Existing financing can also restrict transfer. Security may attach to shares, land, receivables, utility deposits, equipment and bank accounts. The buyer needs a release and perfection sequence that preserves operational continuity. Where a utility or landlord has step-in or termination rights, intercreditor and direct agreements should be reviewed alongside the acquisition documents.

5. Read tenant contracts as option portfolios

A tenant agreement contains a base obligation and a set of options. Renewal can extend cash flow at fixed, indexed or market rent. Expansion can reserve scarce capacity or require the operator to build. Contraction can return capacity to the operator while reducing contracted revenue. Termination can depend on delay, service failure, law, convenience, change of control or a customer milestone. Rights of first offer or refusal can restrict future leasing or a sale.

The tenant-option matrix should record exerciser, notice window, capacity, price, capex, condition, probability basis and valuation treatment. It should also record assignment, parent guarantees, security deposits, service credits, set-off, data residency, step-in, equipment ownership, decommissioning and reinstatement. Options should be modelled from the contract language rather than a management summary.

Pricing options can be as important as capacity options. Fixed escalators, market resets, most-favoured-customer provisions, benchmarking, power caps and currency terms can change cash duration. A renewal at below-market pricing can be likely and still reduce expected value. A market-reset clause can support value while creating dispute or vacancy risk. The model should separate contractual price, current invoiced price, normalised price and the price assumed after each option date.

Customer credit support should be mapped to the obligation it secures. A parent guarantee may expire, cap liability or exclude expansion. A deposit may be available for unpaid invoices while fit-out or decommissioning liabilities remain unsecured. Letters of credit can have renewal and draw conditions. The buyer should reconcile security amount, issuer, expiry, beneficiary and transfer, then reflect any gap in the tenant-risk and closing plan.

Expansion rights deserve close attention. A customer may hold future capacity without paying full reservation economics. The operator may have to procure power, cooling and equipment before the customer commits. A priority right can block alternative tenants and reduce the marketability of expansion. Conversely, a creditworthy take-or-pay expansion can support financing and development value when acceptance and termination risks are controlled.

Table 2. Tenant-option matrix

OptionHolderEvidence to captureValue riskDiligence response
renewaltenant or mutualterm, notice, price and conditionsassumed continuation at uneconomic rentmodel exercise and non-exercise
expansiontenantMW, date, reservation fee, build dutycapacity blocked before commitmentprice reservation and capex
contractiontenantquantity, notice and chargesudden revenue and utilisation lossdownside cash case
terminationtenant or operatortrigger, cure, fee and survivalcash duration overstatedevent-specific probability
ROFR or ROFOtenantasset, capacity, process and durationexit or leasing process restrictedlegal and valuation adjustment
change of controltenantconsent, notice and remedyclosing or churn riskcondition, waiver or holdback

Valuation should reflect the party controlling each option and its contractual economics.

6. Reconcile contracted revenue to collected cash

Annualised contract value is not cash available to the acquirer. The bridge should begin with contracted base charges and remove free periods, ramp, service credits, power pass-through timing, disputed invoices, set-off, tax, bad debt, related-party revenue and amounts conditional on future acceptance. It should reconcile invoices to bank receipts and customer-level deferred or accrued balances.

Power revenue and cost require particular care. Some contracts pass through actual electricity cost; others use fixed rates, indices, mark-ups, caps or periodic resets. Demand charges and minimum utility payments can remain when a customer uses less capacity. The buyer should model gross and net power economics by contract and site, including losses, cooling and facility load.

Customer concentration should be measured by revenue, cash contribution, contracted MW, expiry, parent group and technology workload. A portfolio can appear diversified by legal customer count while remaining dependent on one economic group or cloud platform. Concentration affects renewal leverage, credit exposure, fit-out specificity and re-leasing cost.

7. Verify operating service and customer acceptance

Tenant value depends on service delivery. The technical review should analyse availability, incidents, maintenance, capacity constraints, power quality, cooling performance, security events and customer claims. Service-level calculations should reconcile to credits and correspondence. A site reporting high portfolio uptime can still have material hall-level or customer-level issues.

Acceptance documents determine when construction becomes revenue. The buyer should review commissioning procedures, integrated systems tests, customer tests, punch lists, conditional acceptance and unresolved defects. A signed lease whose rent commencement depends on a future test belongs in contracted growth, not operating earnings.

Cyber and physical security findings can affect retention and integration. The buyer should identify certifications, audit reports, material exceptions, customer-specific controls, privileged access, monitoring, incident response, vendor dependencies and separation requirements. The transaction plan should preserve evidence and control during system migration.

8. Convert expansion claims into a stage-gated pipeline

Expansion capacity should be divided into land-controlled, permitted, power-supported, designed, procured, under construction, commissioned and customer-backed phases. Each phase should have objective entry and exit evidence. A land parcel beside an operating site is not equivalent to an approved and powered extension.

The pipeline should reconcile land area, buildable area, utility capacity, substation space, fibre routes, cooling and water, environmental constraints, equipment lead times, contractor resources, customer demand and capital. The slowest dependency controls the date. IEA analysis highlights the long lead times for grids, transformers and cables; a board should therefore test the delivery path rather than extrapolate recent build rates.

Expansion value should be probability-weighted by evidence state and reduced for capex, delay, financing and cannibalisation. The acquisition model should prevent double counting between existing contracted capacity, customer options and speculative pipeline. A separate opportunity case can preserve upside without embedding it in the price paid at closing.

Permitting should be decomposed rather than shown as a single green status. Planning, building, fire and life safety, environmental, water, generator, fuel, road access, aviation, telecom and operational approvals may follow different authorities and expiry dates. The buyer should identify whether permits attach to land, design, entity or contractor and whether a change of control or design change requires notice or reapproval. A permit valid for the current phase may not support the density, cooling or generator strategy assumed for expansion.

Equipment capacity should also match the design case. Transformer, switchgear, UPS, generator, chiller, pump, heat-rejection and control-system ratings should reconcile to the intended IT load and redundancy. Vendor reservations without an executed purchase order can provide limited schedule certainty. Executed orders with non-cancellable deposits can create a liability if the customer's design changes. The stage gate should therefore connect engineering freeze, customer specification, procurement commitment and financing approval.

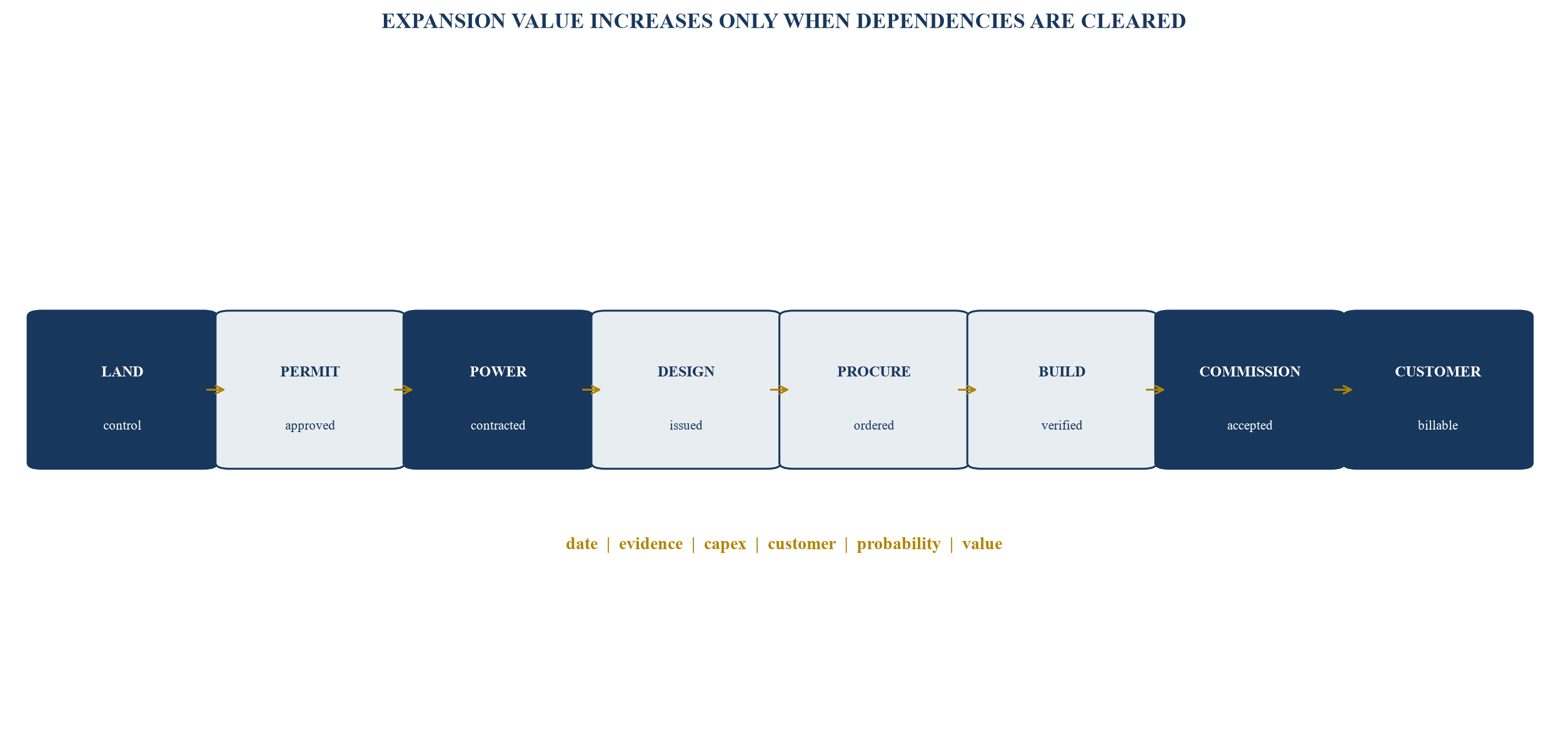

Figure 3. Expansion stage gates
Figure 3. Expansion stage gates

Each gate requires current evidence before capacity moves into a higher-confidence value state.

9. Rebuild capital expenditure from the bottom up

The capex bridge should separate spent cost, committed unpaid cost, forecast cost to complete, owner-supplied equipment, customer-funded work, capitalised interest, contingency, escalation, taxes and working capital. It should reconcile the engineering estimate, purchase orders, invoices, general ledger, payment certificates and budget.

Sunk cost is not proof of completion value. Some spending may relate to abandoned design, deposits at risk, related-party mark-ups or equipment that cannot be used in the buyer's plan. The buyer should test remaining scope and current pricing. Long-lead transformers, switchgear, generators, cooling equipment and controls need purchase-order, manufacturing, testing, shipping, customs, installation and warranty evidence.

The bridge should identify who funds tenant changes and options. A customer specification change can increase power density, cooling and fit-out cost. The contract may allocate this to the operator, customer or a negotiated change order. The valuation model should reflect recoverability and payment timing rather than assuming all growth capex earns the target return.

Table 3. Illustrative capex-to-complete bridge

ItemBase estimateDiligence adjustmentRevised amountEvidence required
remaining construction82991quantity surveyor and contracts
electrical and grid works441357utility scope and vendor orders
cooling and controls31738issued design and quotations
customer fit-out22527approved specification and recovery
contingency and escalation121426risk register and schedule
total cost to complete19148239reconciled completion certificate

Amounts are hypothetical and shown solely to demonstrate the reconciliation.

10. Separate operating value from rights and development value

Operating value should be based on sustainable cash from commissioned and accepted capacity. The buyer should normalise revenue, power margins, maintenance, staffing, insurance, rent, management charges and recurring capital expenditure. One-off credits, related-party pricing and capitalised operating costs require adjustment.

Contracted growth should be valued after capex, acceptance, delay and termination risk. Expansion without a signed customer requires a separate probability and leasing case. Power rights can support option value where transfer, timing and economics are evidenced; they should not be valued as operating capacity before delivery and commissioning.

The model should report value by site, phase and evidence state. This permits the investment committee to see how much price depends on operating cash, customer execution, grid delivery or speculative expansion. It also supports targeted protections rather than a single portfolio discount.

Comparable-company metrics need careful translation. Listed operators can disclose cabinets, square feet, megawatts, annualised recurring revenue, development space and future capacity using their own definitions. Digital Realty states that rentable area depends partly on available power and required support space, and it separately reports active and future development. Equinix reports cabinet utilisation with power limitations and identifies phased projects. These disclosures show why a buyer should document the denominator and readiness state before applying a multiple.

Platform value should be separately evidenced. Management capability, customer relationships, procurement scale, development systems and a repeatable pipeline can support value beyond individual sites. The buyer should test employee retention, decision rights, systems, data ownership, vendor concentration and the historical conversion of pipeline into commissioned and leased capacity. A platform premium should be supported by repeatable capability and a funded opportunity set.

11. Build a rights-adjusted valuation waterfall

The waterfall begins with enterprise value from the agreed valuation method. It then adjusts for normalised operating earnings, debt-like items, working capital and tax in the usual transaction bridge. A second layer addresses sector-specific rights and completion findings: unsupported capacity, capex to complete, tenant-option burden, customer concentration, power defects, delayed energisation, equipment replacement and integration.

Deal protections should follow the finding. A known and measurable cost can adjust price. A pre-closing deliverable can become a condition precedent. A future outcome controlled partly by the seller can use an earn-out, escrow or holdback. A specific historic breach can use an indemnity. A continuing obligation can use a covenant, service agreement or direct agreement. Excluding the affected value remains appropriate when evidence is insufficient.

Acquisition financing should reconcile to the same downside case. Lenders may size debt against operating cash, contracted growth, asset value, completion risk and sponsor support using different eligibility rules. The buyer should identify which valuation adjustments reduce borrowing capacity, which conditions delay funding and which covenants could constrain integration or expansion. Financing certainty, hedging, security, cash control and mandatory prepayment terms should be reflected in both the sources-and-uses model and the acquisition agreement.

The equity bridge should include transaction fees, taxes, refinancing costs, break costs, working capital, capex, reserves and integration. A purchase price that fits the valuation can still exceed the available funding after these uses are included. The investment committee should see required equity under base, delay and combined downside cases and identify the funding source for customer or utility commitments that become payable shortly after closing.

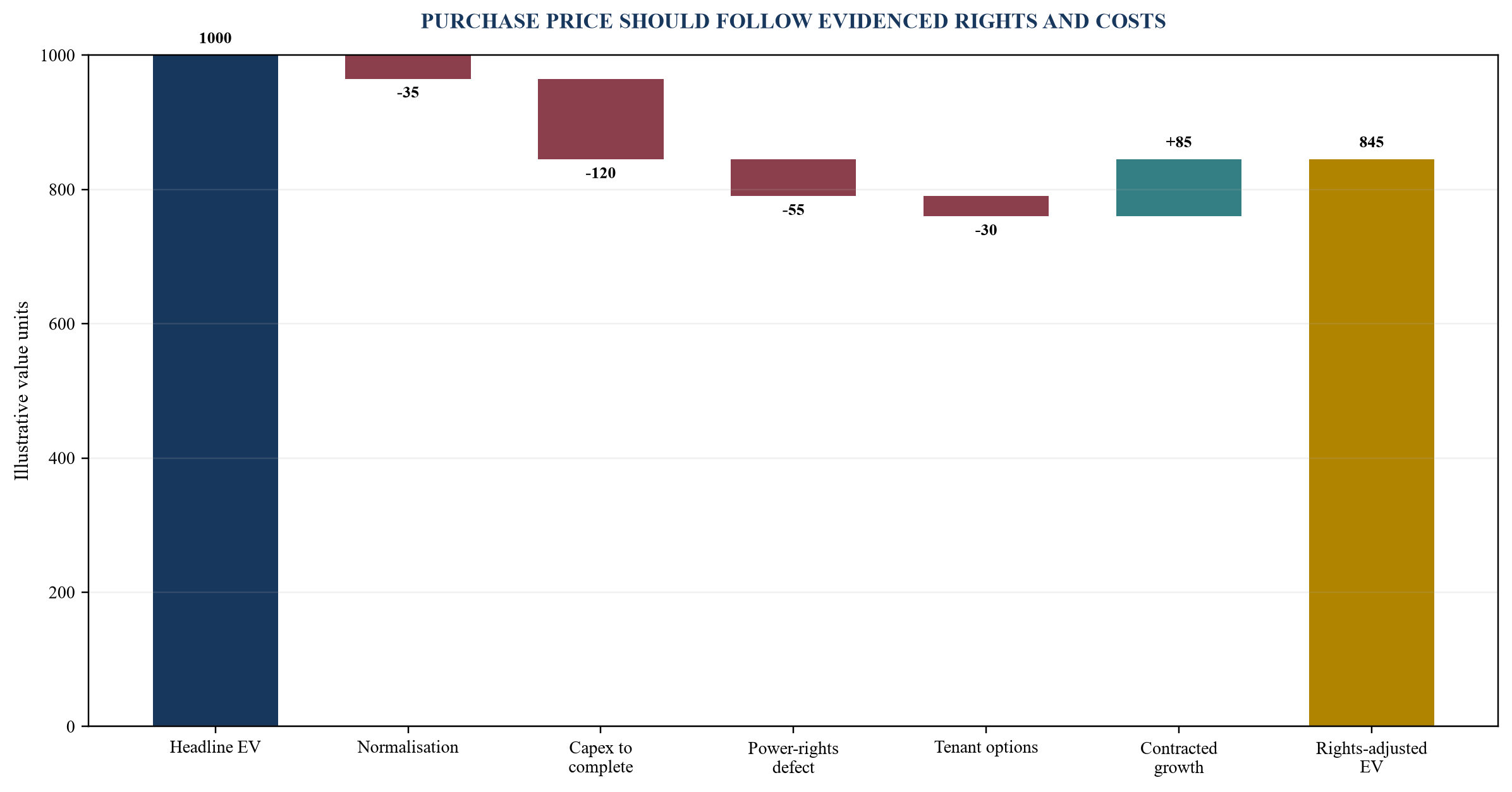

Figure 4. Illustrative rights-adjusted valuation waterfall
Figure 4. Illustrative rights-adjusted valuation waterfall

Amounts are hypothetical; a live transaction requires deal-specific valuation evidence.

12. Stress the dependencies together

Single-variable sensitivities can understate transaction risk because capacity, customer, capex and financing events interact. A grid delay can trigger customer termination, extend construction overhead, defer cash and weaken refinancing. A tenant contraction can release capacity that requires new fit-out and sales cost. A technology change can increase cooling capex and alter customer demand.

The acquisition model should include combined cases. A base case uses current contracted and operating evidence. A delay case moves grid, construction and acceptance dates. A customer case applies termination, contraction, credits and re-leasing cost. A technology case changes rack density, cooling, equipment and recurring capex. A combined downside should test liquidity, covenant headroom, equity requirement and recoverable value.

Probabilities should remain explicit management estimates unless supported by market or contract evidence. The decision paper should show the breakeven variables: maximum capex, latest energisation date, minimum retained MW, minimum renewal, maximum tariff and exit value. These thresholds become negotiation and monitoring priorities.

Table 4. Combined transaction stress matrix

CaseCapacity effectCash effectCapital effectPrincipal response
grid delaycommissioning deferredrevenue and collection delayedoverhead and interest increaselong-stop, holdback and liquidity
tenant contractioncommitted MW fallsrecurring revenue declinesre-fit and leasing spendprice and re-leasing plan
density changeusable MW may changepricing and demand shiftcooling and electrical upgradecustomer-backed retrofit gate
tariff increasecapacity unchangedmargin declines under fixed pricingefficiency spend may risepass-through and hedge review
combined downsidecapacity and timing weakencoverage and exit value fallequity need increaseslower price, restructure or walk-away

The directions show mechanisms; transaction values require current site-specific modelling.

13. Design the transaction documents around the findings

Representations should cover authority, title, contracts, utility rights, permits, compliance, customers, capital commitments, litigation, cyber, assets, financial statements and disclosed forecasts where negotiated. Materiality and knowledge qualifiers should match the diligence evidence and risk allocation. A broad representation cannot substitute for resolving a known defect.

Conditions precedent should be objective and controllable. Examples include utility or landlord consent, competition clearance, release of security, delivery of commissioning evidence, renewal of a key tenant, transfer of a licence or completion of specified works. The acquisition agreement should state the evidence and consequence of failure.

Purchase-price mechanisms should match the business. Completion accounts can address debt, cash and working capital. Locked-box structures require leakage protection and reliable accounts. Earn-outs can address future energisation, commissioning, customer acceptance or contracted growth; their definitions need control, accounting and dispute rules. Escrow and holdback can protect known completion or consent risks.

14. Plan regulatory and competition approvals early

The regulatory map should cover competition, foreign investment where relevant, sector licences, data and cyber obligations, land, utilities, environmental approvals and free-zone requirements. The buyer should identify filing parties, information, timetable, standstill obligations, remedies and long-stop interaction before signing.

UAE Cabinet Decision No. 3 of 2025 identifies notification thresholds based on UAE relevant-market sales above AED 300 million or combined market share above 40 percent. The Ministry describes a review period of 90 working days, with a possible 45-day extension, and a standstill during review. The current 2026 implementing legislation and transaction facts require current legal review.

Saudi Arabia's General Authority for Competition publishes Economic Concentration Review Guidelines. The filing analysis should address control, turnover, relevant markets, nexus, exemptions, timing and substantive effects using current rules. A GCC portfolio transaction may require several national and sector processes rather than one regional approval.

Competition work should connect legal filing analysis to commercial diligence. Relevant markets may turn on geography, service, customer type, connectivity, capacity or substitutability. Customer and competitor documents, market shares, pipeline and pricing can therefore be relevant to both valuation and regulatory review. The clean-team process should protect competitively sensitive data while permitting the advisers to assess concentration, overlaps and remedies.

Transaction timetables should use the longest credible approval path and include information-request risk. Signing documents should allocate cooperation, control of filings, remedy commitments, costs, interim conduct and long-stop rights. The operating team should understand restrictions during the standstill period, especially where capacity, customer contracts, capex and staffing continue to change between signing and closing.

15. Build the first 100 days before signing

Integration planning should protect uptime, customer trust and rights continuity. Day-one controls cover authority, bank accounts, system access, incident escalation, vendor contacts, utility relationships, customer communication and financial close. Critical staff, certifications, permits and service contracts need named owners.

The capacity ledger should become an operating control. Legal, engineering, sales and finance teams should use the same capacity identifiers and milestone states. Changes to power, construction, customer options and capex should update the ledger and valuation case. This converts diligence into portfolio management.

Synergy plans should separate revenue, procurement, network, energy, staffing, platform and capital effects. Each synergy needs a baseline, owner, cost, timing, customer impact and evidence. Capacity that can be sold across the combined platform may create value, while migration or standardisation can create downtime and capex. The integration committee should preserve a customer-safe path.

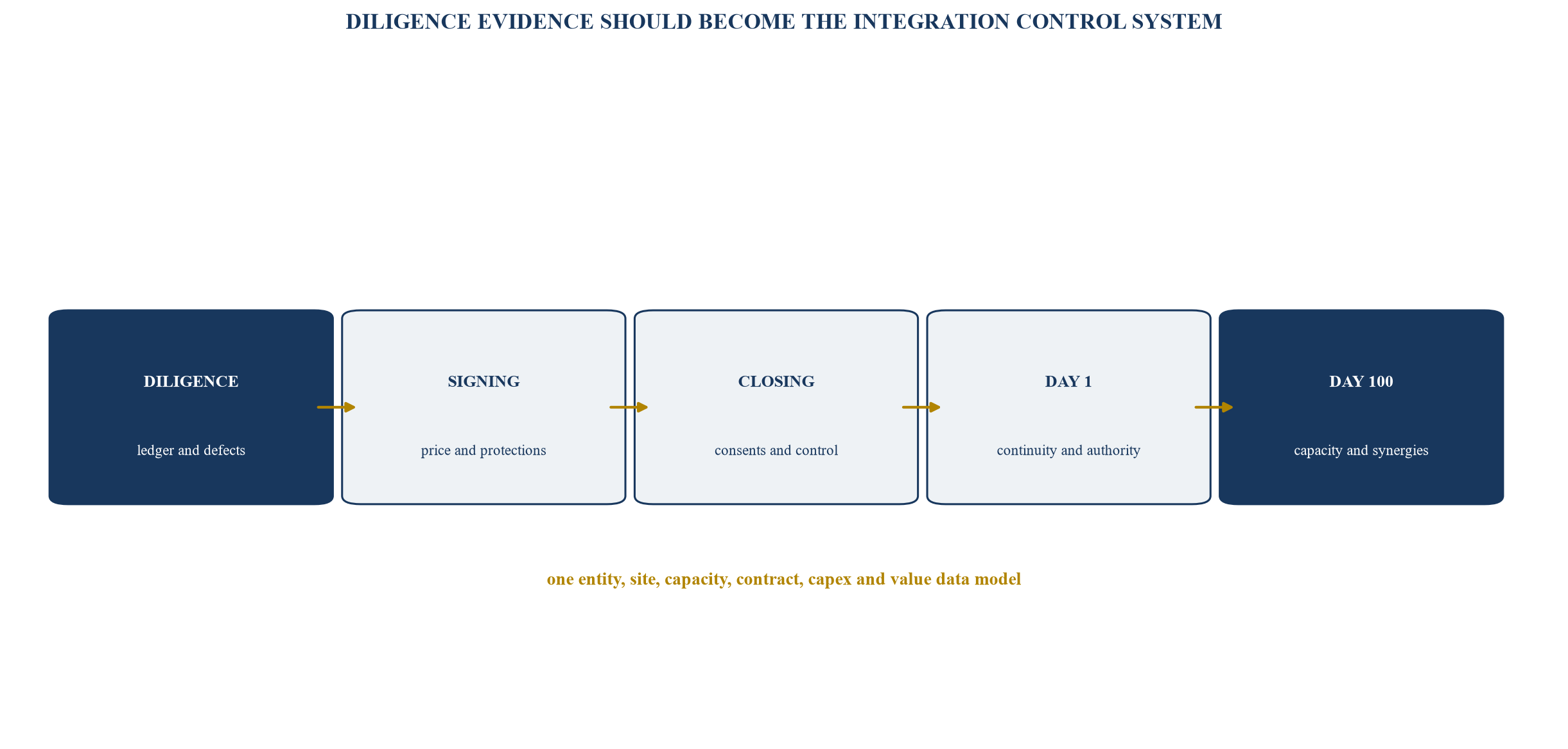

Figure 5. Transaction control room from diligence to value capture
Figure 5. Transaction control room from diligence to value capture

The same evidence model should continue through signing, closing and integration.

16. Use a gated acquisition process

Gate one confirms perimeter and evidence. The buyer maps entities, sites, rights, capacity, customers, assets and financial records. Missing evidence is logged with an owner and closing consequence. Gate two confirms operating value through commissioning, service, contracts, invoices and cash.

Gate three confirms power and expansion through agreements, technical studies, delivery works, permits, equipment, capex and schedule. Gate four converts findings into valuation, financing, approvals and documents. Gate five prepares closing and the first 100 days. Investment approval should state which risks are resolved, transferred, retained or excluded from value.

Table 5. Acquisition gates and minimum outputs

GateCore questionMinimum outputDecision
perimeterwhat rights and liabilities transfer?entity and asset mapscope or restructure
operating valuewhich cash is commissioned, durable and collected?capacity and cash reconciliationsustainable earnings
expansionwhich future MW can be delivered and funded?rights map and capex bridgeprobability-weighted value
transactionhow are findings allocated?valuation waterfall and protectionsprice and documents
integrationhow is continuity and value captured?day-one and 100-day planowners and milestones

A gate closes when the required evidence and decision treatment are documented.

17. Limitations and research agenda

Public regulation, operator disclosures and industry evidence establish risk mechanisms and useful control categories. They do not establish the condition, transferability, cost, customer quality or value of a particular GCC portfolio. Utility and licensing practice can vary by country, emirate, city, free zone, site and connection voltage. Current legal and technical advice is required.

Further research should examine observed GCC transaction pricing by evidence state, the value of transferable power rights, tenant-option exercise behaviour, re-leasing periods, capex by density and cooling architecture, and the effect of sovereign-cloud and data-residency requirements on contract durability. Comparable data should distinguish operating, development and platform value.

The framework can also be tested against post-acquisition outcomes. Buyers can compare diligence assumptions with actual energisation, commissioning, retention, capex, synergies and cash. This evidence can improve future probability weights and identify which documents and technical tests best predict value delivery.

18. Conclusion

GCC data-centre M&A requires a controlled link between rights, physical capacity, customer obligations, capital and cash. Headline megawatts and pipeline descriptions are starting points. Purchase price should reflect the subset that the buyer can legally control, technically deliver, commercially use and finance.

The proposed system uses five schedules. The capacity ledger defines evidence state. The power-rights map tests delivery and transfer. The tenant-option matrix identifies who controls future cash and capacity. The capex bridge measures the remaining funding requirement. The valuation waterfall converts the findings into price and protections.

The method also improves execution after closing. The same identifiers and evidence used in diligence become the operating control for power, construction, leasing, capex and integration. A buyer that maintains this chain can distinguish verified operating value from conditional growth, intervene before milestones fail and allocate capital to the capacity most likely to become durable cash.

References

  1. International Energy Agency, Energy and AI, 2025. https://www.iea.org/reports/energy-and-ai
  2. International Energy Agency, Energy and AI: Executive Summary, 2025. https://www.iea.org/reports/energy-and-ai/executive-summary
  3. International Energy Agency, Energy Demand from AI, 2025. https://www.iea.org/reports/energy-and-ai/energy-demand-from-ai
  4. Dubai Electricity and Water Authority, Power Supply Guidelines for Major Projects, Revision 7, July 2025. https://dewa.gov.ae/-/media/Files/Major-Project-Guidelines-July-2025.ashx
  5. Dubai Electricity and Water Authority, Getting Electricity Permits and Connections. https://dewa.gov.ae/en/about-us/service-guide/builder-services/getting-electricity-connections
  6. Abu Dhabi Department of Energy, Electricity Transmission Code Version 3.0, 2022. https://www.doe.gov.ae/-/media/Project/DOE/Department-Of-Energy/Media-Center-Publications/Codes/2022Electricity-Transmission-Code-Version-30.pdf
  7. Abu Dhabi Department of Energy, Electricity Supply Regulations, 2020. https://doe.gov.ae/-/media/Project/DOE/Department-Of-Energy/Media-Center-Publications/Regulations/English/ESR2020EditionPublication.pdf
  8. National Grid SA, Saudi Arabian Grid Code. https://www.se.com.sa/en/Whoweare/National-Grid-SA/Saudi-Arabian-Grid-Code/
  9. Saudi Electricity Company, Saudi Arabian Distribution Code. https://www.se.com.sa/en/Electricity-Information/Guides/Saudi-Arabian-Distribution-Code/
  10. National Grid SA, Electrical Service Connection Requests. https://www.se.com.sa/en/Whoweare/National-Grid-SA/Electrical-Service-Connection-Requests/
  11. UAE Ministry of Economy and Tourism, Cabinet Decision No. 3 of 2025 on Competition Thresholds. https://www.moet.gov.ae/documents/20121/0/Cabinet%2BDecision%2BNo.%2B%283%29%2Bof%2B2025%2BOn%2Bthe%2BThresholds%2BRelated%2Bto%2Bthe%2BImplementation%2Bof%2BFederal%2BDecree-Law%2BNo.%2B%2836%29%2Bof%2B2023%2BRegulati.pdf/0f228724-8dd5-9b9c-0ed8-0b94d5ae0873
  12. UAE Ministry of Economy and Tourism, Economic Concentration. https://www.moet.gov.ae/en/web/guest/economic-concentration
  13. UAE Ministry of Economy and Tourism, Federal Decree-Law No. 36 of 2023 Regulating Competition. https://www.moet.gov.ae/documents/20121/0/Federal%2BDecree-Law%2BNo.%2B%2836%29%2Bof%2B2023%2BRegulating%2BCompetition.pdf/d5f2b12d-7688-5180-e63b-44a8dbe878d6
  14. General Authority for Competition, Saudi Arabia, Economic Concentration Review Guidelines, 2025. https://gacbep.gac.gov.sa/cms/b9376edc-79a1-4573-a36d-4f3effaba838.pdf
  15. Digital Realty Trust, Inc., Form 10-K for the year ended 31 December 2025. https://www.sec.gov/Archives/edgar/data/1297996/000110465926015365/dlr-20251231x10k.htm
  16. Digital Realty Trust, Inc., Second-Quarter 2025 Investor Presentation filed with the SEC. https://www.sec.gov/Archives/edgar/data/1297996/000155837025009543/dlr-20250724xex99d2.htm
  17. Equinix, Inc., Form 10-K for the year ended 31 December 2025. https://www.sec.gov/Archives/edgar/data/1101239/000110123926000075/EQIXAnnualRpt2025PRINT.pdf
  18. Equinix, Inc., 2024 Annual Report. https://investor.equinix.com/sec-filings/all-sec-filings/content/0001628280-25-005126/eqix-20241231.htm
  19. Equinix, Equinix to Open Its Third Data Center in Dubai, 30 May 2023. https://newsroom.equinix.com/2023-05-30-Equinix-to-open-its-third-data-center-in-Dubai-supporting-rapid-growth-in-the-MENA-region
  20. G42, G42 Acquires Injazat and Khazna. https://www.g42.ai/resources/news/g42-acquires-injazat-khazna
Questions, answered

GCC Data-Centre M&A: frequently asked questions

Headline capacity can combine applications, reservations, contracts, energised supply, commissioned IT load and speculative expansion. Each state has different enforceability, timing, cost and cash support.

It should identify site, phase, legal owner, utility state, technical state, gross and net MW, customer commitment, evidence, milestone, date, capex, risk and valuation treatment.

Transfer, consent, milestone, deposit, delivery works, curtailment, tariff, termination, security and change-of-control provisions should be reviewed with current technical status and compliance evidence.

Model the contracted capacity, notice, price, reservation economics, operator build duty, capex, acceptance, termination and alternative use. The controlling party and evidence state determine the option's effect.

Support strengthens as land, permits, power, design, procurement, construction, commissioning, customer commitment and financing become evidenced. Conditional stages should carry explicit probability and capex adjustments.

Reconcile engineering scope, contracts, purchase orders, invoices, payment certificates, utility obligations, customer changes, contingency, escalation and the current completion schedule.

Depending on the finding, parties may use price adjustments, conditions precedent, seller completion obligations, escrow, holdbacks, earn-outs, indemnities, covenants or exclusion from value.

Convert it into a capacity and integration control system that tracks power, commissioning, customer options, capex, service, synergies and collected cash using the same identifiers.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
