M&A · AI Logistics

AI Network Design in Logistics Deals: Quantifying Synergies before the Investment Committee

A transaction framework connecting digital twins, route and node overlap, service sensitivity, synergy confidence and integration sequencing.

AI Network Design in Logistics Deals: Quantifying Synergies before the Investment Committee
Quick answer

AI network design becomes investment-committee evidence when digital twins, route overlap, service sensitivity and integration cost are reconciled into controlled value ranges.

Abstract

Logistics acquisitions are frequently supported by a network thesis: combine overlapping routes, raise asset utilisation, consolidate nodes, improve procurement and release duplicated capacity. Artificial intelligence and operations-research tools can now test many possible network designs before closing. Their speed can improve diligence, while their output can also create false precision when source data, contractual constraints, service promises or implementation costs are incomplete.

Two route maps can overlap geometrically without sharing compatible time windows, vehicle classes, permits, customer commitments, depot capacity or system identifiers. A cheaper design can reduce resilience or require capital that the transaction model omitted. This paper develops a decision framework for using AI-assisted network design before an investment committee approves a logistics transaction.

It connects a reconciled operational baseline to a network digital twin, route and node overlap, fleet compatibility, service sensitivity, customer and competition constraints, implementation cost, financing capacity and a controlled synergy confidence ladder.

Five original figures and five implementation tables show how a buyer can move from raw data to scenario ranges, identify binding constraints, distinguish modelled opportunity from executable value and sequence integration without treating an optimisation result as evidence of realised cash. The external evidence establishes analytical and governance boundaries rather than universal benchmarks.

IFRS 3, IAS 37 and IAS 36 shape accounting analysis for business combinations, restructuring and impairment.[1][2][3] The UK Competition and Markets Authority's merger guidance explains that efficiency claims within its framework require verifiable evidence and must satisfy defined conditions.[4] The World Bank's logistics indicators emphasise speed, connectivity and reliability, while the US Freight Analysis Framework demonstrates how origin, destination, commodity and mode data can support freight analysis.[5][6] NIST's AI Risk Management Framework provides a voluntary structure for governing, mapping, measuring and managing AI risk.[12] Every route volume, vehicle count, utilisation rate, supplier price, cost, cash value, implementation period and valuation effect in the worked examples is a hypothetical modelling assumption created solely to demonstrate the method.

The examples are not operating benchmarks, forecasts, investment recommendations or valuation conclusions. A live programme requires transaction-specific customer contracts, operational data, labour and safety requirements, licences, tax, accounting, legal, competition, property, technology, cyber, financing and board-approved decisions.

JEL Classification: G34, L91, L92, C61, C63, M21, O33

Keywords: logistics M&A, artificial intelligence, network digital twin, route optimisation, synergy diligence, investment committee, service sensitivity, integration planning, model governance, value creation

This Matchpoint Insight presents the web edition of Matchpoint Partners' research. The supporting paper contains the full framework, structures, worked examples and source material.

Read the full research paper   Explore our M&A practice

1. Define the investment-committee decision

A logistics acquisition creates value when the combined business can serve customers, deploy assets, purchase inputs and manage cash more effectively than the businesses could have done separately. Before approval, the investment committee needs to know which network changes create that value, how much survives practical constraints, what must be spent, when the cash arrives and which evidence could invalidate the thesis. The relevant comparison is the combined result against a credible standalone counterfactual. A budget variance alone cannot establish synergy because market prices, volume, fuel, labour, weather, regulation, customer mix and management action can change after completion.

The committee should specify its decision questions before the modelling team selects an algorithm. Typical questions concern the defensible purchase-price contribution from network synergy, the minimum value that survives downside conditions, the capital and liquidity needed to implement change, the exposure to customer attrition and the earliest safe integration sequence. A model that minimises kilometres while leaving these questions unanswered is an operating experiment rather than transaction evidence.

The board should distinguish five evidence states. Gross opportunity is an analytical hypothesis before full operational challenge. Approved plan is an initiative whose baseline, owner, cost, timing, dependencies and controls have been accepted. Validated run-rate is the recurring economic effect supported by current operating evidence. Accounting result is the amount recognised under the applicable reporting framework. Realised cash is the amount visible in receipts, payments and financing balances after working-capital and implementation effects. These states should never be added together.

The ledger gives every initiative a permanent identity and a controlled history. It records the baseline period, transaction perimeter, counterfactual, formula, data owner, initiative owner, finance reviewer, first irreversible action, customer and workforce risks, capital requirement, one-off cost, expected benefit, cash timing, evidence, approvals, changes and reversals. An initiative remains an opportunity until its gates are satisfied.

This discipline matters because logistics benefits interact. Consolidating two routes may increase vehicle fill while reducing delivery reliability. Negotiating a fuel discount can create a volume commitment that limits later fleet electrification. Closing a depot can remove rent but require additional vehicles, driver hours and inventory. The ledger keeps these effects in one net value record instead of allowing separate teams to claim benefits and leave costs elsewhere.

Table 1. Evidence states for an investment-committee synergy case

Evidence stateRequired supportPermitted board usePrincipal control
gross opportunityinitial route, fleet, supplier or overhead analysisprioritise diligence and design workdisclose assumptions and confidence
approved planfrozen baseline, counterfactual, owner, cost, timing and safeguardsrelease planning capacity and conditional budgetfinance and operating approval
validated run-raterepeated operating evidence after implementationassess recurring economic effectnormalise volume, price and external factors
accounting resultledger entries and policy conclusionstatutory and management reportingreconcile to general ledger and disclosures
realised cashbank, receivable, payable, debt and working-capital evidenceassess liquidity and debt reductionreconcile timing, taxes and implementation cash

The states are management-control categories. Accounting recognition follows the applicable reporting framework and transaction facts.

2. Freeze the transaction perimeter and digital baseline

The first task is to decide what has actually been acquired and what will be measured. Legal entities, customer contracts, operating branches, leased assets, subcontractor arrangements, shared services and data environments can enter the deal perimeter on different dates. A synergy baseline that mixes continuing, excluded and transitional activities will produce false comparisons.

The baseline should cover at least twelve months and, for seasonal networks, a period long enough to explain peak and trough behaviour. It should reconcile shipment or job records to invoices, recognised revenue, direct cost, asset registers, fuel and maintenance systems, payroll, supplier invoices, depot records and cash. Volume should be segmented by origin, destination, service promise, commodity or handling requirement, vehicle class, customer, price, margin and collection profile.

Data quality must be measured before modelling. The UK Government Data Quality Framework identifies completeness, uniqueness, consistency, timeliness, validity and accuracy as distinct dimensions.[7] Applied to logistics, completeness asks whether all movements and costs are present; uniqueness tests duplicate loads or suppliers; consistency reconciles transport-management, finance and telematics records; timeliness tests whether events are posted promptly; validity tests formats and allowed ranges; accuracy compares records with operational reality.

The digital twin should have a controlled data dictionary. Orders, loads, stops, lanes, vehicles, trailers, drivers, depots, customers, contracts, invoices and cash receipts need stable identifiers across both businesses. Entity resolution can propose matches, though ambiguous records should remain visible for accountable review. The model inventory should record source, owner, extraction date, transformation, missingness, permitted use and reconciliation status. A data gap that can change the deal conclusion belongs in the investment-committee pack.

The counterfactual should state how each business was expected to perform without the acquisition. It can use board-approved standalone forecasts adjusted for evidence obtained during diligence, with separate scenarios for volume, price, labour, fuel and capital. Management should preserve the original counterfactual and record later changes rather than overwriting it. This protects the value bridge from hindsight.

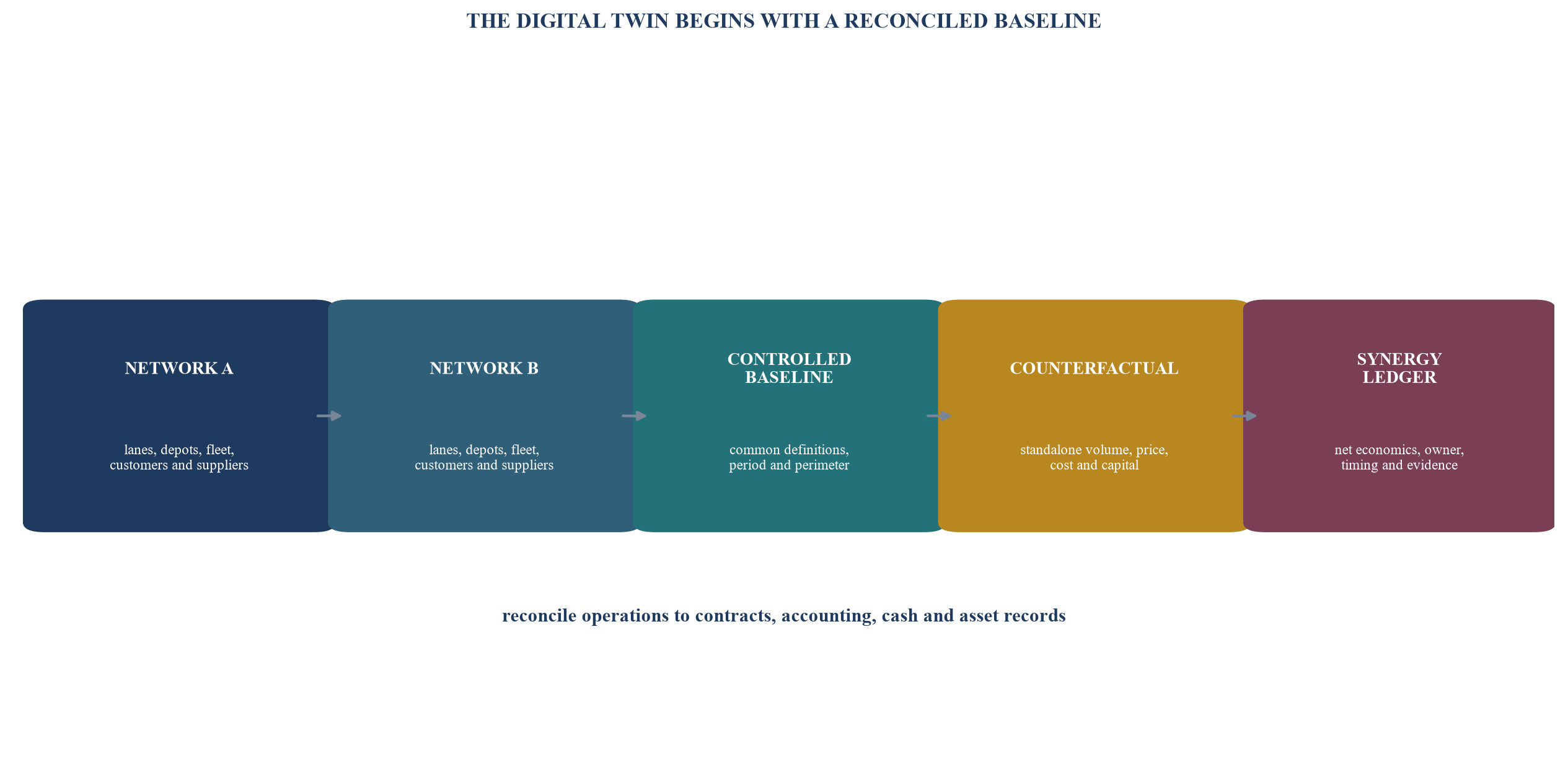

Figure 1. Network digital twin from source systems to decision scenarios
Figure 1. Network digital twin from source systems to decision scenarios

The diagram shows the evidence layers that must be reconciled before route, fleet or procurement benefits are approved.

3. Build an AI-assisted route-overlap map

Route synergy begins with a lane-level map. Each movement should have an origin, destination, collection and delivery window, distance, frequency, volume, weight or cube, handling requirement, vehicle class, customer commitment, revenue, direct cost and exception history. The US Bureau of Transportation Statistics' Freight Analysis Framework illustrates the analytical value of origin, destination, commodity and mode data at scale.[6] A company-level model needs more detailed operational records and contract terms.

Overlap has several forms. Exact overlap occurs when both businesses serve materially the same lane with compatible vehicles and windows. Directional overlap occurs when outbound movements in one network can pair with return movements in the other. Temporal overlap exists when schedules can be coordinated. Node overlap exists when depots, cross-docks or ports serve similar catchments. Customer overlap can support consolidated collections or delivery rounds. Each form creates a different initiative and evidence requirement.

Distance alone cannot determine consolidation. A route may carry dangerous goods, temperature-controlled products, high-value cargo or customer-specific equipment. Cabotage, driver hours, permits, axle limits, customs, security, insurance, trade sanctions and labour rules can constrain alternatives. Customer contracts may require dedicated vehicles, specific depots, fixed collection times or subcontractor approval. The route team should record each hard constraint before an optimisation model is allowed to recommend change.

AI can support clustering, demand prediction, travel-time estimation and search across a large solution space. The model should expose the objective function and each constraint. A weighted objective can combine contribution, kilometres, service performance, emissions, resilience and capital, but the weights remain management choices. The modelling team should show how the preferred design changes when each important weight, constraint or forecast moves. This sensitivity record is more informative than a single labelled optimum.

The design objective should combine cost, service, resilience and capital. A route that is marginally cheaper but vulnerable to a single border, depot or supplier can reduce enterprise resilience. The World Bank's logistics work treats reliability alongside speed and connectivity.[5] Management should therefore measure on-time collection, on-time delivery, damage, temperature or handling compliance, missed slots, dwell, claims, complaints and recovery time as well as kilometres and cost.

Table 2. Route-overlap model and decision record

FieldEvidenceDecision questionFailure signal
origin, destination and nodesgeocoded jobs and depot recordswhere is physical overlap real?aggregated zones conceal detours or restrictions
service windowcontract, order and delivery evidencecan movements share a schedule?missed slots or extended dwell
capacity requirementweight, cube, pallets and handlingcan the same asset serve both loads?legal, safety or equipment incompatibility
revenue and direct costinvoice, job costing and supplier recordsdoes consolidation improve contribution?savings offset by price, claims or subcontracting
customer and regulatory constraintscontracts, permits and specialist reviewwhich constraints are mandatory?model recommends an unlawful or unapproved route
resiliencedisruption and recovery evidencedoes the design retain practical alternatives?a single node or carrier becomes critical

Required fields should be adapted to the transport mode, jurisdiction, customer contract and safety regime.

4. Convert modelled overlap into executable options

The route map becomes valuable when it produces specific initiatives. These can include paired backhauls, combined collection rounds, redesigned line-haul schedules, common cross-docks, direct shipment around a node, consolidated subcontractor capacity, revised customer cut-offs or a new depot catchment. Each initiative needs a before-and-after operating design and a measurable acceptance test.

A lane consolidation record should show affected jobs, current kilometres, proposed kilometres, loaded and empty distance, vehicle and driver hours, tolls, fuel or energy, subcontractor cost, handling, depot activity, service risk and additional technology or planning effort. Revenue effects should be included where the new service promise changes price, volume, retention or claims. The calculation should identify which variables are observed, contracted or assumed.

Each option should be run across normal, peak and disrupted conditions. Peak tests should preserve customer cut-offs, labour and dock capacity. Disruption tests can remove a depot, carrier, border, route or system interface and measure recovery. The scenario set should include the seller case, buyer base case, constrained case and severe but plausible downside. Model output becomes an initiative only after operations, commercial, finance, technology and legal owners accept its feasibility.

The board should avoid treating modelled kilometres as cash. Cash emerges only when schedules change, supplier or labour commitments change, vehicles are redeployed or disposed, fuel or energy consumption falls, and customer service remains within the agreed threshold. Some benefits improve capacity headroom rather than current profit. That headroom can support growth or resilience, while it should be kept separate from released cash until used.

Pilots provide stronger evidence than simultaneous network redesign. A pilot can test a representative set of lanes for several cycles, with predetermined service, safety, cost and workforce criteria. The result should be compared with both the baseline and contemporaneous control routes where practical. A failed pilot is useful evidence when it prevents a larger disruption.

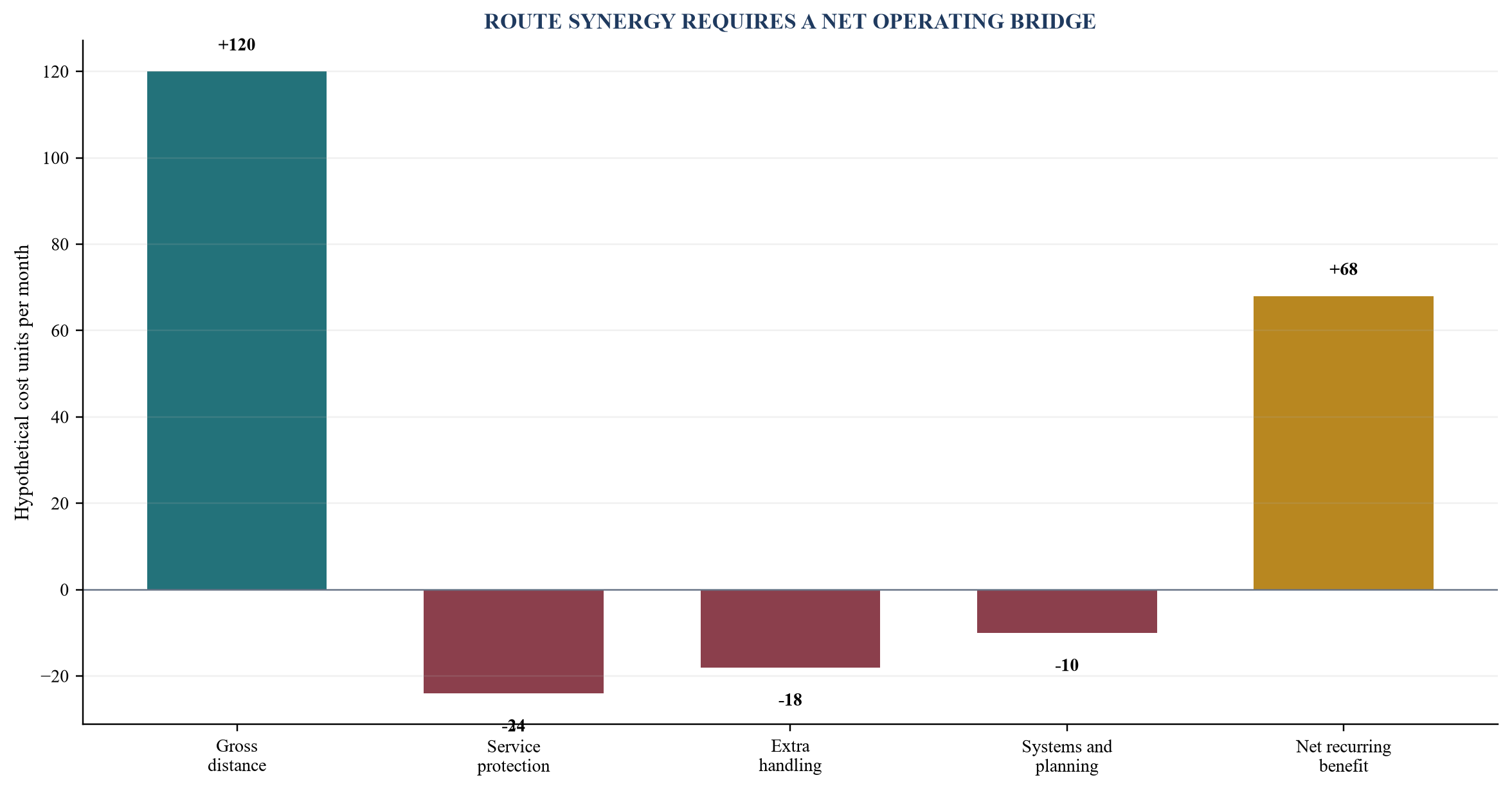

Figure 2. Route overlap and scenario-adjusted synergy economics
Figure 2. Route overlap and scenario-adjusted synergy economics

Values are hypothetical modelling assumptions in cost units per month and demonstrate the bridge from gross distance opportunity to net recurring benefit.

5. Test service sensitivity before accepting value

Fleet utilisation is frequently expressed as one percentage, although several different capacities are involved. Theoretical capacity is the maximum physical capacity of the fleet. Available capacity removes assets that are legally or mechanically unavailable. Scheduled capacity reflects the operating plan. Dispatched capacity reflects movements actually started. Loaded capacity measures productive payload or space. Paid capacity measures customer-billed work. Collected capacity measures the economic activity that has converted into cash.

Each step has a different owner and remedy. Maintenance can improve availability. Network planning can improve schedules. Dispatch can reduce cancellations and empty repositioning. Sales and customer operations can improve demand and mix. Billing and collections can improve conversion into cash. A combined fleet can show higher loaded utilisation while collected contribution deteriorates if price, claims, waiting time or payment terms weaken.

The integration team should segment vehicles by capability, age, ownership, lease terms, emissions standard, jurisdiction, maintenance profile, telematics, driver requirement and resale value. Vehicle counts alone obscure incompatibility. A refrigerated trailer cannot substitute freely for a dry-van movement; an urban electric vehicle may not serve a long-haul duty cycle; and a leased asset can carry termination or mileage obligations.

Fleet decisions should separate operational productivity from asset strategy. The company can redeploy, resize, refinance, dispose, extend, convert or replace assets. Each route should show capital expenditure, lease effects, tax, maintenance, residual value, charging or fuelling infrastructure, downtime and implementation risk. Finance should avoid claiming both a cost reduction and an asset-sale benefit when the same capacity is needed for growth.

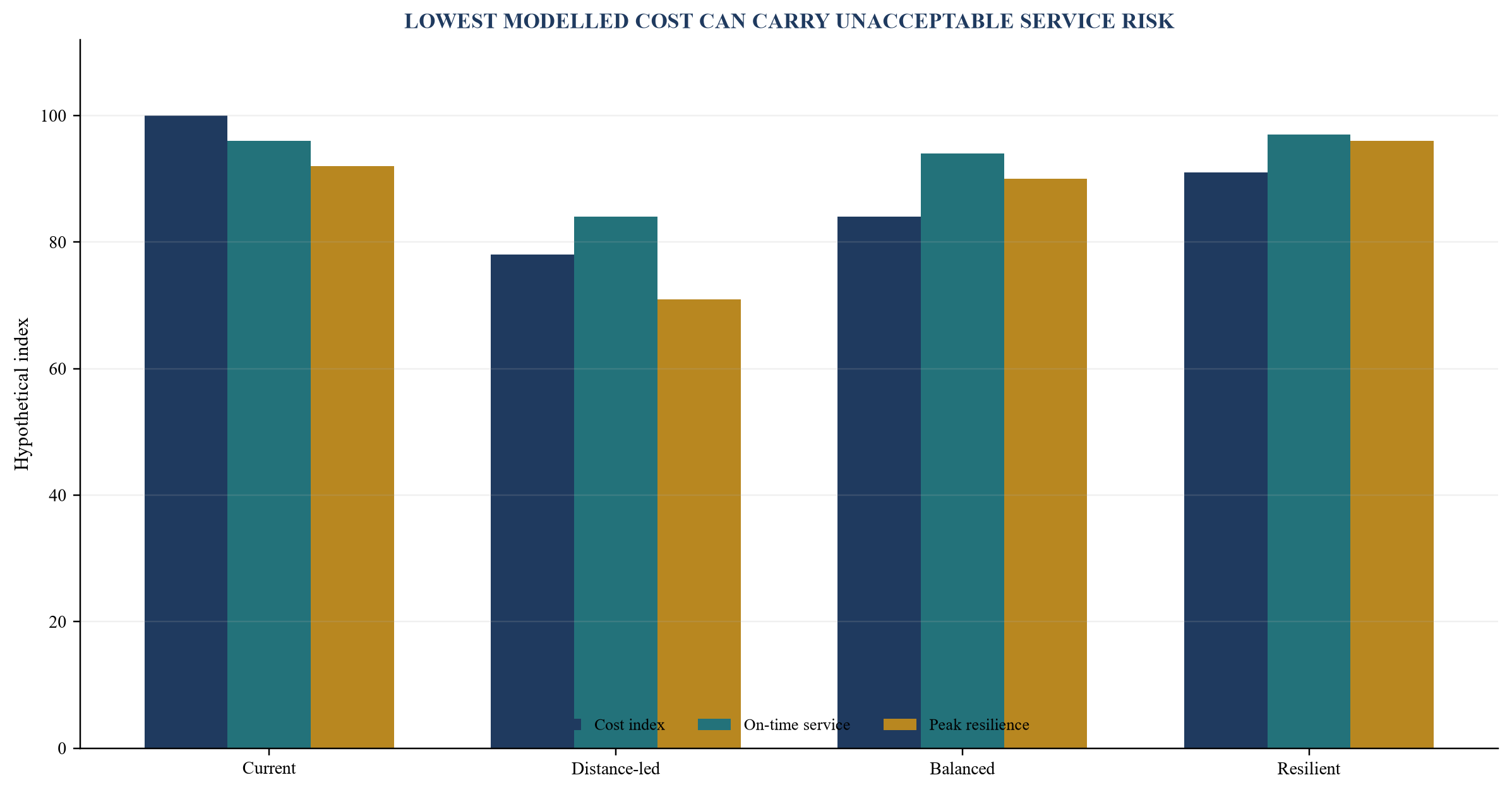

Figure 3. Service-level sensitivity across network scenarios
Figure 3. Service-level sensitivity across network scenarios

Hypothetical percentages show why one utilisation ratio can conceal the point at which capacity and value are lost.

6. Optimise nodes, line-haul and fleet as one system

Depot consolidation can create rent, labour, utilities, handling and management savings. It can also increase stem mileage, congestion, inventory, damage, cut-off pressure and customer distance. A property saving should therefore be modelled with the line-haul and last-mile consequences in the same initiative.

The depot model should include catchment, inbound and outbound flows, dock and yard capacity, operating hours, labour availability, automation, permits, environmental obligations, lease terms, landlord consents, security, maintenance, inventory, customs status and business continuity. Peak-hour capacity matters more than average throughput. A network with adequate annual capacity can fail on a small number of critical days.

Shared locations can create new operating options before a permanent closure. The businesses can cross-utilise yards, maintenance facilities, charging infrastructure, customs expertise or overflow capacity while customer and labour transitions are tested. Temporary dual running has a cost and can reduce execution risk. The ledger should show the approved transition period and the evidence required before exit.

Property, asset and workforce decisions often have long lead times. Lease break dates, redundancy consultation, relocation, systems integration and permitting can delay cash. The board should see a dated path from operational decision to contractual action, accounting treatment and cash release. An announced target date is not a realised benefit.

7. Separate network effects from procurement effects

Procurement synergy begins with a supplier and category cube reconciled to the general ledger, purchase orders, receipts, invoices, contracts, rebates, inventory and payment data. Categories can include fuel or energy, tyres, maintenance, vehicles, equipment, subcontracted transport, warehousing, packaging, technology, insurance, telecommunications and professional services. Spend should be mapped to legal entity, site, route, asset and operating owner.

Addressable spend is the portion that can realistically be influenced within the ownership horizon. It excludes taxes or regulated charges where appropriate, pass-through items that cannot be retained, committed contracts without an economic exit, constrained suppliers, and volume that will disappear under the network plan. A weighted average price difference across two businesses is only a diagnostic. Specification, service level, delivery location, quality, currency, indexation, credit terms and rebates must be normalised.

Procurement waves should follow operational criticality and contract timing. Low-risk common supplies may enter an early wave. Fuel, maintenance, tyres, insurance and strategic subcontractors require operational and safety challenge. Vehicles, automation and technology can change the network design and capital plan. Each wave should include demand management, specification challenge, make-or-buy analysis, supplier competition, negotiation, contract control and compliance.

Savings should be measured through a price-volume-mix bridge. Contracted unit price is evidence of a commercial result; realised margin depends on actual compliant purchases, operating volume, mix, rebates, quality and service. Realised cash depends on payment timing, inventory, implementation costs and taxes. The ledger should capture supplier concentration and continuity risk alongside savings.

Table 3. Procurement synergy measurement chain

StepMeasureEvidenceCommon leakage
spend baselinenormalised quantity, specification and total costledger, purchase order, receipt, invoice and contractduplicate suppliers, missing rebates or mixed specifications
addressable spendspend open to change within the planexpiry, termination, operating demand and constraintsgross spend treated as negotiable
sourced resultevaluated supplier offer and total-cost comparisontender, negotiation record and risk assessmentheadline price ignores service or transition cost
contracted resultsigned price, volume, rebate, index and service termsexecuted contract and authorised awardminimum volume or indexation dilutes saving
realised marginactual compliant quantity at controlled total costreceipt, usage, quality, claims and finance recordsoff-contract buying, mix shift or quality failure
realised cashpayment and working-capital effect after implementationpayable, bank, inventory and tax recordslonger inventory cycle or front-loaded implementation cash

Each step requires evidence before the initiative advances to the next benefit state.

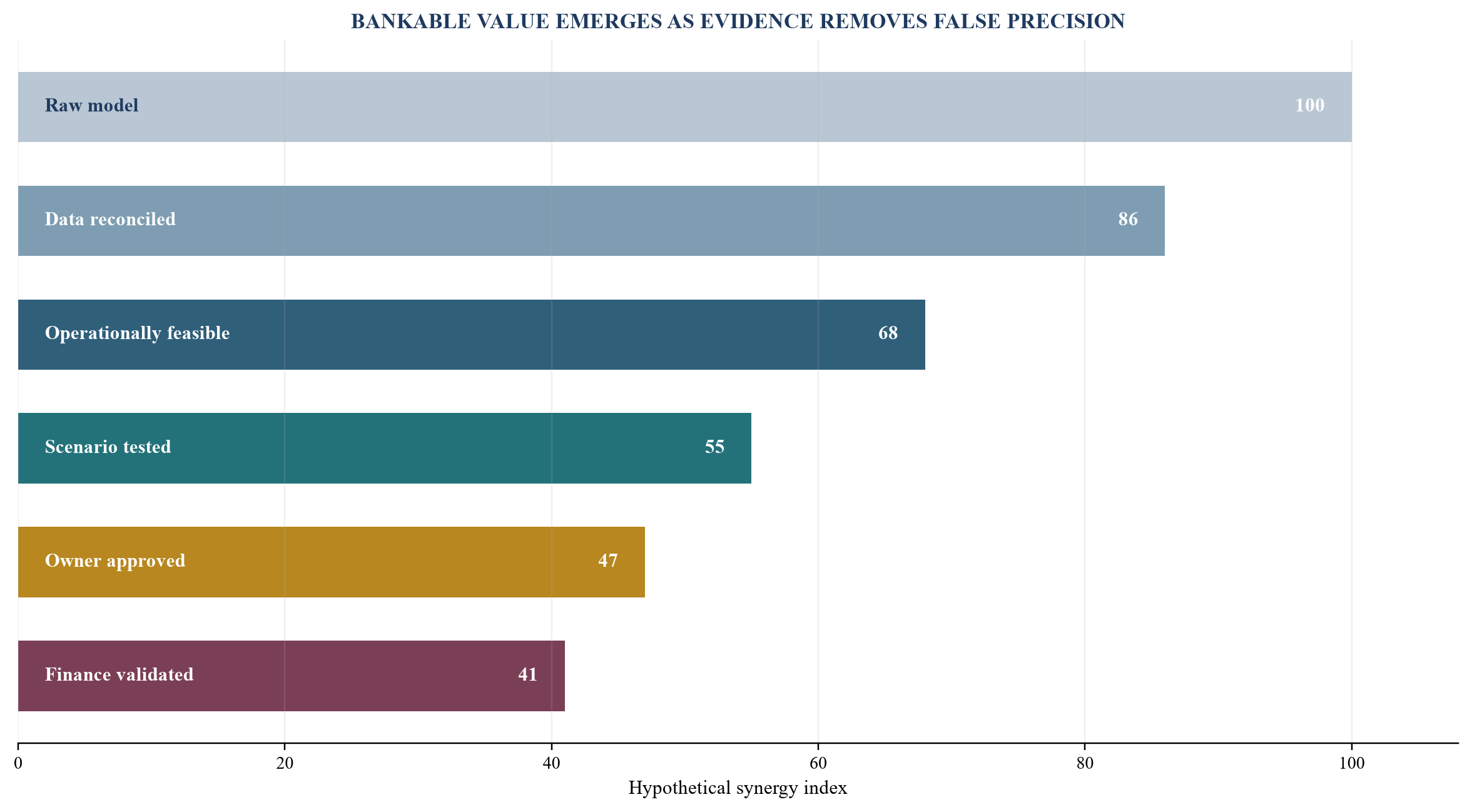

Figure 4. Synergy confidence ladder from model output to bankable value
Figure 4. Synergy confidence ladder from model output to bankable value

The plan shows sequencing by readiness and operational risk; actual category timing depends on contracts, regulation and operating requirements.

8. Protect customers, safety, workforce and resilience

Service protection is an economic control. Customer attrition, claims, penalties and emergency subcontracting can remove the apparent benefit of a network change. Every material initiative should identify affected customers, contractual commitments, communication, acceptance, contingency and monitoring. High-concentration accounts deserve explicit executive ownership.

The customer baseline should include on-time performance, claims, complaints, net revenue, contribution, payment terms, concentration and contract renewal. A route or depot pilot should define thresholds for each relevant measure and the authority to pause or reverse. Customer communication should state operational facts and responsibilities without promising outcomes that have not been tested.

Safety, licensing and labour requirements are mandatory gates. Management should identify applicable driver hours, vehicle standards, dangerous-goods rules, customs authorisations, environmental permits, workplace consultation, union or employee representation, transfer rules, data protection and local employment law. Qualified advisers and accountable executives should confirm each jurisdiction-specific conclusion.

Workforce design should preserve operating knowledge. Dispatchers, drivers, warehouse teams, mechanics and customer-service staff often hold route and exception knowledge that systems do not capture. The integration plan should map critical roles, decision rights, retention risk, training, consultation, transfer, succession and handover. Headcount reduction should not be recorded as a benefit before the operating model, legal process, cost and service effect are approved.

9. Price one-off cost, dis-synergy and capital

Gross benefits become investable only after implementation economics are visible. One-off costs can include advisers, systems, data remediation, integration teams, duplicate facilities, lease termination, asset impairment, relocation, severance, training, branding, contract termination, customer concessions and contingency. Capital can include vehicles, charging infrastructure, depot modifications, automation, cyber controls and integration interfaces.

Dis-synergies should receive the same discipline as benefits. They can include lost revenue, reduced price, lower capacity during transition, extra distance, dual running, supplier disruption, claims, higher inventory, employee attrition and management distraction. The ledger should show gross benefit, gross dis-synergy, one-off operating cost, capital expenditure, working-capital effect, tax and net cash by period.

Accounting boundaries require transaction-specific analysis. IFRS 3 establishes principles for recognising and measuring acquired assets, assumed liabilities, goodwill and consideration, and generally requires acquisition-related costs to be expensed as incurred apart from specified issuing costs.[1] IAS 37 states that a restructuring provision includes only direct expenditures necessarily entailed by the restructuring and not associated with ongoing activities; retraining, relocating continuing staff, marketing and investment in new systems or distribution networks are excluded from that provision.[2]

IAS 36 requires assets to be carried at no more than recoverable amount and applies to cash-generating units, including those containing goodwill.[3] A weak or delayed synergy case can therefore affect impairment analysis, although the impairment test follows the standard and the entity's facts. Management should maintain a controlled bridge between transaction valuation assumptions, integration initiatives, accounting judgements, board reporting and later impairment evidence.

Table 4. Net value bridge for one logistics initiative

ComponentYear 1 cashYear 2 cashRecurring run-rateEvidence owner
route and empty-distance reduction427272network operations
fleet maintenance and availability101818fleet director
procurement price and specification203636procurement and finance
customer and service protection-8-4-4commercial operations
dual running and systems-34-80integration office
capital expenditure-28-60CFO and operations
working-capital effect-650treasury and finance
net cash effect-4113122finance controller

Values and timing are hypothetical modelling assumptions expressed in cost units.

10. Govern the AI model and its decision rights

Transport-management systems, warehouse-management systems, telematics, enterprise resource planning, customer portals, supplier systems and spreadsheets often hold different versions of a shipment. Integration should establish common identifiers for orders, loads, routes, vehicles, drivers, depots, suppliers, invoices and payments. Without common identity and reconciliation, automated dashboards can accelerate inconsistent claims.

Optimisation and machine-learning tools can support routing, demand forecasting, arrival prediction, maintenance, pricing, supplier analysis and anomaly detection. Their use should begin with a defined decision and a baseline for comparison. Inputs, constraints, objective functions, training period, exclusions, overrides and performance should be recorded. Safety, legal, contractual and customer constraints should remain explicit rather than hidden inside a score.

A digital twin can test network alternatives before physical change. Its value depends on whether the model reproduces observed behaviour across normal, peak and disrupted periods. Validation should include back-testing, sensitivity, edge cases and operator review. Recommendations should show which constraints bind and why the result changes. Management remains responsible for the decision.

NIST describes the AI RMF as a voluntary framework for managing risks associated with AI and organises its core around govern, map, measure and manage functions.[12] Applied to transaction diligence, governance assigns accountability and permitted use; mapping defines the decision context and affected parties; measurement tests data, model and outcome risk; management sets controls, escalation and residual-risk acceptance. The model register should also identify third-party software, licences, hosting, cybersecurity, data transfers, retraining, monitoring and exit arrangements.

Model validation should be independent of the team rewarded for finding synergy. It should reproduce the baseline, test conservation of volume and capacity, challenge solver tolerances, confirm time and distance logic, inspect high-value exceptions and compare predicted outcomes with historical disruptions. Human overrides should be recorded with the reason and result. Material changes to data, code, objective weights or constraints should produce a new controlled version rather than silently replacing the case presented to the committee.

Privacy and employment considerations can arise when telematics, location, performance or scheduling data relate to identifiable people. The UK Information Commissioner's Office provides guidance on AI and data protection, including accountability and data-protection impact assessment considerations.[13] Management should obtain transaction-specific advice on lawful basis, transparency, access, retention, automated decision-making and workforce consultation in each jurisdiction.

Access, cyber and continuity require integration controls. The combined business should inventory interfaces, credentials, privileged roles, devices, data transfers, third parties, recovery procedures and incident obligations. A route or fleet initiative should not advance when the required system and fallback control are untested. The COSO framework's components of control environment, risk assessment, control activities, information and communication, and monitoring provide a useful governance architecture.[8]

11. Sequence integration through evidence gates

The first 100 days should separate continuity from structural change. Day One establishes lawful authority, cash and payment control, customer and supplier communication, system access, safety responsibilities, critical staffing, incident response and decision escalation. Network, depot, fleet and supplier changes then proceed through evidence gates suited to their risk.

Pre-close work should remain within competition and information-sharing boundaries. Clean teams, aggregated outputs and access controls may be needed where route, price, customer or capacity data are competitively sensitive. The UK CMA's merger guidance requires verifiable support for efficiencies claimed within its framework and examines whether they are timely, likely, sufficient and merger-specific.[4] The transaction team should preserve the evidence trail and obtain jurisdiction-specific competition advice before operational coordination.

The integration office should maintain one route and synergy issue register. Each finding should route to price, contract protection, Day-One control, initiative design, budget, customer action, accounting conclusion or the decision to stop. Parallel registers allow assumptions to disappear between diligence, integration and finance.

A weekly logistics value review should examine service deviations, safety, customer risk, route and fleet pilots, supplier awards, systems, workforce, one-off cost, capital, working capital and benefit evidence. The meeting should decide exceptions that require enterprise authority. Workstream updates can be handled beforehand.

The board or investment committee should receive a monthly net value bridge. It should compare the transaction case, approved plan, current forecast, validated run-rate, accounting result and realised cash. Changes should identify source, owner, reason, approval and effect. A strong governance process permits benefits to be reduced or reversed when evidence changes.

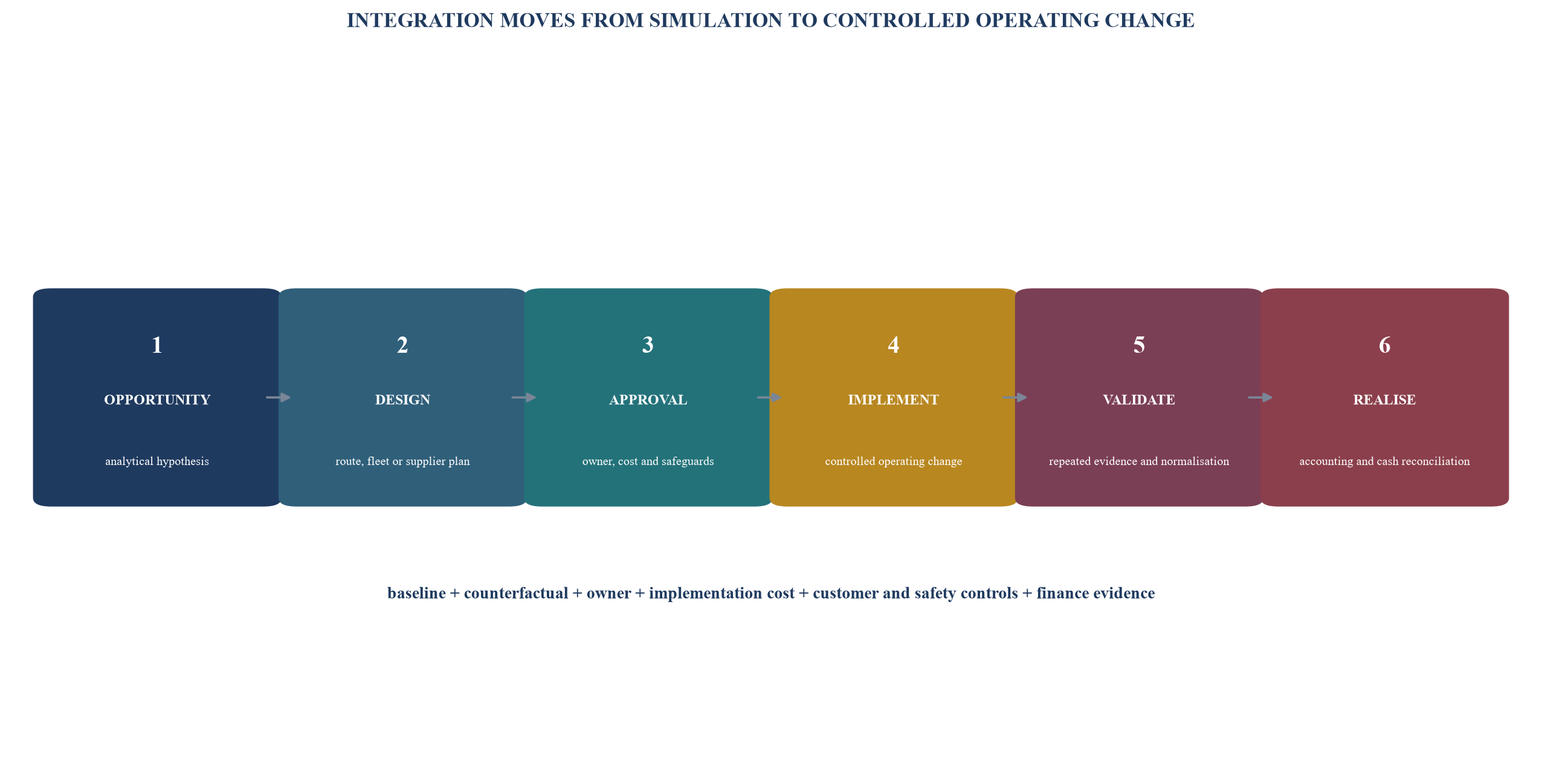

Figure 5. Integration roadmap from pre-close simulation to realised cash
Figure 5. Integration roadmap from pre-close simulation to realised cash

Each initiative moves through controlled gates; the status can move backwards when evidence fails or assumptions change.

Table 5. First-100-day logistics value programme

PeriodPrincipal workAcceptance evidenceBoard decision
pre-close planningperimeter, baseline, constraints, critical customers, safety and Day-One controlsreconciled data and legal operating boundariesapprove continuity plan and delegated authority
Day 1 to 15establish control room, incident path, data access and no-regret diagnosticsauthority, access, cash, service and safety testsapprove diagnostic priorities and pilot design
Day 16 to 35route, fleet, depot and supplier opportunity challengeinitiative records with net economics and safeguardsrelease pilot budget and capacity
Day 36 to 65run pilots, tender early waves and test systemsrepeated operational, customer and finance evidenceapprove, redesign or stop each initiative
Day 66 to 100scale accepted initiatives and lock benefit controlssigned contracts, schedules, control tests and reconciliationsapprove scale plan, capital and ownership handover
after Day 100validate recurring result and cash; retain reversalsledger, general ledger, bank and operational evidenceaccept realised value or revise the deal bridge

Timing is an illustrative management sequence; transaction facts, approvals and consultation can require a different timetable.

12. Present a decision-grade investment-committee case

Synergy reporting often uses adjusted EBITDA and run-rate measures. These measures can support management decisions when their calculation, purpose and reconciliation are controlled. The SEC's guidance states that non-GAAP adjustments can be misleading when they remove normal recurring cash operating expenses, use inconsistent treatment between periods, change accounting recognition principles or carry unclear labels.[9] The specific regulatory requirements depend on the reporting entity and jurisdiction; the underlying discipline remains useful for private-company boards.

IFRS 18 requires disclosures for management-defined performance measures within its scope, including a clear description, calculation and reconciliation to the most directly comparable specified total or subtotal.[10] A logistics synergy dashboard should similarly define every management measure and reconcile it to controlled accounting and operating records. Run-rate benefit, annualised saving, cost avoided, capacity released and realised cash should remain separate.

Value creation should be linked to cash flow before applying a valuation multiple. A buyer can model the present value of recurring after-tax cash, implementation cost, capital, working capital, risk and timing. An exit-value bridge can then separate operating performance from leverage, market multiple movement, acquisitions and cash generation. The 2025 IPEV Valuation Guidelines frame fair value around market-participant assumptions and calibration, within their scope.[11]

The board should receive downside scenarios. Route consolidation can deliver only part of planned distance reduction; a depot exit can slip; customer attrition can increase; procurement compliance can be lower than contracted; fuel, labour or interest rates can move. Scenario triggers should identify decisions and funding requirements rather than provide a single optimistic range.

The investment paper should show a value range rather than a point estimate. The low case should include only initiatives with reconciled data, feasible operating design, quantified cost and conservative timing. The central case can include options with defined dependencies and accountable owners. The high case should remain separately labelled and should not determine purchase price or financing capacity unless its evidence supports that use. Each case should reconcile recurring benefit, dis-synergy, implementation cost, capital, working capital, tax, timing and discounting.

The committee should also see a model-risk appendix. It should identify material missing data, proxy variables, forecast error, sensitivity, solver or method limitations, manual overrides, rights to use seller data, validation work and decisions deferred until access improves. The request for approval should state the maximum price, financing headroom, conditions precedent, diligence actions, integration budget and walk-away triggers that follow from the analysis.

13. Apply the framework to a hypothetical logistics acquisition

Consider a hypothetical buyer combining two regional road-logistics businesses. The businesses operate 180 vehicles across six depots, use a mixture of owned and subcontracted capacity, and serve industrial, retail and project customers. Their route records suggest overlapping trunk lanes, opposite-direction empty movement, duplicate fuel and tyre suppliers, and two depots within related catchments. These figures are modelling assumptions rather than observed market data.

The initial gross opportunity appears large. Management identifies 120 cost units per month from route and empty-distance reduction, 45 from fleet and maintenance, 60 from procurement and 25 from overhead. The integration office challenges the claim against service windows, vehicle compatibility, depot capacity, labour, customer requirements and contractual timing. It removes ineligible spend, records dual running and systems cost, and separates capacity headroom from cash.

The team builds a digital twin from twelve months of orders, transport events, telematics, depot activity, vehicle records, contracts, invoices and collections. Reconciliation removes duplicate movements, aligns customer and site identities and assigns confidence to missing cost fields. The optimisation process tests distance-led, contribution-led, service-balanced and resilience-led objectives under normal, peak and disruption scenarios. The cheapest network fails two critical customer windows and relies on one depot above its practical peak capacity. The balanced design retains additional line-haul capacity and produces a lower recurring saving with stronger service performance.

Three route pilots demonstrate 68 units of recurring monthly benefit after service protection, handling and planning cost. Fleet analysis shows that twelve vehicles can be redeployed after peak testing, while six older assets need additional maintenance before any disposal decision. Procurement waves produce signed terms, followed by lower realised benefit because volumes shift toward specialist tyres and subcontracted capacity. The depot team delays one exit after peak modelling shows an unacceptable resilience risk.

The investment committee receives a low, central and high case. The low case includes route pairs and supplier changes supported by reconciled data and executable contracts. The central case adds depot and fleet options after capital, consultation and customer dependencies. The high case retains further modelled opportunity outside the purchase-price contribution. The committee approves a price and financing structure based on the central case, reserves implementation capital and makes access to specified data a closing condition.

The board later receives a lower benefit than the original headline and a stronger evidence base. It can release investment selectively, protect liquidity and explain the path from premium paid to cash realised. The result illustrates the purpose of AI-assisted network diligence: disciplined conversion of a large solution space into accountable operating choices, including decisions to delay or reject apparent savings.

14. Operating and technology implementation principles

First, establish one source of truth for initiative identity, baseline, economics, owners and evidence. Operational systems remain sources for movements, assets and suppliers; the ledger controls the value claim and its history. Second, freeze definitions before reporting. Every unit, period, currency, perimeter and sign convention should be explicit.

Third, place customer, safety, workforce and regulatory gates beside the economics. A benefit cannot advance when a mandatory gate is unresolved. Fourth, give finance independent validation rights. Operating teams own delivery; finance owns the approved measurement method, accounting reconciliation and cash evidence. Fifth, preserve reversals. A benefit that later fails should reduce the bridge without deleting the earlier record.

Sixth, use technology to improve decisions and evidence. Models should expose assumptions, constraints and sensitivity. Seventh, manage time through contract and operating milestones rather than an undifferentiated annual target. Finally, keep the board focused on exceptions, decisions, cash and risk. Detailed activity reporting belongs in workstreams.

15. Limitations and future research

This framework does not determine the optimal network for a specific transaction. Freight modes, geographies, customer contracts, labour models, safety regimes, tax, permits, fleet technology, property, financing and accounting policies vary materially. Real analysis requires validated transaction data and qualified advice.

The worked examples use hypothetical modelling assumptions and do not estimate market-wide synergy. Benefits cannot be transferred from one acquisition to another without a fresh baseline and counterfactual. Historical route data can also understate latent demand, disruption and future regulation.

Further research can test how route and depot designs perform under extreme weather, border disruption, changing emissions rules and autonomous or electric fleets. It can also examine causal measurement methods for separating acquisition effects from market and management changes, and the governance of AI-assisted network decisions.

Digital-twin standards and practices continue to develop. ISO 23247 describes a digital-twin framework for manufacturing, while NIST has published work on digital twins and cybersecurity for manufacturing systems.[14][15] Logistics transactions need further research on interoperable event data, calibrated uncertainty, federated modelling across clean-team boundaries and validation when pre-close data cannot be transferred. Research is also needed on whether network recommendations create indirect competition, employment, environmental or customer effects that conventional synergy models omit.

16. Conclusion: from optimisation to accountable value

AI-assisted network design can turn a broad acquisition thesis into a controlled set of transaction choices. It begins with a reconciled perimeter and counterfactual, creates a digital twin that reproduces observed operations, tests route and node overlap against service reality, measures sensitivity, grades confidence and records customer, safety, workforce, capital and working-capital consequences in the same initiative.

The board receives a traceable bridge from transaction thesis to operating evidence. That bridge can support faster decisions, disciplined investment and credible value reporting. Its strength comes from the willingness to reduce, delay or reverse claims when the evidence changes.

References

  1. IFRS Foundation. IFRS 3 Business Combinations. Official standard page and issued requirements. https://www.ifrs.org/issued-standards/list-of-standards/ifrs-3-business-combinations/
  2. IFRS Foundation. IAS 37 Provisions, Contingent Liabilities and Contingent Assets. Issued requirements, including restructuring provisions. https://www.ifrs.org/content/dam/ifrs/publications/pdf-standards/english/2021/issued/part-a/ias-37-provisions-contingent-liabilities-and-contingent-assets.pdf
  3. IFRS Foundation. IAS 36 Impairment of Assets. Official standard page. https://www.ifrs.org/issued-standards/list-of-standards/ias-36-impairment-of-assets/
  4. UK Competition and Markets Authority. Merger Assessment Guidelines, updated 3 June 2026. https://www.gov.uk/government/publications/merger-assessment-guidelines/merger-assessment-guidelines-html-version
  5. World Bank. Logistics Performance Indicators 2.0 and Connecting to Compete 2023. https://lpi.worldbank.org/en/about and https://lpi.worldbank.org/sites/default/files/2023-04/LPI_2023_report_with_layout.pdf
  6. US Bureau of Transportation Statistics. Freight Analysis Framework Version 5. https://www.bts.gov/faf/faf5
  7. UK Government Data Quality Hub. The Government Data Quality Framework. https://www.gov.uk/government/publications/the-government-data-quality-framework/the-government-data-quality-framework
  8. Committee of Sponsoring Organizations of the Treadway Commission. Internal Control; Integrated Framework, 2013 executive summary. https://www.coso.org/_files/ugd/3059fc_ada7bcee03a2437c9bf7f46948da818d.pdf
  9. US Securities and Exchange Commission. Non-GAAP Financial Measures Compliance and Disclosure Interpretations, updated 13 December 2022. https://www.sec.gov/rules-regulations/staff-guidance/corporation-finance-interpretations/non-gaap-financial-measures
  10. IFRS Foundation. IFRS 18 Presentation and Disclosure in Financial Statements, 2026 issued requirements, paragraphs 121 to 124. https://www.ifrs.org/content/dam/ifrs/publications/pdf-standards/english/2026/issued/part-a/ifrs-18-presentation-and-disclosure-in-financial-statements.pdf
  11. International Private Equity and Venture Capital Valuation Board. IPEV Valuation Guidelines 2025. https://www.privateequityvaluation.com/Valuation-Guidelines
  12. National Institute of Standards and Technology. Artificial Intelligence Risk Management Framework 1.0. https://www.nist.gov/publications/artificial-intelligence-risk-management-framework-ai-rmf-10
  13. UK Information Commissioner's Office. Guidance on AI and data protection. https://ico.org.uk/for-organisations/uk-gdpr-guidance-and-resources/artificial-intelligence/guidance-on-ai-and-data-protection/
  14. International Organization for Standardization. ISO 23247-1:2021 Automation systems and integration; Digital twin framework for manufacturing. https://www.iso.org/standard/75066.html
  15. National Institute of Standards and Technology. Digital twins for advanced manufacturing. https://www.nist.gov/programs-projects/digital-twins
  16. OECD. Recommendation of the Council on Artificial Intelligence. https://legalinstruments.oecd.org/en/instruments/OECD-LEGAL-0449
  17. European Union. Regulation (EU) 2024/1689 laying down harmonised rules on artificial intelligence. https://eur-lex.europa.eu/eli/reg/2024/1689/oj
  18. UK Department for Transport. Future of Freight: a long-term plan. https://www.gov.uk/government/publications/future-of-freight-a-long-term-plan
  19. International Maritime Organization. Guidelines on maritime cyber risk management. https://www.imo.org/en/ourwork/security/pages/cyber-security.aspx
  20. UK Competition and Markets Authority. Merger remedies guidance, updated December 2025. https://www.gov.uk/government/publications/merger-remedies

Appendix A. Minimum Ledger Fields: A1. Initiative identity and scope

Each initiative should have a stable identifier, descriptive name, value category, affected entities, routes, depots, assets, suppliers, customers and systems. The record should state the baseline period, measurement unit, currency, perimeter, counterfactual and the source records used to reproduce the calculation. Any overlap with another initiative should be identified before approval.

A2. Economics and timing

The record should separate gross recurring benefit, recurring dis-synergy, one-off operating cost, capital expenditure, working-capital effect, tax and net cash by period. It should show the first operational change, first validated result, full run-rate date and cash-realisation date. Capacity released for growth or resilience should be stated separately from cost removed.

A3. Ownership and safeguards

The ledger should name the executive sponsor, operating owner, finance validator, data owner and decision authority. Customer, safety, workforce, legal, regulatory, cyber and business-continuity gates should identify the required evidence and the person authorised to accept it. A material unresolved gate should prevent the benefit from advancing.

A4. Evidence and change history

Every status change should retain its date, evidence, reviewer and decision. The record should preserve the approved case, current forecast, validated run-rate, accounting result, realised cash, changes and reversals. Source-system links, signed contracts, pilot results, general-ledger reconciliations and bank evidence should remain accessible under the organisation's retention and access policies.

Questions, answered

AI Network Design in Logistics Deals: frequently asked questions

It should ask which route, node, fleet and service changes create value against a defined standalone counterfactual; which constraints bind; how the result changes under peak and disruption scenarios; and which evidence could invalidate the conclusion.

Route overlap is an analytical signal. Executable value also requires compatible service windows, assets, capacity, contracts, licences, workforce, systems and resilience.

The model should reproduce a reconciled operating baseline, use controlled definitions and identifiers, expose objective functions and constraints, pass historical and edge-case tests, show sensitivity and maintain accountable version control.

The committee should distinguish modelled opportunity from operationally feasible, approved and finance-validated value. Purchase-price contribution should reflect evidence, implementation cost, timing, downside and financing headroom.

The buyer can run normal, peak and disruption scenarios; test customer windows and contract constraints; model node and fleet capacity; review high-value exceptions with operators; and define post-close pilots and reversal authority.

Validation should include independent modelling or model-risk expertise, operating owners, commercial leaders, finance, technology, legal and relevant safety or regulatory specialists.

Transaction-specific competition advice should determine access. Clean teams, aggregation, purpose limits, access controls and controlled outputs may be appropriate before closing.

The team should revalidate data, run controlled pilots, protect customers and continuity, track implementation cost and capital, compare results with the approved baseline and reconcile validated benefits to accounting and cash evidence.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
