Power, Compute and Resilience · Equipment Finance

The Transformer and Turbine Bottleneck: Financing around Long-Lead Energy Equipment

A global financing framework for production-slot evidence, gated equipment payments, project completion and delivery risk across power infrastructure.

The Transformer and Turbine Bottleneck: Financing around Long-Lead Energy Equipment
Quick answer

Long-lead equipment becomes financeable when the production slot is verified, design and interfaces are controlled, capital follows independently evidenced milestones, and completion remains funded through delivery and commissioning.

Abstract

The expansion of electricity networks, artificial-intelligence infrastructure, industry and dispatchable generation has increased demand for transformers, turbines, switchgear, cables and related equipment. Manufacturing expansion is under way, although new factories, skilled labour, specialised materials and test capacity require time. The commercial constraint is therefore a complete equipment-delivery system rather than a simple product shortage.

This paper develops a global financing framework for long-lead transformers and gas turbines. It maps the path from functional requirement and specification through quotation, production-slot allocation, manufacturing, factory acceptance, transport, installation, commissioning and long-term service. It distinguishes a non-binding quotation from an accepted and secured manufacturing position, and it connects each stage to capital at risk.

The analysis draws on International Energy Agency supply-chain research; United States Department of Energy and North American Electric Reliability Corporation materials; Ofgem's advanced-procurement and supply-chain work in Great Britain; official Singapore generation procurement; public Indian transmission delivery data; UAE electricity-system policy; and 2025 reporting from major equipment manufacturers. These sources describe different jurisdictions and commercial positions.

Project decisions require current transaction-specific evidence. Six figures present the equipment-to-cash chain, production-slot evidence ladder, milestone funding architecture, global procurement response map, downside transmission chain and control dashboard. Six tables provide a diligence file, payment-control matrix, geographic comparison, hypothetical procurement case, stress matrix and 120-day implementation plan.

Every value, rate, date, probability and result in the worked example is a hypothetical management assumption created solely to demonstrate the method. Equipment selection, grid compliance, generation design, fuel, emissions, permits, cybersecurity, logistics, insurance, sanctions, export controls, tax, accounting, financing and legal treatment require qualified professional review.

This paper provides general information for professional audiences and does not provide engineering, legal, regulatory, environmental, tax, accounting, valuation, credit or investment advice.

JEL Classification: G31, G32, L94, O33, Q40, Q48

Keywords: transformers, gas turbines, energy equipment, supply chain, project finance, procurement, data centres, grid infrastructure, completion risk, global infrastructure

This Matchpoint Insight presents the web edition of Matchpoint Partners' research. The supporting paper contains the full framework, structures, worked examples and source material.

Read the full research paper   Explore our Data Centres practice

1. Treat equipment delivery as a financeable critical path

Power-intensive infrastructure earns cash only after a complete electrical system operates. A data centre needs dependable transformation and distribution. A new generation plant needs turbines, generators, transformers, control systems, fuel systems and grid connection. A transmission project needs transformers, cables, switchgear, protection, communications and civil works.

The International Energy Agency's 2025 transmission supply-chain survey found procurement periods of two to three years for cables and up to four years for large power transformers. Average lead times for cables and large transformers had almost doubled since 2021.[1] NERC's 2025 Summer Reliability Assessment reported average transformer lead times of around 120 weeks in 2024 and a range of 80 to 210 weeks for large transformers.[3]

Turbine markets have also tightened. Siemens Energy reported 194 gas-turbine sales in fiscal 2025 and a Gas Services order backlog of EUR 54 billion.[8] GE Vernova reported approximately USD 150 billion of total backlog for 2025 and described data centres as a significant driver of future gas-turbine demand.[9][10] Backlog figures represent each manufacturer's published reporting definition and do not establish a delivery date for a particular buyer.

Financing should follow the actual delivery path. The committee needs to know which equipment controls first power, which actions secure it, when capital leaves, when title and risk transfer, which dependencies can delay it and which protections survive supplier or project stress.

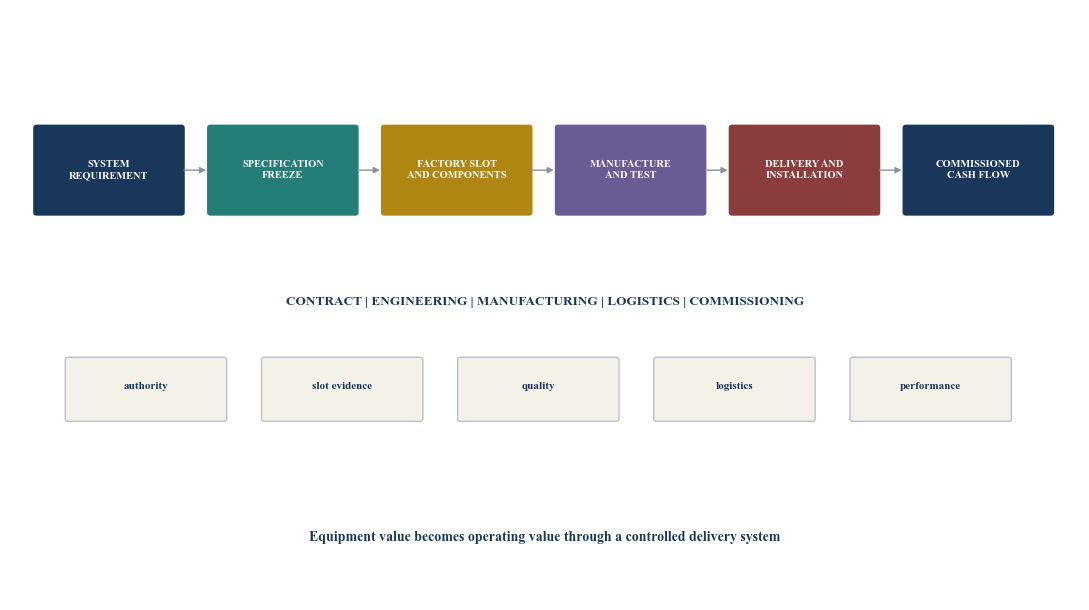

Figure 1. Equipment-to-operating-cash dependency chain
Figure 1. Equipment-to-operating-cash dependency chain Open full-size figure

Author framework. Each stage requires current technical, contractual and financial evidence.

2. Define the financeable equipment perimeter

The financeable object extends beyond the main transformer or turbine. It can include engineering, drawings, software, protection, auxiliary systems, controls, generator, cooling, enclosures, bushings, tap changers, excitation, switchgear, spare parts, tools, transport frames, storage, installation supervision, testing, training and long-term service.

The functional requirement should be translated into a controlled bill of supply. Interfaces need named owners. A transformer requires compatibility with system voltage, frequency, impedance, vector group, insulation, protection, losses, cooling, footprint and transport limits. A turbine package requires compatibility with output, ambient conditions, fuel, emissions, heat-rate, start profile, grid code, balance of plant and service regime.

The transaction perimeter should identify the buyer, project company, supplier, factory, subcontractors, logistics providers, installers, operator, utility and lenders. It should also identify who owns designs, components, work in progress and completed equipment at every stage.

Finance should cover only an evidenced perimeter. Undefined balance-of-plant scope can leave an expensive core machine unable to operate. A low equipment price can be offset by interfaces, civil works, fuel treatment, grid-code modifications, spares, warranty limits or service obligations.

3. Prove the production slot

A supplier quotation can state price and expected delivery while remaining subject to capacity, specification and contract. A reservation can expire. An accepted order can remain conditional on deposit, credit support, export approval, technical data or notice to proceed.

Production-slot evidence should identify the factory, product platform, capacity window, critical component allocation, engineering start, test-bay window and delivery sequence. The investor should reconcile supplier correspondence, contract schedules, payment evidence, drawings, manufacturing plans and independent inspection.

The evidence should reach beyond the prime contractor where possible. Large transformers rely on grain-oriented electrical steel, copper or aluminium, insulation, bushings, tap changers and specialised transport. Turbines rely on forgings, castings, blades, combustion systems, generators, controls and qualified repair capacity. A prime production slot can still move when a critical component or test bay is unavailable.

Evidence has a date. Factory allocation can change after late specification decisions, missed payments or buyer delay. The project should maintain written confirmation tied to the current design and payment status.

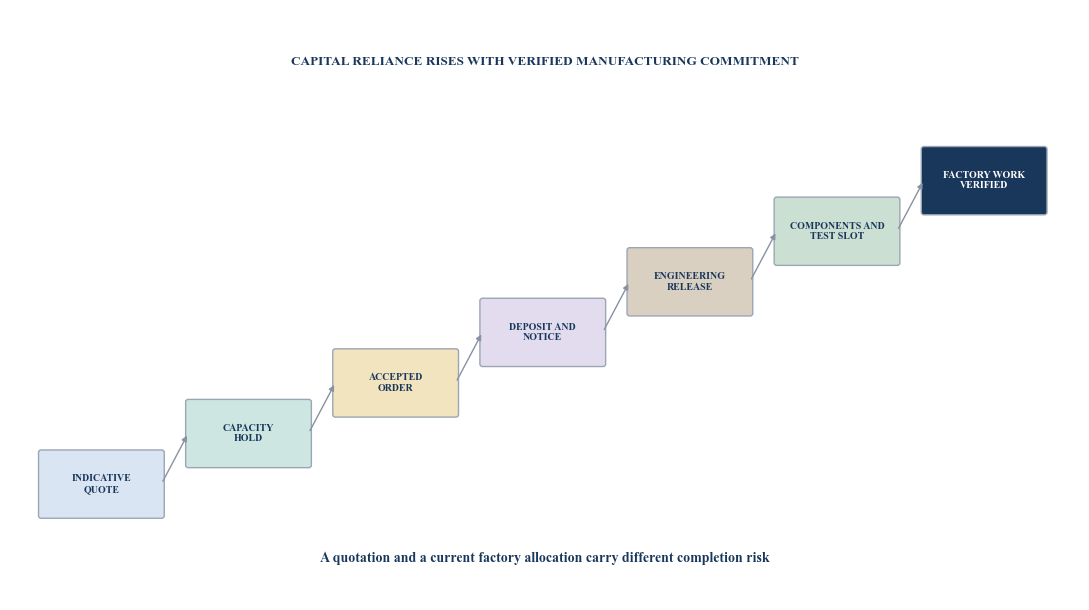

Figure 2. Production-slot evidence ladder
Figure 2. Production-slot evidence ladder Open full-size figure

Author framework. Financing reliance increases with accepted, current and independently verifiable evidence.

Table 1. Long-lead equipment diligence file

Diligence fieldPrimary evidencePrincipal riskDecision test
Functional requirementapproved system design and load caseequipment cannot perform required servicedoes the duty match the complete operating case?
Technical specificationfrozen data sheets and interface registerredesign consumes slot and contingencyare every critical parameter and owner approved?
Production slotsupplier confirmation and factory plandelivery date remains indicativeis the slot tied to this buyer, design and payment?
Critical componentsbill of material and procurement statusupstream item delays main machinewhich components control manufacture and test?
Price and escalationexecuted commercial schedulecommodity, labour or currency exposurewhich amounts can change and under what formula?
Milestone paymentscontract, invoices and certificatescash leaves before value is verifieddoes each payment follow independent evidence?
Title and securitycontract, identification and filingslender cannot recover work in progresswhen and where does enforceable title transfer?
Quality and testinginspection plan and acceptance procedurelatent defects or failed testswho witnesses, rejects and requires remediation?
Logisticsroute survey, permits, carrier and insuranceequipment cannot reach or enter siteis the complete route executable on the required date?
Installation and commissioningmethod, resources and grid requirementsdelivered machine remains inoperableare interfaces, specialists and test power available?
Warranty and servicewarranty, security and service planremedy is slow, capped or inaccessibledoes protection support the operating requirement?
Complianceexport, sanctions, origin and local approvalsdelivery or use becomes unlawfulhave qualified advisers cleared the current transaction?

Required evidence depends on the equipment, supplier, contract, project and jurisdiction.

4. Freeze the specification without freezing optionality

Custom engineering can improve system performance while increasing manufacturing time and switching cost. Standard platforms can improve availability and serviceability while requiring site or system adaptation. The decision should compare complete delivered service.

Specification governance needs an approved baseline, interface register, change-control process and commercial consequence. Every proposed change should state the technical need, schedule effect, price effect, factory effect, warranty effect and alternative.

Standardisation can increase purchasing power across a portfolio. It can create common spares, training and service. Ofgem's 2026 supply-chain work in Great Britain identifies demand visibility and procurement practices as material to manufacturer confidence.[5] The United States Department of Energy reports more than 80,000 distribution-transformer varieties and describes standardisation as a potential way to improve interoperability and production time.[2]

Optionality should be engineered in advance. Alternative approved materials, accessories, cooling configurations, transport arrangements and factories can reduce dependence on a single path. A late attempt to substitute equipment can trigger new studies, permits, foundations, protection design and customer approval.

5. Connect factory capacity to project capacity

Manufacturer expansion supports future supply while carrying its own delivery schedule. Siemens Energy announced a EUR 220 million expansion of its Nuremberg transformer factory, targeting approximately 50 percent additional capacity with new areas expected in 2028.[11] Hitachi Energy announced multiple transformer investments, including an additional USD 250 million through 2027 and a Thailand expansion expected to increase local production capacity by 60 percent by the end of 2027.[12][13]

These announcements demonstrate investment response. They do not establish allocation for an individual buyer. New buildings require equipment, staff, qualification and ramp. Existing factories can improve throughput through automation, standardisation, shifts, debottlenecking and supply-chain agreements.

The buyer should distinguish supplier-wide announced capacity, product-family capacity, factory capacity, test capacity and its own allocated slot. A supplier can report a large backlog and still provide a credible date for a defined platform, or report expansion while a specific test bay remains constrained.

Concentration should be mapped. Several bidders can rely on the same component producer or sub-supplier. Alternative brands can rely on the same port, specialised transporter or installation workforce.

6. Build an evidence-led payment architecture

Long-lead equipment often requires deposits and progress payments before delivery. Those payments fund engineering, materials, components and manufacturing. They also create buyer exposure to delay, quality failure, supplier stress and project cancellation.

Each payment should correspond to verified value. A deposit can follow an accepted order, capacity allocation and appropriate security. Engineering payments can follow approved deliverables. Material payments can follow identifiable, compliant components. Manufacturing payments can follow inspection of completed work. Shipment payment can follow factory acceptance, documentation, title and transport readiness.

Security can include advance-payment guarantees, performance bonds, parent guarantees, letters of credit, retention, escrow, direct agreements and insurance. The instrument should be checked for issuer, jurisdiction, expiry, conditions, reduction, assignment and enforceability.

Title language should match physical identification and local law. A contract clause that transfers title to generic work in progress may provide limited recovery. Serial numbers, segregation, marking, inventory records, inspection rights and filings can strengthen control where legally effective.

Figure 3. Hypothetical milestone funding architecture
Figure 3. Hypothetical milestone funding architecture Open full-size figure

Percentages are hypothetical management assumptions created solely to demonstrate gated funding.

Table 2. Milestone payment and control matrix

MilestoneEvidence before paymentPrincipal protectionStop condition
Capacity reservationbinding hold, factory and expiryrefundable fee or suitable guaranteeallocation remains conditional or unidentified
Contract depositexecuted contract and noticeadvance-payment guaranteesecurity is missing, mismatched or expires early
Engineering releaseapproved drawings and interface registerchange control and schedule remedycritical specification remains open
Critical materialssupplier evidence and identificationtitle, segregation and inspectionorigin, quality or allocation is unclear
Manufacturing progressindependent progress certificatedirect inspection and cure rightsdelay exceeds funded recovery plan
Factory acceptancepassed tests and complete dossierretention and performance securitymaterial test failure remains unresolved
Shipmenttitle, permits, route and insurancecargo cover and controlled documentssite or route is not ready
Deliverycondition report and secure storagecustody, preservation and warrantydamage or missing items prevent installation
Commissioningcompleted performance testsfinal retention and warranty startoutput, efficiency or grid compliance fails

Controls require transaction-specific legal, technical, insurance and credit review.

7. Underwrite supplier and counterparty capacity

The supplier credit case includes financial strength, backlog quality, cash conversion, warranty exposure, factory execution, labour, components and service capability. A strong group balance sheet can coexist with an overloaded product line. A specialised supplier can have excellent execution and limited liquidity.

The buyer should understand whether the contracting party owns the factory, relies on an affiliate or subcontracts material scope. Parent support should be explicit. Guarantees should state the supported obligations and remain effective through the relevant period.

Backlog requires interpretation. It can include cancellable orders, service obligations, framework volumes and projects awaiting conditions. The investor should use published definitions and transaction evidence. Manufacturer statements can support market context and should not replace direct confirmation.

Counterparty risk also exists on the project side. Suppliers can suspend or reallocate capacity after missed payments, late data or delayed site readiness. The completion plan should fund buyer obligations and preserve decision rights.

8. Finance equipment before the full project closes

Early equipment commitments can preserve schedule while land, permits, grid agreements, customer contracts and long-term financing remain incomplete. This creates an interface between development capital and project finance.

An early-equipment facility can finance deposits and verified manufacturing milestones. Repayment can come from financial close, equity, asset sale or operating finance. Lenders need a defined project path, sponsor support, equipment rights, supplier agreements, assignment, insurance, valuation and completion liquidity.

The equipment can have limited standalone recovery. Transformers are frequently engineered for a specific system. Large turbines require site-specific balance of plant, permits, fuel, installation and service. Resale can involve delay, redesign, transport and warranty consent.

Credit should therefore depend on both collateral and completion. The base case needs a funded path to delivery and operation. A recovery case should use realistic time, cost, buyer universe, modifications and legal control.

9. Use portfolio procurement and advanced funding

Portfolio buyers can aggregate demand, standardise equipment, reserve manufacturing capacity and sequence projects. This can improve supplier visibility and reduce repeated procurement. It can also create take-or-pay, allocation and rebalancing risk.

Great Britain's Ofgem introduced an Advanced Procurement Mechanism in March 2025 to allow transmission owners to book supply-chain capacity earlier within the price-control framework.[4] The mechanism provides a regulatory example of financing before individual project readiness. Its legal and regulatory treatment is specific to Great Britain.

A commercial portfolio framework should define minimum volume, call-off process, allocation priority, specification families, price adjustment, cancellation, substitution, transfer, delivery windows and unused capacity. It should prevent a delayed project from consuming a slot needed by a ready project.

Financing can sit at portfolio, utility, project or equipment-vehicle level. The allocation of cost and security should follow the party controlling the slot and receiving the benefit.

10. Compare geographic procurement responses

The equipment constraint is global, while institutional responses differ. North American sources emphasise transformer lead times, standardisation, domestic manufacturing and reliability. Great Britain is using advanced procurement and supply-chain reporting within a regulated network model.

Singapore's Energy Market Authority launched a 2026 request for proposal for new hydrogen-ready combined-cycle gas-turbine generation to be operational in 2031 and 2032, including units of at least 600 megawatts.[14] The timetable demonstrates central coordination between demand planning, generation procurement and equipment delivery.

India's Central Electricity Authority publishes project-level transmission delivery reporting, including transformation capacity, material receipt, construction progress and reasons for delay.[15] This type of physical-progress disclosure can support portfolio monitoring.

The UAE Ministry of Energy and Infrastructure describes national grid investment and a unified monitoring centre across the four utilities.[16][17] These materials provide system context. A project still needs its own utility, equipment and contract evidence.

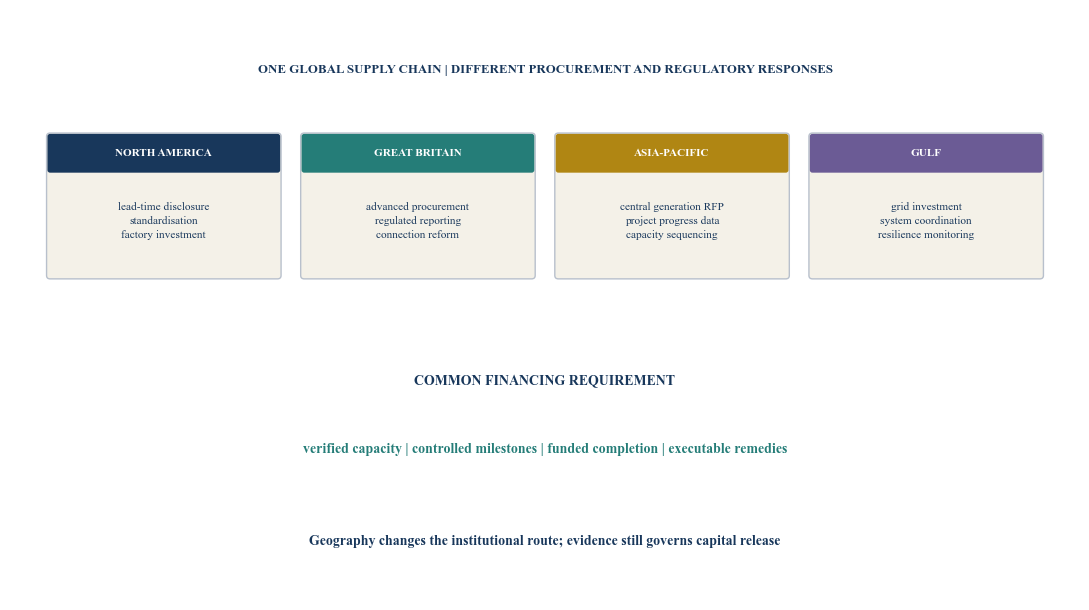

Figure 4. Global procurement response map
Figure 4. Global procurement response map Open full-size figure

Author synthesis of selected official approaches. Each jurisdiction has distinct laws, institutions and market structures.

Table 3. Selected geographic procurement context

GeographyPublished contextIllustrative financing implicationRequired project evidence
North Americalong transformer lead times and factory investmentearly reservation, standardisation and supplier diligencefactory, component, testing and delivery proof
Great Britainadvanced procurement within regulated transmissioncapacity can be booked before individual project deliveryregulatory allowance, portfolio allocation and reporting
Singaporecentral RFP for future CCGT capacitygeneration and equipment timetable can be coordinated centrallyaward, permits, fuel, turbine slot and completion funding
Indiaproject-level transmission progress reportingfinance can follow visible materials and construction milestonescontract, delivered equipment, site progress and commissioning
Gulfgrid investment, generation expansion and national coordinationequipment can support large integrated infrastructure programmesutility interface, import, logistics, local permits and service
Global OEM marketlarge backlogs and manufacturing expansionsupplier strength and allocation require separate reviewbuyer-specific accepted order and current production status

This comparison summarises cited official materials and does not state a complete legal or market position.

11. Control price, currency and escalation

Equipment price can be fixed, indexed, provisional or subject to change after specification. Escalation can reference metals, labour, energy, logistics, foreign exchange or published indices. Duties, tariffs, taxes and localisation requirements can change delivered cost.

The model should separate base price, options, spares, service, logistics, civil interfaces, taxes, security cost, owner contingency and financing. It should identify the currency and date of every cash flow.

Hedging should match the payment schedule and contractual reset rules. A hedge can create collateral or liquidity requirements. A delayed milestone can leave a hedge misaligned with the underlying payment.

Price protection should be tested with schedule protection. A fixed price offers limited benefit if an uncapped delay postpones project revenue. Liquidated damages, caps, exclusions and force-majeure provisions require qualified review.

12. Treat logistics as engineered scope

Large transformers and turbines can exceed ordinary road, rail, port and lifting limits. Delivery requires route surveys, bridge and road analysis, port capacity, permits, escorts, cranes, specialised trailers, weather windows and site access.

The equipment dimensions and weight can change during engineering. The route should be revalidated against the final transport configuration. Temporary works can require land rights and approvals.

Incoterms allocate specified delivery obligations and risk within their defined use. They do not replace a complete logistics plan. Insurance should address cargo, delay in start-up, storage, handling, installation and testing where appropriate.

Preservation is part of logistics. Equipment stored before installation can require controlled humidity, heaters, inspections, oil management, rotation, security and manufacturer procedures. Warranty periods should align with realistic installation and commissioning.

13. Integrate installation, commissioning and service

Factory completion is an intermediate milestone. The site needs foundations, buildings, fuel, grid interface, cabling, auxiliaries, cooling, protection, controls, communications and qualified teams.

Commissioning should define mechanical completion, energisation, first fire, synchronisation, reliability run, performance test and acceptance. Test conditions should specify ambient adjustment, fuel quality, measurement tolerance, output, heat rate, losses, sound, vibration and emissions as relevant.

Service planning begins before operation. Turbine economics can depend on inspections, parts, outages, upgrades and long-term service agreements. Transformer service can depend on oil testing, monitoring, bushings, tap changers, spares and repair capability.

The financier should understand which failure modes require factory support, which can be repaired locally and how long critical spares take. Service concentration can persist long after equipment delivery.

14. Protect quality, provenance and cybersecurity

Quality plans should state applicable standards, approved suppliers, hold points, witness points, test procedures, document requirements and non-conformance control. Independent technical advisers should have direct access where appropriate.

Provenance matters for quality, sanctions, export control, tariffs, local content and security. The bill of material should identify critical components and origin to the degree required by the transaction and law.

Digital controls and remote service create cybersecurity dependencies. FERC's 2025 supply-chain action directed reliability-standard revisions concerning supply-chain risk management for applicable United States bulk-power entities.[6] Its jurisdiction and requirements should not be applied automatically elsewhere.

The project should inventory software, firmware, remote access, updates, credentials, data flows and support obligations. Cyber review should connect procurement, commissioning and operations.

15. Allocate delay, cancellation and change risk

Delay can originate with buyer data, supplier engineering, sub-suppliers, factory labour, testing, export approvals, logistics, permits, site readiness or grid availability. The contract should distinguish responsibility and evidence.

Cancellation terms can escalate as committed cost increases. The buyer should know the amount at risk at every date and whether the equipment or slot can transfer to another project. The supplier should know whether buyer credit and project readiness support the reservation.

Change provisions should address price, date, cancellation, capacity and warranty. A buyer-directed change should not automatically excuse unrelated delay. A supplier change should require technical equivalence and approval.

Direct agreements can provide notice, cure, step-in, assignment and continued performance for lenders. Their practical value depends on supplier consent, financing documents, law and the project's ability to complete.

16. Demonstrate a hypothetical procurement case

Consider a hypothetical 600-megawatt generation and data-infrastructure power programme. Route A waits for full project close before placing a turbine and transformer order. Route B uses sponsor-backed early-equipment finance to secure defined slots after technical and commercial diligence.

Route A commits no early equipment cash and reaches financial close in month twelve. Its hypothetical first-power date is month sixty. Route B pays a secured deposit in month three, releases engineering in month six and reaches financial close in month twelve. Its hypothetical first-power date is month forty-eight.

Route B requires AED 420 million of early commitments, of which AED 300 million is financed. Hypothetical interest, fees, security and owner cost add AED 38 million. Earlier customer and capacity cash has a hypothetical present value advantage of AED 210 million. Reduced idle-site and escalation cost adds AED 74 million. A risk reserve of AED 62 million covers cancellation, rework and delay scenarios.

The hypothetical net advantage is AED 184 million before project-specific tax, accounting and valuation review. Every amount, date, rate, probability and result is a hypothetical management assumption created solely to demonstrate the framework.

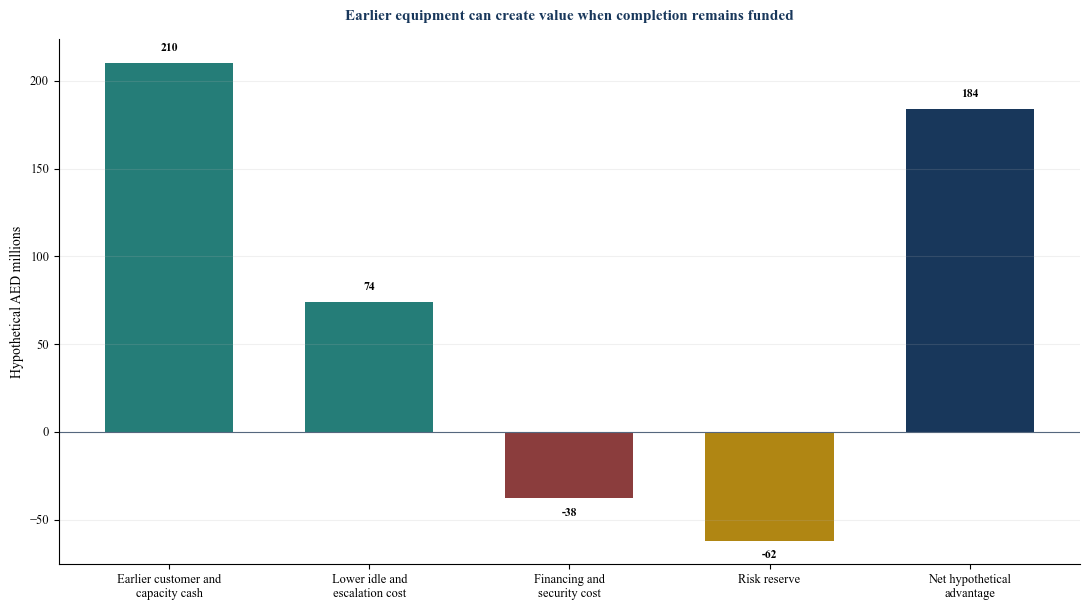

Figure 5. Hypothetical early-equipment value bridge
Figure 5. Hypothetical early-equipment value bridge Open full-size figure

Every value is a hypothetical management assumption in AED millions created solely to demonstrate the method.

Table 4. Hypothetical procurement-route comparison

MeasureRoute A: order after closeRoute B: early-equipment financeDecision relevance
Early equipment commitmentAED 0AED 420mcapital placed before full project close
Early-equipment facilityAED 0AED 300mdedicated funded procurement
Financial closemonth 12month 12common long-term financing date
Hypothetical first powermonth 60month 48twelve-month timing difference
Equipment evidencequotation until closeaccepted order, slot and gated milestonesdelivery confidence differs
Earlier customer and capacity cash PVbaselineAED 210m advantagedated operating cash benefit
Lower idle-site and escalation PVbaselineAED 74m advantageavoided carry and price exposure
Finance and security costbaselineAED 38m deductioncost of early commitment
Completion risk reservebaselineAED 62m deductioncancellation, rework and delay
Hypothetical net advantagebaselineAED 184mscenario result before professional review

Every value and date is a hypothetical management assumption created solely to demonstrate the framework.

17. Stress the complete equipment path

The base case should be stressed through connected events. A slot-loss case delays manufacturing and can reprice the order. A component case delays factory completion. A test-failure case requires rework and consumes the test bay. A logistics case leaves completed equipment at the factory, port or storage site.

A project-delay case can create cancellation exposure, storage, preservation and warranty burn. A supplier-stress case can stop work while the buyer attempts to enforce security or recover components. A foreign-exchange case changes deposits and hedging liquidity.

The model should show project cash, equipment cash, debt draw, equity need, security expiry, customer cash and completion headroom by date. It should identify the earliest funding shortfall and the decision available before it occurs.

Mitigations should be executable. They can include alternative components, technical redesign, slot transfer, portfolio reallocation, supplier support, additional security, bridge finance, temporary generation, phased capacity or a different site. Each action requires time, authority, cost and technical approval.

Table 5. Long-lead equipment stress matrix

StressImmediate effectCash and value transmissionRequired evidence and response
Production slot movesdelivery date slipsrevenue delay, carry and possible repricingwritten factory cause, revised plan and funded liquidity
Critical component delaymanufacture cannot progressmilestone and test sequence shiftsub-supplier status and approved alternative
Factory test failurerework and retest requiredpayment hold, delay and remediation costwitnessed result and agreed cure plan
Supplier financial stresswork or warranty support weakensrecovery and completion funding increasesecurity, title, direct rights and replacement route
Buyer project delaysite is not ready for equipmentstorage, preservation and cancellation costintegrated project schedule and funded holding plan
Logistics failureequipment cannot reach siteidle equipment and installation delayfinal route, permits, carrier and contingency
Currency or tariff movedelivered price changescapital requirement and hedge cash changecurrent exposure and aligned hedge plan
Specification changedesign and interfaces reopenslot, price, permits and foundations moveauthorised change case and full consequence
Commissioning failurecommercial operation delayedcustomer cash and performance security affectedtest evidence, root cause and repair resources
Service bottleneckoutage or repair duration risesavailability and life-cycle cost worsenspares, specialists, service agreement and alternatives

Scenario magnitudes and mitigations require current transaction, supplier, technical and legal evidence.

18. Operate through one equipment-control dashboard

The dashboard should connect contract, engineering, factory, components, quality, logistics, site, commissioning, service and cash. Every metric needs a definition, source, date, owner and response threshold.

Core fields include specification-freeze status, factory, slot confirmation date, engineering release, critical-component status, manufacturing percentage, test-bay date, inspection findings, paid amount, secured amount, title status, guarantee expiry, shipment date, route readiness, site readiness, commissioning date and remaining liquidity.

Forecast dates should preserve their movement history. The committee should distinguish supplier contract date, factory forecast, independent adviser view and management assumption.

Exceptions should produce decisions. A slipping component date can require an alternative approval before the main schedule moves. A guarantee expiry can require extension before payment. A site delay can trigger storage and preservation before shipment.

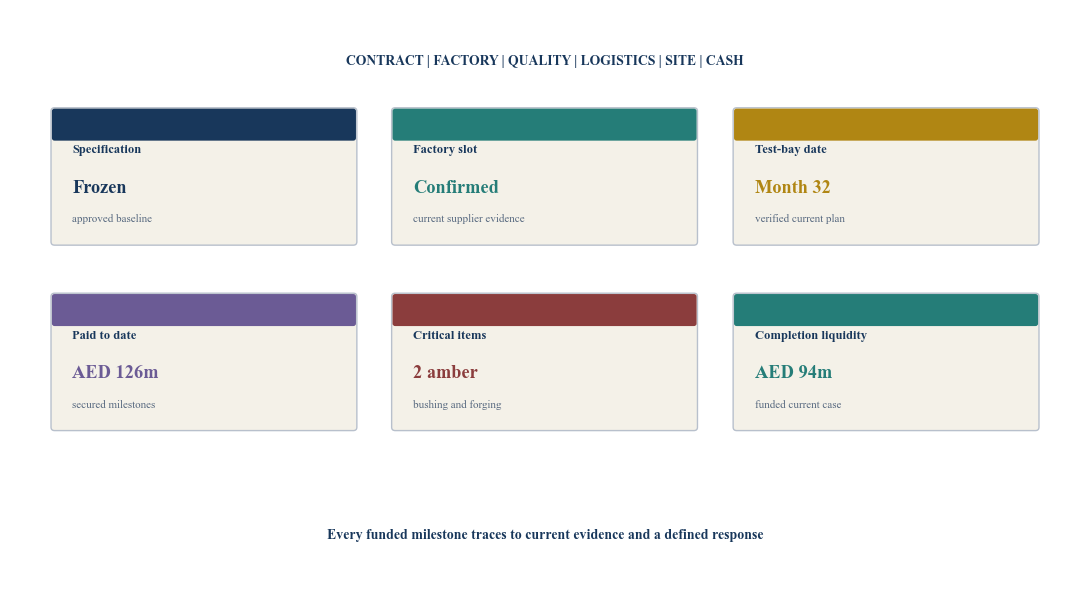

Figure 6. Hypothetical equipment-control dashboard
Figure 6. Hypothetical equipment-control dashboard Open full-size figure

Every displayed value is a hypothetical management assumption created solely to demonstrate dashboard design.

19. Implement the framework in 120 days

Days one to twenty define the power requirement, project configuration, equipment perimeter, procurement authority, geographic constraints, adviser roles and decision rights. The team preserves and indexes supplier and project records.

Days twenty-one to forty freeze the functional specification, interface register and qualified supplier list. It maps factories, critical components, test capacity, logistics, service and applicable compliance.

Days forty-one to sixty obtain and reconcile supplier proposals. The team tests production-slot evidence, price, milestones, security, title, warranty, service, cancellation and alternative routes.

Days sixty-one to eighty build the integrated schedule, equipment cash model, completion plan, recovery case and connected downside scenarios. Technical, legal, tax, insurance, export and credit advisers complete their scoped reviews.

Days eighty-one to one hundred negotiate the equipment contract, direct agreement, security, inspection, logistics, storage and early-finance documents. The operating team conducts a funds-flow and exception-response dry run.

Days one hundred and one to one hundred and twenty approve, commit or decline. The first dashboard becomes active. Every subsequent payment remains conditional on current evidence, valid security, project readiness and funded completion.

Table 6. One-hundred-and-twenty-day long-lead equipment programme

DaysWorkstreamControlled deliverableGate
1 to 10mandate and requirementpower, service and equipment perimetercommittee confirms decision scope
11 to 20authority and recordsparties, advisers, data room and approvalseach claim has accountable ownership
21 to 30specificationfunctional baseline and interfacescritical parameters are approved
31 to 40market and factoriessupplier, slot, component and service mapqualified routes remain technically feasible
41 to 50proposal reconciliationcomparable price, scope, date and obligationscommercial offers share one basis
51 to 60slot diligencefactory allocation and payment evidencereliance follows verified commitment
61 to 70schedule and logisticsmanufacture-to-commissioning critical pathsite and factory paths reconcile
71 to 80finance and stresscash, security, recovery and completion casesdownside remains funded and actionable
81 to 90contract protectionsmilestones, title, quality, delay and warrantyrisk allocation supports approved case
91 to 100execution readinessdirect rights, funds flow and dashboardoperational dry run passes
101 to 110commit or declineauthorised procurement decisionevidence and security remain current
111 to 120adoptionfirst monitored milestone and next gatecommittee accepts control reporting

Timing depends on project maturity, equipment, supplier, approvals, law and financing scope.

20. Limitations and conclusion

Equipment markets, factory capacity, component availability, prices, currencies, trade measures, export controls, regulation and project schedules can change during procurement. Project decisions require current evidence from suppliers, factories, sub-suppliers, utilities, contractors, insurers and qualified advisers.

IEA findings describe surveyed global transmission supply-chain conditions.[1] DOE, NERC and FERC materials apply within their stated United States purposes.[2][3][6] Ofgem decisions and consultations apply to Great Britain.[4][5] Singapore, Indian and UAE materials apply within their respective institutional purposes.[14][15][16][17] Manufacturer reporting presents corporate and market information under each company's definitions.[8][9][10][11][12][13]

Every capacity, cost, value, date, rate, probability, payment percentage and result in the worked example is a hypothetical management assumption. No supplier allocation, project, transaction, market price or realised outcome is claimed.

Long-lead equipment can justify early capital when the production slot is real, the design is controlled, payments follow verified value, protections are enforceable, logistics and commissioning are executable, and the project has funded completion liquidity.

The resulting discipline turns a headline shortage into a sequence of investment decisions. Capital follows evidence from requirement through factory, delivery and operating performance. Geography changes the institutional route and regulatory context. The control principles remain grounded in verified capacity, dated milestones and executable remedies.

References

  1. [1] International Energy Agency, Building the Future Transmission Grid: Executive Summary, 25 February 2025. https://www.iea.org/reports/building-the-future-transmission-grid/executive-summary
  2. [2] United States Department of Energy, Supply Chain and Market Analysis, official materials accessed 13 August 2026. https://www.energy.gov/oe/supply-chain-and-market-analysis
  3. [3] North American Electric Reliability Corporation, 2025 Summer Reliability Assessment, May 2025. https://www.nerc.com/globalassets/programs/rapa/ra/nerc_sra_2025.pdf
  4. [4] Ofgem, Electricity Transmission Advanced Procurement Mechanism, 20 March 2025. https://www.ofgem.gov.uk/decision/electricity-transmission-advanced-procurement-mechanism
  5. [5] Ofgem, Growing Great Britain's Electricity Network Supply Chains, 25 March 2026. https://www.ofgem.gov.uk/call-for-input/growing-great-britains-electricity-network-supply-chains-ofgem-position-and-call-evidence
  6. [6] United States Federal Energy Regulatory Commission, FERC Takes Action to Enhance Reliability of the U.S. Electric Grid, 18 September 2025. https://www.ferc.gov/news-events/news/ferc-takes-action-enhance-reliability-us-electric-grid
  7. [7] North American Electric Reliability Corporation, 2025 Long-Term Reliability Assessment, January 2026. https://www.nerc.com/globalassets/our-work/assessments/nerc_ltra_2025.pdf
  8. [8] Siemens Energy, Q4 FY2025 Shareholder Letter, 14 November 2025. https://assets.siemens-energy.com/dam/9478ef65-c3f9-49de-97b0-b3aa00d5712d/2025-11-14--Shareholder-Letter-Q4-FY2025-EN_final-pdf_Original%20file.pdf
  9. [9] GE Vernova, 2025 Annual Report, 2026. https://www.gevernova.com/sites/default/files/gevernova_2025_annual_report.pdf
  10. [10] GE Vernova, 2025 Annual Report CEO Letter, 2026. https://www.gevernova.com/investors/annual-report/ceo-letter
  11. [11] Siemens Energy, Siemens Energy Invests EUR 220 Million in German Transformer Factory, 5 September 2025. https://www.siemens-energy.com/global/en/home/press-releases/siemens-energy-invests--220-million.html
  12. [12] Hitachi Energy, Additional USD 250 Million Investment to Address Global Transformer Shortage, 10 March 2025. https://www.hitachienergy.com/uk-ie/en/news-and-events/press-releases/2025/03/hitachi-energy-invests-additional-250-million-usd-to-address-global-transformer-shortage
  13. [13] Hitachi Energy, Transformer Operations Expansion in Thailand, 28 August 2025. https://www.hitachienergy.com/us/en/news-and-events/press-releases/2025/08/hitachi-energy-invests-455-million-thb-14-million-usd-to-expand-transformer-operations-in-thailand-to-meet-accelerating-demand
  14. [14] Energy Market Authority of Singapore, RFP for New Electricity Generation Capacity, 29 April 2026. https://www.ema.gov.sg/content/dam/corporate/news/media-releases/2026/20260429-EMA-Media%20Release-EMA-Launches-Request-for-Proposal-for-New-Electricity-Generation-Capacity.pdf.coredownload.pdf
  15. [15] Central Electricity Authority of India, Transmission Lines and Transformation Capacity Targeted for FY 2025-26, February 2026. https://cea.nic.in/wp-content/uploads/transmission/2026/02/RFD_Report_Feb_2026.pdf
  16. [16] UAE Ministry of Energy and Infrastructure, Minister Highlights UAE Approach to Diversify Energy Mix at ADIPEC, 4 November 2025. https://www.moei.gov.ae/en/media-center/news/4/11/2025/minister-of-energy-and-infrastructure-highlights-uaes-approach-to-diversify-energy-mix-at-adipec
  17. [17] UAE Ministry of Energy and Infrastructure, Emirates Monitoring Center Inaugurated to Strengthen National Power Grid Resilience, 9 July 2026. https://www.moei.gov.ae/en/media-center/news/9/7/2026/ministry-of-energy-and-infrastructure-inaugurates-emirates-monitoring-center-to-strengthen-national

About the Author

Chennakeshav Adya is an independent researcher and Managing Partner of Matchpoint Partners. His research focuses on investment strategy, capital formation, transaction execution, governance and operating-model design across the Gulf and international markets.

Questions, answered

The Transformer and Turbine Bottleneck: frequently asked questions

The evidence should identify the buyer, factory, product, current specification, capacity window, accepted order, required deposit, engineering release, critical components, test window and delivery obligations. The complete evidence should be reconciled to payment and supplier confirmation.

An early commitment can preserve a scarce delivery position and protect the operating date. The decision requires a credible route to full project funding, suitable security, controlled milestones, enforceable rights and funded downside liquidity.

Recovery depends on title, identification, location, specification, completion, warranty, transfer consent, transport, buyer demand and law. Custom equipment can have limited standalone recovery, so completion support and project viability remain important.

Each payment should follow independently verified value creation, valid security, current schedule evidence and continuing project readiness. The financier should have clear stop conditions, inspection rights and a funded cure or exit route.

Published backlog supports market and corporate context under the manufacturer's definition. It does not prove a buyer-specific slot, delivery date, price, cancellation right or factory allocation.

Selected North American materials emphasise lead times, standardisation and factory capacity; Great Britain uses regulated advanced procurement; Singapore coordinates future generation procurement; India publishes physical delivery progress; Gulf materials emphasise system investment and coordination. Each project still requires its own evidence.

This research connects to Matchpoint Partners' data-centre and digital-infrastructure advisory work, including equipment and power diagnostics, capital planning, project finance, procurement strategy, investor materials, transaction diligence, funding processes and execution support.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
