1. Frame the valuation decision

The decision question is whether the asset earns durable cash from present service, contracted conversion and financeable expansion. The analysis should begin with audited cash, executed contracts, customer acceptance, metered power, engineering records and approved capital plans. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that a market narrative can capitalise uncommitted demand and unavailable power as current value. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to separate operating value, conversion value, expansion value and strategic option value. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

2. Separate facility economics from compute economics

The decision question is which party buys processors and software, bears technology risk and pays the data-centre owner. The analysis should begin with service descriptions, customer contracts, equipment ownership, metering, cloud architecture and responsibility matrices. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that a decline in compute cost can be mistaken for an equal decline in rent even when the facility sells committed power or space. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to trace the economic unit from customer workload to contracted facility charge. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

3. Adopt a capacity dictionary

The decision question is how stated megawatts convert into usable, contracted, installed, billable and collected service. The analysis should begin with utility agreements, substations, commissioning, redundancy design, cooling limits, contracts, invoices and receipts. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that reported capacity can mix land-bank potential, utility allocation, construction and operating load. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to reconcile each capacity layer with one definition, owner, source and date. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

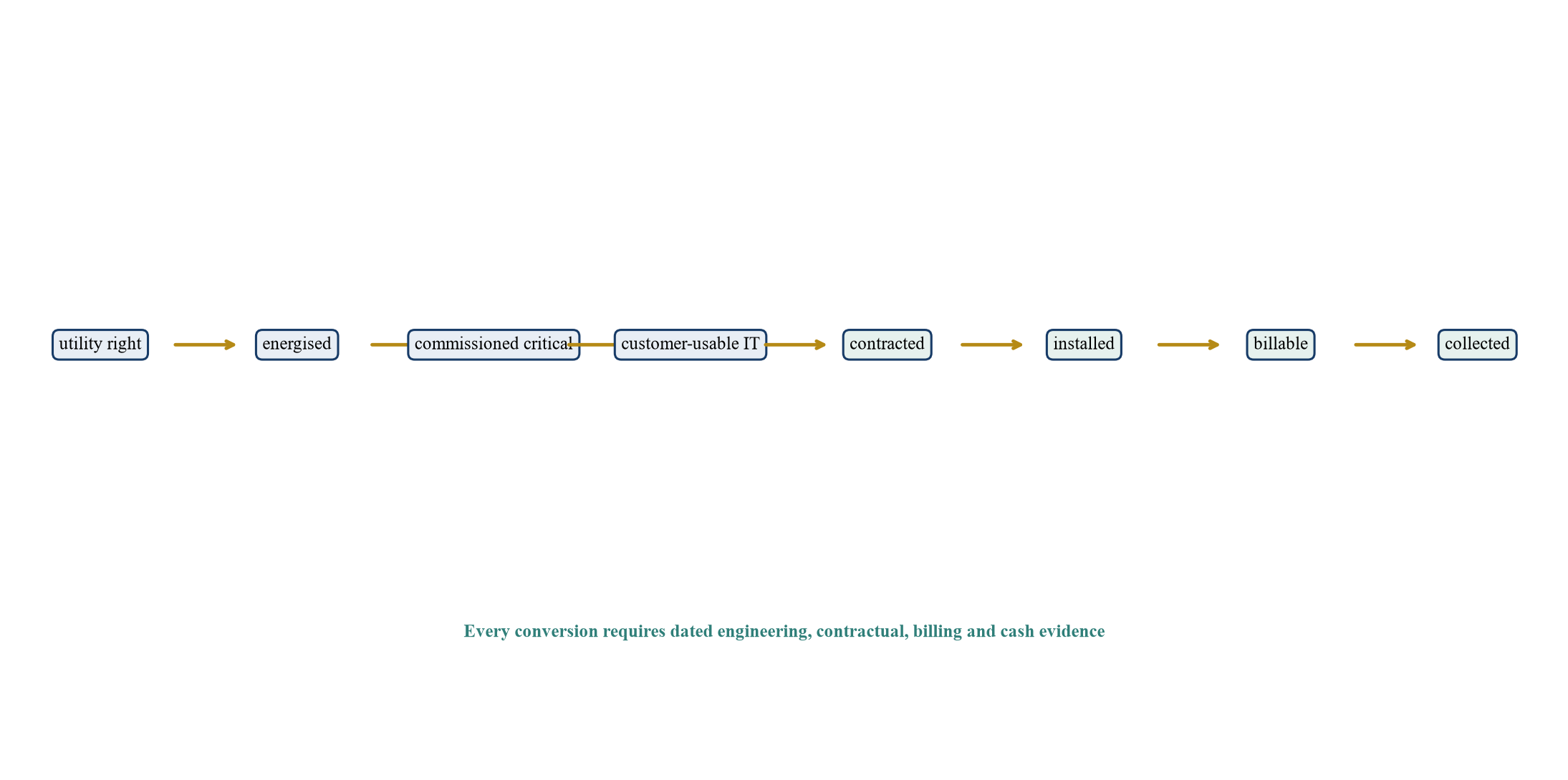

Figure 1. Proposed data-centre capacity-to-cash ladder
Figure 1. Proposed data-centre capacity-to-cash ladder
Analytical framework; transaction-specific engineering and contracts determine conversion.
Table 1. Capacity definitions for valuation
LayerEvidenceValuation use
utility rightexecuted service and delivery termsdependency and option
commissioned criticalcompleted and tested systemsoperating capacity
customer-usable ITdensity, redundancy and cooling-adjustedsaleable denominator
contractedexecuted customer commitmentconversion value
installedaccepted customer equipment and serviceramp evidence
billableinvoice supported by accepted serviceoperating revenue
collectedreconciled cash receiptcash-quality test

Proposed definitions; engineering and contracts determine actual treatment.

4. Map the customer-contract transmission channels

The decision question is which price, volume, minimum, escalation, renewal and pass-through clauses transmit a compute-cost change. The analysis should begin with executed agreements, amendments, order forms, service schedules, invoices, credits and renewal notices. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that average revenue per kilowatt can conceal different contract exposure and customer options. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to model every material contract according to its enforceable cash mechanism. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

5. Classify customer and service archetypes

The decision question is how hyperscale, wholesale, retail colocation, managed hosting, interconnection and powered-shell services respond differently. The analysis should begin with customer master data, product catalogue, contracts, rack and power records, sales pipeline and collections. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that one demand elasticity can be applied to customers with incompatible economics and switching costs. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to build archetype-specific revenue, churn, density and capital assumptions. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

Table 2. Customer-contract archetypes
ArchetypeTypical charging unitCompute-cost channelPrincipal valuation test
hyperscale build-to-suitcommitted MWrenewal and expansioncredit, term and residual use
wholesale colocationkW or MW commitmentutilisation and priceramp, minimum and renewal
retail colocationrack, cabinet and powerdensity and churncustomer cohort economics
interconnectioncross-connect or portnetwork demandecosystem and migration cost
managed hostingservice bundledirect efficiency and competitionhardware and service margin
powered shelllease and power rightstenant capital and take-upfit-out, credit and reletting

Illustrative classification; executed terms govern each exposure.

6. Measure utilisation quality

The decision question is whether occupied capacity produces durable margin and collected cash at an appropriate capital burden. The analysis should begin with commissioned capacity, installed equipment, meters, billing, collections, support tickets and service credits. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that headline utilisation can count reservations, testing load or low-margin legacy contracts. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to publish physical, contractual, billing and cash utilisation as separate measures. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

7. Construct alternative compute-cost paths

The decision question is how a lower cost per unit of useful computation could develop without treating one path as a forecast. The analysis should begin with processor performance, software efficiency, cloud prices, workload mix and customer disclosures. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that precision in a technology forecast can create false confidence in long-dated cash flows. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to use transparent indices, ranges, trigger points and regular re-estimation. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

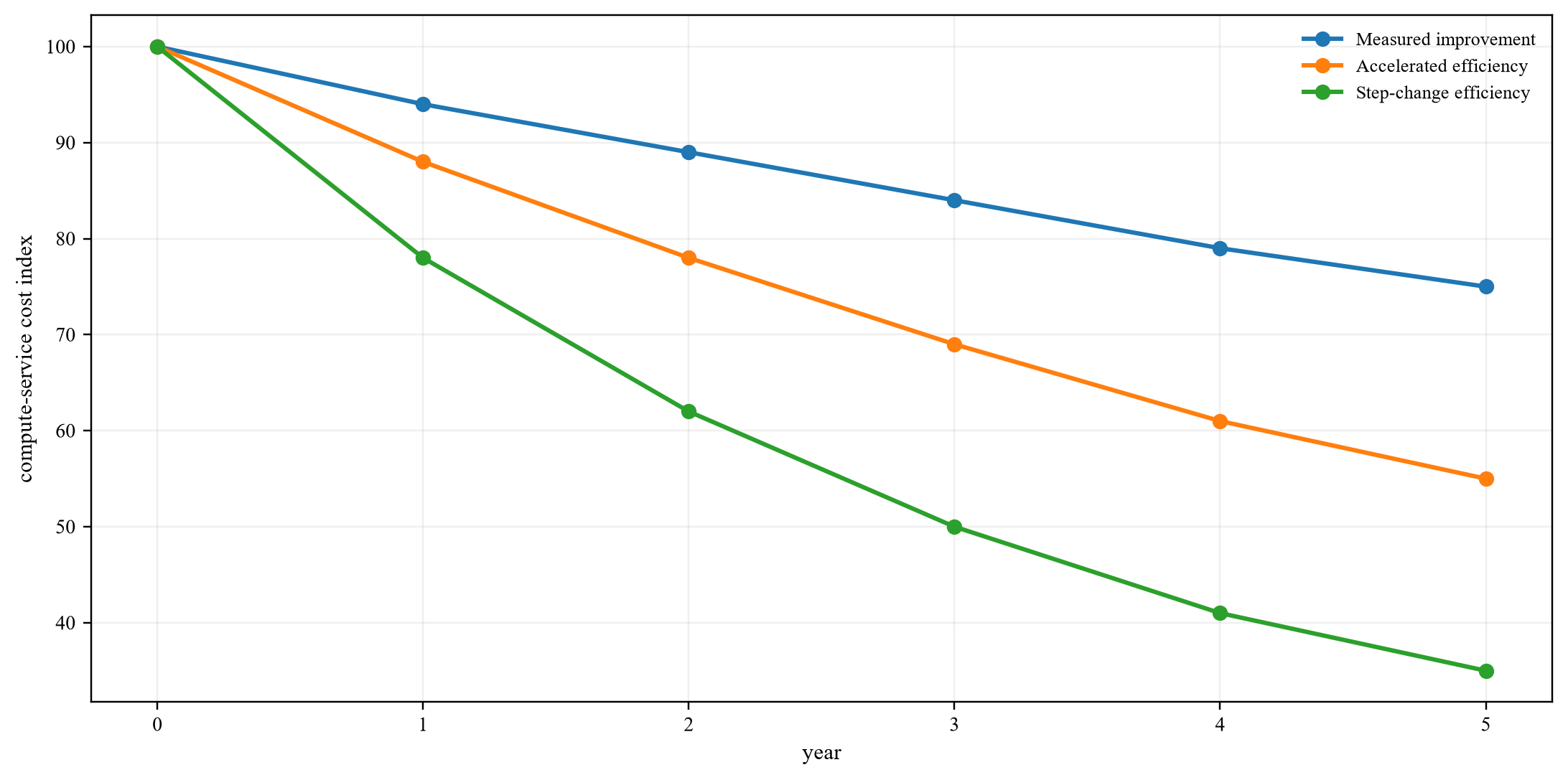

Figure 2. Illustrative compute-service cost paths
Figure 2. Illustrative compute-service cost paths
Wholly hypothetical indices; these are scenario assumptions rather than forecasts.
Table 3. Compute-cost scenario design
PathYear-five indexPossible demand responsePossible facility effect
measured improvement75broader but gradual adoptionstable ramp; selective density capex
accelerated efficiency55strong workload expansionhigher density; mixed MW demand
step-change efficiency35rapid new use with consolidation riskwinners by power, network and design

Hypothetical indices; no path is a forecast.

8. Estimate demand elasticity by workload

The decision question is whether lower unit cost expands inference, training, storage, networking or enterprise workloads enough to offset efficiency. The analysis should begin with customer cohort history, workload telemetry where contractually permitted, bookings, cancellations and industry evidence. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that aggregate demand growth can hide falling demand from a particular customer or facility generation. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to estimate response by workload, customer, location and contract. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

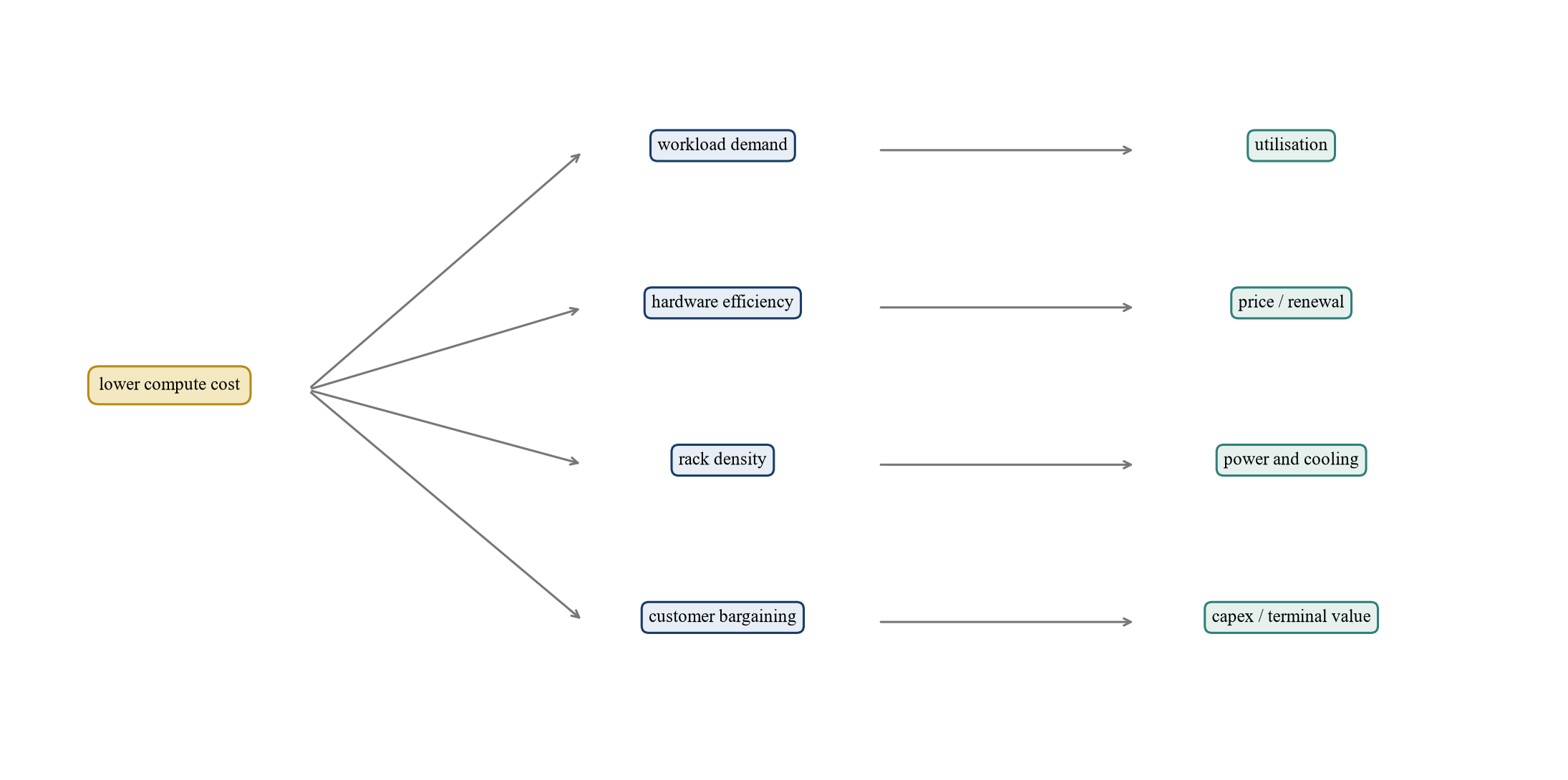

Figure 3. Compute-cost transmission into data-centre cash
Figure 3. Compute-cost transmission into data-centre cash
Proposed causal map; each arrow requires transaction-specific evidence.

9. Model density and facility compatibility

The decision question is whether rising kilowatts per rack can be served by electrical, cooling, floor, fire and operational systems. The analysis should begin with design drawings, nameplates, commissioning, thermal studies, rack inventories and customer specifications. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that portfolio megawatts can remain available while commercially relevant high-density capacity is scarce. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to value density-compatible service separately and cost retrofit constraints. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

10. Underwrite power availability and price

The decision question is whether utility rights, delivery dates, tariffs, generation mix and network constraints support each cash scenario. The analysis should begin with utility contracts, interconnection studies, tariffs, FERC and regional operator records, metering and bills. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that an executed customer contract can precede deliverable utility capacity or expose the owner to volatile power cost. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to model physical availability, timing, basis, pass-through and curtailment separately. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

11. Test interconnection and network value

The decision question is how carrier density, cloud on-ramps, latency and cross-connect economics affect retention and pricing. The analysis should begin with network maps, cross-connect inventory, traffic, customer dependencies, prices and service records. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that power-only valuation can miss durable network effects or duplicate connectivity capital. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to measure network revenue, customer dependence and replacement difficulty. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

12. Model renewal, churn and migration

The decision question is when customers can renegotiate, consolidate, relocate or change architecture under each scenario. The analysis should begin with contract expiry, renewal notice, installation history, migration cost, service quality and customer strategy. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that long average tenure can mask a concentrated renewal wall. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to forecast contract-level renewal with explicit timing and probability. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

13. Assess customer concentration and credit

The decision question is how a small number of customers influence price, capital, utilisation and financing. The analysis should begin with customer revenue, margin, receivables, parent support, ratings, security and contract remedies. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that investment-grade customer names can obscure entity, termination and concentration risk. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to link credit and bargaining power to revenue and covenant cases. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

14. Reconcile expansion and reliability capital

The decision question is which expenditure sustains service, converts contracts and creates new saleable capacity. The analysis should begin with condition assessments, capex ledgers, construction contracts, schedules, permits, commissioning and customer milestones. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that growth capex can include deferred maintenance or infrastructure unavailable to the target workload. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to classify sustaining, compliance, conversion, density, resilience and expansion capital. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

Table 4. Capital-expenditure classification
ClassPurposeValue treatmentRelease evidence
sustainingpreserve serviceoperating cash requirementcondition and maintenance plan
compliancemeet law and codeunavoidable requirementpermit and remediation scope
reliabilityprotect uptimerisk-adjusted cashfailure and resilience evidence
conversiondeliver contracted loadcontracted growthcustomer and commissioning milestones
density retrofitserve higher-density workloadsscenario valuedesign, customer and return
expansioncreate new saleable capacitycontingent growthland, power, permit, demand and funding

Proposed classification; transaction-specific engineering controls amounts.

15. Model technological and economic obsolescence

The decision question is when an operating hall loses competitiveness despite remaining physically functional. The analysis should begin with density, cooling, efficiency, reliability, network, certifications, customer pipeline and retrofit economics. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that straight-line depreciation can understate commercial obsolescence or overstate required replacement. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to use facility-generation cohorts and cash-based impairment indicators. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

16. Build the discounted-cash-flow model

The decision question is how contract cash, utilisation, price, power, operating cost, capex, tax and working capital create value. The analysis should begin with monthly customer cash, operating records, tax basis, capital schedules and financing assumptions. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that a top-down revenue growth rate can disconnect value from capacity and contracts. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to build from customer and capacity cohorts with auditable scenario drivers. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

17. Use megawatt multiples with discipline

The decision question is which capacity definition, cash maturity, geography and capital obligation make a comparable transaction relevant. The analysis should begin with public filings, transaction disclosures, operating metrics, capacity definitions and remaining capex. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that enterprise value per stated megawatt can reward undeveloped power and ignore liabilities. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to normalise multiples to commissioned, usable and billable capacity and reconcile to DCF. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

Table 5. Valuation-method reconciliation
MethodStrengthPrincipal limitationRequired reconciliation
DCFlinks contracts and capital to cashsensitive to long-term assumptionsscenario and terminal-value bridge
EV per MWrapid market comparisoncapacity definitions differcommissioned, usable and billable MW
EBITDA multiplecash-oriented comparisonmaturity and capex differleases, power, capex and growth
replacement costtests scarcity and recreationcost can exceed economic valuetime, utility feasibility and demand
transaction evidenceobserves control valuedisclosure and cycle varydate, perimeter, synergies and liabilities

Each method requires consistent perimeter and capacity definitions.

18. Apply replacement cost and land-power evidence

The decision question is what it would cost and how long it would take to recreate land, power, buildings, systems and network position. The analysis should begin with land evidence, utility works, engineering quantities, procurement, labour, permits and commissioning. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that replacement cost can exceed economic value where customer demand or returns are insufficient. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to use depreciated replacement cost as a cross-check with time and feasibility adjustments. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

19. Govern AI-assisted valuation

The decision question is how models extract contracts, reconcile capacity, detect anomalies and simulate scenarios under accountable review. The analysis should begin with data lineage, model cards, validation, access controls, exception logs and reviewer approvals. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that automated summaries can propagate source errors or conceal model uncertainty. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to assign human owners, preserve citations and validate consequential outputs. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

20. Define the hypothetical portfolio

The decision question is how the worked case converts 360 stated megawatts into billable capacity and cash. The analysis should begin with the illustrative capacity ladder, contract mix, capital plan, operating costs and debt. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that a single 360 MW denominator would overstate current operating scale. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to value only the capacity layer supported by the relevant evidence. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

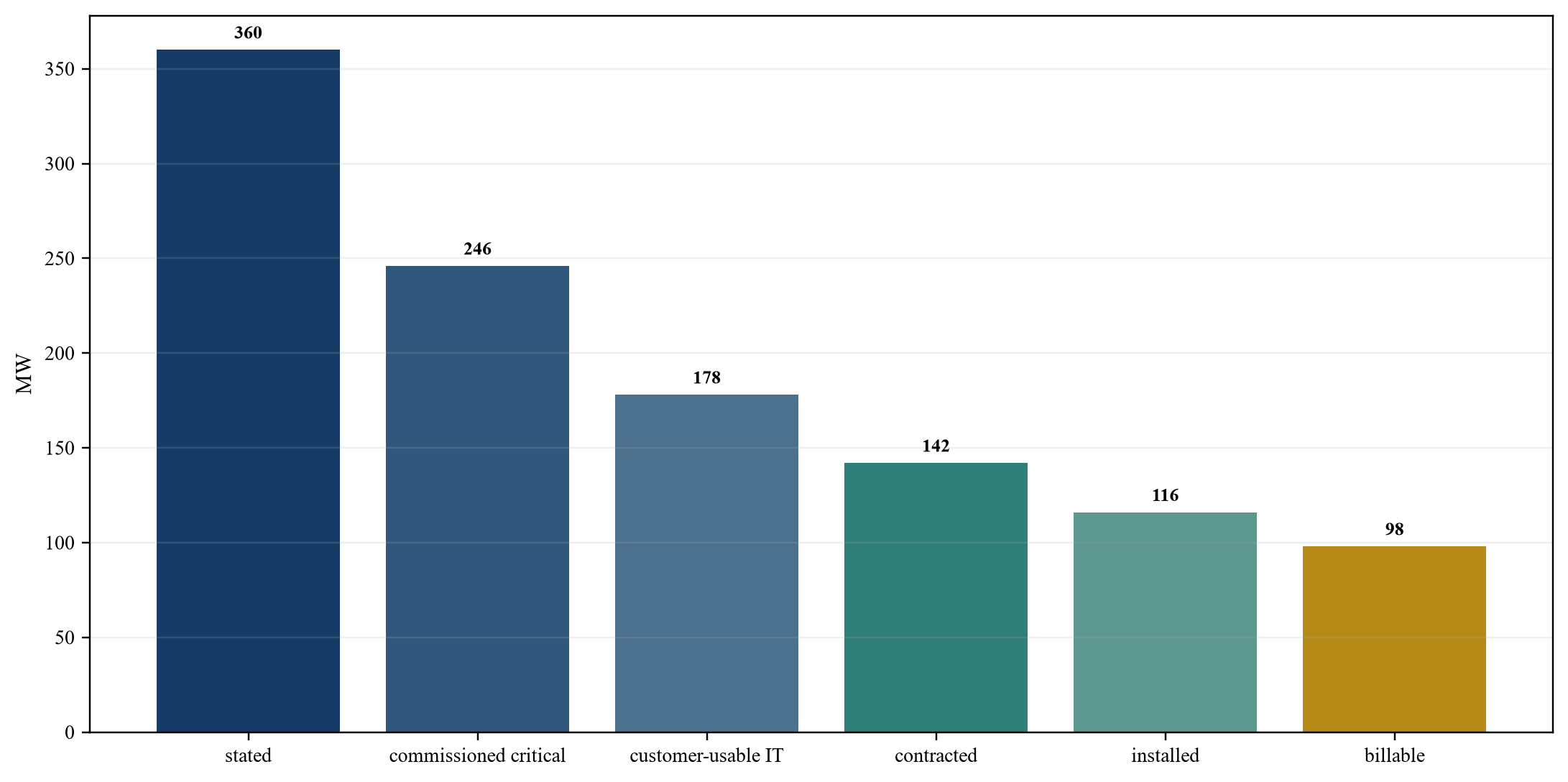

Figure 4. Hypothetical conversion of stated capacity to billable load
Figure 4. Hypothetical conversion of stated capacity to billable load
Wholly hypothetical megawatts; figures do not describe an identified portfolio.

21. Translate scenarios into cash

The decision question is how compute-cost indices change demand, renewal price, density, power, capex and margin. The analysis should begin with central, demand-led and efficiency-led assumptions with explicit elasticities and contract lags. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that a lower cost index can be applied directly to data-centre revenue without an economic channel. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to calculate each channel independently and show interactions. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

Table 6. Hypothetical cash-flow scenario assumptions
DriverCentralDemand-led upsideEfficiency-led downside
billable load in year five142 MW165 MW118 MW
renewal price change0%+4%-9%
average power density+28%+45%+20%
five-year capitalUSD 2.1bnUSD 2.5bnUSD 1.7bn
expansion delay9 months3 months24 months
terminal utilisation86%92%74%

Wholly hypothetical; values do not describe an identified company.

22. Bridge enterprise value to equity value

The decision question is how operating assets, contracted conversion, expansion, debt, leases, tax and contingencies reach equity value. The analysis should begin with DCF outputs, debt, cash, lease obligations, committed capex and transaction adjustments. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that headline enterprise value can conceal funding obligations and debt-like items. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to show a transparent bridge with downside liquidity. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

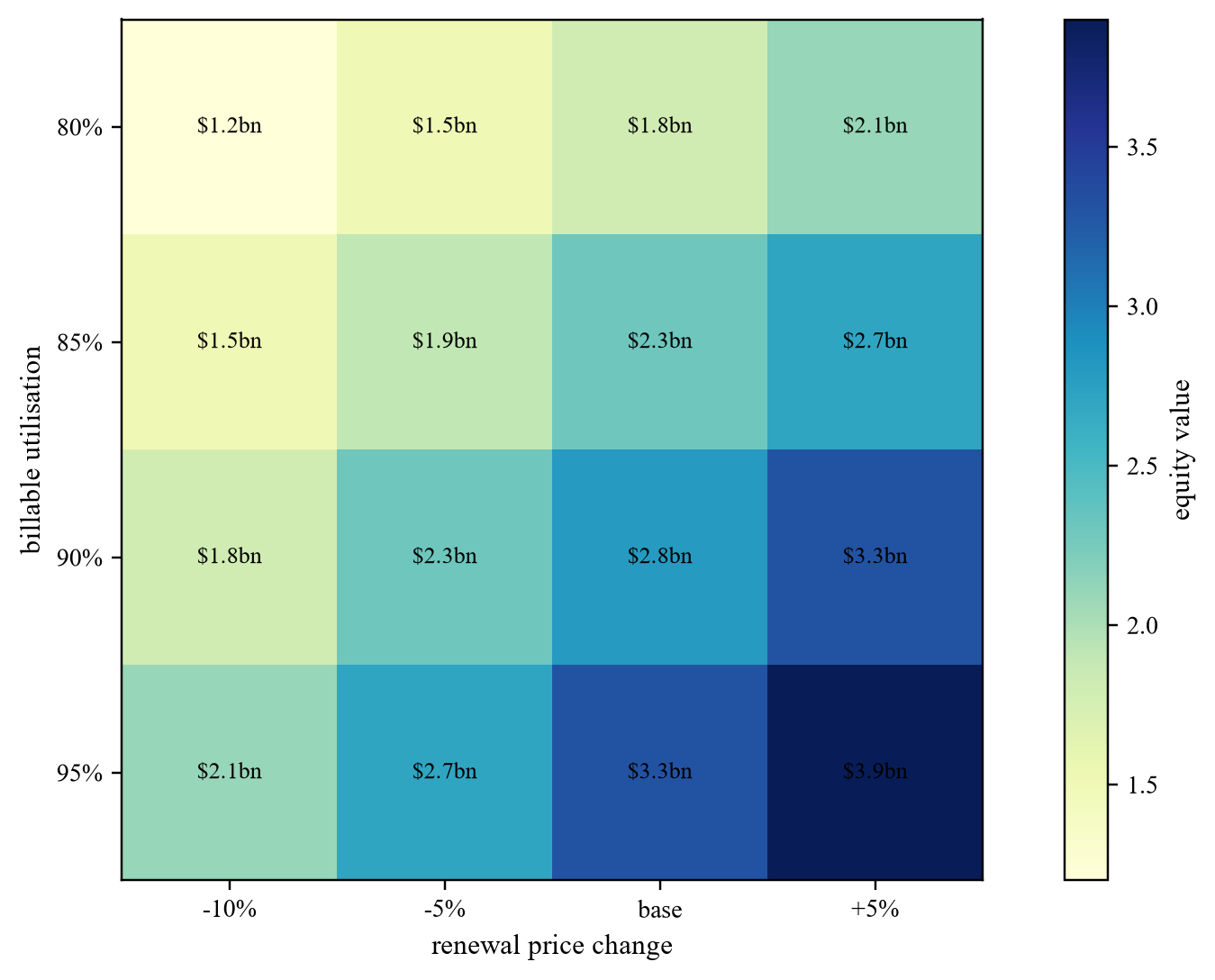

Figure 5. Hypothetical equity-value sensitivity to billable utilisation and renewal price
Figure 5. Hypothetical equity-value sensitivity to billable utilisation and renewal price
Wholly hypothetical USD billions; this is not a valuation opinion.

23. Run sensitivity and tornado analysis

The decision question is which assumptions explain the greatest change in value and covenant resilience. The analysis should begin with contract renewal, billable capacity, price, power cost, capex, delay, exit yield and terminal growth. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that many small sensitivities can distract from a few decisive exposures. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to rank variables by equity and debt-service impact and assign evidence priorities. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

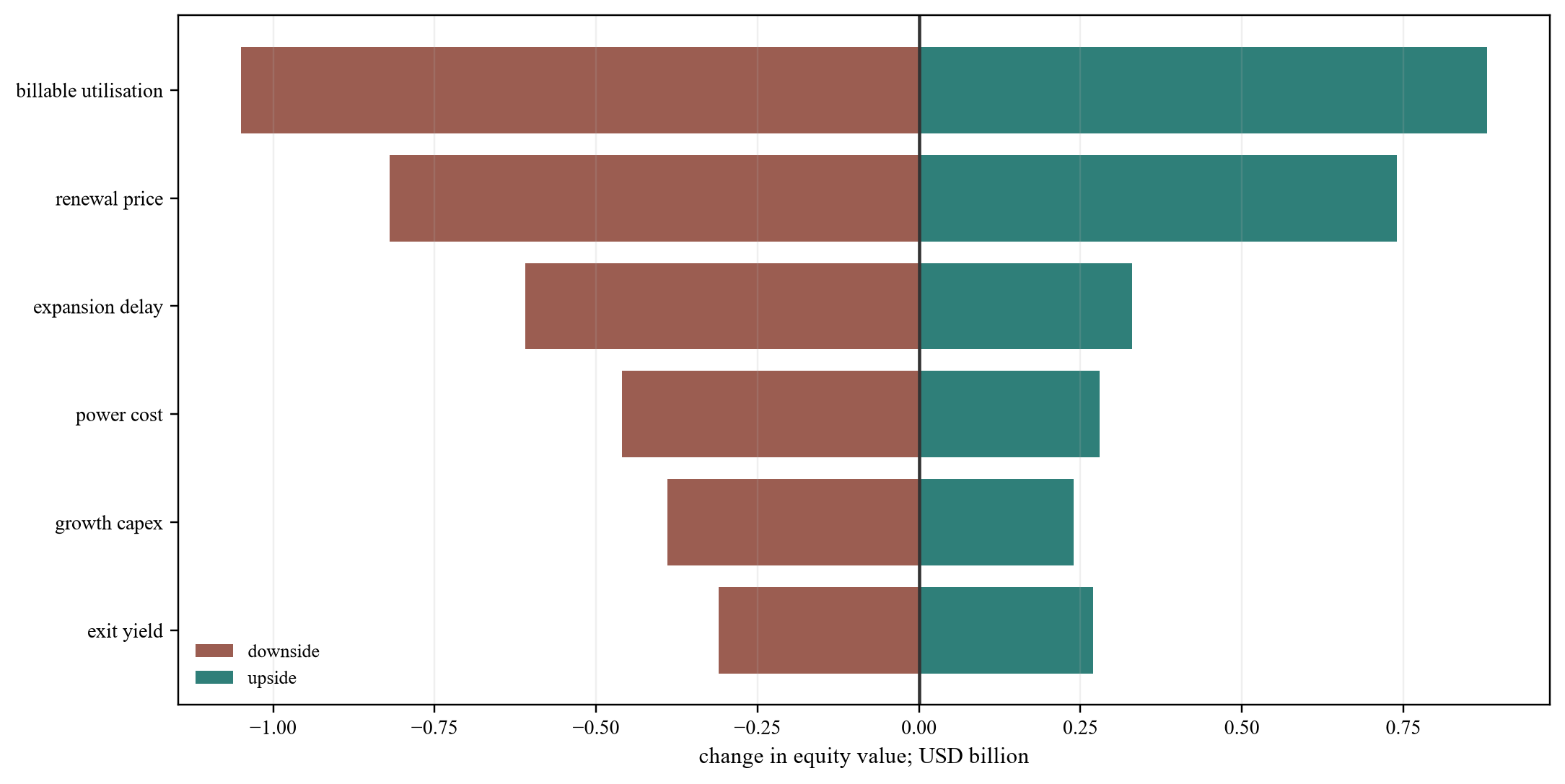

Figure 6. Hypothetical equity-value tornado
Figure 6. Hypothetical equity-value tornado
Wholly hypothetical sensitivities around the central case.

24. Size debt to resilient cash

The decision question is what leverage, amortisation, reserve and covenant structure survives realistic downside. The analysis should begin with contracted EBITDA, maintenance capital, taxes, working capital, interest, maturity and liquidity. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that debt can be sized to projected expansion that lacks power, customer acceptance or funding. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to base leverage on resilient cash and stage growth debt against milestones. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

25. Translate findings into transaction terms

The decision question is which price adjustments, escrows, earn-outs, indemnities, conditions and covenants allocate uncertainty. The analysis should begin with diligence findings, legal rights, financing requirements and integration plan. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that valuation caveats can disappear from definitive agreements. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to attach each material uncertainty to a quantified protection and owner. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

26. Set board gates for expansion

The decision question is when land, power, permitting, customer demand, design, funding and returns permit capital release. The analysis should begin with approved business cases, utility evidence, customer commitments, engineering and financing. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that strategic urgency can accelerate spending before dependencies are secured. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to use sequential gates with stop, redesign and repricing decisions. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

Table 7. Board capital-release gates
GateMinimum evidenceStop or redesign trigger
land and controltitle, lease, access and environmental baselineunresolved control or remediation
powerexecuted rights, delivery path and pricespeculative timing or unaffordable upgrade
customerenforceable commitment and creditnon-binding pipeline or concentrated option
designdensity, cooling, resilience and costincompatible target workload
fundingcommitted sources, liquidity and covenant headroomreliance on unfinanced growth
constructionfixed scope, schedule, interfaces and contingencycritical-path dependency unresolved
commissioningtested systems and customer acceptancefailed performance or acceptance

Proposed governance; each investment requires project-specific approval.

27. Monitor post-close value and refinancing

The decision question is which leading indicators identify variance before cash and covenant failure. The analysis should begin with capacity conversion, bookings, renewals, metering, incidents, capex, collections and liquidity. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that quarterly financial reporting can reveal problems after intervention options narrow. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to operate a monthly evidence dashboard tied to board actions. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

28. Reach a defensible conclusion

The decision question is whether the asset remains valuable across transparent compute-cost and operating scenarios. The analysis should begin with reconciled evidence, scenario results, protections, financing and accountable approvals. Each item needs a source, period, owner and reconciliation to the financial model. External market growth provides context; it does not establish the cash earned by a particular facility, contract or customer.

The principal valuation failure is that one point estimate can hide incompatible paths and concentrated risk. This can move value through revenue, operating cost, capital expenditure, timing, tax, liquidity and the cost of capital. The model should expose those paths instead of embedding them in one growth rate or terminal multiple. Management estimates can be used for planning when they are clearly identified as assumptions and remain separate from observed evidence.

The recommended response is to approve a value range, protection package and trigger-based operating plan. Central, upside and downside cases should state the contract mechanism, capacity consequence, required capital, timing and responsible decision owner. The board should see the earliest observable indicator, the value at risk and the action available before it releases capital or accepts leverage.

Sources

  1. U.S. Department of Energy, *DOE Releases New Report Evaluating Increase in Electricity Demand from Data Centers*, 2024. Read the primary source
  2. Lawrence Berkeley National Laboratory, *2024 United States Data Center Energy Usage Report*, 2024. Read the primary source
  3. International Energy Agency, *Energy and AI*, 2025. Read the primary source
  4. U.S. Energy Information Administration, *Electric Power Monthly*. Read the primary source
  5. Federal Energy Regulatory Commission, *Electric Power Markets*. Read the primary source
  6. Federal Energy Regulatory Commission, *Reliability Primer*. Read the primary source
  7. PJM Interconnection, *Load Forecast Report*. Read the primary source
  8. North American Electric Reliability Corporation, *Long-Term Reliability Assessment*. Read the primary source
  9. U.S. Environmental Protection Agency, *ENERGY STAR for Data Centers*. Read the primary source
  10. National Institute of Standards and Technology, *AI Risk Management Framework*. Read the primary source
  11. National Institute of Standards and Technology, *Cybersecurity Framework 2.0*. Read the primary source
  12. Cybersecurity and Infrastructure Security Agency, *Cross-Sector Cybersecurity Performance Goals*. Read the primary source
  13. U.S. Securities and Exchange Commission, *Equinix, Inc. filings*. Read the primary source
  14. U.S. Securities and Exchange Commission, *Digital Realty Trust, Inc. filings*. Read the primary source
  15. U.S. Securities and Exchange Commission, *American Tower Corporation filings*. Read the primary source
  16. U.S. Securities and Exchange Commission, *NVIDIA Corporation filings*. Read the primary source
  17. U.S. Securities and Exchange Commission, *Microsoft Corporation filings*. Read the primary source
  18. U.S. Securities and Exchange Commission, *Amazon.com, Inc. filings*. Read the primary source
  19. U.S. Securities and Exchange Commission, *Alphabet Inc. filings*. Read the primary source
  20. Federal Accounting Standards Advisory Board, *Accounting Standards and Other Pronouncements*. Read the primary source
  21. Financial Accounting Standards Board, *Accounting Standards Codification*. Read the primary source
  22. Internal Revenue Service, *Publication 946, How To Depreciate Property*. Read the primary source
  23. U.S. Census Bureau, *Quarterly Construction Spending*. Read the primary source
  24. Bureau of Labor Statistics, *Producer Price Indexes*. Read the primary source
  25. Federal Reserve Board, *Financial Accounts of the United States*. Read the primary source
  26. U.S. Department of Justice and Federal Trade Commission, *Merger Guidelines*, 2023. Read the primary source
Questions, answered

US Data-Centre Valuation under Lower Compute-Cost Scenarios: frequently asked questions

No. The result depends on demand elasticity, customer contracts, workload architecture, density, power availability, competitive supply and capital requirements. A lower compute cost can expand workloads, reduce required infrastructure per task or do both.

Megawatts can describe utility rights, construction, commissioned systems, usable IT load, contracted load or billable service. These layers have different remaining capital, timing and cash. A multiple requires a consistent capacity definition and a DCF reconciliation.

The model should use enforceable minimums, ramp dates, escalation, power pass-through, service levels, renewal options, termination rights, customer credit and remaining owner capital. Portfolio averages can conceal renewal and concentration risk.

AI can extract terms, reconcile identifiers, detect anomalies and run scenarios. Accountable specialists remain responsible for source validation, engineering conclusions, legal interpretation, assumptions and investment decisions.

Planned capacity should receive contingent or option value after evidence of land control, deliverable power, permits, compatible design, customer demand, funding and return. It should not be treated as current billable capacity.

The most important test varies by asset. Common decisive exposures are concentrated renewals, delayed power, lower billable utilisation, retrofit capital, power-cost mismatch, expansion delay and refinancing pressure. A tornado analysis identifies the dominant variables.

Higher density can increase revenue per square foot and make constrained power more valuable. It can also require new cooling, electrical distribution, controls and maintenance practices. Value depends on price, capital, downtime and customer acceptance.

Debt should be sized to resilient contracted cash after power, maintenance capital, tax and working-capital requirements. Growth debt can be staged against utility, construction and customer-acceptance milestones.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
