1. Define the investment decision

Decide whether a staged portfolio of satellite-backed edge nodes can earn an acceptable return after network, power, equipment, operating, refresh and financing costs. [1][2][3][6] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with asset perimeter, country and catchment rationale, workload, customer, payer, technical architecture, licence path, service contract, capital plan and downside liquidity. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that continental connectivity growth or satellite coverage is treated as node-level demand. The practical response is to approve only nodes supported by customer, service, regulatory, infrastructure and cash evidence. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

2. Define the portfolio perimeter

The portfolio must identify the countries, legal entities, assets, contracts, currencies, cash accounts and shared services included in the financing. [6][7][27][29] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with country scope, ownership, permits, asset register, contracts, currencies, tax, cash waterfall, security, shared dependencies and excluded activities. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that a regional brand or holding company is assumed to create a single financeable asset pool. The practical response is to define each borrowing entity and the enforceable route from customer payment to debt service. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

3. Screen markets with comparable evidence

National and regional indicators can identify candidate markets, but each node needs evidence for its actual service catchment. [1][2][3][4] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with coverage and usage gaps, affordability, enterprise and public-service activity, fibre availability, power, satellite licensing, security and competition. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that population or an offline-user count is multiplied by a tariff to create revenue. The practical response is to use indicators to rank diligence and require named workloads and payers before forecasting cash. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

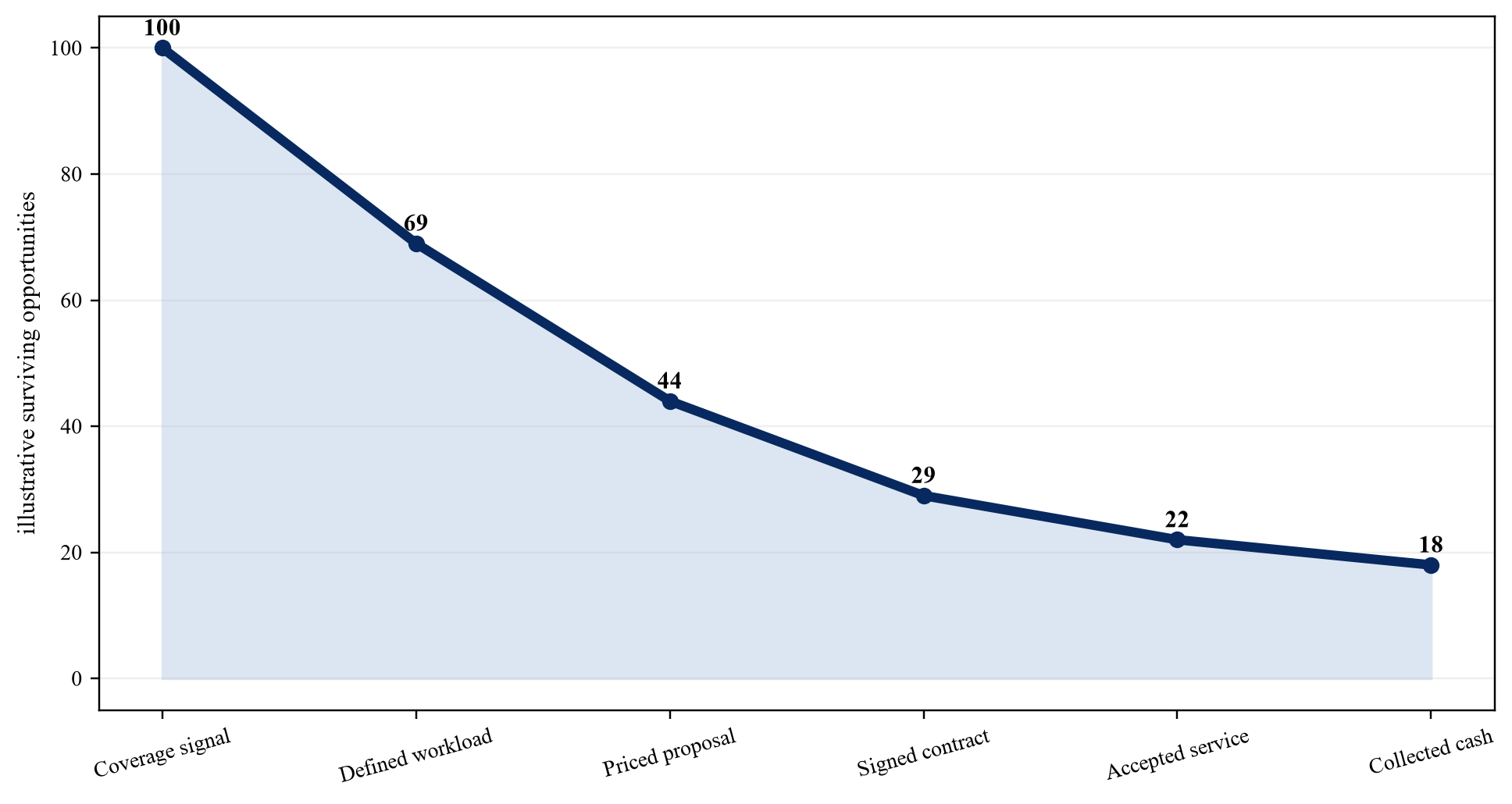

Figure 1. Market signal to collected cash
Figure 1. Market signal to collected cash
Proposed evidence funnel; activity indicators do not establish financeable revenue.
Table 1. Market-screen evidence matrix
SignalUseful questionRequired conversion evidence
coverage and usage gapwhere may unmet connectivity remaindefined service and payer
enterprise and public activitywhich workloads may need local processingapplication path and budget
fibre and satellite availabilitywhich network options are feasiblecontracted capacity and SLA
power and site readinesswhere can a node operate reliablycommissioned infrastructure
affordability and collectionswho can sustain paymenttariff, support and receipts

Proposed framework; screening evidence prioritises diligence and does not prove revenue.

4. Separate workload classes

Content delivery, telecom backhaul, enterprise continuity, public services, industrial applications and AI inference have different performance and payment characteristics. [3][4][12][13] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with application path, data volume, latency tolerance, throughput, continuity, data control, customer, payer, service window and price. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that all traffic is converted into one undifferentiated edge-compute forecast. The practical response is to forecast, contract and finance each workload class separately. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

5. Choose the network architecture

Low Earth orbit, geostationary satellite, microwave, fibre and mobile networks offer different coverage, latency, capacity, cost and regulatory profiles. [1][9][10][11] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with route design, orbit and provider, gateway, spectrum, capacity, contention, redundancy, terrestrial alternatives, service level and migration path. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that a satellite footprint is treated as committed capacity and an end-to-end service. The practical response is to select an architecture through measured service requirements, contracted capacity and tested alternatives. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

6. Build the end-to-end service path

The financed service includes user access, local network, edge node, satellite terminal, space segment, gateway, terrestrial transit, application and response. [12][13][14][32] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with logical and physical topology, ownership, hand-offs, latency, loss, jitter, capacity, encryption, monitoring, maintenance and remedies. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that the satellite hop or server benchmark substitutes for end-to-end performance. The practical response is to measure the complete path under normal, peak, degraded and failover conditions. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

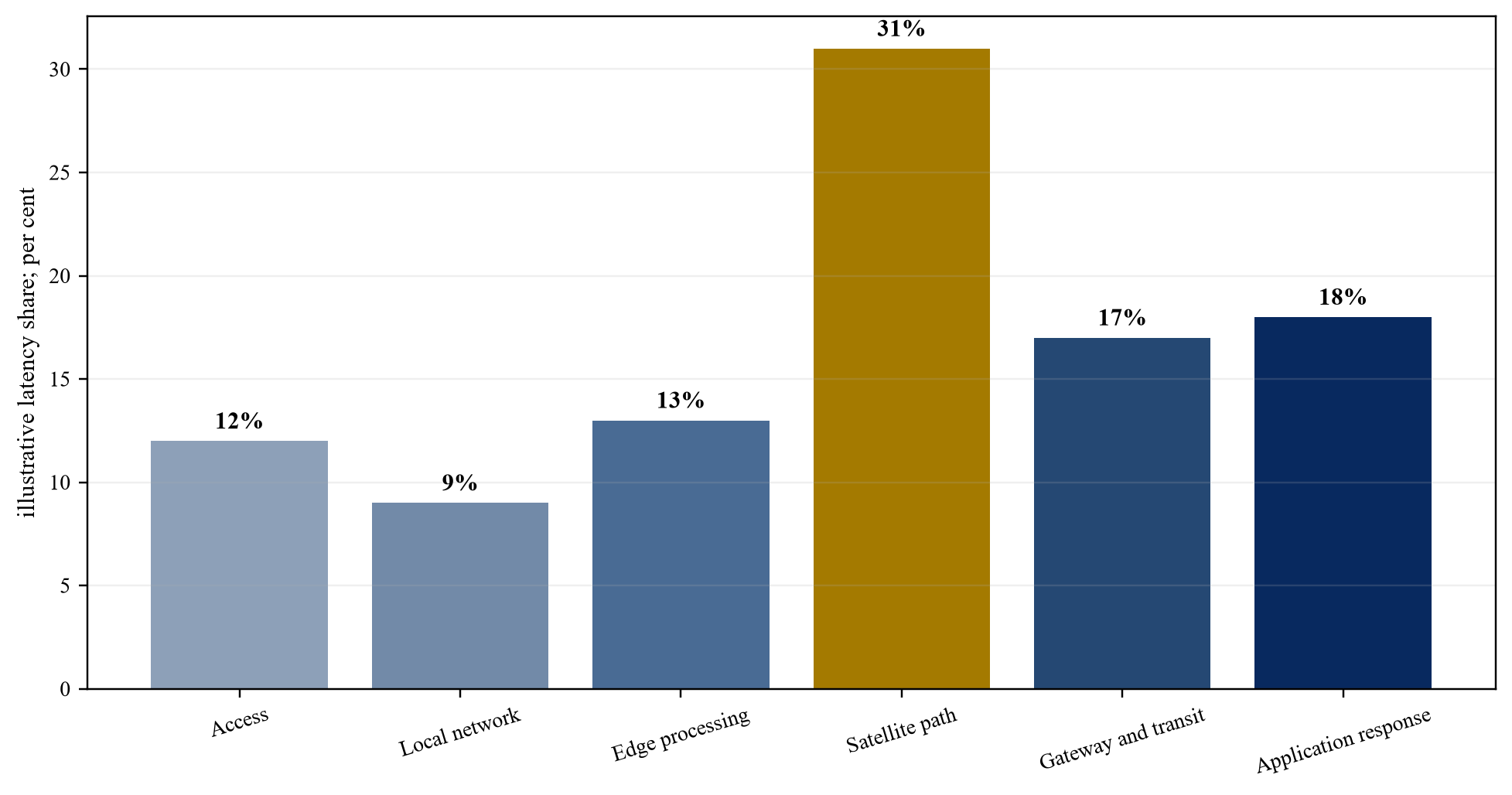

Figure 2. Hypothetical end-to-end latency budget
Figure 2. Hypothetical end-to-end latency budget
Wholly hypothetical allocation; replace with measured application traces.
Table 2. Architecture selection test
ArchitecturePotential roleRequired evidence
fibrehigh-capacity primary or growth routeroute, delivery, diversity and tariff
microwaveregional point-to-point backhaulspectrum, line of sight and capacity
geostationary satellitebroad reach and established servicescapacity, latency, gateway and SLA
low Earth orbit satellitelower-latency distributed accesslicence, terminal, capacity and continuity
mobile networklocal access and redundancycoverage, congestion and commercial terms

Proposed comparison; actual results depend on location, provider, contract and measured performance.

7. Measure capacity and contention

Satellite and terrestrial capacity must be translated into committed information rates, burst rights, contention, priority, oversubscription and restoration obligations. [1][9][11][32] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with beam and gateway allocation, committed and peak rate, fair-use rules, congestion history, traffic profile, quality of service and upgrade rights. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that advertised peak speed is used as continuous saleable capacity. The practical response is to size customer promises to enforceable capacity and measured busy-period performance. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

8. Locate the payer and budget

Every forecast workload needs a customer, authorised budget owner, payment source, procurement route and credit assessment. [6][8][22][27] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with customer identity, use case, procurement, approved budget, contract term, payment history, security, public appropriation and funding expiry. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that social value, technical interest or pilot use is treated as recurring revenue. The practical response is to progress demand from use case to priced proposal, approved budget, contract, acceptance and collection. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

9. Test affordability and usage

Coverage creates value only when users or institutions can afford devices, services, applications and recurring connectivity. [2][3][4][5] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with income and price data, device access, service bundle, subsidy, shared-access model, demand elasticity, churn and collection. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that a closed coverage gap is assumed to close the usage gap at the forecast tariff. The practical response is to model adoption and payment by customer cohort and identify the party funding any affordability gap. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

10. Design the revenue contract

Contracts should define capacity, service, acceptance, price, currency, indexation, minimum payment, credits, termination and security. [22][23][27][30] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with signed agreement, order form, service schedule, acceptance test, invoice basis, taxes, payment mechanics, credit support and dispute route. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that letters of intent, grants or traffic forecasts support debt sizing as contracted revenue. The practical response is to value cash according to enforceability, conditions, tenor, customer credit and collection evidence. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

Table 3. Anchor-contract diligence
TermEvidenceFinancing concern
reserved serviceunit, site and commencementacceptance condition
price and currencytariff and indexationmargin and convertibility
service levelmeasurable performancecredits and termination
payment supportpayer, account and securityarrears and set-off
renewal and exitnotice, data and migrationresidual utilisation

Proposed comparison; governing contracts determine enforceability.

11. Resolve licensing and spectrum

Country-specific authorisation, type approval, spectrum, landing, gateway, data and telecom rules affect launch timing and service legality. [1][10][11][17] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with regulatory map, responsible authority, licence, spectrum rights, equipment approval, local entity, fees, renewal, reporting and sanctions. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that approval in one country or a global satellite licence is assumed to authorise regional service. The practical response is to make every country launch conditional on written local regulatory evidence. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

12. Secure gateway and carrier rights

Satellite capacity depends on gateways, earth stations, terrestrial transit, peering and rights that may sit outside the project company. [9][10][15][33] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with gateway location, ownership, licence, capacity, diversity, transit, interconnection, direct agreements, step-in and alternate route. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that multiple customer terminals are treated as network diversity despite a common gateway or upstream carrier. The practical response is to map shared dependencies and procure tested alternate routes where the service requires them. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

13. Design reliable node power

Each node needs deliverable primary power, backup, storage, fuel or renewable supply, cooling and an operating response to outages. [16][17][18][19] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with connection, sanctioned load, outage record, generation, battery autonomy, fuel logistics, cooling design, maintenance, tariff and test results. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that nameplate generation or a national access statistic is treated as continuous usable power. The practical response is to size services to commissioned power and stress outage duration, fuel, tariff and equipment degradation. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

14. Control sites and equipment

Site tenure, physical access, equipment title, customs, insurance, security, assignment and relocation rights determine buildability and recovery. [18][27][28][30] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with lease or title, permits, access, import and customs path, equipment register, serial numbers, insurance, assignment, direct agreement and exit route. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that a proposed host site or partner discussion is treated as controlled infrastructure. The practical response is to release capital only after transferable site and equipment rights are documented. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

Table 4. Node-release gate
GateRequired evidenceCapital action
licence and sitewritten authority and transferable rightscondition precedent
power and coolingcommissioned capacity and testsize or defer
network pathcontracted capacity and failoverprocure or reject
customer and payeracceptance schedule and contractrelease or hold
cyber and recoveryapproved controls and exerciseremediate before service

Proposed minimum gate; local requirements may add conditions.

15. Map data and cyber obligations

Distributed nodes increase exposure across identity, remote access, suppliers, physical security, data location, logging and recovery. [20][21][31][32] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with data inventory, processing roles, cross-border path, sector rules, trust boundaries, privileged access, segmentation, logging, incident plan and recovery test. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that encryption or a certification label substitutes for an operating control system. The practical response is to embed cyber, data and recovery obligations in design, acceptance and supplier contracts. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

16. Allocate service-chain responsibility

The service crosses site owner, power supplier, satellite provider, gateway, carrier, equipment vendor, integrator, operator, application provider and customer. [18][20][27][30] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with responsibility matrix, hand-off, service measure, maintenance window, warranty, credit, indemnity, cap, insurance, step-in and termination. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that the project company promises end-to-end service without matching rights against upstream providers. The practical response is to align customer obligations with measurable supplier obligations and fund retained gaps. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

17. Build node unit economics

Each node should show revenue, satellite capacity, terrestrial transit, power, maintenance, field support, licence, tax, service credits, receivables and refresh. [3][9][22][24] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with billable unit, customer and workload mix, price, utilisation, bandwidth, energy, support, downtime, bad debt, working capital and refresh. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that revenue per node or user omits idle capacity, shared-network cost, collection delay and service credits. The practical response is to measure contribution and collected cash by customer, workload, node and cluster. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

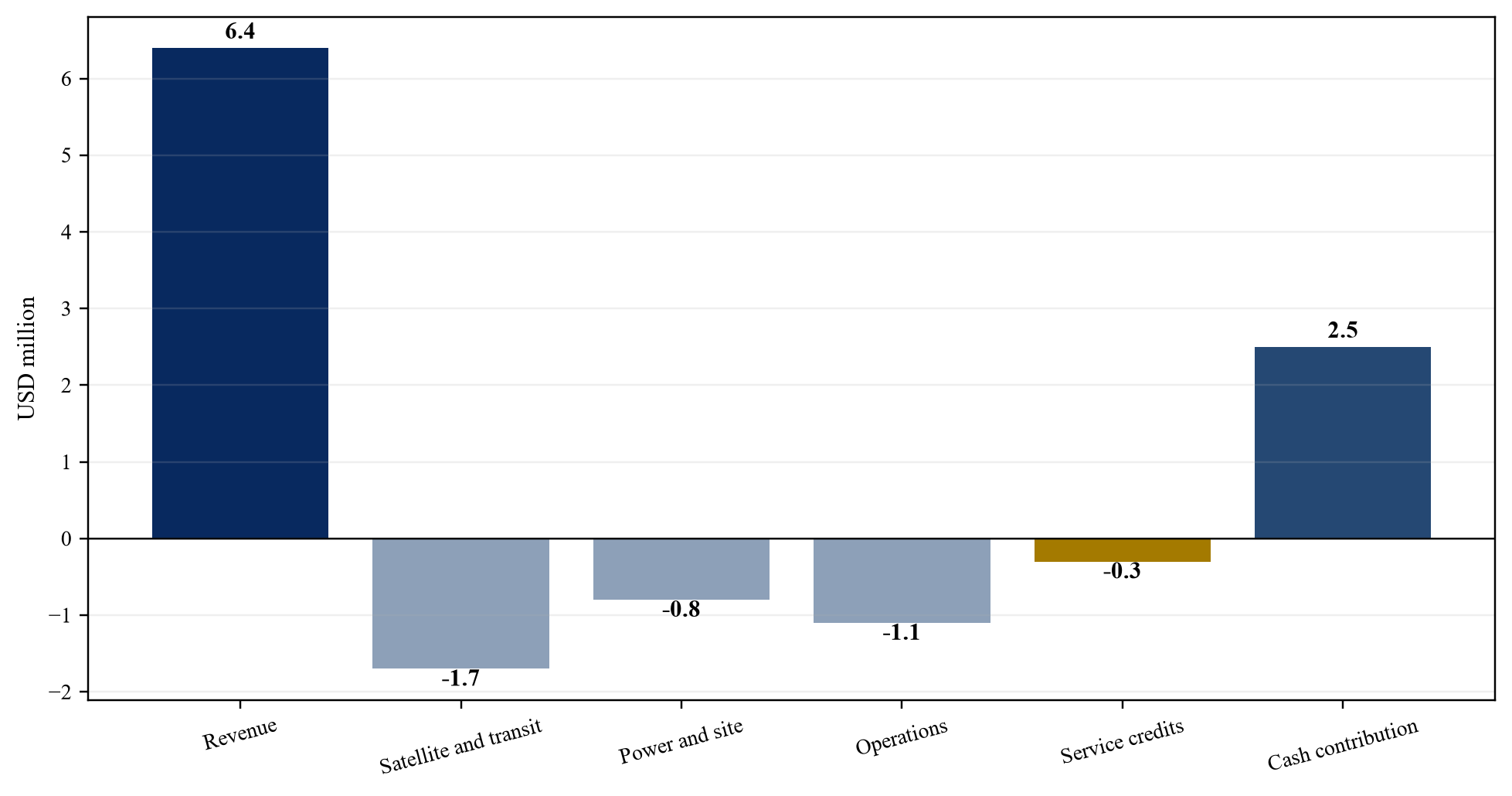

Figure 3. Hypothetical annual node cash bridge
Figure 3. Hypothetical annual node cash bridge
Wholly hypothetical; USD million for one representative accepted node.

18. Separate capacity states

Planned, licensed, installed, commissioned, connected, accepted, reserved, billable and collected capacity have different financing value. [1][9][22][27] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with state definition, evidence, date, expiry, owner, remaining conditions, cost to advance and linked customer. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that ordered equipment or available satellite coverage is reported as revenue-generating capacity. The practical response is to use a capacity waterfall with evidence rules for every movement. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

19. Measure concentration correctly

Geographic dispersion does not diversify a portfolio when nodes share a satellite provider, gateway, vendor, currency, government payer or power supplier. [9][11][23][29] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with exposure by provider, beam, gateway, country, customer, currency, bank, vendor, technology and recovery path. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that node count or country count is used as the diversification measure. The practical response is to calculate common-cause exposures and set concentration limits before crediting diversification. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

Table 5. Common-cause concentration map
DependencyExposure measurePossible control
satellite provider and beamrevenue and nodes affectedalternate capacity and limit
gateway and carriercash exposed to one routediverse path and direct agreement
sovereign and licenceassets and cash by countrystaging and country cap
customer and payercontracted revenue concentrationsecurity and portfolio limit
currency and bankcash and debt mismatchmatching, reserve and account control

Proposed framework; exposure should be measured before portfolio diversification is credited.

20. Stage the twelve-node portfolio

The hypothetical programme releases six first-wave nodes, preserves four options and defers two until customer, licence and infrastructure evidence improve. [4][6][10][27] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with node dossier, readiness score, anchor contract, cost, schedule, acceptance, ramp, liquidity, option expiry and stop authority. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that all candidate nodes receive simultaneous capital despite different readiness and common dependencies. The practical response is to use modular deployment and explicit rights to defer, resize, relocate or stop. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

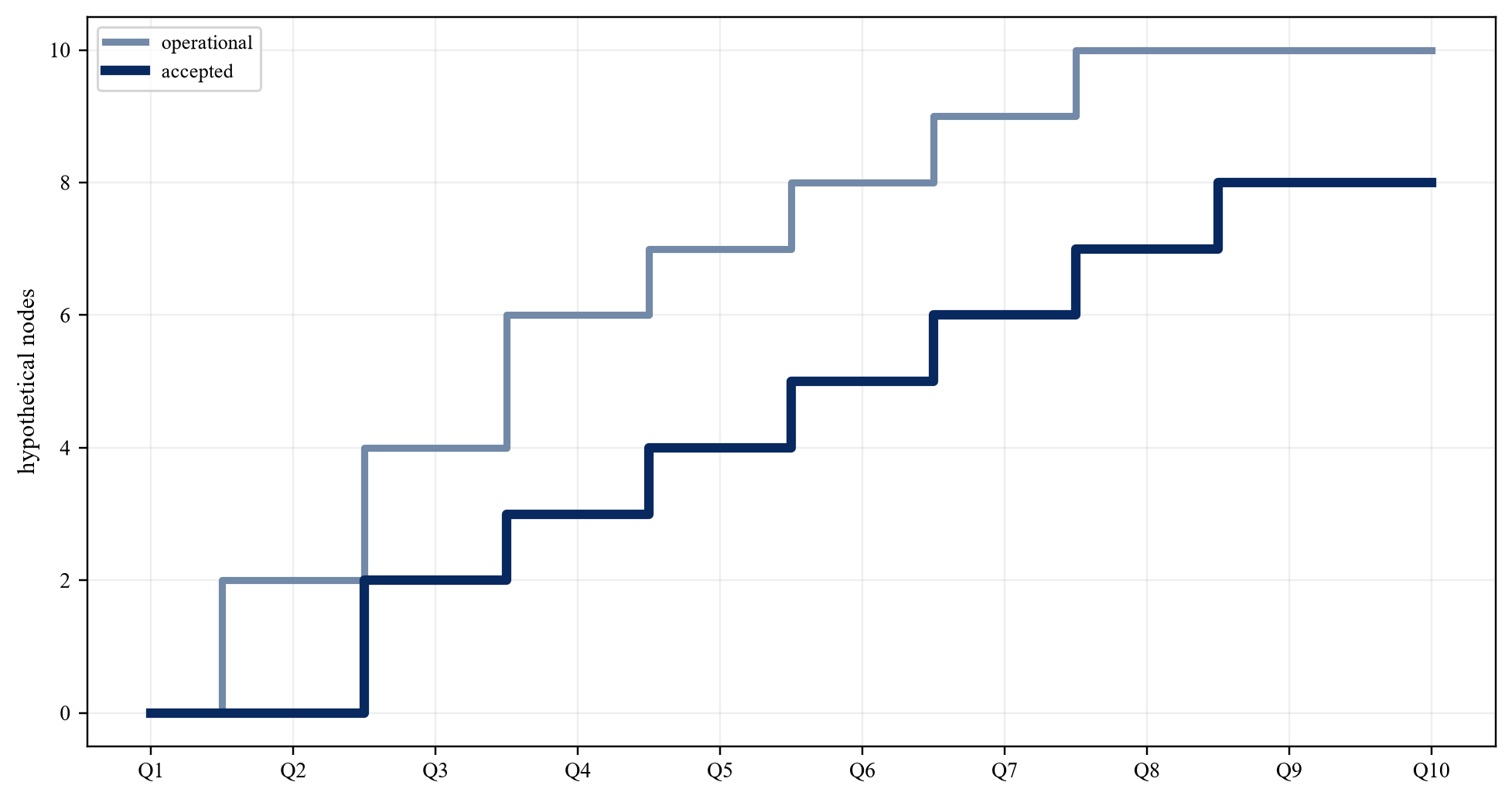

Figure 4. Hypothetical twelve-node deployment curve
Figure 4. Hypothetical twelve-node deployment curve
Wholly hypothetical; accepted nodes lag installed nodes until regulatory, customer and service acceptance.

21. Apply the hypothetical sources and uses

The USD 180 million case separates durable infrastructure, edge equipment, satellite integration, software, deployment and reserves. [23][27][28][29] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with wholly hypothetical sources and uses, draw conditions, amortisation, grant or blended terms, reserve policy, anchor support, vendor terms and sponsor cure. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that funding categories hide which capital absorbs licensing, technology, demand, currency and operating risk. The practical response is to allocate debt to eligible accepted cash and risk-bearing capital to uncertainty. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

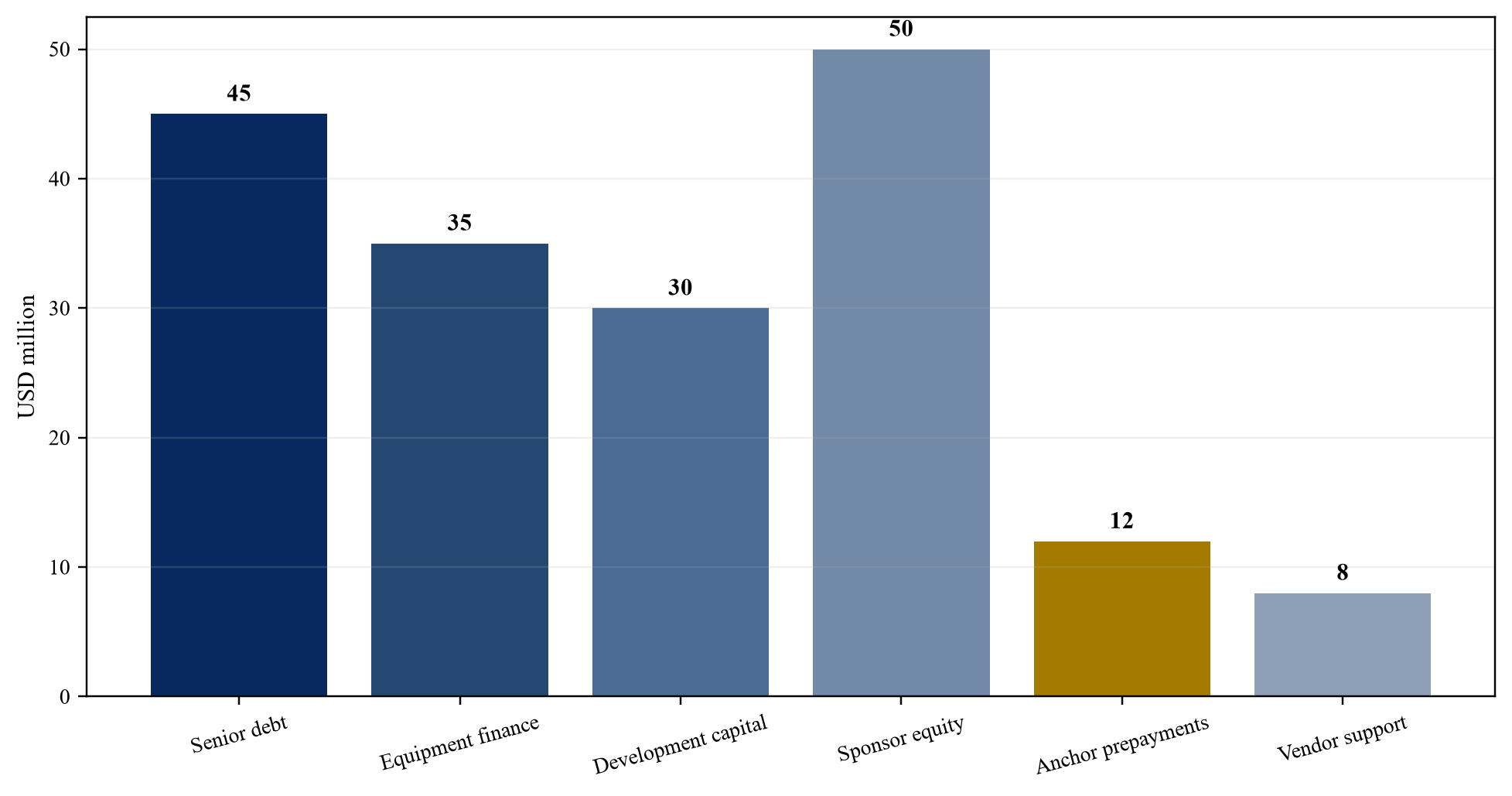

Figure 5. Hypothetical USD 180 million funding plan
Figure 5. Hypothetical USD 180 million funding plan
Wholly hypothetical; USD million.
Table 6. Hypothetical twelve-node financing case
MetricCentral caseCombined downside
accepted nodes in year five87
billable utilisation62%38%
recurring revenueUSD 46 millionUSD 25 million
deployment delaynone beyond plan12 months
satellite-cost variancebase+18%
debt-service coverage ratio1.47x0.78x

Wholly hypothetical; figures do not describe an announced project.

22. Match capital to asset lives

Sites and power, satellite terminals, servers, network equipment and software have different useful lives, portability and replacement cycles. [23][24][25][26] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with asset register, useful life, warranty, maintenance, residual value, replacement, security, amortisation, cash sweep and refresh reserve. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that long-dated debt and terminal value rely on equipment beyond its economic or contractual life. The practical response is to separate borrowing bases and fund refresh within coverage and valuation. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

23. Design the capital stack

Senior debt, equipment finance, development capital, sponsor equity, customer prepayments and vendor support should bear risks they can price and control. [27][28][29][30] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with tranche purpose, eligibility, tenor, currency, repayment, security, intercreditor terms, conditions, reserves, cure and distribution tests. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that cheap capital is spread uniformly across assets and countries without regard to risk or cash availability. The practical response is to match each source to a defined asset, risk period and enforceable cash flow. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

24. Allocate construction and operating risk

The party controlling a milestone or service failure should carry a measurable obligation, remedy or funded exposure. [18][20][27][30] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with risk matrix, milestone, warranty, delay damages, service credit, insurance, direct agreement, cap, relief, step-in and termination. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that correlated risks remain in the project company without price, recourse, reserve or operating control. The practical response is to place risk with the party able to prevent, measure or remedy it and capitalise the remainder. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

25. Stress correlated downside

Licensing delay, lower utilisation, satellite congestion, gateway outage, power failure, currency depreciation, customer arrears and equipment refresh can occur together. [3][11][16][23] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with monthly integrated scenarios, covenant headroom, concentration, deferred nodes, alternate routes, sponsor cure, reserve use and termination cash. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that single-variable sensitivities understate interactions between demand, network, sovereign, currency and financing risk. The practical response is to test the seven-node, 38 per cent utilisation, twelve-month delay and 18 per cent satellite-cost increase together. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

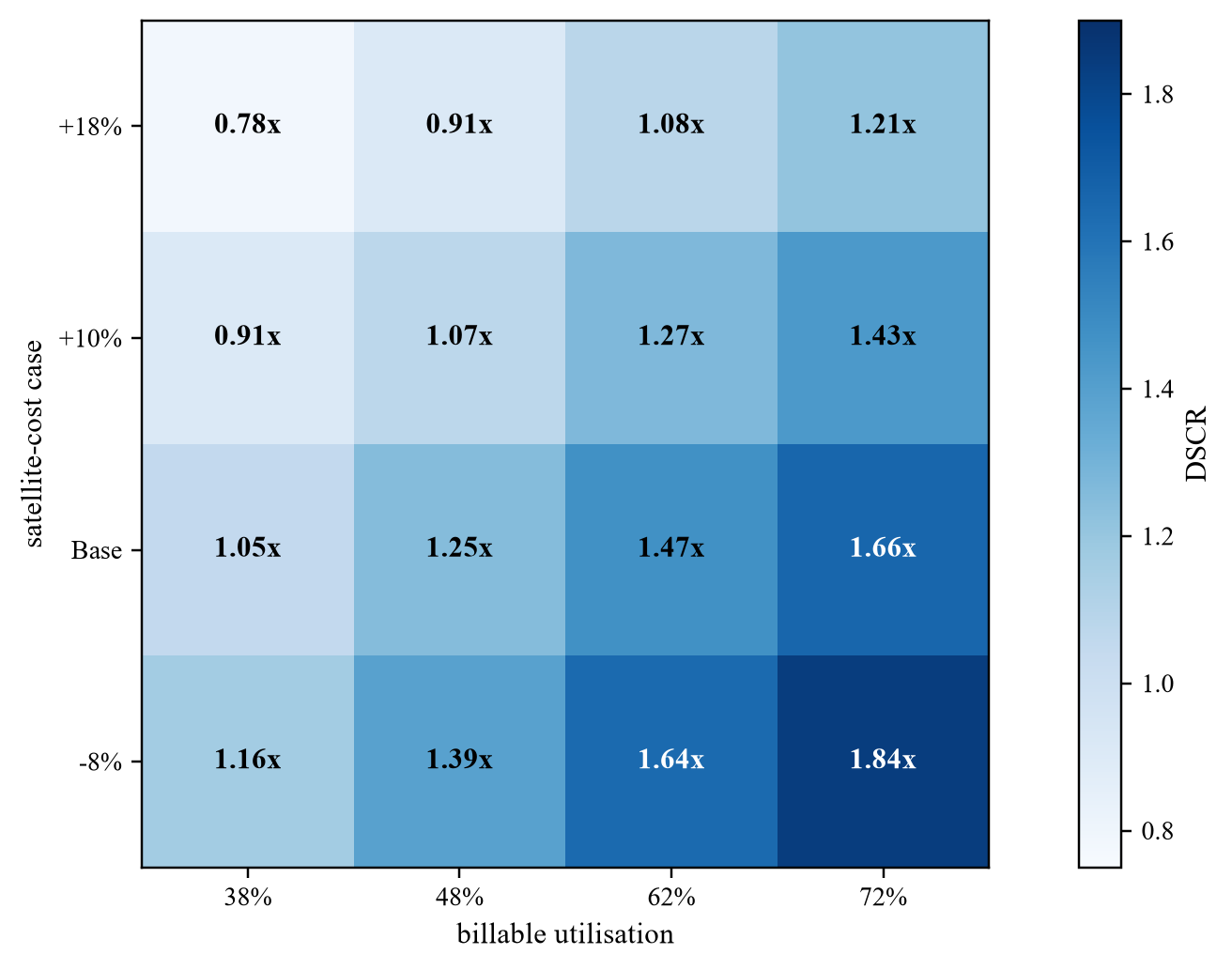

Figure 6. Hypothetical portfolio DSCR sensitivity
Figure 6. Hypothetical portfolio DSCR sensitivity
Wholly hypothetical; combined utilisation and satellite-cost cases.

26. Design covenants and reserves

Credit controls should identify deterioration before cash is exhausted and preserve funds for debt service, network, maintenance and refresh. [23][25][27][29] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with minimum coverage, liquidity, concentration, accepted-node ratio, collections, outage, arrears, currency, reserve target, cash sweep and distribution lock. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that a single annual debt-service ratio allows operational weakness and concentration to develop unnoticed. The practical response is to use monthly operating and cash triggers with defined cure, hold and stop actions. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

27. Protect step-in and recovery

Financiers need practical remedies when a supplier, customer, node, country or network path fails. [10][18][27][30] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with security package, direct agreements, equipment title, software and data continuity, licence transfer, account control, relocation cost, alternate users and sale route. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that security is taken over assets and contracts that cannot transfer, move or operate after enforcement. The practical response is to test recovery routes net of consent, time, configuration, currency, tax and remarketing cost. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

28. Reach the investment decision

Approval requires contracted anchor cash, lawful service, commissioned infrastructure, measured unit economics, controlled concentration, funded refresh and combined downside liquidity. [1][3][10][27] The analysis should identify the asset owner, operator, customer, payer, financier and party responsible for performance failure or remediation. A regional statistic can prioritise diligence. It cannot replace a contract, licence, technical test or bank receipt.

The evidence file should begin with investment memorandum, evidence ledger, contracts, technical acceptance, regulatory opinions, model, financing, security, scenarios and approval record. Each item should state its country and service scope, definition, effective date, expiry or refresh point, accountable owner and relationship to accepted service and collected cash. Public statistics, standards and policy documents provide context. Portfolio value requires node-level rights, lawful operation, utility and network evidence, executed customer obligations, measured performance and financial reconciliation.

The principal failure is that strategic urgency or regional digital growth replaces evidence for the specific portfolio. The practical response is to approve one node and customer cohort at a time with named owners, expiry dates and stop authority. Management estimates belong in a clearly identified model input register and should be replaced when observed evidence becomes available. Forecast changes should preserve the original case, the revised assumption, the source and the effect on utilisation, liquidity and debt coverage.

Table 7. Investment decision record
DecisionMinimum evidencePossible action
country entrylicence, entity, bank and currency routeenter, condition or defer
node releasesite, power, network and permitfund, resize or stop
service releasecustomer, acceptance and measured pathlaunch, redesign or hold
debt draweligible collected cash and coveragedraw, reduce or block
next cohortacceptance, concentration and liquidityexpand, relocate or stop

Proposed governance; each approval records evidence, owner and expiry.

Sources

  1. International Telecommunication Union, *The State of Broadband in Africa 2025*. Read the primary source
  2. International Telecommunication Union, *Measuring Digital Development Facts and Figures 2025*. Read the primary source
  3. GSMA, *The Mobile Economy Africa 2025*. Read the primary source
  4. GSMA, *The State of Mobile Internet Connectivity 2025 Network Coverage and Infrastructure*. Read the primary source
  5. International Telecommunication Union, *ICT Price Baskets*. Read the primary source
  6. World Bank, *From Connectivity to Services Digital Transformation in Africa*. Read the primary source
  7. African Union, *Digital Transformation Strategy for Africa 2020 to 2030*. Read the primary source
  8. African Development Bank, *Nigeria Digital Value Chain Infrastructure Project BRIDGE*. Read the primary source
  9. Orange and Eutelsat, *Strategic Partnership to Accelerate Satellite Internet in Africa and the Middle East*, 4 March 2025. Read the primary source
  10. International Telecommunication Union, *Regional Initiatives for Africa 2025 Satellite Regulation Training*. Read the primary source
  11. International Telecommunication Union, *Economic and Policy Aspects of High-Speed Internet Connectivity by Retail Satellite Operators*. Read the primary source
  12. ETSI, *Multi-access Edge Computing*. Read the primary source
  13. 3GPP, *Specifications*. Read the primary source
  14. ITU-T Recommendation Y.1541, *Network Performance Objectives for IP-based Services*. Read the primary source
  15. Internet Society, *Internet Resilience Index*. Read the primary source
  16. International Energy Agency, *World Energy Investment 2025 Africa*. Read the primary source
  17. World Bank, *Mission 300*. Read the primary source
  18. International Finance Corporation, *Environmental Health and Safety Guidelines for Telecommunications*. Read the primary source
  19. International Finance Corporation, *General Environmental Health and Safety Guidelines*. Read the primary source
  20. National Institute of Standards and Technology, *Cybersecurity Framework 2.0*. Read the primary source
  21. ISO, *ISO IEC 27001 Information Security Management Systems*. Read the primary source
  22. IFRS Foundation, *IFRS 15 Revenue from Contracts with Customers*. Read the primary source
  23. IFRS Foundation, *IFRS 9 Financial Instruments*. Read the primary source
  24. IFRS Foundation, *IAS 16 Property Plant and Equipment*. Read the primary source
  25. IFRS Foundation, *IAS 36 Impairment of Assets*. Read the primary source
  26. IFRS Foundation, *IFRS 16 Leases*. Read the primary source
  27. World Bank Group, *Public Private Partnership Contractual Provisions*. Read the primary source
  28. Private Infrastructure Development Group, *Emerging Africa and Asia Infrastructure Fund*. Read the primary source
  29. African Development Bank, *USD 100 Million Loan to EAAIF*, 12 November 2025. Read the primary source
  30. African Development Bank, *Partnership with AXIAN Telecom*, 29 January 2025. Read the primary source
  31. GSMA, *Mobile Privacy Principles*. Read the primary source
  32. International Telecommunication Union, *Quality of Service and Quality of Experience*. Read the primary source
  33. World Bank, *Africa Regional Connectivity*. Read the primary source
Questions, answered

African Edge Compute with Satellite Backhaul: frequently asked questions

No. Coverage is one input. A financeable node also needs local authorisation, contracted capacity, a defined workload, an accepted service, an identified payer, reliable power, measurable operating performance and collected cash.

The choice depends on the workload, location, latency, capacity, availability, licensing, cost, gateway and redundancy requirements. The paper recommends testing the complete service path and contractual protections rather than selecting an orbit in isolation.

Forecast named customer cohorts by workload, procurement stage, contract status, acceptance date, billable capacity, tariff, currency and collection. National connectivity indicators can rank markets for diligence but should remain outside committed revenue.

Senior debt should rely on lawful operations, commissioned assets, accepted service, enforceable customer cash, controlled concentration, adequate coverage, funded reserves and practical lender rights. Uncontracted demand should remain outside the debt case.

Equipment finance or shorter-term amortising facilities may match their economic lives where title, maintenance, insurance, refresh and relocation value are clear. Sponsor and development capital should absorb early licensing, integration and demand risk.

Geographic spread helps only where common dependencies are limited. The portfolio should measure exposure to each satellite provider, beam, gateway, carrier, vendor, country, customer, currency and bank before assigning a diversification benefit.

The model should map each customer tariff, collection currency, operating cost, reserve and debt obligation. Coverage should be tested after devaluation, convertibility delay and trapped cash, with matching or other controls documented where available.

It should require local regulatory evidence, controlled site and equipment rights, commissioned power and network capacity, a tested service path, an enforceable anchor contract, node-level unit economics, concentration analysis, combined downside liquidity and explicit stop rights.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
