Debt · Electricity Grids and Transmission

Build the Grid Ahead of Demand: Financing Anticipatory Transmission

A comparative financing and risk-allocation framework for building strategic transmission capacity before demand fully materialises.

Build the Grid Ahead of Demand: Financing Anticipatory Transmission
Quick answer

Connect long-term system need to benefits, beneficiaries, cost allocation, staged funding and consumer protection; compare regulated, public, private and blended financing across the UK, US, GCC and India.

Abstract

Transmission infrastructure often takes longer to plan, permit, finance and construct than the generation and demand it must serve. Waiting for every project to become firm can create connection queues, renewable curtailment, reliability pressure and delayed industrial or digital investment. Building early can reduce those costs, but it exposes consumers and investors to demand, route, delivery and stranded-capacity risk. This paper develops the Anticipatory Transmission Financing Framework.

It connects long-term scenarios, system need, alternatives, benefits, beneficiaries and cost allocation to a staged investment lifecycle. It evaluates regulated asset-base treatment, early construction funding, construction-work-in-progress recovery, delivery incentives, competitive transmission, concessions, public funding, green debt, institutional capital and blended finance. It then applies the framework to the United Kingdom, United States, GCC and India.

The International Energy Agency recommends proactive grid investment, anticipatory regulatory treatment and stronger supply-chain pipelines [1]-[3]. Ofgem's Accelerated Strategic Transmission Investment framework provides streamlined assessment and early construction funding with consumer safeguards [4]-[5]. FERC Orders 1920, 1920-A and 1920-B establish long-term regional planning, scenario analysis, benefits and cost-allocation processes [6]-[7].

GCCIA expansion plans and India's notified National Electricity Plan illustrate regional and national anticipatory build programmes [8]-[10]. The central conclusion is that anticipatory transmission can be financeable when system need, benefit allocation and staged consumer protection are documented together. Four tables and three figures translate the framework into a transaction method.

All numerical examples are hypothetical management assumptions used solely to demonstrate the method; they are not observations, forecasts, valuation conclusions or investment recommendations.

JEL Classification: G21, G28, G31, G32, H54, L51, L94, Q40, Q48

Keywords: anticipatory transmission, grid finance, cost allocation, regulated asset base, transmission planning, ASTI, FERC Order 1920, GCC interconnection, India transmission

This Matchpoint Insight presents the web edition of Matchpoint Partners' research. The supporting paper contains the full framework, structures, worked examples and source material.

Register Before Download   Explore our Debt practice

1. Define the anticipatory-investment decision

Anticipatory transmission commits capital before all generation or demand is contracted. The decision is whether future system benefits justify early expenditure, which risks consumers should bear and which conditions should govern release of funding.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

2. Explain why the grid must move first

Transmission often takes longer to plan, permit and build than renewable generation, industrial load or data centres. Waiting for firm demand can create queues, curtailment and delayed economic activity.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

3. Separate forecast need from committed need

Scenario evidence, signed projects, policy targets and contracted load carry different certainty. The plan should show which capacity is supported by each evidence class and how that evidence can change.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

4. Compare the regional models

The UK, United States, GCC and India use different combinations of regulated investment, regional planning, public direction, utility balance sheets and competitive delivery. The framework should preserve those legal differences.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

5. Map the investment lifecycle

The lifecycle should connect system need, scenarios, options, route, land, permits, engineering, procurement, financing, construction, commissioning and cost recovery to explicit approval gates.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

Table 1. Comparative anticipatory-transmission models

MarketPlanning anchorPrincipal funding routeConsumer or public protectionCore execution challenge
United KingdomStrategic network need and ASTI project approvalRegulated recovery with staged early fundingCost evidence, incentives, clawback and independent reviewAccelerated permitting and supply chain
United StatesLong-term regional scenarios under FERC planning rulesUtility and transmission-provider investment with approved allocationBenefit-based allocation, state engagement and transparent selectionMulti-state agreement and siting
GCCNational plans and regional interconnection strategyUtility, sovereign and project finance combinationsMember-state approvals, benefit sharing and delivery oversightCross-border allocation and dispatch
IndiaNational and state transmission plans and renewable corridorsRegulated, public and competitively awarded transmissionRegulatory approval, tariff discipline and programme monitoringScale, land, state coordination and utility credit

The summary is conceptual and subject to the governing law, regulatory decisions and project documents.

6. Build long-term scenarios

Scenarios should cover load growth, generation mix, retirements, storage, electrification, data centres, industry, climate resilience and policy. They should be updated as material evidence changes.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

7. Map demand drivers

Population, urbanisation, cooling, electric mobility, industrial policy, hydrogen, desalination and digital infrastructure can create concentrated or corridor-specific demand. Timing and flexibility matter as much as headline volume.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

8. Map generation drivers

Renewable zones, nuclear, gas, storage and cross-border imports create different transmission patterns. The plan should distinguish evacuation, reliability and market-integration needs.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

9. Price reliability and resilience

Transmission can provide redundancy, stability, restoration and access to diverse resources. Reliability value should be supported by system studies and avoided-event analysis rather than broad assertions.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

10. Recognise option value

A corridor built with headroom can accommodate future projects and reduce repeated permitting and construction. Option value depends on credible future use, design flexibility and the cost of unused capacity.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

11. Build the project portfolio

A portfolio can combine urgent reinforcement, strategic corridors, replacements and digital upgrades. Ranking should reflect benefits, deliverability, dependencies and system-wide interactions.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

12. Stage capacity deliberately

Phased circuits, substations and equipment can align capital with demand while preserving the corridor. Staging should not create avoidable rework or strand early assets.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

13. Protect strategic corridors

Securing routes and substation sites early can preserve scarce options. The programme should define the minimum rights needed, holding cost and route-change protection.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

14. Secure land and easements

Land acquisition should align with route alternatives, environmental surveys, access and compensation. Early funding requires controls for land that later becomes unnecessary.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

15. Integrate permitting and consultation

Transmission approval can depend on environmental review, community engagement, heritage, aviation, marine and land-use decisions. The programme should budget time and mitigation before the construction date is committed.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

16. Map supply-chain constraints

Transformers, cables, conductors, towers, switchgear and specialist vessels or labour can constrain delivery. Pipeline visibility and standardisation can support supplier investment.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

17. Use early procurement selectively

Long-lead equipment can be reserved before final approval where delay cost is high. Cancellation rights, storage, specification risk and recoverability should be explicit.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

18. Standardise designs where useful

Standard voltage, substation and equipment families can reduce engineering, procurement and spares complexity. Standardisation should retain room for site and system requirements.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

19. Embed digital capability

Dynamic line ratings, sensors, control, protection and data can increase transfer capability and asset utilisation. Cybersecurity, interoperability and lifecycle support belong in the investment case.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

20. Value flexibility alternatives

Storage, demand response, topology changes and grid-enhancing technologies can defer or resize conventional investment. The comparison should use equivalent reliability and service outcomes.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

Figure 1. Anticipatory-transmission investment chain
Figure 1. Anticipatory-transmission investment chain

Early capital should move through evidence-based approvals from scenario to operating asset.

21. Define the benefit-cost framework

The framework should compare capital and operating cost with reliability, congestion, generation access, avoided curtailment, loss reduction, resilience, competition and economic-development benefits.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

22. Measure avoided delay

Building ahead can shorten connection waits for future projects. The value should use realistic project probabilities and distinguish social value from revenues available to the transmission owner.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

23. Avoid double counting benefits

Congestion reduction, lower generation cost and renewable integration can overlap. The model should trace each benefit to one causal mechanism and one beneficiary group.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

24. Identify beneficiaries

Beneficiaries can include load, generators, network users, regions, future customers and neighbouring systems. Cost allocation should follow supported benefits and applicable law.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

25. Design cost allocation

Allocation can be postage-stamp, zonal, beneficiary-based, connection-funded, public-funded or hybrid. The chosen method should be transparent, durable and capable of handling future entrants.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

26. Protect current consumers

Consumers should receive evidence that early investment is prudent, efficient and governed. Controls can include staged approvals, independent review, cost sharing, incentives and clawback.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

27. Price stranded-capacity risk

Demand can arrive late, move or fail. The downside model should show unused capacity, carrying cost, alternative uses, cancellation recoveries and responsibility for shortfall.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

28. Plan cancellation and scope change

Early work can become unnecessary after scenario, route or technology changes. Contracts should define termination, reuse, resale, compensation and documentation.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

29. Define early-development funding

Development allowances can fund engineering, land, permits, surveys and supply-chain commitments before final construction approval. The scope and evidence standard should be narrow and auditable.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

30. Use the regulated asset base carefully

A regulated asset base can support low-cost financing where prudent expenditure earns a return through tariffs. Entry timing, depreciation and disallowance risk shape financeability.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

Table 2. Anticipatory-investment risk-allocation matrix

RiskNetwork ownerRegulator or public authorityUsers or beneficiariesEvidence and control
Demand arrives lateEfficient staged design and mitigationApprove scenarios and sharing rulesCommit where direct benefits are identifiableScenario updates and utilisation triggers
Route or permit failureDevelop alternatives and engage stakeholdersCoordinate statutory processSupport project-specific access where applicableRoute studies, permits and consultation record
Cost escalationProcure efficiently and control scopeAllow prudent cost and set incentivesPay allocated share under approved methodBaseline, tender evidence and change log
Project cancellationRecover, reuse or resell early assetsSet clawback and recovery rulesMeet contractual exit obligationsCancellation plan and asset register
Under-deliveryManage contractors and interfacesEnforce output and incentive regimePreserve agreed information and accessMilestones, independent review and testing
Benefit shortfallOperate and optimise the completed assetReview allocation and future planningProvide actual use dataPost-completion benefit and utilisation review

Allocation should follow controllability, benefit and the governing regulatory framework.

31. Decide when revenue begins

Recovery can begin during construction, at commissioning or through milestones. Earlier recovery lowers financing cost while exposing consumers before assets provide service.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

32. Evaluate construction-work-in-progress treatment

CWIP or equivalent mechanisms can improve cash flow and credit metrics. The regulator should balance financing savings against delivery discipline and intergenerational fairness.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

33. Design delivery incentives

Incentives can reward timely output, efficient cost, capacity and availability. Penalties and sharing factors should reflect risks the transmission owner can control.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

34. Test competitive delivery

Competition can reveal cost and capability for suitable projects. The model should account for tender time, interfaces, financing, standards and long-term operation.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

35. Evaluate PPP and concession structures

A concession can allocate design, finance, construction and availability risk to a project company. Revenue, dispatch, land, interconnection and termination must remain bankable.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

36. Evaluate sovereign and public funding

Budget, development-bank or sovereign funding can support strategic projects and lower cost. Governance should retain transparent project selection and lifecycle accountability.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

37. Use green and sustainability-linked debt

Labelled debt can broaden capital access where use of proceeds and reporting meet recognised standards. The underlying credit and cost recovery remain decisive.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

38. Mobilise institutional capital

Pension, insurance and infrastructure investors can fund operating or construction-stage assets where risk, duration and regulation align. Portfolio structures can diversify project exposure.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

39. Use blended finance where constraints bind

Guarantees, subordinated capital, grants and technical assistance can address sovereign, currency, utility or early-stage risk. Concessional support should target a defined financing barrier.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

40. Manage currency and emerging-market risk

Local-currency revenue paired with foreign debt creates mismatch. Hedging cost, convertibility, inflation, indexation and sovereign support should be modelled.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

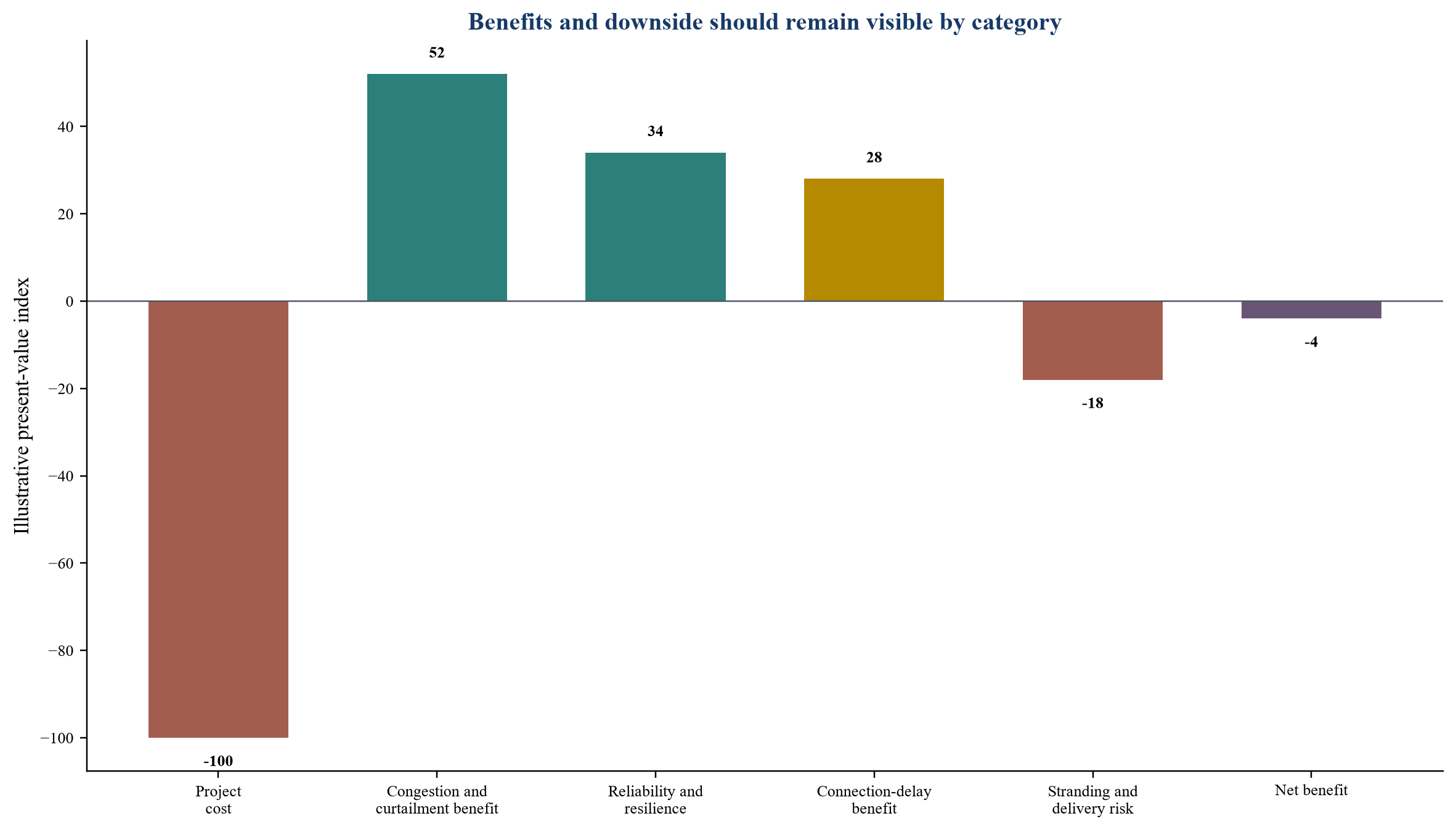

Figure 2. Illustrative benefit and downside bridge
Figure 2. Illustrative benefit and downside bridge

Values are hypothetical management assumptions used solely to demonstrate the framework.

41. Apply the framework to the United Kingdom

Ofgem's ASTI model accelerates strategic projects through streamlined assessment and early construction funding while retaining consumer protections, cost evidence and recovery controls.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

42. Apply the framework to the United States

FERC Orders 1920, 1920-A and 1920-B require long-term regional planning, scenario analysis, benefit evaluation and cost-allocation processes with enhanced state involvement.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

43. Apply the framework to the GCC

Regional interconnection and national expansion can support resilience, trade and future load growth. Project design should reconcile member-state benefits, sovereignty, dispatch and cost sharing.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

44. Apply the framework to India

India's notified transmission plan and green-energy corridors plan network capacity ahead of fast renewable additions. Financing must coordinate central, state and competitive transmission development.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

45. Value interregional transmission

Interregional links can share reserves, diversify weather and access lower-cost resources. Benefits and cost allocation should reflect multiple systems and credible transfer capability.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

46. Structure cross-border investment

Cross-border projects require treaty, market, dispatch, currency, tax, security and dispute arrangements. A physical line needs a durable commercial and institutional framework.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

47. Build sources and uses

Sources should match development, land, equipment, construction, financing and contingency uses by approval stage. Public, regulated and private capital should have clear priority and recovery.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

48. Test debt-service capacity

Debt sizing should reflect revenue commencement, construction profile, indexation, incentive exposure and cost-recovery risk. DSCR should be tested under delay, disallowance and under-utilisation.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

49. Build the downside cases

Cases should include delayed demand, route change, permit delay, equipment escalation, cancellation, weaker benefit realisation and lower allowed recovery. Mitigation should have quantified value.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

50. Control cost overruns

The baseline should separate owner scope, market escalation, design development, risk allowance and contingency. Change control should assign responsibility and preserve independent evidence.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

Table 3. Hypothetical financing and debt-service sensitivity

ScenarioCapital cost, USD mRevenue beginsAllowed recovery of prudent costMinimum DSCRDecision implication
Staged regulated build1,000During construction95%1.35xSupports early procurement with staged gates
Recovery at commissioning1,000Year 695%1.18xRequires larger construction liquidity
Cost escalation1,250During construction90%1.12xSharing and contingency become critical
Demand delayed five years1,000During construction85%1.04xHeadroom and alternative use drive value
Partial disallowance and delay1,200Year 775%0.86xCapital structure requires reset or support

All values are hypothetical management assumptions and do not represent an actual project or forecast.

51. Maintain liquidity through construction

Long programmes need committed facilities, reserve policy and draw flexibility. Liquidity should cover schedule downside without relying on unapproved tariff recovery.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

52. Align covenants with regulation

Covenants should recognise approval milestones, allowed revenue, cost sharing, completion and incentive exposure. Cure rights should activate before delivery or liquidity becomes irrecoverable.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

53. Procure for a repeatable programme

Framework agreements, supplier capacity reservations and standard packages can improve delivery across a portfolio. Competition, performance and concentration risks still require oversight.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

54. Create integrated governance

System planners, regulators, transmission owners, governments, users and financiers need defined decision rights, data and escalation. Governance should separate advocacy from approval.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

55. Publish transparent evidence

Public confidence improves when scenarios, alternatives, benefits, costs and performance are reported clearly. Commercially sensitive information can be protected without obscuring the decision basis.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

56. Run the system-need gate

This gate confirms scenarios, reliability need, demand and generation evidence, alternatives and timing. It prevents strategic language from substituting for a defined network requirement.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

57. Run the benefits and allocation gate

This gate validates benefit methods, beneficiaries, cost allocation and consumer protection. It should show who pays, when and why.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

58. Run the financing gate

This gate confirms sources, revenue, debt capacity, currency, contingency, incentives and downside liquidity. Funding should remain conditional on the approved risk perimeter.

The working file should identify the governing plan, regulatory instrument, benefit evidence, cost owner and approval date. Engineering, economic and financing conclusions should remain traceable to current authoritative sources.

A practical review asks which capacity is needed, why it must be built early, who benefits, who pays and how stranded risk is controlled. The output should support staged capital rather than an undifferentiated programme commitment.

59. Run the delivery gate

This gate confirms route, land, permits, engineering, supply chain, procurement, interfaces and milestones. Early work should have recoverability and cancellation controls.

The assessment should distinguish committed projects, scenario demand and policy aspirations. Regulators, network owners, users and financiers should use one reconciled need statement, programme and cost baseline.

The issue should be translated into dated actions, evidence tests and quantified risk allocation. Regulated recovery, public support, user funding and private finance should remain visible as separate sources.

60. Adopt the decision record and 90-day plan

The final record states need, preferred solution, staged capital, cost allocation, risk owners, evidence conditions and fallback. The first 90 days should close the most valuable planning and financing gaps.

The decision should be updated when demand, generation, route, cost or regulation changes. Every material assumption should have an owner, validation method and review date.

The objective is a financeable grid programme that arrives before credible demand without transferring uncontrolled risk. Early expenditure should proceed only where consumer and investor protections are commensurate with the uncertainty.

Table 4. Illustrative 90-day anticipatory-investment programme

PeriodWorkstreamCore actionsDecision outputAccountable owner
Days 1-15Need and scenariosReconcile plans, load, generation, reliability, corridors and timingConfirmed system-need statementSystem planner
Days 16-30Options and deliveryCompare conventional, digital, flexibility and staged solutionsPreferred technical optionsTransmission engineer
Days 31-45Benefits and allocationQuantify benefits, beneficiaries, downside and cost-sharing routesAllocation recommendationEconomist and regulator team
Days 46-60FinancingModel regulated, public, private and blended funding with sensitivitiesFinanceable capital structureFinancial adviser
Days 61-75Risk and procurementAllocate route, supply-chain, cost, cancellation and performance riskExecutable delivery strategyCommercial director
Days 76-90Decision recordSet staged approvals, consumer protections, owners and reportingApproved anticipatory programmeAuthorised board and regulator

Timing is indicative and should be adapted to the governing planning and regulatory process.

Figure 3. Five gates for anticipatory transmission
Figure 3. Five gates for anticipatory transmission

Each gate requires documented evidence before the next capital commitment.

The framework turns anticipatory transmission from a broad policy ambition into a staged capital programme. It links long-term system evidence to benefits, cost allocation, financing, delivery and consumer protection.

Execution quality depends on maintaining the evidence as the system changes. Early capital should preserve strategic options and delivery capacity while retaining explicit controls for cancellation, cost and under-utilisation.

References

  1. International Energy Agency, "Electricity Grids and Secure Energy Transitions," 2023, https://www.iea.org/reports/electricity-grids-and-secure-energy-transitions
  2. International Energy Agency, "Building the Future Transmission Grid," https://www.iea.org/reports/building-the-future-transmission-grid
  3. International Energy Agency, "Electricity 2026," https://www.iea.org/reports/electricity-2026
  4. Ofgem, "Decision on Accelerating Onshore Electricity Transmission Investment," 2022, https://www.ofgem.gov.uk/decision/decision-accelerating-onshore-electricity-transmission-investment
  5. Ofgem, "Accelerated Strategic Transmission Investment Guidance and Submission Requirements," https://www.ofgem.gov.uk/sites/default/files/2023-08/Accelerated%20Strategic%20Transmission%20Investment%20Guidance%20And%20Submission%20Requirements%20Document.pdf
  6. Federal Energy Regulatory Commission, "Explainer on the Transmission Planning and Cost Allocation Final Rule," https://www.ferc.gov/explainer-transmission-planning-and-cost-allocation-final-rule
  7. Federal Energy Regulatory Commission, "Order No. 1920 Fact Sheet," https://www.ferc.gov/news-events/news/fact-sheet-building-future-through-electric-regional-transmission-planning-and
  8. GCC Interconnection Authority, "Our Plans," https://gccia.com.sa/gccia-grid/our-plans/
  9. GCC Interconnection Authority, "Projects Under Construction," https://gccia.com.sa/gccia-grid/projects-under-construction-2/
  10. Central Electricity Authority, "National Electricity Plan, Volume II: Transmission," https://cea.nic.in/psp___a_i/national-electricity-plan-volume-ii-transmission/?lang=en

About the Author

Chennakeshav (CK) is a corporate finance and investment banking executive with 25+ years of global experience in deal origination, structuring and execution across M&A, growth capital and corporate strategy. He has led value-creation mandates for founders, corporates and funds — bridging the boardroom view to hands-on execution and close.

His career spans Morgan Stanley, HSBC, Lloyds Banking Group, EWEC, ADQ portfolio companies and Emirates Growth Fund, across TMT, real estate, fintech, deeptech, cleantech, infrastructure and energy. He has partnered with C-suite leaders, private equity and venture funds, sovereign wealth funds and family offices to finance complex fund raises and scale-up ventures, and has led M&A due diligence, post-merger integration and business-transformation initiatives to create value.

At Matchpoint Partners he is Managing Partner, leading the firm's corporate finance, M&A and capital-raising practice. He holds an MBA from London Business School, an engineering degree from VTU and a Master of Laws (LLM, in progress) from UCL London.

An active start-up mentor, CK mentors at Techstars, DIFC FinTech Hive, Startup Grind, Founder Institute and IN5, serves as Entrepreneur Mentor in Residence (EMiR) at London Business School, and judges the Entrepreneurship World Cup.

https://www.linkedin.com/in/ckadya/

https://www.matchpoint-partners.com/team/ck-adya.html

Questions, answered

Build the Grid Ahead of Demand: frequently asked questions

It funds network capacity before every future user or generator is fully committed, based on supported system need and the value of earlier delivery.

Transmission can take longer to deliver than generation or load, creating connection delays, congestion, curtailment and reliability pressure.

Costs may be allocated to network users, identifiable beneficiaries, connecting customers, public budgets or a combination under the governing framework.

Controls include staged approvals, independent review, efficient-cost tests, incentives, sharing factors, clawback and transparent reporting.

Private capital can participate through regulated utilities, concessions, competitive transmission, project bonds or institutional platforms where revenue and risk are financeable.

The downside plan should cover staging, alternative users, flexibility, refinancing, tariff treatment, delayed expansion and cancellation.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
