Alternatives · Electricity Grids and Transmission

Stability Has a Price: Grid-Forming Inverters after Synchronous Generation

A valuation and procurement framework for inertia, system strength, fault performance and grid-forming investment after synchronous generation retires.

Stability Has a Price: Grid-Forming Inverters after Synchronous Generation
Quick answer

Translate system-stability need into service-specific grid-forming requirements, field qualification, procurement, valuation and financeable revenue.

Abstract

Power systems have historically received inertia, voltage-source behaviour and fault current as physical characteristics of synchronous machines. As synchronous generation retires and inverter-based resources expand, those capabilities can become scarce, locational and commercially explicit. Grid-forming inverters can provide valuable responses, yet capability varies by control, hardware, energy source, network condition and operating envelope. This paper develops the Grid-Forming Stability Value Framework.

It separates inertia-like response, phase-jump power, protection-quality fault current, voltage support, damping, system strength and restoration. It compares grid-forming batteries, wind, solar, network devices, VSC-HVDC and synchronous condensers, then connects technical qualification to procurement, pricing, contracts, finance and valuation.

NESO states that grid-forming equipment can create voltage and frequency and identifies active RoCoF response, phase-jump power and fast fault-current injection in its requirements [1]. NESO has used competitive stability tenders and is developing enduring Stability Markets [1]-[3]. AEMO is testing methods to quantify grid-forming system-strength support and has initiated procurement for a protection-quality fault-current trial [4]-[5].

DOE, NREL and UNIFI identify modelling, validation, interoperability and standards as continuing priorities [6]-[9]. These sources support staged qualification; they do not establish universal performance or project economics. The central conclusion is that stability should be purchased as measurable services under explicit operating conditions. Four tables and three figures translate the framework into an investment method.

Numerical examples are hypothetical management assumptions used solely to demonstrate the method; they are not observations, forecasts, valuation conclusions or investment recommendations.

JEL Classification: G31, G32, L51, L94, O32, Q40, Q48

Keywords: grid-forming inverter, system stability, inertia, system strength, fault current, battery storage, stability market, energy transition

This Matchpoint Insight presents the web edition of Matchpoint Partners' research. The supporting paper contains the full framework, structures, worked examples and source material.

Register Before Download   Explore our Alternatives practice

1. Define the investment decision

System operators, networks and asset owners must decide how much grid-forming capability is required, where it is needed and whether it should be mandated, procured or co-optimised with energy and storage. The decision should connect measurable system need to qualified technical performance and financeable revenue.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

2. Map the changing system

Retiring synchronous generation reduces rotating mass, fault current and voltage-source behaviour while inverter-based resources grow. Planning should identify the operating conditions and locations where stability constraints become binding.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

3. Separate stability services

Inertia-like response, phase-jump power, fault current, voltage control, damping, system strength, island operation and restoration are distinct capabilities. A single grid-forming label should not substitute for product-specific performance.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

4. Define the counterfactual

The counterfactual may use synchronous generation, synchronous condensers, network reinforcement, operational constraints or curtailment. Value should be measured against the least-cost secure alternative.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

5. Quantify inertia need

Frequency stability depends on credible loss, system inertia, primary response and load behaviour. Procurement should specify the response characteristic and operating envelope rather than an unsupported equivalent-inertia claim.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

Table 1. Stability-service evidence map

ServiceSystem needQualification evidenceCommercial unitPrincipal risk
Inertia-like responseLimit frequency change after disturbanceValidated RoCoF response across operating envelopeMW response characteristic and availabilityHeadroom and saturation
Phase-jump powerMaintain stability after angle disturbanceEMT model and site testQualified capability and availabilityControl interaction
Fault-current contributionOperate protection and support voltage recoverySequence, magnitude, duration and waveform testsEvent capability and availabilityCurrent limit and protection mismatch
Voltage and system strengthSupport weak-grid operationFrequency-domain and EMT studiesLocational capabilityNetwork change and model error
RestorationEnergise and sustain islandsBlack-start and load-pickup testAvailability and successful eventAuxiliary power and coordination

Exact requirements remain system-specific and require validated studies and tests.

6. Quantify RoCoF response

Active power response to rate of change of frequency can reduce frequency excursions. The model should capture measurement, delay, saturation, energy headroom and interactions with other controls.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

7. Quantify phase-jump response

A phase-angle disturbance can demand rapid active-power response. Capability should be demonstrated across credible network strength and operating conditions.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

8. Quantify fault-current contribution

Protection-quality current requires adequate magnitude, duration, sequence content and waveform properties. AEMO's current trial illustrates the need for evidence before this service is relied upon at scale.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

9. Quantify voltage support

Grid-forming controls can establish voltage and support weak-grid operation. Reactive current limits, transformer impedance, network strength and recovery after faults determine useful performance.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

10. Quantify oscillation damping

Controls can damp or amplify network and converter interactions. Small-signal and electromagnetic-transient studies should cover multiple vendors, operating points and credible contingencies.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

11. Define black-start capability

Restoration requires energisation, voltage build-up, load pickup, island control, synchronisation and resilience. Grid-forming capability is necessary for some designs but does not alone prove a complete restoration service.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

12. Compare synchronous condensers

Synchronous condensers provide physical inertia, fault current, reactive power and familiar protection behaviour. Their capex, losses, maintenance, construction time and locational value should be compared with inverter options.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

13. Compare grid-forming batteries

Batteries can combine grid-forming controls with active-power headroom and energy services. Duration, state of charge, degradation and energy-market opportunity cost affect stability availability.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

14. Compare grid-forming wind

Wind converters can provide grid-forming behaviour subject to turbine, converter and resource constraints. Commercial value depends on available power, control mode, headroom and warranty.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

15. Compare grid-forming solar

Solar and co-located storage can provide voltage-source behaviour when irradiance, headroom and DC-energy support are adequate. Night-time and low-resource operation require explicit design.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

16. Compare STATCOM and power-electronic devices

Converter-based network devices can provide rapid voltage and stability support. Active-power services require an energy source or stored energy beyond reactive capability.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

17. Compare VSC-HVDC capability

Voltage-source converters can support connected AC systems and restoration under defined configurations. Contracting should separate mandatory link performance from incremental system services.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

18. Build a hybrid portfolio

Synchronous condensers, grid-forming batteries, network devices and retained generation can cover different services and locations. Portfolio design should manage common-mode and vendor-control risk.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

19. Specify the operating envelope

Performance should be defined across power, reactive output, state of charge, voltage, frequency, system strength and temperature. A narrow test point can overstate dependable capability.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

20. Set minimum technical requirements

Connection requirements establish a baseline, while procured services may demand higher performance. Mandates and markets should avoid paying twice for the same obligation.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

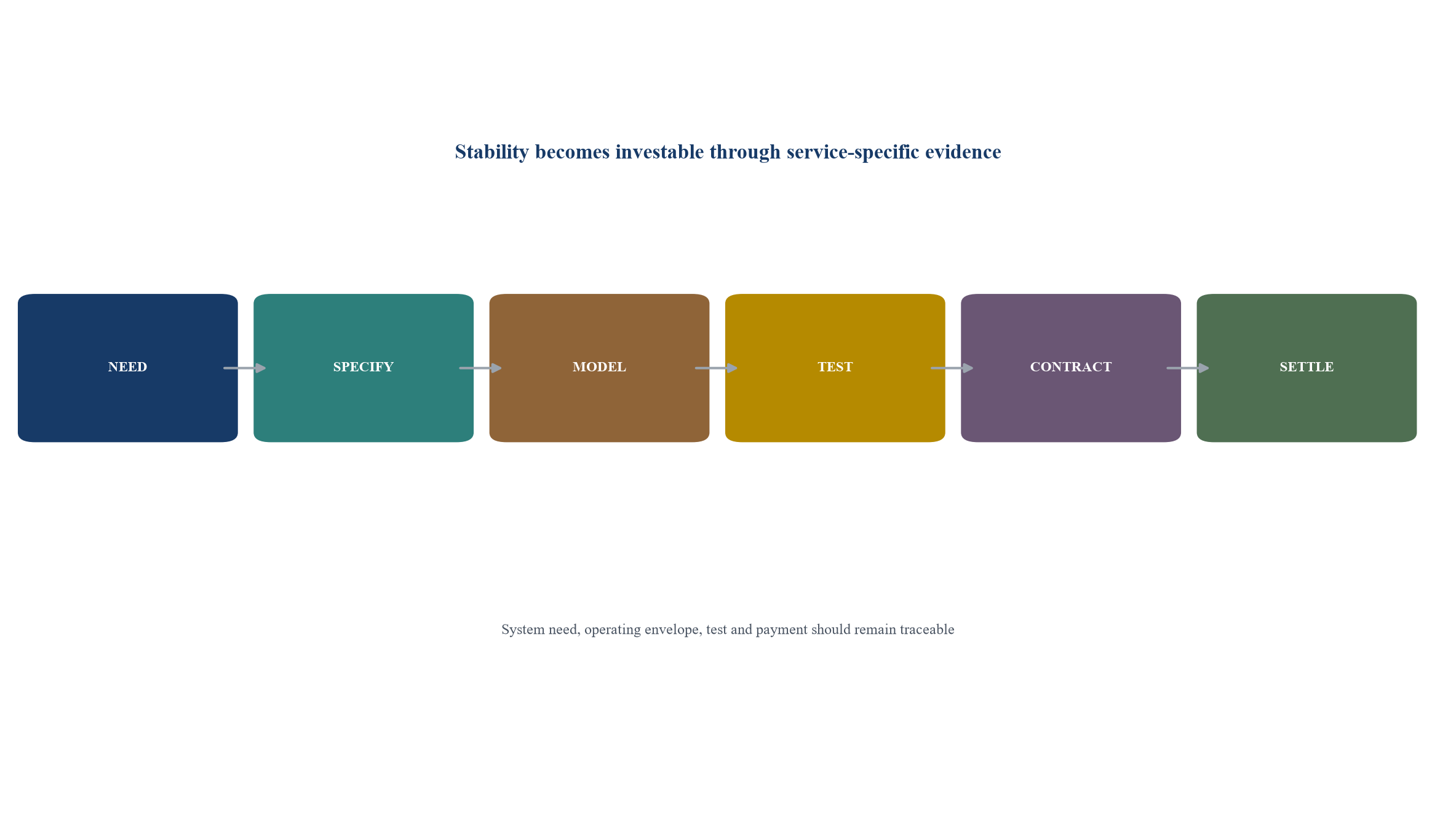

Figure 1. Grid-forming stability value chain
Figure 1. Grid-forming stability value chain

Commercial value requires evidence from system need through qualified settlement.

21. Design model validation

RMS, positive-sequence, frequency-domain and electromagnetic-transient models serve different questions. Validation should reconcile simulation, hardware tests, site commissioning and field events.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

22. Test interoperability

Multiple grid-forming and grid-following controls can interact. System studies should include vendor diversity, communication failure, protection, current limits and mode transitions.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

23. Redesign protection where needed

Lower or controlled fault current can challenge legacy relays. Protection changes, communications and fault-current products should be planned with the stability portfolio.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

24. Manage energy headroom

Active-power response requires upward or downward headroom and sufficient energy. Reservation reduces energy-market revenue and should be included in service cost.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

25. Model current saturation

Inverter current limits can force trade-offs between active and reactive response during faults. Control priorities should be specified and tested under credible disturbances.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

26. Define response duration

Sub-cycle response, seconds of inertia-like support and longer balancing energy address different system needs. Payment and testing should match the required duration.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

27. Value locational need

System strength and voltage stability are often local or regional. Procurement zones should follow electrical need and should be reviewed as the network changes.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

28. Build the stability requirement forecast

Forecasts should combine generation retirements, inverter connections, network outages, demand, interconnectors and operating patterns. Uncertainty supports staged procurement and periodic recalibration.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

29. Set the procurement product

The product should define capability, availability, location, tests, telemetry, dispatch, outages and penalties. Technology-neutral specifications improve competition where equivalence can be demonstrated.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

30. Use competitive tenders

Tenders can reveal cost and bring forward new assets when requirements and contract tenure are clear. Bid assessment should compare service portfolios, dependencies and total system cost.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

Table 2. Technology and commercial comparison

OptionStability capabilityEnergy sourceRevenue profileKey diligence
Synchronous condenserPhysical inertia, fault current and reactive supportGrid losses and auxiliariesLong-term availabilityLocation, losses and outage
Grid-forming batteryFast active and reactive responseStored energyAvailability plus stacked marketsState of charge, degradation and controls
Grid-forming wind or solarConverter response with resource constraintsRenewable resource and headroomEnergy plus incremental serviceWarranty, headroom and night operation
Power-electronic network deviceVoltage and control supportDC link or limited stored energyRegulated or contracted availabilityActive-power duration and interoperability
Hybrid portfolioComplementary physical and inverter servicesMultipleDiversified contracted and marketCoordination and common-mode risk

Ratings are qualitative and project-specific; detailed engineering remains necessary.

31. Use enduring markets

Regular markets can adapt volumes and prices as need changes. Participation rules, accreditation, clearing and performance monitoring require sufficient liquidity and standardisation.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

32. Use bilateral contracts selectively

Bilateral procurement can support first-of-a-kind or location-specific solutions. Price discovery and change control need governance where competition is limited.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

33. Choose availability payments

Grid-forming services may be delivered continuously when an asset is connected, as NESO notes for grid-forming batteries. Availability payment can align with this service when performance is independently verified.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

34. Define utilisation payments

Some services require instruction or measurable activation. Utilisation payment should avoid duplicating availability revenue and should reflect incremental energy, degradation and opportunity cost.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

35. Set performance deductions

Deductions should reflect unavailable capability, failed tests, outages and non-delivery. Caps and cure rights should preserve proportionality while protecting system security.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

36. Build the capex model

Capex includes converters, controls, storage, transformers, connection, protection, modelling, testing, cyber and owner cost. Incremental grid-forming cost should be separated from the host asset.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

37. Build the operating-cost model

Software, maintenance, testing, monitoring, insurance, warranties, energy losses and specialist support create lifecycle cost. Vendor licence and upgrade terms should remain visible.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

38. Measure avoided system cost

Benefits can include reduced must-run generation, fewer synchronous condensers, lower curtailment, faster connections, improved restoration and deferred reinforcement. Each benefit needs an attributable counterfactual.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

39. Co-optimise energy and stability

Energy, frequency, reserve, capacity and stability commitments share converter, current and energy limits. Dispatch and valuation should prevent double counting.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

40. Stack revenues with controls

Revenue stacking can improve financeability when service obligations are compatible. Contract priority, availability windows, dispatch rights and default consequences should be explicit.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

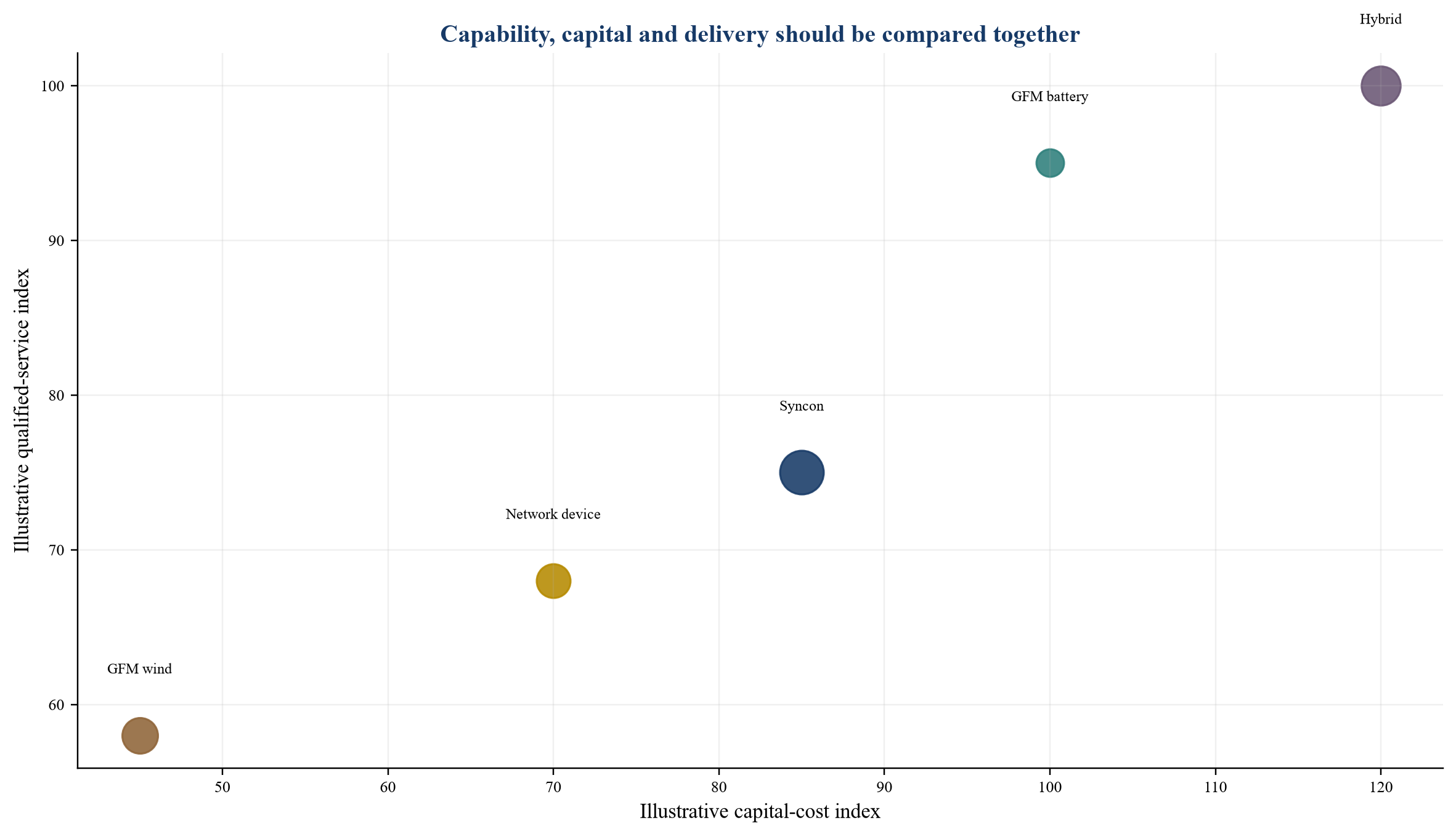

Figure 2. Hypothetical stability-portfolio comparison
Figure 2. Hypothetical stability-portfolio comparison

Values are hypothetical management assumptions used solely to demonstrate trade-offs.

41. Price opportunity cost

Providing headroom or maintaining state of charge may displace energy and ancillary-service earnings. Bids should include the foregone margin under expected and stressed conditions.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

42. Model battery degradation

Stability services can cause cycling, high-power events and calendar exposure. Degradation should be linked to duty cycle, warranty and augmentation rather than assumed negligible.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

43. Create revenue certainty

Long-term tenders can support financing while short markets adapt to need. A blended structure can combine contracted base revenue with merchant upside and periodic volume review.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

44. Set contract tenor

Tenor should reflect asset life, technology maturity, forecast confidence and financing need. Short contracts can underwrite little capex, while long contracts require reopeners and performance evolution.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

45. Allocate technology risk

The asset owner generally bears design and performance risk, while the system operator specifies need and tests. First-of-a-kind uncertainty may justify pilots, staged acceptance and shared learning.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

46. Manage vendor concentration

Proprietary controls, models and service tools can create dependency. Source-code escrow, model access, data rights, spare capability and transition support should be considered.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

47. Protect cybersecurity

Grid-forming controls and remote access are critical operational systems. Security design should cover identity, firmware, logging, incident response, recovery and supply-chain assurance.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

48. Align warranties and market obligations

OEM warranties may restrict control modes, current, cycling or field changes. Service contracts should not require operation that invalidates equipment support.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

49. Use Great Britain evidence

NESO has procured stability through competitive tenders and moved toward enduring Stability Markets. Its requirements distinguish connection-code obligations from higher commercial performance.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

50. Use Australian evidence

AEMO is developing methods to quantify grid-forming system-strength support and is procuring a fault-current trial. The evidence supports staged qualification and service-specific valuation.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

Table 3. Hypothetical revenue and debt sensitivity

CaseContracted availability revenueMerchant revenue shareQualified availabilityMinimum debt-service coverageDecision implication
Base contract70%30%96%1.55xFinanceable with tested performance
Accreditation delay45%30%80%1.08xNeeds equity and delayed draw
Lower merchant prices70%15%96%1.37xContracted base protects coverage
Higher opportunity cost70%30%90%1.24xReprice headroom commitment
Blended long and short contracts82%18%96%1.68xStronger coverage with reopeners

All values are hypothetical management assumptions and do not represent an actual asset, market or forecast.

51. Use US research evidence

DOE, NREL and the UNIFI consortium identify modelling, validation, standards, interoperability and commercialisation as central to deployment. Research maturity does not remove project-specific diligence.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

52. Address GCC conditions

Rapid renewable, battery and data-centre growth can create weak-grid and stability needs in specific areas. High temperature, network structure, operating practice and procurement rules should inform design.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

53. Value the asset

Valuation should separate host energy cash flow, contracted stability revenue, merchant upside, incremental capex, degradation, technology risk and terminal obligations.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

54. Structure debt

Debt sizing should rely on enforceable availability revenue, tested performance, warranty alignment and downside coverage. Merchant stability prices and unaccredited services should receive conservative credit.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

55. Structure equity

Equity absorbs development, accreditation, technology, merchant and residual-value risk. Return analysis should include opportunity cost and potential changes in mandatory requirements.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

56. Build the risk-allocation matrix

The matrix should assign specification, model, commissioning, availability, market, cyber, warranty and change-in-law risk to parties with control and balance-sheet capacity.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

57. Create the contract suite

Connection agreements, stability contracts, energy-market terms, OEM warranties, LTSA, finance documents and data licences should align. Conflicting dispatch and performance obligations require resolution before close.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

58. Create the lender-grade data room

The data room should contain system need, studies, models, tests, contracts, warranties, capex, operating plan, cyber controls and financial cases. Each assumption needs a source and owner.

The evidence package should reconcile system study, technical specification, validated model, site test, operating envelope and commercial obligation. Vendor claims and management estimates should remain distinguished from observed field performance.

A financeable service has measurable need, technology-neutral requirements, credible tests and predictable settlement. Procurement should preserve competition while recognising locational and first-of-a-kind constraints.

59. Run implementation governance

System planning, operations, markets, engineering, procurement, cyber, legal and finance require shared decisions. A controlled baseline should govern service definition, tests, costs and change.

The valuation should separate required connection capability from incremental procured service. Dependable quantity, availability, location, energy headroom, opportunity cost and technology risk should be measured under common scenarios.

The board and system operator should see low-inertia, weak-grid, non-delivery, vendor-failure and market-reform cases. The preferred portfolio should remain secure and economically defensible across credible conditions.

60. Adopt the scorecard and 90-day plan

The final record should state need, services, portfolio, procurement, economics, finance, risks and readiness gates. The first 90 days should close evidence gaps that could change investment.

The financing model should connect qualified performance to enforceable revenue and downside coverage. Accreditation, warranty, cyber, degradation and change-in-requirement risks should have accountable owners and contractual controls.

Implementation should translate the framework into planning, modelling, procurement, accreditation, operations and finance workstreams. Capital commitment should follow readiness gates and field evidence.

Table 4. Illustrative 90-day stability-investment programme

PeriodWorkstreamCore actionsDecision outputAccountable owner
Days 1-15Need and servicesConfirm system conditions, locations and product definitionsApproved need statementSystem planner
Days 16-30Models and optionsValidate models, operating envelopes and technology portfolioFeasible option setStability engineer
Days 31-45Tests and accreditationDefine factory, site and field evidenceQualification planSystem operator
Days 46-60Economics and marketsModel capex, opportunity cost, degradation and revenueRisk-adjusted value modelCommercial lead
Days 61-75Contracts and financeAlign service, warranty, security, covenants and downsideFinanceable term sheetCorporate-finance adviser
Days 76-90Approval and governanceClose risks, owners, KPIs and implementation gatesAuthorised investment planBoard and system operator

Timing is indicative and should be adapted to system and transaction governance.

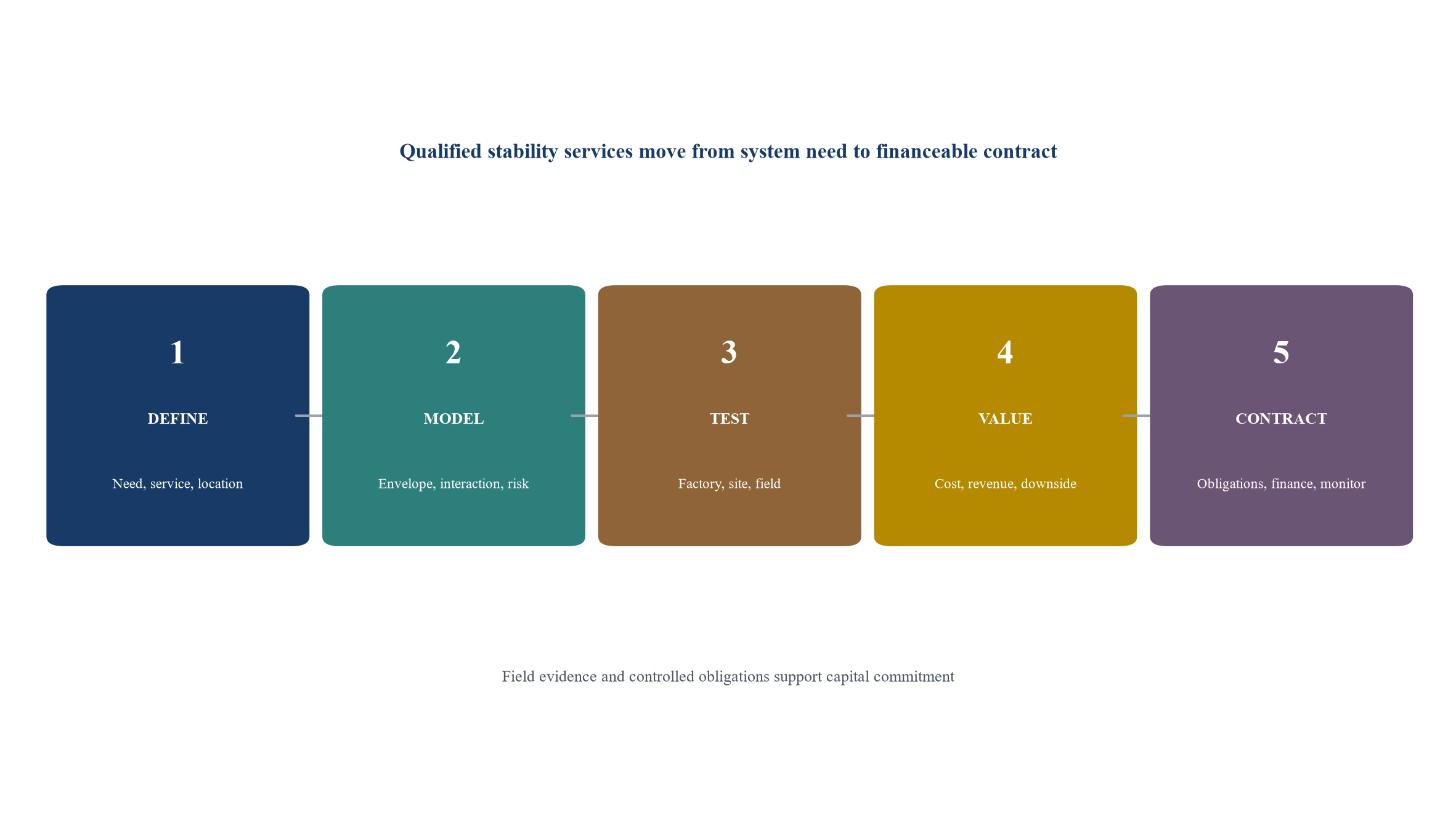

Figure 3. Five gates for grid-forming stability investment
Figure 3. Five gates for grid-forming stability investment

Each gate requires documented evidence before the next capital commitment.

The framework converts an emerging control capability into measurable stability products and financeable obligations. It preserves traceability from system need through field evidence to revenue and downside protection.

Investment should proceed through staged qualification. Market design, warranties, cyber controls and operating experience should evolve with the technical evidence.

References

  1. National Energy System Operator, "Why is Grid Forming Important?" 9 June 2026, https://www.neso.energy/news/why-grid-forming-important
  2. National Energy System Operator, "Stability Pathfinder Service Information," https://www.neso.energy/data-portal/stability-pathfinder-service-information
  3. National Energy System Operator, "GC0137: Minimum Specification Required for Provision of GB Grid Forming Capability," https://www.neso.energy/industry-information/codes/gc/modifications/gc0137-minimum-specification-required-provision-gb-grid-forming-gbgf-capability-formerly-virtual-synchronous-machinevsm-capability
  4. Australian Energy Market Operator, "Engineering Roadmap Execution Reports," https://www.aemo.com.au/initiatives/major-programs/engineering-roadmap/engineering-roadmap-execution-reports
  5. Australian Energy Market Operator, "Grid-Forming Inverter Protection-Quality Fault Current Trial," https://www.aemo.com.au/energy-systems/electricity/national-electricity-market-nem/nem-forecasting-and-planning/transition-planning/transitional-services---type-2-services/grid-forming-inverter-protection-quality-fault-current-trial
  6. US Department of Energy, "Powering On with Grid-Forming Inverters," 4 January 2021, https://www.energy.gov/cmei/systems/articles/powering-grid-forming-inverters
  7. National Renewable Energy Laboratory, "Research Roadmap on Grid-Forming Inverters," https://www.nrel.gov/docs/fy21osti/79761.pdf
  8. US Department of Energy, "UNIFI Consortium," https://www.energy.gov/cmei/systems/unifi-consortium
  9. National Renewable Energy Laboratory, "Planning for Reliable Operations," https://www.nrel.gov/grid/planning-for-reliable-operations.html
  10. National Energy System Operator, "MinGFM," https://www.neso.energy/about/innovation/our-innovation-projects/mingfm

About the Author

Chennakeshav (CK) is a corporate finance and investment banking executive with 25+ years of global experience in deal origination, structuring and execution across M&A, growth capital and corporate strategy. He has led value-creation mandates for founders, corporates and funds — bridging the boardroom view to hands-on execution and close.

His career spans Morgan Stanley, HSBC, Lloyds Banking Group, EWEC, ADQ portfolio companies and Emirates Growth Fund, across TMT, real estate, fintech, deeptech, cleantech, infrastructure and energy. He has partnered with C-suite leaders, private equity and venture funds, sovereign wealth funds and family offices to finance complex fund raises and scale-up ventures, and has led M&A due diligence, post-merger integration and business-transformation initiatives to create value.

At Matchpoint Partners he is Managing Partner, leading the firm's corporate finance, M&A and capital-raising practice. He holds an MBA from London Business School, an engineering degree from VTU and a Master of Laws (LLM, in progress) from UCL London.

An active start-up mentor, CK mentors at Techstars, DIFC FinTech Hive, Startup Grind, Founder Institute and IN5, serves as Entrepreneur Mentor in Residence (EMiR) at London Business School, and judges the Entrepreneurship World Cup.

https://www.linkedin.com/in/ckadya/

https://www.matchpoint-partners.com/team/ck-adya.html

Questions, answered

Stability Has a Price: frequently asked questions

It controls an inverter-based resource as a voltage source capable of establishing voltage and frequency behaviour.

Potential services include inertia-like response, phase-jump power, fault-current contribution, voltage support, damping, system strength and restoration.

They provide overlapping capabilities, while physical inertia, fault current, energy limits, losses and location can favour different portfolios.

Payment can combine availability, utilisation and performance components aligned with measurable service, headroom, degradation and opportunity cost.

Lenders need validated models, accreditation, field tests, contracts, warranty alignment, downside coverage and enforceable payment terms.

System strength, voltage and fault performance depend on network conditions, so value varies by zone.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
