Energy Transition · Long-Duration and Alternative Storage

Store Summer for Winter: Pricing Hydrogen's Losses against Supply Security

An investment, contracting and financing framework for seasonal hydrogen storage and hydrogen-to-power, from geology and energy losses to capacity value and cross-chain completion.

Store Summer for Winter: Pricing Hydrogen's Losses against Supply Security
Quick answer

Price hydrogen's conversion losses against seasonal duration, dependable capacity, strategic inventory and security of supply.

Abstract

Background. Hydrogen can move renewable energy from periods of surplus into periods of scarcity, yet conversion, compression, storage, withdrawal and reconversion consume energy and capital. A power-to-hydrogen-to-power chain may therefore appear unattractive when judged only by round-trip efficiency.

Objective. This paper develops an investment framework that prices those losses against the services a seasonal hydrogen system can provide: firm fuel, long-duration capacity, strategic reserve, curtailment capture, network flexibility and protection against fuel disruption.

Method. It reviews evidence from the International Energy Agency, the United States Department of Energy, the National Renewable Energy Laboratory, the United Kingdom Department for Energy Security and Net Zero, the National Energy System Operator and technical literature. It then applies a common energy boundary, an evidence matrix and three explicitly hypothetical commercial cases.

Findings. Hydrogen storage is most credible where geology, renewable supply, transport, withdrawal rate and dependable demand form one integrated system. Low round-trip efficiency remains economically important. It should be assessed alongside duration, deliverability, capacity accreditation, fuel optionality and the cost of the alternative security resource. Direct hydrogen use can avoid the reconversion loss, while hydrogen-to-power requires payment for readiness and dependable output as well as electricity sold.

Implications. Sponsors should contract the complete chain, meter losses at agreed boundaries, separate inventory from capacity, price cushion gas and working capital, stage capital through subsurface and operating evidence, and size debt to contracted downside cash flow rather than headline energy capacity.

JEL Classification: G31, G32, L94, O32, Q40, Q42, Q48

Keywords: seasonal hydrogen storage, hydrogen to power, salt cavern, security of supply, long-duration storage, project finance, capacity value, energy resilience

This Matchpoint Insight presents the web edition of Matchpoint Partners' research. The supporting paper contains the full framework, structures, worked examples and source material.

Register Before Download   Explore our Strategy & Execution practice

1. Seasonal storage is an insurance question as well as an efficiency question

Electricity systems with large shares of wind and solar can experience surplus generation in one period and scarcity in another. Batteries can shift energy across hours. Reservoirs, demand response, interconnection and dispatchable generation can cover other intervals. Hydrogen becomes relevant when the required duration, fuel inventory or strategic reserve extends beyond the economic duty of shorter-duration assets.

The first investment question is not whether hydrogen is efficient in isolation. It is whether a defined hydrogen chain delivers a needed service at lower risk-adjusted cost than the available alternatives. The comparison should include energy losses, capital, fixed operating cost, fuel inventory, network cost, carbon performance, response time, reliability and the value of dependable supply during stressed periods.

Security value is real only when the asset can deliver. Storage volume without withdrawal capacity, hydrogen production without transport, or a turbine without firm fuel is incomplete. The financed asset is the connected chain.

2. The complete chain defines the economic boundary

A seasonal hydrogen system can include renewable generation, grid import, electrolysis, water treatment, drying, compression, pipelines, geological storage, withdrawal, purification, metering, direct industrial use and power generation. Each component has its own capacity, availability, loss and contractual boundary.

An energy balance should begin at the electricity meter feeding the electrolyser and end at the final sale meter. For hydrogen-to-power, that final meter is net electricity exported after turbine or fuel-cell auxiliaries. For direct use, the final meter may be kilograms or megawatt-hours of hydrogen delivered at specified pressure and purity.

Changing the boundary changes the apparent efficiency. An electrolyser efficiency does not represent the full chain. A turbine heat rate does not capture electrolysis and storage. Investment committees should require one reconciled model and prohibit selective component metrics.

3. Round-trip efficiency captures losses and omits duration value

Round-trip efficiency divides net electrical energy returned by net electrical energy consumed. The United States Department of Energy's 2023 bidirectional hydrogen-storage assessment used a 31 per cent base round-trip efficiency for a system with stated electrolyser and fuel-cell assumptions. That public benchmark illustrates the magnitude of conversion losses; it is not a project guarantee.

The metric is useful because lost energy must be purchased or produced. It is incomplete for an asset held for rare, prolonged scarcity. A reserve plant may operate for few hours while preserving system adequacy throughout the year. Its value comes from readiness and dependable capacity, not high annual energy throughput.

The correct comparison therefore pairs round-trip efficiency with duration, annual cycles, dependable megawatts, response, storage losses, outage correlation and the avoided cost of the marginal security resource.

4. Direct hydrogen use changes the conversion logic

Hydrogen sold to industry, refining, chemicals, heavy transport or another fuel user avoids conversion back to electricity. The energy chain still includes electrolysis, conditioning, compression, transport and storage, but it does not incur turbine or fuel-cell reconversion losses.

This distinction can materially change project economics. A store supporting both industrial demand and power-system reserve may earn from regular hydrogen throughput while preserving an inventory tranche for scarcity. The two services need separate rights, nomination rules and inventory accounting.

Direct-use demand also creates quality constraints. Pressure, purity, moisture, contaminants, temperature and delivery profile must meet the customer's process. A store that preserves energy quantity while allowing unacceptable contamination does not satisfy the commercial duty.

5. Electrolysis converts electricity into a storable molecule

Electrolysers split water into hydrogen and oxygen. Their output depends on electrical input, stack efficiency, loading, temperature, water quality, compression boundary and degradation. Flexible operation can absorb renewable surplus, but frequent starts, low-load periods and variable power may influence performance and maintenance.

The financial model should use net alternating-current electricity at the project boundary and saleable hydrogen after agreed treatment. Stack replacement, auxiliary systems and availability belong in operating cost. A quoted stack efficiency without balance-of-plant loads can overstate delivered output.

Renewable procurement also matters. A project relying on curtailed or negative-price power should test how often that energy is available at its grid node, whether the electrolyser can secure it, and whether network charges or connection constraints change the price.

6. Compression, drying and transport are material energy users

Hydrogen leaving an electrolyser may require drying, purification and compression before transport or injection. The work depends on inlet and delivery pressure, compressor stages, cooling, flow profile and equipment efficiency. Pipelines add linepack and pressure-management requirements.

These loads should appear explicitly in the energy balance. Treating them as a generic percentage can conceal a design that operates far from its efficient range. Compression equipment may also define the rate at which surplus electricity can be converted into stored inventory.

Transport utilisation influences unit cost. A large pipeline sized for future demand can be strategically valuable while operating at low initial throughput. The contract and financing structure must allocate ramp-up risk rather than assuming mature utilisation from the first year.

7. Geological storage separates inventory from deliverability

Underground capacity is commonly described in energy or mass terms. Commercial performance also depends on injectivity, withdrawal rate, pressure range, working gas, cushion gas, cycling, well configuration and surface equipment. Two stores with equal inventory can provide different dependable power.

Salt caverns can offer high deliverability and repeated cycling where suitable geology exists. Porous reservoirs such as depleted fields and aquifers may offer large volume and broader geographic potential while requiring evidence on containment, microbial activity, geochemical reactions, gas quality and recovery.

Storage value should therefore be decomposed into working inventory, injection capacity, withdrawal capacity, availability and required pressure. A single currency-per-kilowatt-hour metric does not capture the complete service.

8. Salt caverns provide a strong reference class with site-specific limits

Hydrogen has been stored in salt caverns for industrial use for decades in selected locations. Caverns are created through solution mining and operated within geomechanical pressure limits. Salt can provide low permeability and self-healing characteristics, subject to site conditions and design.

The development case depends on salt thickness, depth, purity, cavern spacing, leaching water, brine disposal, wells, subsidence, permitting and connection to production and demand. Existing industrial experience supports the storage principle. It does not remove project-specific construction and cycling risk.

The National Energy System Operator's 2025 pathways note existing hydrogen salt-cavern storage in Teesside and identify large-scale hydrogen storage as important for seasonal power use and security of supply. Those system pathways remain scenarios rather than project revenue contracts.

9. Porous reservoirs increase capacity and subsurface uncertainty

Depleted gas fields and aquifers can offer substantial pore volume. Their hydrogen performance depends on caprock integrity, residual fluids, mineral reactions, microbial consumption, mixing, pressure response and recovery. Existing wells and data can reduce selected uncertainties while introducing legacy integrity issues.

Pilot injection and withdrawal should measure gas composition, losses, pressure, plume behaviour and well performance across representative cycles. Models should be calibrated to observed data before full capacity is recognised in valuation.

Cushion gas can be a large initial inventory and working-capital requirement. The model should state whether cushion gas is recoverable, who owns it, how it is financed and what happens at decommissioning.

10. Above-ground storage serves different duties

Pressurised tanks, tube trailers, liquid hydrogen systems and chemical carriers can store hydrogen without suitable local geology. They generally face different scale, cost, energy and safety characteristics from underground storage.

Surface systems may suit buffering, mobility, distributed demand or early market development. Liquefaction and carrier conversion can facilitate transport while imposing additional energy use and reconversion requirements. The International Energy Agency notes material energy use for certain hydrogen shipping chains.

A seasonal power-system proposal should not assume that every hydrogen storage technology scales economically to months of inventory. The chosen medium should match volume, duration, location, purity and withdrawal duty.

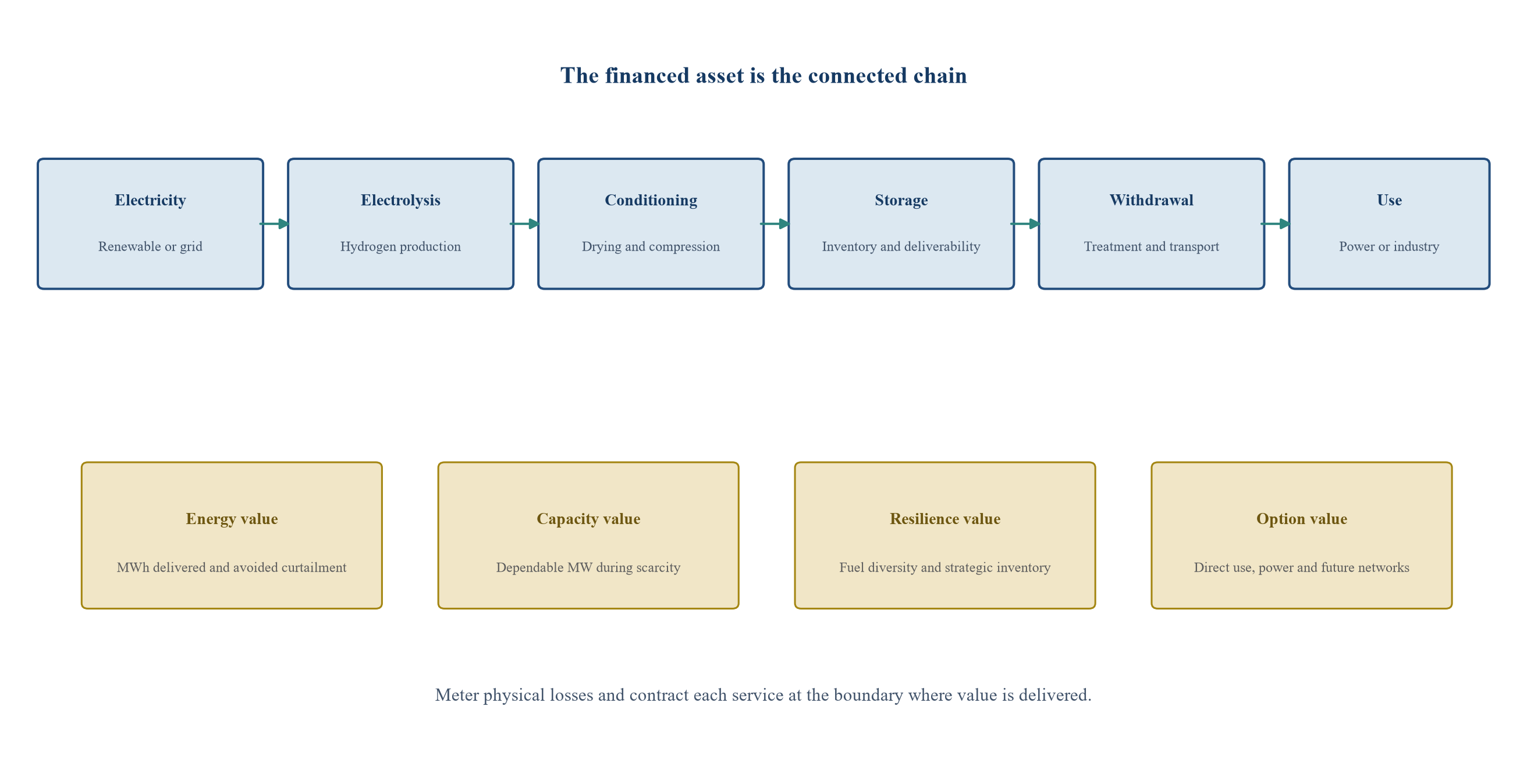

Figure 1. Seasonal hydrogen energy and value boundaries
Figure 1. Seasonal hydrogen energy and value boundaries

The diagram identifies physical and commercial boundaries. Actual equipment, losses, ownership and metering remain project-specific.

11. Seasonal duty creates low utilisation by design

A store intended for winter scarcity may complete one major annual cycle or remain unused in mild years. Low throughput raises the capital cost allocated to each unit of discharged energy. It can still be rational when the asset provides dependable capacity or avoids an expensive disruption.

The financial model should separate fixed readiness revenue from variable energy revenue. Fixed revenue supports staff, maintenance, inspections, debt service and return on capital. Variable revenue covers hydrogen consumed, incremental wear and dispatch costs.

An energy-only model is vulnerable when scarcity events are rare. A capacity-only model is vulnerable when performance obligations are weak. The commercial structure should pay for measurable readiness and penalise unavailable delivery.

12. Security of supply must be translated into a service specification

Security cannot remain a broad policy aspiration. A contract should define the event, notice, minimum output, duration, ramp, inventory, recovery time, permitted outages, testing and consequences of non-performance.

For hydrogen-to-power, dependable capacity is constrained by turbine availability, firm hydrogen, withdrawal rate, pipeline capacity and electricity connection. Accreditation should consider common-mode risks such as one compressor station or one pipeline serving multiple plants.

The alternative resource establishes the economic benchmark. It may be additional interconnection, demand response, gas generation with carbon constraints, bioenergy, nuclear, batteries, other long-duration storage or controlled load. Each alternative has a different risk and delivery profile.

13. Curtailment capture depends on chronology and location

Hydrogen is often proposed as a sink for surplus renewable electricity. Annual curtailment totals do not prove that a particular electrolyser can access that energy. Time, node, connection, network rules and competing flexible demand determine availability.

The model should use chronological hourly or sub-hourly data where possible. It should identify the price and volume the project can secure after network charges, losses and operational constraints. Future renewable build and transmission expansion can increase or reduce local surplus.

Electrolyser utilisation is a trade-off. Running only during the cheapest hours lowers electricity cost and spreads fixed capital over fewer kilograms. Running more often raises utilisation and may consume higher-priced electricity.

14. Hydrogen inventory creates working-capital exposure

Seasonal storage requires hydrogen to be produced and paid for before it is sold. Inventory may remain underground for months. Its funding cost, losses, insurance, ownership and valuation method influence project cash flow.

The project should distinguish working gas from cushion gas and strategic reserve. Inventory pledged to one customer cannot simultaneously support another obligation unless nomination and replenishment rules permit it. Title transfer at injection, in store or at withdrawal creates different credit exposure.

Lenders will examine whether inventory can be sold after counterparty default, whether access rights survive enforcement and whether quality remains within specification. A volumetric asset without marketable title may provide limited collateral value.

15. Carbon intensity follows the whole chain

Hydrogen's climate value depends on production pathway, electricity source, methane emissions where applicable, carbon capture performance, compression, transport, storage leakage and end use. A low-emissions label should map to the relevant regulation and contract.

For electrolysis, temporal and geographic electricity matching can influence attributed emissions. For hydrogen from fossil fuel with carbon capture, upstream methane and residual process emissions matter. Hydrogen leakage also warrants monitoring because it can affect atmospheric chemistry.

Contracts should preserve measurement data and allocate the risk of methodology change. A project may remain physically operational while losing a premium, subsidy or eligibility status if its emissions evidence fails.

16. Water and brine are development constraints

Electrolysis needs treated water. Salt-cavern construction requires water for leaching and creates brine that must be used or disposed of lawfully. Water availability, abstraction rights, treatment, discharge and local acceptance belong in the core development plan.

The quantity and timing should be reconciled with drought conditions and competing users. Desalination can add energy, capital and discharge considerations. Municipal or industrial sources may require long-term agreements and quality management.

Brine disposal can control cavern schedule. A cavern without a permitted brine route is not construction-ready. The owner should avoid valuing theoretical geological capacity before this constraint is resolved.

17. Development lead time can be longer than the power asset

Geological characterisation, wells, cavern leaching, pipelines, environmental approvals and market-support contracts can take years. A turbine or electrolyser procurement schedule may be shorter than the enabling infrastructure on which it depends.

The integrated critical path should cover subsurface studies, land, permits, water, brine, electricity, transport, storage and offtake. Independent schedules for each asset can conceal a system completion gap.

Early expenditure should purchase information and rights. Large irreversible capital should wait until decisive constraints have been reduced or contractually protected.

18. Technology readiness is chain-specific

Individual components may be commercially available while the integrated duty remains first of a kind. Electrolysers, compressors, wells, caverns, pipelines and turbines each have reference projects. Their combination at a new scale, pressure, fuel specification or operating profile can create integration risk.

Readiness evidence should record scale, operating hours, cycles, ramp, impurities, outages, maintenance and measurement boundary. A natural-gas turbine converted to hydrogen blend is not equivalent to a plant guaranteed for the proposed hydrogen concentration and duty.

Capital gates should follow integrated evidence. A pilot can establish injection and withdrawal behaviour. A demonstration can prove fuel and turbine performance. Commercial completion should prove the full contracted sequence.

19. Public project pipelines contain limited committed capacity

The International Energy Agency's 2026 infrastructure assessment reports a substantial announced underground-storage pipeline and a much smaller share at final investment decision or under construction. This gap is relevant to investors because announcements do not demonstrate financing, permits or completion.

Pipeline data can identify geography, scale and policy direction. It should not be treated as delivered supply. The project model should use only capacity supported by rights, engineering, approvals, contracts and credible funding.

Supply-chain demand should also be based on committed timing. A broad future pipeline can justify strategic positioning while leaving near-term utilisation uncertain.

20. Policy is beginning to contract the missing services

The United Kingdom has developed separate policy mechanisms for hydrogen production, transport, storage and hydrogen-to-power. The storage model work recognises that large infrastructure may need revenue support and coordinated allocation. The hydrogen-to-power response confirms an intention to use a business-model intervention adapted from dispatchable-power arrangements.

These initiatives illustrate the cross-chain problem. A store depends on producers and users. Producers depend on transport and demand. Power plants depend on firm fuel. Coordinated support can reduce circular dependency.

Policy design remains jurisdiction-specific and can change. An investment case should identify enacted rules, awarded contracts and remaining decisions rather than treating a policy intention as bankable revenue.

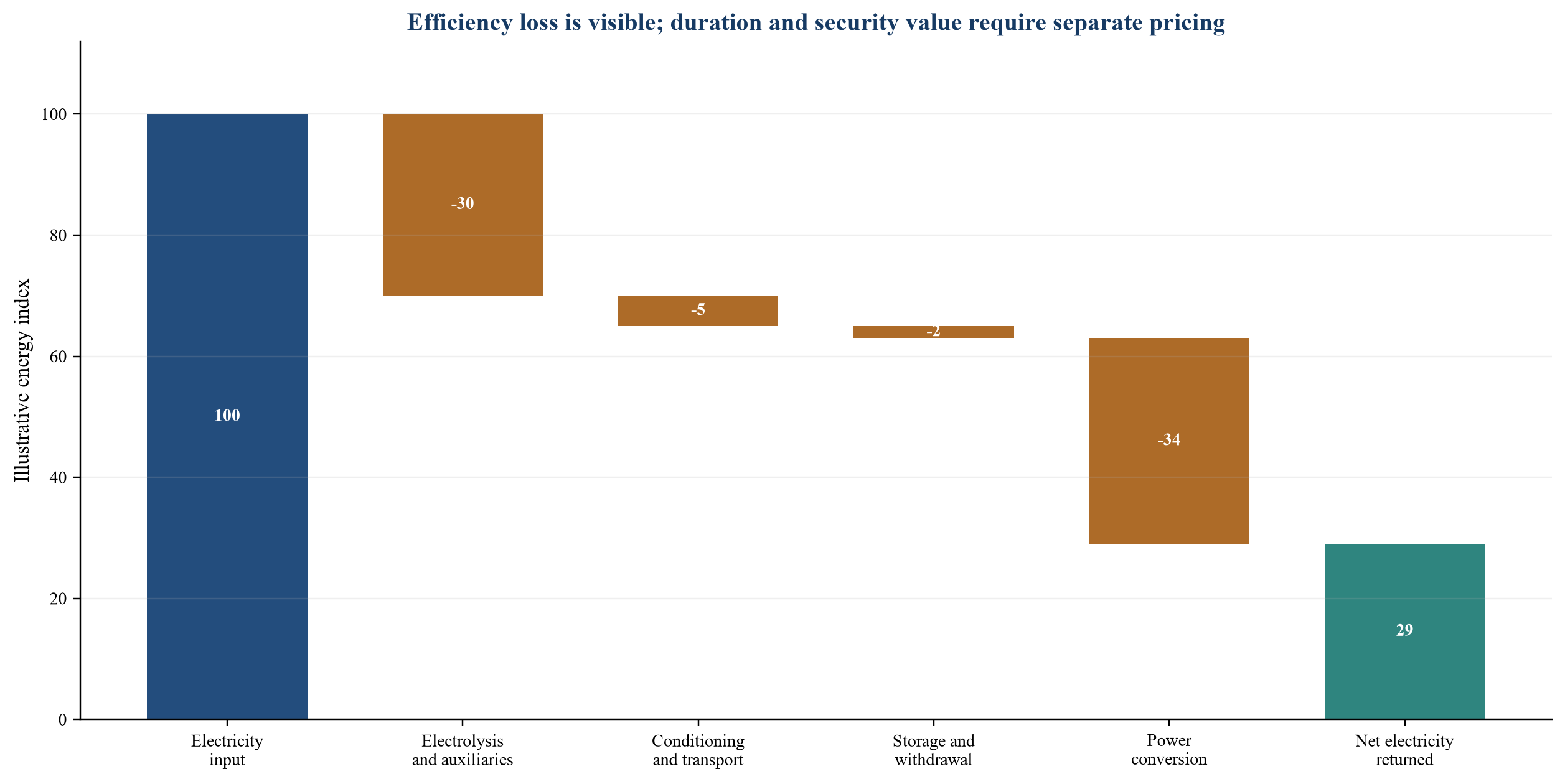

Figure 2. Illustrative energy-loss waterfall for hydrogen-to-power
Figure 2. Illustrative energy-loss waterfall for hydrogen-to-power

Values are hypothetical percentages of initial electrical input. They are not observed performance, a forecast or a project guarantee.

21. A common evidence matrix improves technology comparison

Storage concepts should be compared through geology, scale, deliverability, loss, operating evidence, development period, environmental boundary, quality risk and commercial duty. No single category wins every dimension.

Table 1. Evidence matrix for seasonal hydrogen storage archetypes

ArchetypePrincipal advantageDecisive evidenceMaterial riskMost credible duty
Salt cavernLarge working volume and potentially high deliverabilityCore data, cavern design, leaching plan, well integrity and cycling testsLocation, brine disposal, development schedule and cavern integritySeasonal inventory, repeated balancing and firm fuel
Depleted fieldPotentially very large pore volume and existing subsurface dataContainment, microbial and geochemical tests, recovery and calibrated reservoir modelHydrogen loss, contamination, cushion gas and legacy wellsLarge strategic inventory with proven withdrawal
AquiferBroad theoretical resource in suitable structuresSeismic, wells, caprock, pressure, water chemistry and pilot cyclesLimited operating evidence, recovery and permittingFuture large-volume storage after demonstration
Pressurised surface tanksModular deployment and controlled equipment boundaryCertified vessels, cycle life, compression duty and safety caseHigh unit cost at seasonal scale and land footprintBuffering, distributed demand and early markets
Liquid hydrogenHigh volumetric density relative to compressed gasLiquefaction performance, boil-off, materials and handlingLarge energy penalty, boil-off and specialised infrastructureTransport or high-value applications with limited alternatives
Chemical carrierUse of carrier-specific transport and storage systemsConversion yield, reconversion, purity and terminal compatibilityAdditional conversion loss and carrier-management riskTrade and transport where carrier infrastructure is valuable

The matrix is a diligence framework. Project evidence, regulation and commercial performance remain location-specific.

22. Scenario analysis should preserve physical causality

Hydrogen economics are sensitive to electricity price, utilisation, efficiency, storage duration, capital cost, financing and sale value. A scenario should change related assumptions coherently. Cheap curtailed power may occur for limited hours, reducing electrolyser utilisation. High scarcity prices may occur infrequently and carry volume uncertainty.

Chronological dispatch should respect production, injection, inventory, withdrawal, turbine and network limits. An annual average can permit hydrogen to be used before it is produced or hide prolonged low-renewable periods.

The model should show mass and energy balances in every period. Reconciliation errors can create more apparent value than the commercial strategy.

23. Three hypothetical cases reveal different value drivers

The following cases are illustrative and do not describe an identified project. They demonstrate how duty changes the investment case.

Table 2. Hypothetical seasonal-hydrogen commercial cases

AttributeCase A: industrial seasonal supplyCase B: hydrogen-to-power reserveCase C: integrated multi-user hub
Electrolyser capacity100 MW500 MW1,000 MW
Storage working inventory150 GWh hydrogen energy1,500 GWh hydrogen energy4,000 GWh hydrogen energy
Principal storageSalt cavernSalt cavernsCaverns or proven porous storage
Final serviceFirm industrial hydrogen300 MW dispatchable power for prolonged scarcityIndustrial supply, balancing and 600 MW power reserve
Illustrative full-chain electrical round-trip efficiencyNot applicable to direct use30%32% for power tranche; direct-use tranche avoids reconversion
Illustrative major cycles2 per year0.5 per year1.5 blended cycles per year
Principal revenueTake-or-pay hydrogen and availabilityReadiness, capacity and dispatched energyStorage capacity, throughput, reserve and optionality
Dominant riskCustomer credit and specificationLow utilisation and cross-chain availabilityInterface, allocation and governance complexity
Financing postureProject finance possible after firm offtake and completionContracted availability revenue needed for leverageRing-fenced assets and coordinated contracts

Every quantity is a modelling assumption for framework illustration. The cases are not forecasts, observed projects or investment recommendations.

24. Case A values firm molecules rather than returned electricity

The industrial case produces hydrogen during lower-cost periods and delivers against a customer profile. Its economics depend on avoided alternative fuel, process value, carbon eligibility, take-or-pay commitment and storage service.

The customer may value continuity more than spot hydrogen price. A production outage or electricity constraint can be covered from inventory. The contract should define minimum stock, delivery pressure, purity, nomination and replenishment.

Direct use avoids power reconversion, but it does not remove production and storage losses. Debt capacity depends on the customer's credit, termination payment, replacement market and the project's ability to meet specification.

25. Case B needs a readiness contract

The power-reserve case may dispatch rarely and consume large hydrogen volumes during prolonged scarcity. Energy sales alone are unlikely to recover fixed cost under the illustrative duty. A capacity, availability or dispatchable-power contract therefore becomes central.

The contract should pay for dependable output and define fuel-stock obligations. Performance testing should prove start, ramp, sustained output, emissions, minimum load, cycling and recovery. The storage and pipeline must be tested with the plant rather than separately.

Fuel price indexation and dispatch economics require careful design. The operator should not profit from withholding inventory, and it should not face unlimited exposure to a fuel price it cannot control.

26. Case C creates a portfolio and allocation problem

An integrated hub can serve industrial users, balance producers and retain a reserve tranche for power. Diversified demand can improve utilisation and reduce dependence on one customer. It also creates competing claims on inventory and withdrawal capacity.

Operating rules should allocate capacity during normal and emergency periods. Priority rights, interruptibility, imbalance charges and replenishment determine how value and risk are shared. A central system operator or storage operator may be needed.

Financing can ring-fence components while preserving interface obligations. Cross-defaults and step-in rights should avoid a failure in one user contract collapsing the whole system unnecessarily.

27. Revenue stacking requires compatible obligations

Potential revenue includes hydrogen sales, storage-capacity fees, injection and withdrawal charges, capacity payments, availability revenue, ancillary services, electricity sales and strategic-reserve payments. Each stream can improve utilisation or risk allocation.

The obligations may conflict. An industrial customer may need firm withdrawal when the power system also calls the turbine. Ancillary dispatch may consume inventory needed for a seasonal event. A capacity contract may restrict merchant use.

The model should simulate simultaneous calls and identify the governing priority. Revenue should be counted only when the same physical capacity can satisfy all obligations.

28. Capacity accreditation should follow the weakest link

Dependable megawatts should reflect the probability that electricity generation, hydrogen inventory, withdrawal, transport, treatment, turbine and grid connection are available together. Independent availability assumptions can overstate system reliability when components share power, controls or location.

Stress tests should cover renewable drought, cold weather, compressor failure, well outage, pipeline restriction and delayed replenishment. Maintenance schedules should avoid concentrating outages before the target season.

Accreditation rules may apply derating or testing requirements. Investors should use the applicable market methodology and maintain a separate engineering view of common-mode risk.

29. The alternative benchmark should include carbon and resilience

Comparing hydrogen only with spot electricity misses the resource it is intended to replace. The relevant benchmark might be a gas peaker plus fuel storage, an interconnector backed by foreign capacity, batteries with replacement, demand curtailment, or overbuilding renewable generation and networks.

The comparison should include carbon cost, fuel-price exposure, import concentration, start time, duration, outage correlation, development risk and residual value. Security of supply can justify a premium when alternatives share the same disruption risk.

The premium should remain explicit. Labelling it as strategic does not establish its amount. A regulator, government or customer must decide how much dependable service is worth and who pays.

30. A security premium can be structured as an availability payment

An availability payment can compensate fixed cost in return for tested readiness. The payment may be reduced for outages, inventory shortfall or failed tests. Dispatch payments can cover fuel and variable operating cost.

A cap-and-floor structure can support a network-like store where revenues are uncertain and users develop over time. A regulated-asset approach can suit monopoly infrastructure. A contract for difference can support production price while leaving storage and capacity risks elsewhere.

Each mechanism allocates volume, price and utilisation differently. The selected form should match the risk the investor cannot control and preserve incentives for efficient construction and operation.

31. Contract duration should reflect asset and market maturity

Underground storage and pipelines can have long physical lives. Early users may contract for shorter periods because their own hydrogen demand is developing. This mismatch creates re-contracting and residual-value risk.

Support duration should allow recovery of efficient investment while retaining performance incentives. Termination compensation should distinguish default, policy change and convenience. Refinancing provisions should preserve public value where support is publicly funded.

Residual value should be supported by transferable rights, remaining technical life and a credible market after the initial contract. A long-lived cavern with no connected users has limited commercial value.

32. Cross-chain interfaces require coordinated completion

The production plant, storage, pipeline and end user may be owned by different entities. Each asset can be mechanically complete while the chain remains unavailable. Delay in one component can strand capital in the others.

Interface agreements should align definitions, testing, pressure, purity, nominations, planned outages, relief events and liability. A coordinated long-stop date and cross-chain delay regime can reduce circular claims.

Government allocation processes can coordinate projects, but investors still need enforceable bilateral rights. Policy alignment is not a substitute for project contracts.

33. Metering is a financial-control system

Meters determine electricity input, hydrogen production, inventory movement, losses, deliveries and power output. They support settlement, carbon accounting, performance tests and loss allocation.

The metering architecture should define ownership, calibration, redundancy, data access, cybersecurity and dispute resolution. Mass balance should reconcile production, injection, stock, withdrawal, use and leakage over each settlement period.

Unexplained imbalance can signal measurement error, venting, leakage or subsurface loss. Tolerance and investigation procedures should be agreed before operation.

34. Completion tests should reproduce the commercial duty

Electrolyser tests should establish net consumption, saleable output, dynamic range, purity and degradation baseline. Storage tests should establish injectivity, working volume, withdrawal, pressure response and quality. Power tests should establish start, sustained output, efficiency and emissions.

The integrated test should move energy through the full chain at representative conditions. Seasonal duration may make a complete inventory cycle impractical before acceptance, so staged tests and conservative initial capacity can be used.

Minimum thresholds, correction, retest, delay damages and rejection rights should protect the downside case. A performance certificate without access to underlying data provides weak evidence.

35. Procurement strategy should follow risk boundaries

A single engineering, procurement and construction contract can simplify accountability when one contractor can control the chain. Geological storage, networks, electrolysis and power equipment may require specialist packages and owner integration.

Package procurement can improve technical depth and price transparency. It increases interface and schedule risk. The owner needs a systems integrator, common design basis and enforceable data obligations.

The risk-adjusted comparison should include exclusions, caps, security, claims exposure and integrated testing. A low package price can conceal a costly unallocated interface.

36. Operating strategy must protect inventory and equipment

The operator manages nominations, compression, wells, pressure, hydrogen quality, turbine readiness, maintenance and emergency response. Optimising one component can reduce whole-system value.

Operating procedures should define minimum inventory, pressure bands, injection and withdrawal sequences, impurity control and abnormal conditions. Digital models can support dispatch, but control decisions require verified sensors and safe limits.

The maintenance plan should align with seasonal risk. Critical spares, compressor redundancy, well workover capability and turbine support influence dependable capacity.

37. Safety and integrity remain investment fundamentals

Hydrogen has a wide flammability range, low ignition energy and material-compatibility considerations. Design should address detection, ventilation, hazardous areas, isolation, pressure relief, embrittlement, emergency shutdown and fire response.

Subsurface integrity includes wells, cavern or reservoir pressure, caprock, subsidence and induced effects. Pipelines require material, welding, fracture and operating assessments suited to hydrogen service.

Safety evidence should be integrated with permitting, insurance and lender diligence. A compliant design still requires competent operation and incident learning throughout asset life.

38. Cybersecurity protects a coupled infrastructure chain

Electrolysers, compressor stations, storage sites, pipelines and turbines depend on industrial-control systems and remote communications. A cyber event can interrupt supply or create unsafe states across several owners.

The architecture should segment networks, control remote access, authenticate devices, preserve logs and support recovery. Vendor access and cloud services need contractual security and continuity obligations.

Joint incident protocols should allocate command, notification and restoration. A chain is only as resilient as the least protected critical interface.

39. Debt sizing should use contracted downside cash flow

Development equity should fund early geology, design, permitting and market formation. Construction debt becomes more credible after rights, permits, tested technology, fixed scope, completion support, connected users and durable revenue are established.

Debt service should be covered after electricity purchases, hydrogen losses, compression, maintenance, inventory finance, network charges, availability deductions, taxes and reserves. Merchant scarcity prices should receive conservative treatment.

Drawdown can be staged against cavern evidence, well tests, pipeline completion, production tests and offtake readiness. Refinancing after stable operation can recognise proven availability and lower risk.

40. Risk allocation should follow control and credit

The party controlling design, construction, operation or demand should bear the associated risk where it can price and manage it. Allocation has limited value if the responsible party lacks financial capacity or the obligation expires before the risk appears.

Table 3. Risk allocation and financing response for seasonal hydrogen storage

RiskEvidence before commitmentNatural control partyContract responseFinancing response
Geology and containmentSeismic, wells, cores, tests and calibrated modelDeveloper and subsurface contractor within defined baselineBaseline, staged capacity acceptance, warranty and remediationRisk capital until containment and cycling are demonstrated
Injection and withdrawalWell and compressor curves, pressure range and duty testsStorage operator and equipment suppliersRate, availability, retest, damages and redundancyDebt case uses guaranteed dependable rate
Hydrogen quality and lossSampling, material balance, microbial and geochemical evidenceStorage and transport operators within custody boundariesSpecification, tolerances, treatment and loss allocationReserves and conservative saleable volume
Cross-chain completionIntegrated schedule, interfaces and common test planSponsors and designated system integratorCoordinated long-stop, cross-chain relief and delay securityStaged draw and funded delay support
Electricity and productionConnection rights, procurement and electrolyser evidenceProducerPower supply, output, efficiency and availability guaranteesContracted production supports inventory build
Demand and dispatchBinding industrial offtake or capacity arrangementOfftaker or support counterparty within contractTake-or-pay, availability, nominations and termination paymentDebt relies on creditworthy downside revenue
Inventory valueTitle, custody, replacement market and accessInventory ownerTitle transfer, pledge, stock obligation and replenishmentWorking-capital facility with conservative advance rate
Policy and carbon eligibilityApplicable rules, measurement and audit methodAllocated between project and support counterpartyChange-in-law, eligibility covenant and data rightsExclude unsupported premiums from base case
Operations and safetyOperating plan, competence, spares and emergency systemOperatorAvailability, integrity, audit, insurance and step-inMaintenance and liquidity reserves

Final allocation depends on project design, policy, counterparties and applicable law.

41. Valuation should separate energy, capacity and option value

Energy value comes from hydrogen or electricity sold. Capacity value comes from dependable availability during scarcity. Resilience value comes from reducing exposure to disruption, common fuel sources or prolonged renewable shortfall. Option value comes from future users, network growth and alternative end uses.

Each value should have an evidence basis and probability. A strategic narrative cannot be capitalised at full value without a payer or enforceable right. Future network expansion should remain option value until approvals and funding are credible.

The base case should use contracted or conservatively supported cash flow. Upside can be shown separately with required capital and timing.

42. A risk-adjusted bridge prevents double counting

The illustrative bridge begins with the value of delivered energy and contracted readiness. Firm duration, fuel diversity and optional direct use may add value. Conversion loss, development, cross-chain and merchant risks reduce it.

The percentages are hypothetical. A real valuation should use project data, independently reviewed forecasts and contracts.

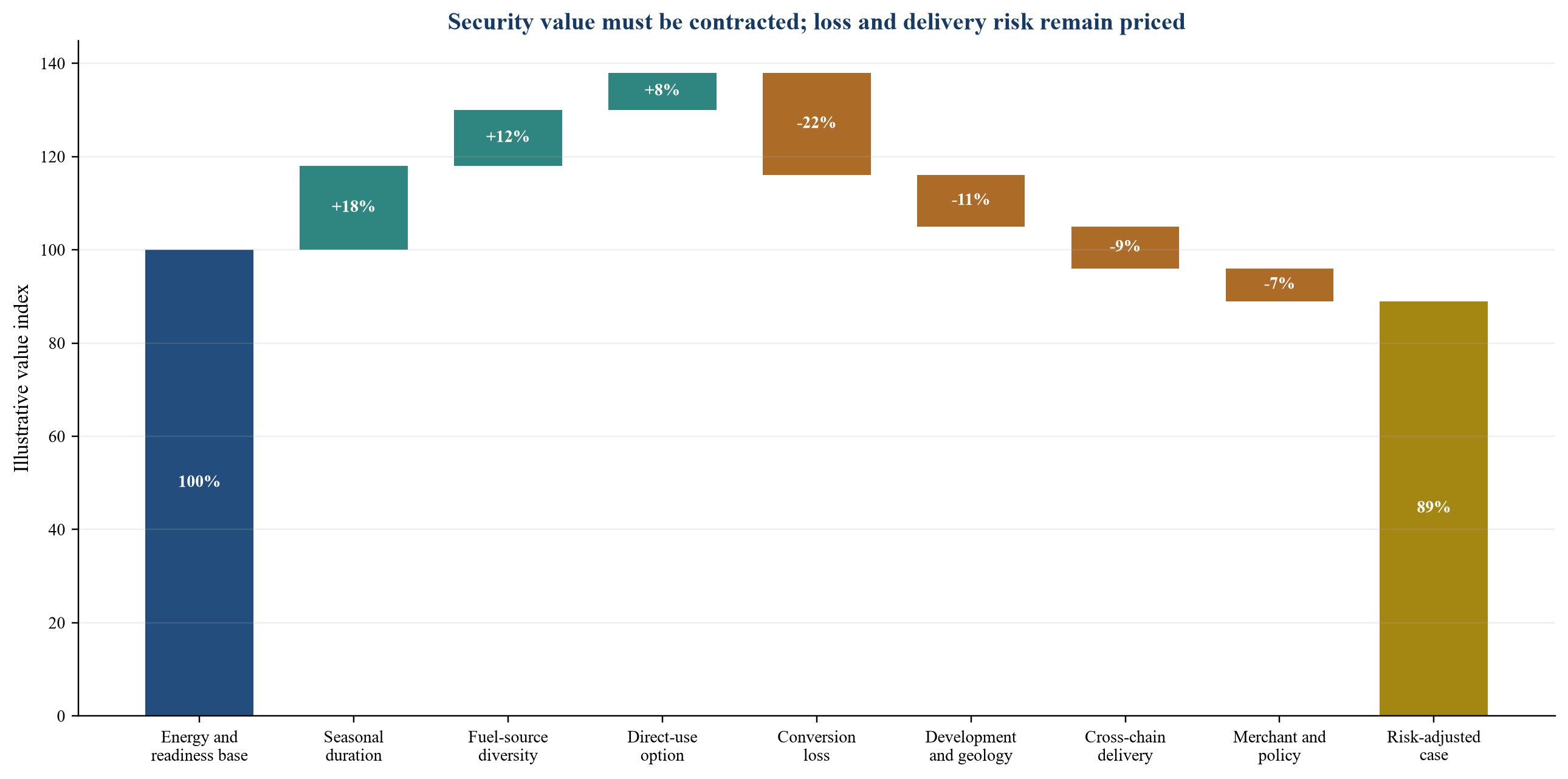

Figure 3. Illustrative security-of-supply value bridge
Figure 3. Illustrative security-of-supply value bridge

Values are hypothetical percentage adjustments to a reference index. They are not observed economics, valuations or forecasts.

43. Acquisition diligence should test the connected platform

A buyer should reconcile every announced kilogram, megawatt and storage unit with rights, permits, engineering, connection, users and funding. A large development pipeline can contain projects at very different levels of control.

The diligence file should include geological data, models, wells, land, water, brine, grid, pipeline routes, equipment references, contracts, carbon evidence, safety studies, data rights and claims. Key-person dependency and access to specialist capability also matter.

Consideration can be linked to objective milestones such as permits, support awards, storage tests, financial close and commercial operation. Governance should identify who controls each milestone after acquisition.

44. The first hundred days should close the decisive gaps

The initial programme should establish a single mass-and-energy balance, custody map, subsurface evidence register, chronological dispatch model and integrated schedule. Independent engineers should review storage capacity, withdrawal, efficiency, completion and safety.

Commercial work should define users, capacity need, alternative resources, revenue mechanism and inventory ownership. Legal work should secure site, subsurface, water, brine, grid, pipeline and data rights. Finance work should connect every downside assumption to a contract or reserve.

At day one hundred, the sponsor should decide which gaps require testing, redesign, contract protection, additional contingency or termination. Continued spend should follow documented evidence gates.

45. Limits and conclusion

Public evidence can establish policy direction, reference performance, announced infrastructure and system scenarios. It does not establish the cost, containment, deliverability, schedule or bankability of an unidentified project. Investment decisions require current site data, designs, permits, bids, tests, contracts and qualified technical, legal, tax and regulatory advice.

Seasonal hydrogen storage loses substantial energy when electricity is converted to hydrogen and later returned to electricity. Those losses are economically important and should be metered transparently. They do not, by themselves, determine whether the system is valuable. Duration, dependable withdrawal, firm fuel, strategic inventory, alternative-use optionality and resilience can justify a service payment when a credible payer defines and procures them.

An investable project connects geology, production, transport, demand and power through one evidence system. It separates inventory from deliverability, energy from capacity, and contracted value from policy aspiration. It releases capital through subsurface and integrated tests, protects cross-chain interfaces, and sizes debt to dependable downside cash flow. Summer energy becomes winter security only when the complete chain can deliver under stress.

References

  1. International Energy Agency, Global Hydrogen Review 2026, 2026. https://www.iea.org/reports/global-hydrogen-review-2026
  2. International Energy Agency, Trade and Infrastructure, Global Hydrogen Review 2026, 2026. https://www.iea.org/reports/global-hydrogen-review-2026/trade-and-infrastructure
  3. International Energy Agency, Global Hydrogen Review 2025, 2025. https://www.iea.org/reports/global-hydrogen-review-2025
  4. International Energy Agency, Proving the Viability of Underground Hydrogen Storage, 2021. https://www.iea.org/articles/proving-the-viability-of-underground-hydrogen-storage
  5. International Energy Agency, Hydrogen in North-Western Europe, 2021. https://www.iea.org/reports/hydrogen-in-north-western-europe
  6. United States Department of Energy, Findings from Storage Innovations 2030: Bidirectional Hydrogen Storage, July 2023. https://www.energy.gov/sites/default/files/2023-09/11_Technology%20Strategy%20Assessment%20-%20%2311%20Bidirectional%20Hydrogen%20Storage_508.pdf
  7. United States Department of Energy, Bulk Storage of Gaseous Hydrogen: 2022 Workshop Summary Report, 2022. https://www.energy.gov/sites/default/files/2022-05/bulk-storage-gaseous-hydrogen-2022.pdf
  8. United States Department of Energy, Pathways to Commercial Liftoff: Long Duration Energy Storage, July 2025. https://www.energy.gov/sites/default/files/2025-07/LIFTOFF_DOE_Long-Duration-Energy-Storage.pdf
  9. National Renewable Energy Laboratory, The Role of Hydrogen in Future Energy, 2021. https://docs.nrel.gov/docs/fy21osti/78296.pdf
  10. National Energy System Operator, Future Energy Scenarios 2025: Pathways to Net Zero, 2025. https://www.neso.energy/document/364541/download
  11. Department for Energy Security and Net Zero, Hydrogen to Power: Market Intervention Consultation Response, December 2024. https://www.gov.uk/government/consultations/hydrogen-to-power-market-intervention-need-and-design
  12. Department for Energy Security and Net Zero, Hydrogen Storage Business Model: Market Engagement on the First Allocation Round, December 2023. https://www.gov.uk/government/consultations/hydrogen-storage-business-model-market-engagement-on-the-first-allocation-round
  13. Department for Energy Security and Net Zero, Proposals for Hydrogen Transport and Storage Business Models, updated August 2023. https://www.gov.uk/government/consultations/proposals-for-hydrogen-transport-and-storage-business-models
  14. Department for Energy Security and Net Zero, Hydrogen Strategy Update to the Market: December 2024, 2024. https://www.gov.uk/government/publications/hydrogen-strategy-update-to-the-market-december-2024
  15. Department for Energy Security and Net Zero, Clean Flexibility Roadmap, accessed September 2026. https://www.gov.uk/government/publications/clean-flexibility-roadmap/clean-flexibility-roadmap
  16. Department for Energy Security and Net Zero, Statutory Security of Supply Report 2025, 2025. https://www.gov.uk/government/publications/statutory-security-of-supply-report-2025
  17. Department for Energy Security and Net Zero, Capacity Market: New Technologies 2025, updated November 2025. https://www.gov.uk/government/consultations/capacity-market-new-technologies-2025
  18. Department for Energy Security and Net Zero, Hydrogen Production Business Model and Net Zero Hydrogen Fund: HAR1 Successful Projects, December 2023. https://www.gov.uk/government/publications/hydrogen-production-business-model-net-zero-hydrogen-fund-shortlisted-projects/hydrogen-production-business-model-net-zero-hydrogen-fund-har1-successful-projects
  19. European Commission, A Hydrogen Strategy for a Climate-Neutral Europe, July 2020. https://energy.ec.europa.eu/system/files/2020-07/hydrogen_strategy_0.pdf
  20. European Union Agency for the Cooperation of Energy Regulators, European Hydrogen Markets, accessed September 2026. https://www.acer.europa.eu/gas/hydrogen
  21. Heinemann, N. et al., Enabling Large-Scale Hydrogen Storage in Porous Media: The Scientific Challenges, Energy & Environmental Science, 2021, 14, 853-864. https://doi.org/10.1039/D0EE03536J
  22. Tarkowski, R., Underground Hydrogen Storage: Characteristics and Prospects, Renewable and Sustainable Energy Reviews, 2019, 105, 86-94. https://doi.org/10.1016/j.rser.2019.01.051
  23. Zivar, D., Kumar, S. and Foroozesh, J., Underground Hydrogen Storage: A Comprehensive Review, International Journal of Hydrogen Energy, 2021, 46(45), 23436-23462. https://doi.org/10.1016/j.ijhydene.2020.08.138
  24. Caglayan, D. G. et al., Technical Potential of Salt Caverns for Hydrogen Storage in Europe, International Journal of Hydrogen Energy, 2020, 45(11), 6793-6805. https://doi.org/10.1016/j.ijhydene.2019.12.161

About the Author

Chennakeshav (CK) is a corporate finance and investment banking executive with 25+ years of global experience in deal origination, structuring and execution across M&A, growth capital and corporate strategy. He has led value-creation mandates for founders, corporates and funds — bridging the boardroom view to hands-on execution and close.

His career spans Morgan Stanley, HSBC, Lloyds Banking Group, EWEC, ADQ portfolio companies and Emirates Growth Fund, across TMT, real estate, fintech, deeptech, cleantech, infrastructure and energy. He has partnered with C-suite leaders, private equity and venture funds, sovereign wealth funds and family offices to finance complex fund raises and scale-up ventures, and has led M&A due diligence, post-merger integration and business-transformation initiatives to create value.

At Matchpoint Partners he is Managing Partner, leading the firm's corporate finance, M&A and capital-raising practice. He holds an MBA from London Business School, an engineering degree from VTU and a Master of Laws (LLM, in progress) from UCL London.

An active start-up mentor, CK mentors at Techstars, DIFC FinTech Hive, Startup Grind, Founder Institute and IN5, serves as Entrepreneur Mentor in Residence (EMiR) at London Business School, and judges the Entrepreneurship World Cup.

LinkedIn: https://www.linkedin.com/in/ckadya/

Profile: https://www.matchpoint-partners.com/team/ck-adya.html

Questions, answered

Store Summer for Winter: frequently asked questions

Hydrogen can store large energy volumes for long periods and can provide firm fuel, strategic inventory and prolonged dispatch. The efficiency penalty remains a real cost and should be priced against duration, dependable capacity, resilience and alternative security resources.

No. Hydrogen can be delivered directly to industrial, transport or chemical users. Direct use avoids the reconversion loss and creates different pressure, purity, demand and contracting requirements.

Salt caverns have established industrial precedents and can offer high deliverability where suitable geology and brine solutions exist. Other formations require project-specific containment, quality, recovery and cycling evidence.

It can pay for tested readiness, dependable output, required inventory and sustained delivery during defined scarcity events, with clear notice, duration, testing, outage and remedy terms.

Debt becomes more credible after rights, permits, storage evidence, grid and transport access, fixed scope, integrated completion support, creditworthy revenue and funded inventory arrangements are established.

Use a common service boundary covering duration, dependable power, delivered energy, full-chain efficiency, response, cycles, development time, location, carbon performance, revenue and completion risk.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
