Alternatives · Wind and Offshore Energy

The Second Life of a Wind Farm: Extend, Repower or Sell

A board decision framework for mature wind assets, reinvestment, repowering and exit timing.

The Second Life of a Wind Farm: Extend, Repower or Sell
Quick answer

Choose among lifetime extension, partial or full repowering, asset sale and decommissioning using one evidence base for remaining life, rights, grid, revenue, capital and liabilities.

Abstract

Owners of mature wind farms need to compare continued operation, repowering and sale against a supported operating horizon and a defined allocation of obligations. This paper develops a decision framework linking technical condition, maintainability, consent, land and grid rights, revenue arrangements, capital expenditure and decommissioning. It reviews selected UK, German and European primary sources, with a bounded operator-disclosed repowering example from Spain.

A hypothetical onshore model compares complete cash-flow paths on a common valuation date. It separates operating value, restricted security, debt and shareholder proceeds, and includes permission failure, delay, construction cost, output and removal sensitivities. In the selected base case, extension and repowering have similar project values after security; repowering also exceeds the assumed owner funding limit. These results illustrate the method and provide no valuation or recommendation for an actual farm.

The proposed transaction and board processes connect unresolved evidence to an assessment, funding decision or completion condition. Project-specific engineering, legal, commercial, tax and financing review remains necessary before commitment.

JEL Classification: G31; G32; G34; L94; Q42

Keywords: wind farm; lifetime extension; repowering; asset sale; decommissioning; restricted security; project finance; valuation; onshore wind; offshore wind

This Matchpoint Insight presents the complete web edition of the research, including its worked calculations and source material.

Register Before Download   Explore our Energy Transition practice

1 Define the second-life decision

A mature wind farm presents an ownership and reinvestment decision across several possible operating configurations. DNV's published lifecycle-service scope distinguishes continued operation, repowering and decommissioning, alongside assessments of fatigue life, economic life and asset integrity. These categories provide a useful starting point for an owner's review. An asset sale or partnership adds a separate question about who funds and executes the selected physical pathway. [13]

The analytical framework developed in this paper treats extension, component renewal, full repowering, sale and decommissioning as explicit alternatives. Each requires its own physical scope, rights position, cash-flow timetable and retained obligations. A proposed five-year extension, for example, would need an assessment covering that operating period and the interventions on which it depends. Five years in that example is a hypothetical management choice; it supplies no engineering conclusion or standard market term.

Sale also requires a defined perimeter. The interest offered could comprise an operating company, selected equipment and rights, or participation in a future development. The comparison should identify the operating cash flows surrendered, any development participation retained, and obligations remaining with the seller. The statutory treatment of offshore decommissioning requires particular care, as discussed below.

The proposed board question is therefore specific: which executable combination of configuration, ownership and capital commitment meets the owner's objectives on the evidence available? A route should remain conditional where its engineering, rights, revenue or funding basis is unresolved. This discipline allows the owner to evaluate an extension undertaken while developing a repowering proposal, or a sale timed around a documented milestone.

Table 1. Proposed option perimeter

PathwayPhysical perimeterCommercial perimeterMain decision
ExtendExisting configurationAdditional operating periodFund required interventions
Renew componentsSelected replacement scopeRevised cost and output caseAccept mixed-vintage interfaces
RepowerNew configuration and retained worksDevelopment and new operationsCommit replacement capital
Sell or partnerAgreed asset and rights packagePrice, participation and liabilitiesAllocate ownership and execution
DecommissionApproved removal and restorationCost, security and recoveryExecute funded cessation

Analytical comparison. The entries describe questions for assessment and do not represent an observed transaction sample.

2 Establish an evidence method

The proposed method begins with a common evidence register. The register should distinguish source records, professional conclusions, management forecasts and hypothetical modelling inputs. A meter record, an inspection finding and a forecast describe different things; the model should preserve their identities when it converts them into expected cash flow. The date, asset coverage, author and reliance conditions of each material document belong alongside the finding.

The quality review should examine completeness and reconciliation. Production records need a defined metering boundary and period. Maintenance records need links to turbine identifiers and completed work. Design documentation needs an identifiable configuration. A remaining-life report needs a stated assessment period, exclusions, required actions and operating restrictions. An uncompleted recommendation should enter the work programme with a responsible party and evidence of closure.

DNV's published inspection scope includes end-of-contract condition assessment, component examination and acquisition-diligence inspection. Its lifetime-service page lists load measurements, SCADA, inspections and numerical analysis. These published categories help scope an adviser appointment; they supply no results for the unnamed assets considered in this framework. [14; 13]

For decision purposes, the owner should maintain one reconciled base case and a visible set of unresolved items. A missing document should remain a missing document. The appropriate response may be retrieval, inspection, further analysis, a conservative scenario or a contractual condition, depending on the issue. The proposed approach makes that choice explicit before management assigns value to the affected operating period or development option.

Table 2. Proposed evidence-quality treatment

Evidence classExampleRequired contextDecision treatment
Source recordMeter or maintenance dataBoundary, dates, identifiersReconcile to the model
Physical findingInspection or test resultScope and limitationsDefine action and exposure
Professional conclusionRemaining-life assessmentConditions and relianceApply supported operating case
Management forecastIntervention programmeBasis and approval dateTest cost and delivery scenarios
Hypothetical inputIllustrative price or outageExplicit assumption statementUse for explanation and sensitivity

Analytical evidence hierarchy. Project findings and numerical adjustments require their own supporting records.

3 Map the physical system and its rights

The review should divide the farm into systems whose assessment and ownership boundaries are clear. Turbines, foundations, collection cables, substations, export infrastructure, access works and control systems need identifiable records and interfaces. The owner can then ask which elements are retained, replaced, shared or removed under each proposed pathway.

The rights map belongs beside the physical map. Consent duration, land or seabed occupation, access, cable routes, export arrangements and service permissions should be checked against the intended operating and construction periods. A model extending generation beyond a documented right needs a clearly identified conditional case and the steps required to establish that right. No project-specific agreement is assessed in this paper.

Ofgem's offshore health-review material includes onshore and offshore consents, leases, grid-related agreements and transmission arrangements within the extension review. This is a concrete regulatory example of reviewing rights alongside equipment condition. Its application is confined to the relevant offshore process. [4]

For the proposed framework, each dependency should show the responsible party, the decision or approval needed, and the consequence for timing or scope. Shared infrastructure deserves particular attention when different owners control the generator, transmission assets or neighbouring developments. An extension, repowering programme or sale should use the same interface description, so that each case values the same perimeter. Any retained facility should carry its own evidence of condition, capacity, rights and maintenance obligations.

Table 3. Proposed system and rights dependencies

SystemEvidence questionRights dependencyPathway implication
Turbines and foundationsSupported configuration and lifeConsent and occupationExtension or replacement scope
Collection and substationCondition and capacityOwnership and accessRetained-infrastructure assessment
Export systemHealth and export limitsConnection and interfacesDeliverable output and timing
Roads and working areasAccess and construction suitabilityAccess and temporary worksRepair and repowering logistics
Shared facilitiesResponsibilities and interfacesThird-party agreementsConsent, liability and transaction scope

Analytical map. Actual ownership, contractual rights and permissible reuse require document review.

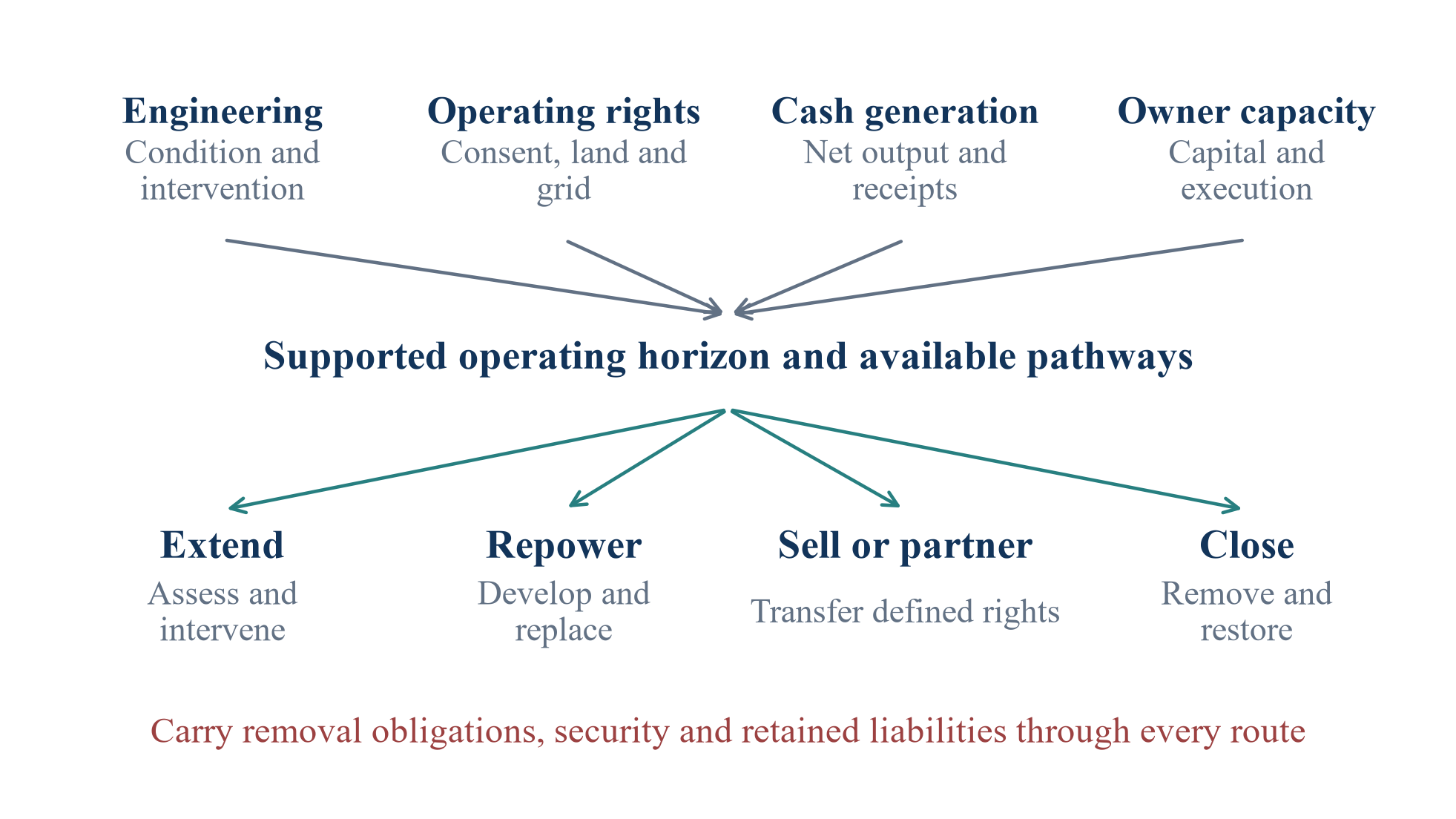

Figure 1. The asset decision and its evidence dependencies
Figure 1. The asset decision and its evidence dependencies
View figure at full size; scroll horizontally on smaller screens.

Author's analytical framework. Pathways depend on the actual engineering findings, rights, agreements and available capital; the diagram grants no project approval.

4 Assess the engineering evidence

DNV-ST-0262's public synopsis covers lifetime extension of onshore and offshore turbines and identifies assessment of fitness for extension among its objectives. The complete standard is subscription-gated. The discussion here uses the published scope and does not claim to reproduce its detailed acceptance requirements. [1]

The proposed engineering work package should identify the original design basis, subsequent configuration changes, operating history and available physical findings. For structures, the questions include the loads assessed, deterioration identified and conditions attached to additional operation. For rotating equipment and blades, the review should connect component history, observed condition, repair recommendations and monitoring requirements. Electrical and control systems need their own condition and supportability review.

The report presented to the board should state the operating period examined, limiting systems, required interventions, inspection intervals, restrictions and residual uncertainty. It should also show which turbines or components were directly examined and how any wider conclusion was developed. The commissioning of an assessment is an administrative event; a supported conclusion depends on its scope, findings and conditions.

ORE Catapult's September 2025 announcement provides a bounded example of physical testing. The programme used a blade that had operated for 20 years at an exposed RWE onshore site. The announcement describes controlled accelerated loading, monitoring and specific adaptations, and reports extension potential. Detailed test data and acceptance criteria were not available on the inspected announcement page. The result therefore supports discussion of the evidence process for that programme; it supplies no generic additional-life allowance for a fleet. [10]

The analytical follow-through is to connect every required intervention to delivery, cost and verification. The owner should know what must be completed before further operation, what can be scheduled during it, and what finding would prompt reassessment. Finance and transaction work should use the resulting conditional operating case, with the engineering limitations preserved.

5 Examine OEM support and obsolescence

The 2026 UK government study records stakeholder concerns about access to spare parts as turbine models age. Interviewees described reduced OEM or supplier production, replacement lead times, and restrictions associated with service arrangements. These are reported stakeholder findings; their relevance to a particular turbine population requires a support and supply review. [2]

The proposed review should distinguish physical condition from the practical ability to maintain operation. An owner needs to understand the available repair routes, component compatibility, access to tools and software, and the parties able to deliver the work. The evidence should identify existing support terms, exclusions, termination dates and any confirmed alternative suppliers. Unconfirmed alternatives should remain development actions.

A maintainability plan can then connect equipment exposure to the proposed operating period. For each material component, the owner should record the repair or replacement strategy, quotation status, delivery assumptions and access requirements. Pooled spares and fleet refurbishment can be examined where an actual arrangement exists. The capital and outage model should disclose any dependence on a supply arrangement still being negotiated.

This framework also proposes a clear treatment of controls and software. The review should establish what is supported, what permissions are required and what changes have been assessed. A general statement that a turbine is serviceable gives insufficient detail for these questions. The relevant conclusion is whether the intended configuration can be maintained through the chosen period, within the documented operational restrictions and the owner's funding capacity.

Management should also distinguish support already contracted from support that remains to be procured. The intervention case should identify which assumptions depend on a particular supplier and what alternative is available if that arrangement changes. A dependency with no confirmed substitute belongs in the downside case, with its operating and funding consequences stated for the board's decision.

6 Build a net-energy and revenue bridge

For the analytical comparison, installed capacity, generated energy and cash receipts should be separate model stages. The owner should begin with the available metered record and identify the boundary between turbine output, collection losses and exported energy. Any reconstruction or adjustment should have an explanation and a reproducible calculation.

The proposed bridge then separates resource variation, availability, curtailment, electrical losses and other documented operating effects. It should identify the evidence behind a forecast change: a completed intervention, a revised operating restriction, a different layout or a hypothetical scenario. This treatment allows the owner to test extension and repowering without automatically carrying historical output into a new configuration.

Revenue requires a second bridge from exported volume to settled receipts. The review should identify the contract or market basis, price adjustments, imbalance allocation, curtailment treatment, settlement costs and counterparty arrangements. The treatment must follow the relevant agreement. Future awards and unsigned contracts should enter distinct conditional scenarios with their status visible.

The decision model should then reconcile operating, accounting and settlement information for the same period. A buyer or lender can examine that reconciliation alongside the generation forecast. For management, the useful output is an explanation of which changes drive the difference between pathways and how much value depends on each unresolved input. Numerical generation and price assumptions in the later illustrative model are hypothetical; they are not production estimates for a specified wind farm.

7 Separate onshore permission routes by jurisdiction

The UK National Policy Statement EN-3 carries “2025” in its title and displays a publication date of 6 January 2026. Its onshore wind provisions operate within the stated English nationally significant infrastructure scope. Paragraph 2.12.36 addresses expiry of time-limited consent; paragraphs 2.12.43-2.12.45 address changed repowering impacts and new consent applications with relevant EIA and HRA requirements. Applicability must be established for the actual project and consent route. [3]

Germany provides a different statutory example. Section 16b of the Bundes-Immissionsschutzgesetz sets out a repowering modification procedure. Its complete-replacement conditions include construction within 48 months of dismantling and distance within five times the new installation's total height. Separate examination of planning/building matters, occupational safety and Natura 2000 remains addressed in paragraph 4. Paragraph 10 requires the existing operator's agreement where the replacement developer differs and excludes parallel operation of the replaced and replacement installations. The consolidated German text was checked on 11 October 2026; project interpretation requires German legal review. [7]

At EU level, Directive 2023/2413 introduces Article 16c provisions for repowering. The grid-permit provision concerns capacity increases of no more than 15% and a three-month procedure, subject to its stated qualifications. It also limits the relevant environmental examination to changes from the original project. National implementation and application need confirmation; an administrative deadline supplies no physical connection-delivery schedule. [9]

The analytical consequence is a jurisdiction-specific permission case. The owner should establish the route before fixing configuration, sequence or valuation. A timetable that depends on an unverified legal interpretation should remain conditional. Existing operational experience can inform the assessment, while the actual application requirements determine the evidence needed for the revised proposal.

Table 4. Jurisdiction-specific permission examples

ScopeVerified provisionProject question
English onshore NSIP windEN-3 new repowering applicationWhich consent route and assessments apply?
German repoweringBImSchG section 16b conditionsDoes the proposed replacement qualify?
German outside-settlement windBauGB section 35 restoration undertakingWhat undertaking and security bind the project?
EU repowering frameworkArticle 16c permit provisionsWhat has national law implemented?

Compact source-based comparison. National implementation, consent scope and project eligibility require confirmation. [3; 7; 8; 9]

8 Align offshore consent and transmission life

EN-3's offshore wind paragraphs 2.8.74-2.8.75 recognise that repowering can involve a changed scale and nature of turbines, and require a new consent application with applicable environmental assessments. The statement has specified geographical and statutory boundaries, including exclusions associated with Scottish functions. An offshore proposal needs a confirmed route for both its generation and associated works. [3]

The Ofgem health-review process provides a further offshore dependency. Its November 2024 guidance places the generator review at T-6 before the initial OFTO tender revenue stream ends and the OFTO review at T-5. The generator review addresses technical viability, the overall extension case and the preferred period; the subsequent process considers transmission condition and revenue. These dates belong to that regulatory process. [4]

Ofgem's July 2025 decision maintains the 98% OFTO availability target in extension. It also describes prospective licence modifications for uninsured major failures and the discussion of repair funding or early termination. Subsequent licence implementation was not verified for this paper. The distinction matters when a model assumes a particular allocation of repair cost. [5]

For the wind-farm owner, the proposed task is to establish a consistent generation/transmission case: aligned periods, required works, approved arrangements and the consequences of a material failure. Detailed OFTO revenue mechanics and transmission-asset valuation fall outside the central extend, repower or sell comparison developed here. An owner should carry the verified interface assumptions into the common model and retain the unresolved items as explicit conditions.

9 Resolve land and grid interfaces

The proposed rights review should examine the actual land or seabed agreement alongside the intended configuration. Relevant questions include the permitted use, occupation period, extension mechanism, rent basis, access, cable rights, removal obligations and transfer or change-of-control provisions. Repowering may require a different footprint or construction access; the review should identify which proposed changes are already covered and which require agreement.

Grid analysis should similarly begin with the actual connection and interface documents. The owner needs a defined export limit, equipment boundary, modification route, compliance scope and responsibility for required works. EN-3's English onshore provisions expressly discuss network capacity, connection characteristics and available export capacity as development considerations. They do not determine the capacity available to an unnamed project. [3]

For the analytical framework, retained infrastructure should be examined through engineering and rights workstreams together. An existing cable, road or substation belongs in the repowering case only with an identified basis for the intended use. Where an assessment is outstanding, the model should include the potential replacement or redesign consequence as a scenario.

These interfaces also define the transaction package. The seller should be able to show the rights attached to each facility and the agreements required for transfer or continued shared use. The board can then distinguish value supported by existing documentation from value conditional on new approvals, counterparty agreement or delivery of additional works.

The proposed rights register should have separate extension and repowering columns. An agreement covering the current configuration should be examined against the revised use before management assigns repowering value to it. Where the owner proposes to preserve existing operation during development, the register should record both the continuing rights and the conditions associated with the future configuration.

10 Review PPAs, hedges and operating cash receipts

The proposed commercial review should identify the revenue arrangements that continue into each pathway and those that end or require replacement. For a PPA, the relevant analysis follows the signed terms: volume basis, delivery point, price mechanism, duration, credit support, curtailment, imbalance, termination and change provisions. No universal contracting tenor or price is assumed in this framework.

Hedges need a matching review of volume, shape, settlement and termination exposure. Management should test whether the proposed outage or construction sequence changes the volumes available to meet the agreement. The operating model and treasury position should be reconciled so that a repair programme or repowering delay appears in the cash-flow scenarios with the relevant contractual consequences.

The revenue case should distinguish executed agreements, negotiations and a hypothetical future contract. For a proposed sale, those categories should be visible in the valuation and data room. The allocation of risk between the project and a counterparty depends on the actual wording and credit position; this paper supplies an analytical review structure.

A useful board output is a bridge showing revenue duration against technical life and rights duration. Any gap should carry a documented assumption and a sensitivity. The resulting comparison can show how much extension or repowering value depends on continued merchant exposure, a replacement agreement, or a contract condition still requiring resolution.

Table 5. Proposed revenue diligence comparison

ItemEvidenceModel question
PPA duration and priceExecuted agreementWhich years and volumes are covered?
Curtailment and imbalanceContract and settlement recordsWho bears each documented adjustment?
Hedge positionConfirmations and exposure reportWhat changes during outages or delays?
Counterparty supportCredit and security documentsWhat cash or collateral is required?
Future revenueNegotiation or award statusWhich case remains conditional?

Analytical review structure. Contract interpretation and financial exposure depend on the actual agreements.

11 Define capex and execution scope

The analytical capital programme should be built around identifiable work packages. An extension case needs the inspections, repairs, monitoring and support arrangements on which its operating conclusion depends. A repowering case needs development, removal, new equipment, retained-infrastructure work, construction interfaces, commissioning and restoration. Each package should identify quotation status, scope exclusions, schedule assumptions and responsibility.

Execution sequencing connects cost to lost generation. Management should examine when existing operation ends, which works can proceed alongside it, and what must be complete before new generation begins. For each proposed sequence, the financial model should identify foregone cash receipts, temporary facilities, mobilisation and the cost consequences of delay. Numerical downtime and construction periods require project evidence or an explicit hypothetical assumption.

Retained works create a specific interface question. The engineering review should establish the required condition and capacity; the execution plan should establish access, isolation, testing and allocation of responsibility. Commercial terms should be reviewed for what happens if actual condition differs from the assumed scope. The proposed board comparison should retain the gross exposure and identify any contractual recovery separately.

The final capital request should reconcile engineering recommendations, supplier scope, programme milestones and the model. Contingency should have an explained basis and remain separate from an unidentified omission. Before committing, the owner should know which material quotations and approvals are firm, which remain conditional and how the pathway changes if a required item cannot be obtained on the modelled terms.

Management can present the capital programme in a decision-date view and a cash-payment view. The first identifies when commitments become binding; the second identifies funding needs. Keeping those views reconciled allows the board to examine staged approval, cancellation exposure and working capital without treating an uncommitted estimate as an executed procurement contract.

Table 6. Proposed execution cost perimeter

Work packageExtension caseRepowering case
Assessment and developmentLife and intervention reviewDesign, surveys and applications
Equipment workDefined repair/replacementNew equipment and retained interfaces
Access and mobilisationMaintenance logisticsRemoval and construction logistics
Lost operationIntervention outagesDisconnection and commissioning sequence
Completion evidenceClosed engineering actionsTests, approvals and handover

Analytical scope comparison. No cost, duration or procurement result is asserted.

12 Separate decommissioning cost, security and liability

The England/Wales offshore guidance states that ownership transfer does not automatically release decommissioning liability. Paragraphs 5.7.7-5.7.9 describe approved programme arrangements, equivalent security and written government confirmation in the release process. Paragraph 8.7 excludes scrap-value offsets from the security cost assumptions. Scottish offshore guidance separately addresses insolvency-protected security and disclosure of restricted cash. Germany's BauGB section 35(5) requires relevant outside-settlement development to carry a restoration undertaking following permanent cessation. Actual project obligations require jurisdiction-specific review. [6; 12; 8]

For the proposed financial framework, removal scope, economic cost and security should be separate schedules. The cost schedule should identify the assets to be removed or treated, restoration work, timing, quotations and unresolved scope. A security schedule should identify the beneficiary, instrument, amount, renewal conditions, restricted cash and release mechanism. The model can then show the funding requirement without treating a restricted balance as freely distributable cash.

Extension and repowering should carry their own decommissioning consequences. Management should identify what is deferred, what is removed during replacement, what remains in service and what future obligation attaches to the revised configuration. The approved programme and occupation agreement should be reviewed against that sequence. A proposed amendment should remain a condition until the relevant authority has accepted it.

For a sale, the analytical completion plan should distinguish contractual allocation from regulatory release. It should identify what evidence is needed for the transfer arrangements, replacement security and release of any existing support. The value comparison should disclose retained obligations and the cash available after transaction costs and required security movements. A headline sale price alone supplies insufficient information for that comparison.

Table 7. Proposed separation of security and recovery value

ItemEvidence basisModel treatment
Gross removal obligationProgramme, consent and scopeCost and timing schedule
Regulatory securityApproved instrument and termsRestricted cash or instrument exposure
Internal salvage estimateOutlet, condition and quotationSeparate conditional receipt
Liability releaseAuthority confirmation and conditionsCompletion or retained-obligation field
Restoration and monitoringPermit and occupation termsPost-operation work and funding

Analytical model structure informed by the cited guidance. Actual approved requirements govern the project. [6; 12; 8]

13 Underwrite reuse and salvage separately

The 2026 UK government research identifies a limited empirical basis for second-hand reuse assumptions and describes relevant estimates as informed estimates. Its discussion also recognises that age provides incomplete information about condition. These limitations matter when the owner includes reuse receipts or avoided replacement costs in a pathway model. [2]

The proposed reuse assessment should identify the component, documented history, remaining assessment work, intended application and receiving party. Transport, dismantling, refurbishment, testing and warranty arrangements belong in the same commercial case. A potential use should remain conditional until the technical and contractual requirements are understood. The same discipline applies to civil and electrical works retained at the site.

Salvage requires a distinct receipt case. The owner should establish the material or equipment quantity, recoverable condition, removal method, processing cost, logistics and outlet evidence. A gross scrap quotation should not be entered as net proceeds without the associated scope. The model should show both the receipt assumption and the costs needed to realise it, with uncertainty visible.

For board analysis, reuse can be assessed as avoided expenditure, an external receipt or an internal fleet transfer. Each has a different valuation boundary and should appear once in the comparison. The later model should avoid counting the same component as retained infrastructure and as equipment sold. This is a modelling rule within the proposed framework; actual recoverability remains a project-specific conclusion.

Management should also test a case with no recovery receipt while retaining the documented removal obligation. That sensitivity identifies the amount of value dependent on the outlet assumption. A separate assessment can then examine whether additional testing, segregation or refurbishment expenditure is justified by the conditional receipt it supports.

14 A bounded onshore example at Muel

RWE's 10 December 2025 announcement reports commissioning of the repowered Muel wind farm in Aragon, Spain. It describes replacement of 27 turbines totalling 16.2 MW with three totalling 19.97 MW, using the same grid connection, over an eight-month dismantling and replacement period. The announcement says the old turbines were disconnected in April 2025 after 27 years of operation. These are attributed operator disclosures. [11]

The announcement also reports 99.82% material recovery or recycling and receipt of Bureau Veritas ZeroWaste certification. It describes 1,350 components as intended for refurbishment and later reuse in RWE's fleet. A secured PPA is disclosed with an undisclosed offtaker. The household equivalents in the announcement are calculated figures. The inspected release supplies no realised investment return, PPA price or independently inspected production history. [11]

The analytical value of the example is its combination of equipment replacement, a disclosed existing connection, circularity arrangements and a revenue contract. It gives the owner specific questions to investigate in another case: the configuration retained, the capacity approved, the period without generation, the component-disposition agreements and the status of contracted revenue.

The eight-month period should remain attached to the reported dismantling/replacement activity. It establishes no general development timetable. The material disclosures likewise need their reported boundaries and the distinction between completed recovery and planned refurbishment. A board assessing another farm would need its own engineering, permission, procurement and contract evidence before using the example in a capital decision.

15 Common valuation and input assumptions

Every numerical input and scenario in this model is hypothetical. The calculations demonstrate a reproducible decision method; they do not describe an observed wind farm, lender offer, buyer bid, engineering assessment or tax jurisdiction. No scenario probabilities are supplied. Conditional outcomes remain separate throughout the analysis.

The common valuation date is 30 September 2026. All monetary values are nominal pounds sterling, expressed in millions unless stated otherwise. Year 1 ends on 30 September 2027. Cash flows after the decision date occur at annual period ends; immediate investment occurs at year zero. The annual convention simplifies seasonal generation, construction draw timing and intra-year outages. A transaction model would require the underlying monthly evidence.

Table 8 records the central assumptions. Existing net exports begin at 95,000 MWh; new-plant exports begin at 180,000 MWh. Both use an assumed year-one realised electricity price of £70/MWh. Ordinary availability, electrical losses and curtailment are already embedded in exported energy. The realised-price assumption embeds the assumed capture effect and route-to-market charge. Multiplying those adjustments again would duplicate them. Separate annual degradation is 0.5 percent for existing plant and 0.3 percent for new plant.

Price and fixed operating expenditure increase by the assumed 2 percent inflation rate from their year-one values. Capital and removal estimates are quoted at the valuation date and escalate to their payment years. The project discount rate is 8 percent nominal; the separate shareholder hurdle is 12 percent. A hypothetical buyer uses 7 percent. These rates are selected inputs, with no claim that they represent market returns.

Equation 1.

VP = ∑t = 0H(Pt(1 + rP)t)

In the valuation equation, V with subscript P is project present value, P with subscript t is project cash flow including restricted security, r with subscript P is the nominal project discount rate, and H is the final calculation year. The complete calculation runs from year zero through year 40, including any closure settlement; cash flows after final settlement are zero. The equation discounts each complete path to the same date. It includes explicit closure and assigns no terminal multiple, perpetual growth value or separate premium for grid rights. The project value including security contains the future release of the existing restricted-cash asset. An operating-only value is also reported so that the source of value remains visible.

Table 8. Hypothetical common-date model assumptions

InputExisting plant / ownerNew plant / common convention
Valuation and units30 September 2026Nominal GBP millions; annual period-end cash
Net exported energy95,000 MWh in year 1180,000 MWh in first operating year
Realised priceGBP 70/MWh in year 1Same common price framework
Annual degradation0.5%0.3%
Fixed cash opexGBP 2.20m in year 1GBP 2.80m in year 1 quoted money
Capital input at date 0GBP 7.00m extensionGBP 70.00m new construction
Development at date-0 pricesNot applicable for immediate extension1.00 at t=0; 1.00 at t=1; 0.50 at t=2
Operating calendarExtension through year 10Permitted new operation: years 5 to 29
Absolute rights expiryYear 10Year 29, including delayed cases
Gross removal / salvage8.00 / 1.00 at date-0 prices10.00 / 2.00 at date-0 prices
Nominal inflation / corporate tax2% / hypothetical 25%No refunds or terminal value for losses
Discount inputs8% project; 12% equity7% hypothetical buyer
Initial cash / debt4.00 restricted; 0.00 unrestricted; 8.00 debtExisting debt is never redrawn at t=0
Security rule50% of future gross removal estimateOld-cash floor; new cash posted at construction
Debt assumptions6% rate; six-year existing schedule65% construction cap; DSCR 1.35x; LLCR 1.50x
Owner funding limits45.00 pre-COD; 80.00 total callsNominal undiscounted capital-commitment assumptions

Every input is hypothetical. The security, lender, tax and return assumptions are selected model inputs, not verified market terms. MWh is net export; realised price contains the assumed capture effect.

16 Full-life project cash flows

The extension route invests £7.00 million immediately, operates through year 10 and pays removal costs in year 11. The permitted-repowering route incurs development spending before the permission outcome at the end of year 2. Existing generation continues in years 1 and 2. Removal and the first construction tranche occur in year 3; the second tranche occurs in year 4; new generation begins in year 5. The £70.00 million construction input is current-money cost, divided equally between the two payment years before inflation.

Equation 2.

Ut = Yt − Ot − Dt − Kt − Ct + St − TtU

In this notation, U is operating unlevered cash flow, Y is revenue, O is cash operating expenditure, D is development spending, K is capital spending, C is gross removal cost, S is salvage and T with superscript U is unlevered cash tax. The subscript t identifies the payment year.

This operating-cash-flow equation deducts cash operating expenditure, development, investment, gross removal and unlevered cash tax, and adds salvage receipts. Existing generation surrendered during replacement is captured by comparing the complete extension and repowering paths. Charging an additional foregone-generation penalty would count that difference twice.

Tax treatment is explicitly hypothetical. The model assumes 25 percent corporate tax, straight-line tax depreciation and unlimited nominal loss carryforward. Development, repair, financing costs and removal receive the stated assumed deductions. Salvage is taxable; remaining tax book value is written off on removal. Tax losses produce no refunds, group relief or terminal receipts. The unused unlevered loss balance is £8.70 million after extension closure and £14.49 million after permitted-repowering closure; neither balance is assigned value.

Table 9 separates operating-only project NPV, project NPV including restricted security and shareholder NPV. Extension produces £14.94 million operating-only value and £16.10 million including security. Permitted repowering produces £19.14 million operating-only value and £16.01 million including security. The difference after security is approximately £0.09 million in favour of extension. This narrow synthetic difference provides no evidence about an actual project choice.

Failure and delay have explicit consequences. Permission failure with separately supportable extension produces £14.90 million project value; failure requiring closure produces £1.88 million including security and negative £1.28 million operating-only value. The positive restricted-cash release explains the latter distinction. A two-year delay moves commissioning to year 7. Absolute new rights still expire in year 29, leaving 23 operating years and reducing project value to £11.91 million. Modelled cash flows cease after final settlement.

Table 9. Hypothetical full-life scenario values and funding tests

Deterministic stateOperating NPVProject incl. securityEquity NPV at 12%Funding tests
Extend14.9416.106.20Pass
Repower, permitted19.1416.01(0.19)Fail
Permission fails; extend13.6014.905.55Pass
Permission fails; close(1.28)1.88(4.95)Pass
Repower delayed two years14.5311.91(1.84)Fail
Construction capex +30%3.690.56(10.63)Fail
Common realised price -20%(1.24)(4.37)(13.67)Fail
New generation -15%5.202.07(8.94)Fail
Removal doubled; zero salvage10.851.16(13.25)Fail
Combined downside(36.47)(45.13)(45.74)Fail
Extension: one-year failure7.889.04(0.00)Fail
Immediate orderly closure(6.61)(2.91)(10.38)Pass

GBP millions; parentheses indicate negative values. Operating and security-inclusive project NPVs use 8%; equity uses 12%. Failure-year equity NPV is negative GBP 0.00453m before display rounding. Funding tests include model DSCR/LLCR assumptions and nominal owner-call limits; a funding pass does not imply positive investment value. No probability weights.

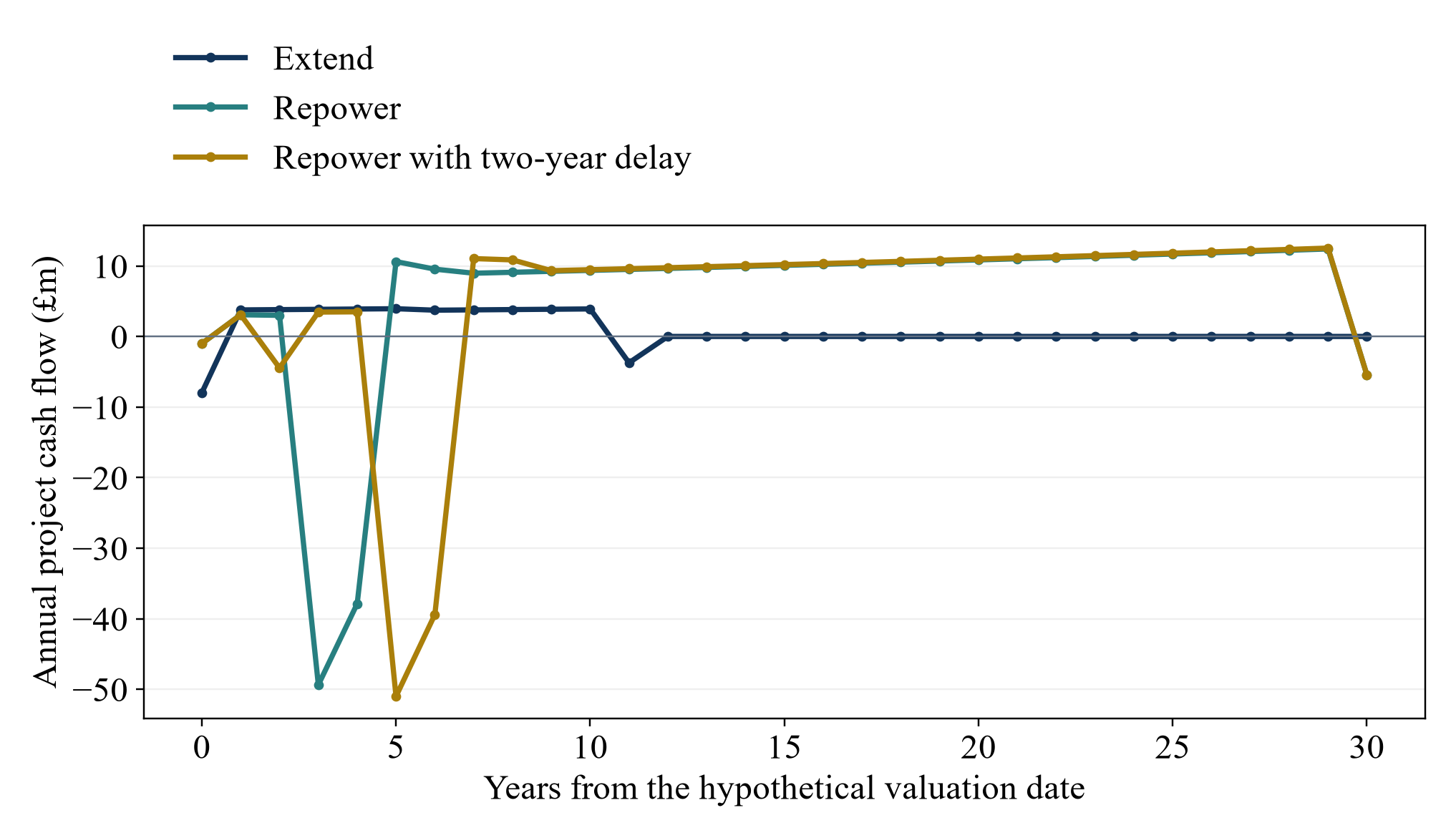

Figure 2. Full-life project cash flows including security
Figure 2. Full-life project cash flows including security
View figure at full size; scroll horizontally on smaller screens.

Hypothetical nominal annual cash flows, including restricted-security movements, capex, tax and explicit removal. No terminal multiple. New operating rights expire at year 29 in both repowering cases; delay shortens generation.

17 Debt and shareholder cash

Financing is an explicit overlay. The £8.00 million existing loan is a pre-existing obligation and receives no artificial year-zero draw. Its assumed 6 percent interest and six-year level-service schedule apply until repayment. Repowering accelerates the remaining old principal at old-plant removal. The example assumes no refinancing, repayment premium or covenant waiver.

New debt is constrained by three hypothetical limits: 65 percent of actual new construction capex; level-annuity debt capacity consistent with at least 1.35 times DSCR; and at least 1.50 times LLCR. These are hypothetical financing constraints selected for the model. Debt tenor is capped at 15 years and ends at least two years before the relevant operating-rights and technical-life limit.

The permitted case draws £48.77 million alongside the two construction tranches and repays through year 19. Interest is charged on opening balances and paid in cash during construction. A 1 percent arrangement fee is paid at first draw. Equity funds these cash uses; capitalised interest is zero. Conservative sizing uses unlevered-tax cash available for debt service, with the actual levered-tax result tested separately.

Equation 3.

Ft = Drawt − Interestt − Principalt − FeestEt = Pt + TtU − TtL + Ft + C0 × I(t = 0)NPVrP(E) = VP + NPVrP(TU − TL) + NPVrP(F) + C0

Here E is equity cash flow, T with superscript L is levered cash tax and F is net financing cash flow: debt draws less interest, principal repayments and financing fees. Initial unrestricted cash is included once at year zero. The valuation identity uses the same project discount rate for every component.

Table 10 provides the exact project-to-equity bridge at the common 8 percent discount rate. Extension project value of £16.10 million, a £0.36 million financing-tax benefit and negative £7.52 million net financing value reconcile to £8.93 million equity value. Permitted repowering reconciles £16.01 million project value, £3.68 million tax benefit and negative £3.42 million financing value to £16.26 million equity value. Rounding explains minor differences between displayed components.

The separate 12 percent shareholder-hurdle calculation gives £6.20 million for extension and negative £0.19 million for permitted repowering. A shareholder-hurdle measure cannot be used as an accounting subtraction from a project NPV discounted at 8 percent. The model reports both measures and verifies the same-rate identity. Different capital timing, debt cash flows and discount inputs explain the different rankings. Actual financing decisions require project evidence and agreed financing terms.

Table 10. Hypothetical same-rate project-to-equity reconciliation

ComponentExtensionPermitted repowering
Project NPV including security at 8%16.1016.01
Interest / fee tax benefit NPV at 8%0.363.68
Net financing cash-flow NPV at 8%(7.52)(3.42)
Initial unrestricted cash0.000.00
Reconciled equity NPV at 8%8.9316.26
Separate owner-hurdle equity NPV at 12%6.20(0.19)
New debt drawn0.0048.77
Minimum new regular DSCRNot applicable1.94x
New debt LLCR at sizingNot applicable1.94x
Final outstanding debt0.000.00

Cash amounts are GBP millions. The first five rows form the 8% identity; the 12% row is a separate valuation measure. Display rounding can cause a GBP 0.01m addition difference. All ratios and loan terms are hypothetical model assumptions.

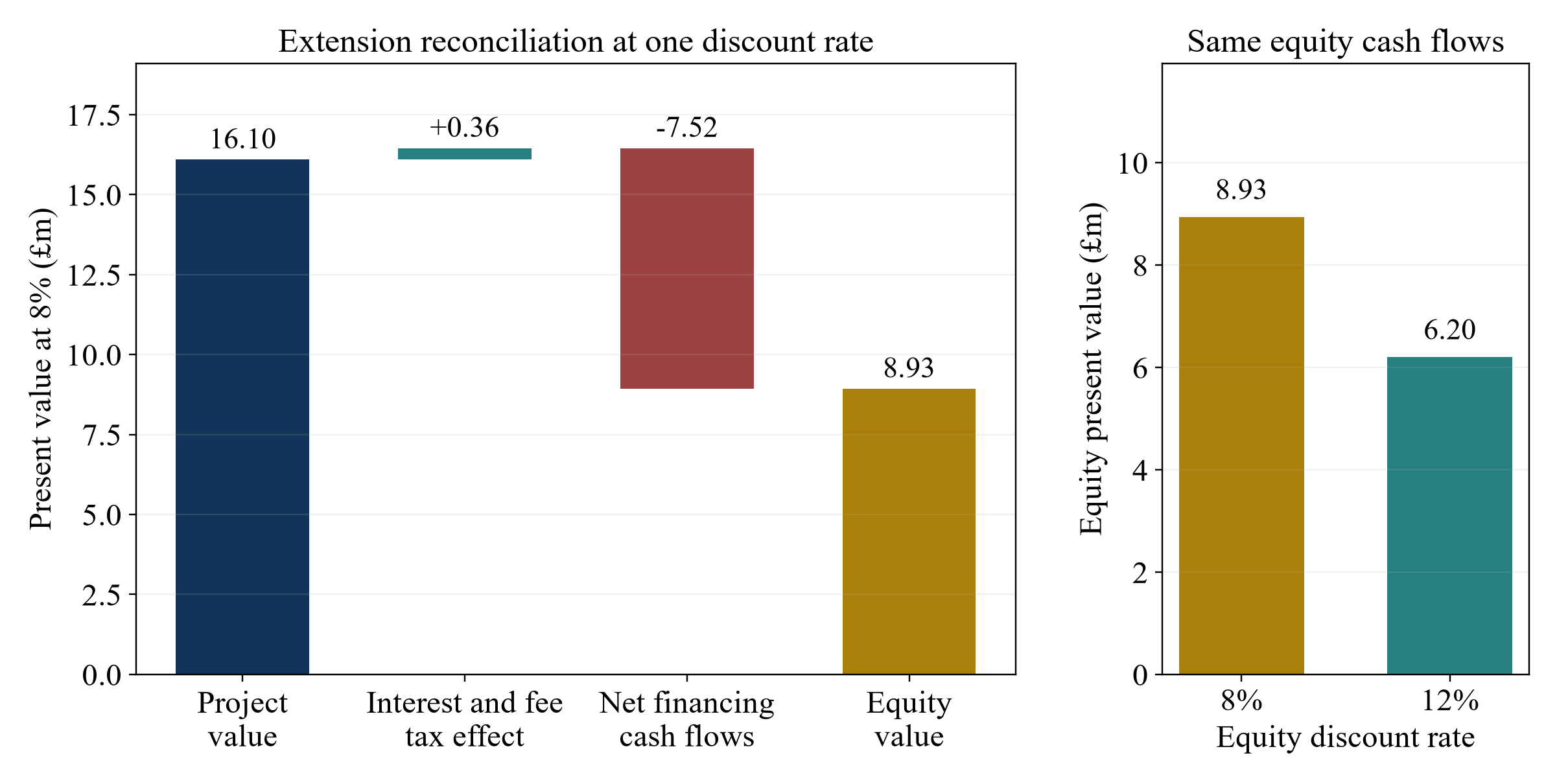

Figure 3. Project value and the shareholder cash-flow bridge
Figure 3. Project value and the shareholder cash-flow bridge
View figure at full size; scroll horizontally on smaller screens.

Hypothetical extension case. Left panel reconciles all components at 8%; right panel separately discounts the identical equity cash flows at 8% and 12%. Initial debt is repaid through financing cash flows and is not drawn again at the valuation date.

18 Security and liquidity

The example begins with £4.00 million restricted cash already funded before the valuation date. Its release remains part of project cash flow. The baseline security rule requires 50 percent of the scenario's gross nominal removal estimate, with an existing-cash floor for old plant. Repowering branches share the same security position before the permission outcome; requirements update when that outcome is known. New security is posted at first construction. Deposit interest is assumed zero.

Equation 4.

Pt = Ut − (Rt − Rt−1)R−1 = InitialRestrictedCash

In the reserve equation, R with subscript t is restricted cash held at the end of year t. R with subscript minus one is the £4.00 million already restricted before the valuation date. The reserve equation subtracts increases in restricted cash and adds releases. Posting cash collateral receives no assumed tax deduction. Gross removal expenditure is charged when the work occurs. Security release and gross removal cost remain separate cash-flow entries. The existing £4.00 million receives no separate add-back in the sale bridge.

In the permitted case, old security reaches £4.24 million and is released in year 3. New security of £9.06 million is posted that year and released in year 30. Across the separate old and new ledgers, gross deposits total £9.30 million and gross releases £13.30 million. The £4.00 million difference recovers the initially restricted asset exactly once. Gross removal payments total £26.60 million; separate salvage receipts total £4.68 million.

Table 11 changes the required security fraction while retaining the existing restricted cash. With existing security alone, permitted-repowering project NPV is £22.31 million and pre-commissioning equity calls are £38.60 million. At the 50 percent baseline, those figures become £16.01 million and £47.41 million. At 100 percent security, they become £9.45 million and £55.00 million. The timing of funded obligations materially affects this assumed case.

The owner is assumed to have a £45.00 million pre-commissioning commitment limit and an £80.00 million total-call limit. These are undiscounted nominal funding limits. Base repowering passes the stated debt-ratio tests and exceeds the pre-commissioning limit by £2.41 million. Positive annual shareholder cash is treated as distributed; subsequent shortfalls remain explicit new calls. Gross calls, maximum annual calls and peak cumulative net unrecovered equity are reported separately. NPV is not a substitute for cash available on a payment date.

Table 11. Hypothetical security and nominal owner-liquidity sensitivity

Required securityRouteProject NPVPre-COD callsTotal callsFunding
Existing security onlyExtend16.657.0011.70Pass
Existing security onlyRepower22.3138.6053.09Pass
50% future gross costExtend16.107.9711.70Pass
50% future gross costRepower16.0147.4152.85Fail
100% future gross costExtend13.2612.9512.95Pass
100% future gross costRepower9.4555.0055.00Fail

GBP millions. Existing restricted cash of 4.00 remains held in every row. Project NPV is discounted at 8%; capital calls are undiscounted nominal amounts. Funding limits are 45.00 pre-COD and 80.00 total calls. For extension, the pre-COD label denotes its initial capital phase. Gross calls assume positive annual equity cash is distributed; no recycling of earlier distributions is presumed.

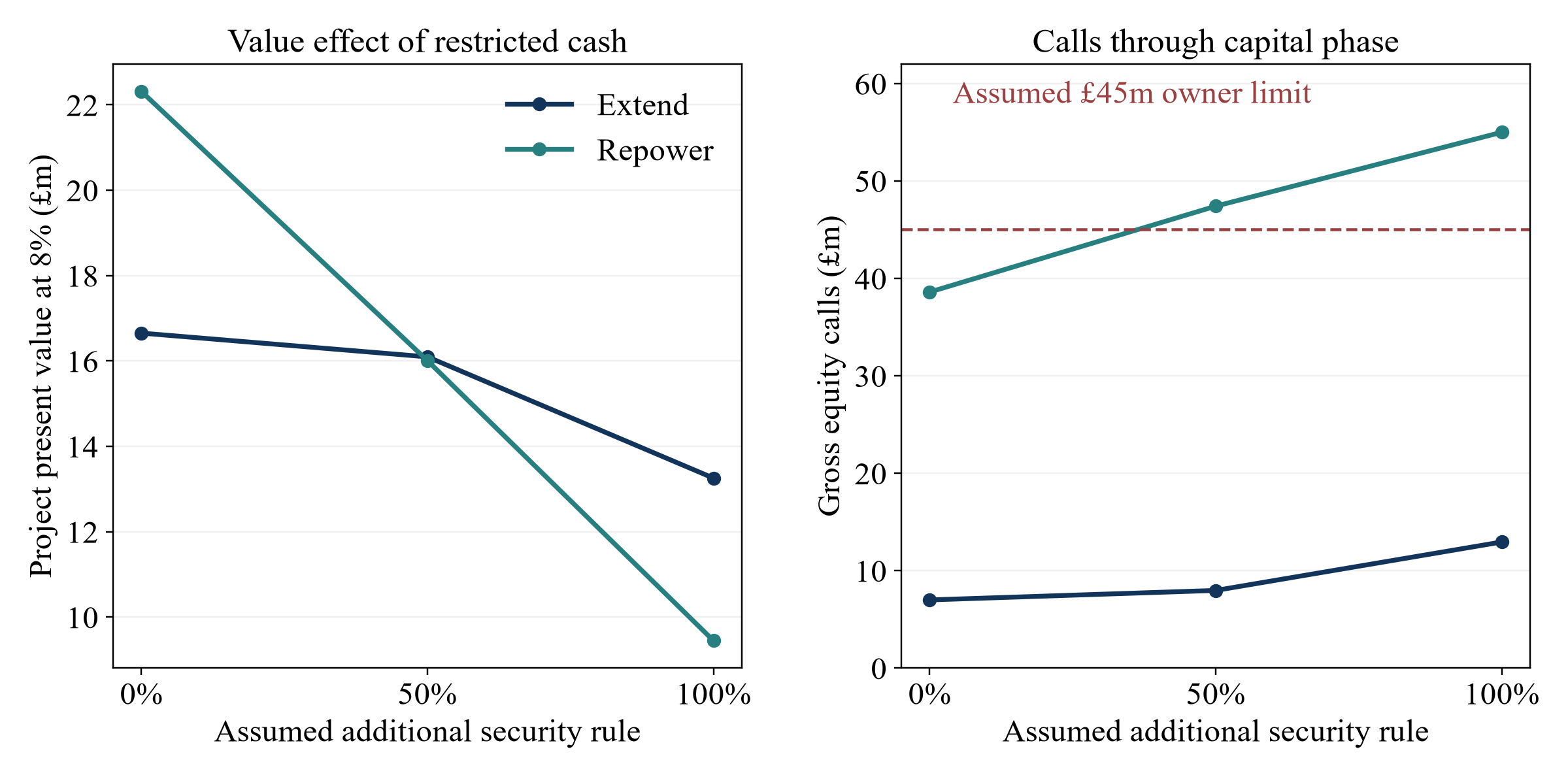

Figure 4. Security funding and available owner capital
Figure 4. Security funding and available owner capital
View figure at full size; scroll horizontally on smaller screens.

Hypothetical sensitivity. The initial £4m stays restricted until old-plant removal in all cases, including the 0% additional-security case. Percentages are modelling assumptions, not regulatory rules. Gross calls exclude recycling of distributions; the extension capital phase ends at year 0 and the base repowering capital phase at year 4.

19 Sensitivity and conditional decision

Table 12 reports incremental repowering project NPV against extension, using the same electricity-price multiplier for both routes in each cell. Its five price multipliers and five construction-cost multipliers produce 25 deterministic comparisons. At baseline price and cost, incremental value is negative £0.09 million. Reducing construction cost to 80 percent of baseline increases incremental value to £10.21 million. At 115 percent price and 120 percent construction cost, incremental value remains negative £0.43 million. Funding tests remain a separate condition.

Individual downside cases reduce project value to £0.56 million for a 30 percent construction overrun, negative £4.37 million for a 20 percent price reduction, and £2.07 million for a 15 percent new-generation reduction. The combined scenario adds a two-year delay, doubled removal costs and zero salvage. Its project NPV is negative £45.13 million; pre-commissioning equity calls reach £101.41 million. These are selected stress definitions, with no assigned likelihood.

Equation 5.

Ts = τs × max(0,A − Debt0 + Cash0 − fs − B)Seq = A − Debt0 + Cash0 − fs − Ts − L

The hypothetical transaction is a share sale priced on an enterprise-value basis. The sale notation uses A for that enterprise value, B for the assumed share tax basis, f with subscript s for seller fees and L for retained transaction-indemnity present value. T with subscript s is the hypothetical seller tax, at rate tau with subscript s. Debt and unrestricted cash are measured at completion. S with subscript eq denotes net seller equity proceeds.

Table 13 distinguishes sale price, shareholder proceeds and buyer underwriting. An assumed £15.00 million enterprise-value offer becomes £5.56 million seller proceeds after £8.00 million debt repayment, £0.80 million fees, £0.24 million hypothetical share-gain tax and £0.40 million transaction-only indemnity PV. Future project cash flow belongs to the buyer. The seller's break-even assumed enterprise value against the £6.20 million extension-equity value is £15.82 million under these tax and fee assumptions.

At the hypothetical buyer's 7 percent rate, the conditional extension bid ceiling after acquisition fees is £16.76 million. The successful-repowering ceiling is £24.25 million; permission failure requiring closure gives £1.67 million. Each ceiling identifies its underwriting state. Successful permission cannot be treated as certain before resolution. The model computes no probability-weighted bid or real-option premium. A board can use the outputs to identify evidence, funding and contract conditions requiring resolution before an irreversible commitment.

Table 12. Hypothetical incremental repowering project NPV: price and construction cost

Common price factorCapex 0.80xCapex 1.00xCapex 1.20xCapex 1.40xCapex 1.60x
0.70x(9.75)(20.06)(30.38)(40.72)(51.08)
0.85x0.25(10.05)(20.35)(30.66)(40.97)
1.00x10.21(0.09)(10.39)(20.68)(30.98)
1.15x20.179.87(0.43)(10.72)(21.02)
1.30x30.1019.819.52(0.76)(11.06)

GBP millions at an 8% project discount rate, including security. Each cell is repowering NPV minus extension NPV at the same common price multiplier. Only new construction capex receives the column multiplier. Positive incremental project value requires separate owner-hurdle and funding assessment. These factors have no assigned probabilities.

Table 13. Hypothetical seller proceeds and conditional buyer values

MeasureGBP millionsScope / condition
Assumed enterprise value15.00Hypothetical share sale priced at t=0
Existing debt repaid(8.00)Pre-existing obligation
Seller fixed and variable fees(0.80)0.50 plus 2% of price
Assumed share-gain tax(0.24)20% of positive assumed gain
Retained transaction indemnity PV(0.40)Separate from physical project removal
Net seller equity proceeds5.56Zero future seller project cash flow
Owner extension equity value6.2012% shareholder hurdle
Seller break-even enterprise value15.82Same fees, tax basis and retained exposure
Buyer extension bid ceiling16.767% conditional DCF less acquisition fees
Buyer permitted-repowering bid ceiling24.25Conditional on successful permission
Buyer failure-with-extension bid ceiling15.43Conditional supported extension fallback
Buyer failure-with-closure bid ceiling1.67Conditional forced closure
Buyer two-year-delay bid ceiling18.91Absolute new rights expire in year 29

All values are hypothetical. Buyer ceilings deduct assumed 0.20 fixed plus 1% price acquisition costs. Restricted cash is included in project scope and receives no separate seller add-back. Conditional repowering success is not a verified current price or probability-weighted option value.

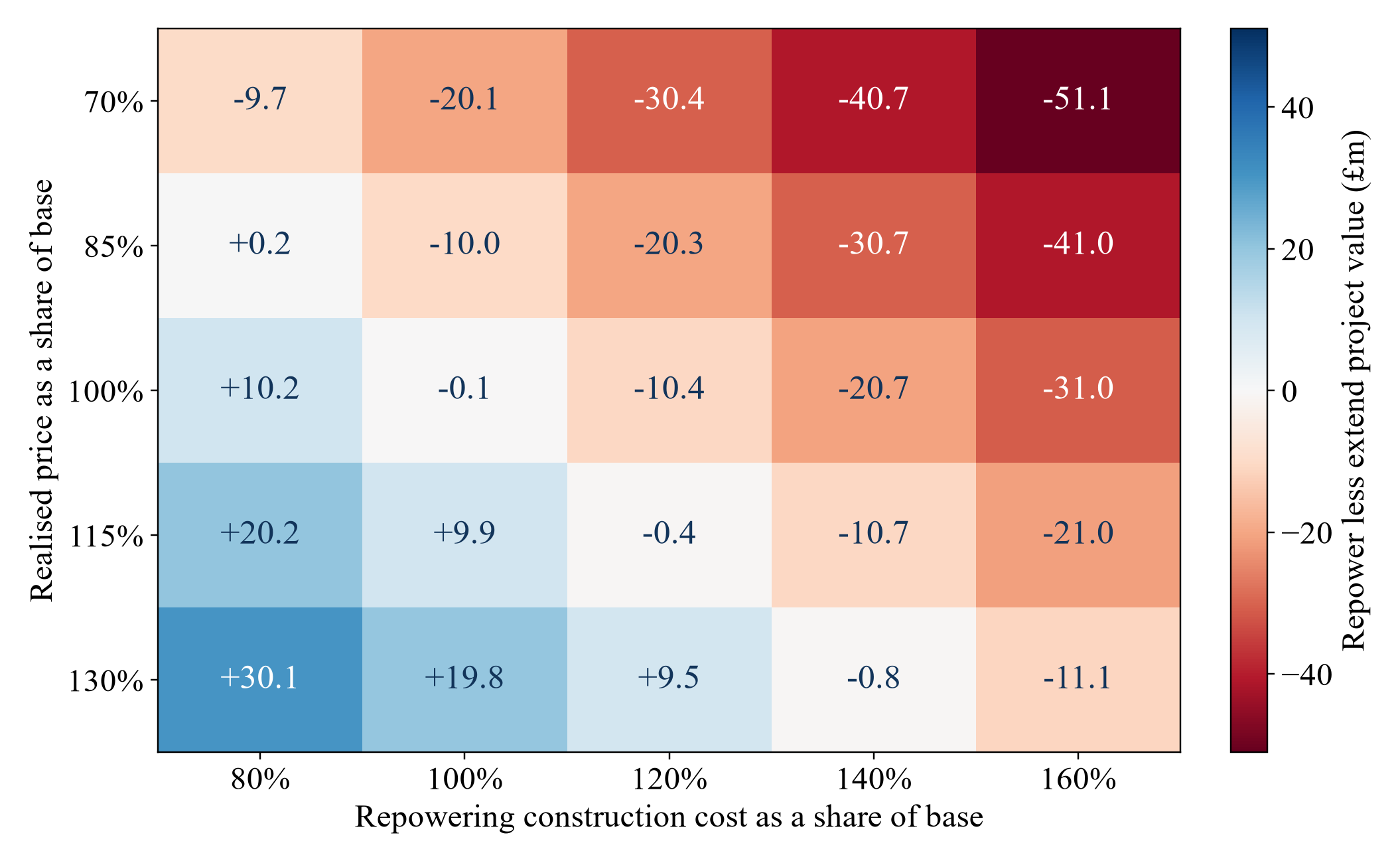

Figure 5. Conditional value from price and construction cost
Figure 5. Conditional value from price and construction cost
View figure at full size; scroll horizontally on smaller screens.

Hypothetical project values at 8%, including security and closure. Each cell compares extension and repowering at the same realised-price multiplier. Positive values favour repowering within the stated case; financing and owner funding tests require separate review.

20 Acquisition price and obligations at completion

A seller should present a reconciliation between the consideration in the sale agreement and the cash available to its shareholders. The calculation starts with the agreed transaction perimeter. An enterprise-value offer may require deductions for debt, transaction expenses and specified liabilities. An equity offer already reflects some of those items. Applying a second debt deduction to an equity offer understates proceeds. Every offer should therefore identify its valuation date, debt treatment, restricted cash treatment and assumed completion adjustments before management compares it with continued ownership.

The proposed vendor diligence pack connects each finding to a financial or contractual consequence. A blade inspection with an unresolved defect creates an engineering question, an intervention-cost estimate and a possible operating restriction. A lease that expires before the modelled operating period creates a rights question. Management should show the conditional cash flows separately from the unresolved evidence, together with the document or assessment needed to resolve each point. Any price adjustment for a defined exposure should be accompanied by the technical assessment or rights agreement needed to support the proposed operation.

Offshore decommissioning needs particular care. Under the England and Wales guidance reviewed here, a transfer of ownership does not itself release the former owner. The guidance describes approved programme arrangements, equivalent security and written government confirmation. A buyer indemnity is a separate contractual promise whose value depends on its terms and the buyer's ability to perform. Completion documentation should state whether the regulator has released the seller and identify any surviving obligations. The analysis should keep the statutory release process distinct from the parties' allocation of cost. [6]

Table 14. Proposed transaction evidence and completion controls

MatterEvidence to reviewFinancial treatmentCompletion question
Price definitionOffer and adjustment scheduleEnterprise or equity valueWhich liabilities are included?
Existing debtPayoff and release documentsDeduct once from enterprise valueCan security be discharged?
Operating rightsConsent, lease and grid agreementsLimit cash flows to supported rightsAre transfers and changes approved?
Technical conditionInspection, assessment and intervention scopeCapex and outage sensitivityWho bears unresolved defects?
DecommissioningProgramme, security and release correspondenceGross liability and restricted cashIs the seller expressly released?
Conditional paymentTrigger, measurement and enforcement termsSeparate future conditional proceedsWho controls the trigger?

Author's analytical checklist. Requirements depend on the project's jurisdiction, agreements and transaction structure. The offshore release and Scottish security entries draw on the cited guidance. [6; 12]

21 Partnership and conditional development proceeds

An owner may retain exposure to a repowering project through a partnership, a minority interest or conditional sale proceeds. These structures deserve their own cash-flow schedules. A retained stake requires assumptions about future equity subscriptions, dilution, governance and distributions. A payment linked to consent or commissioning requires a definition of the triggering event, a payment date and remedies when development is delayed or abandoned. Adding the maximum possible payment to cash consideration treats a contingent claim as immediately available money.

Management can compare such an offer using a fixed upfront receipt and separately displayed conditional outcomes. This paper supplies no observed bids or empirical probabilities for consent or construction. A board using probability weights would need to document their source, explain who reviewed them and show the unweighted outcomes alongside the expected value. An owner facing a near-term liquidity requirement also needs the actual timing of receipts. A large future payment may provide little funding for an obligation due at completion.

The partnership agreement should connect economic exposure to decision rights. Relevant questions include who can approve a revised layout, select the turbine supplier, increase the budget, refinance, abandon an application or sell the development. Cost-overrun contributions, default remedies and related-party procurement can change the economics of a minority interest. The seller should test a delayed project and a terminated project using the agreement's proposed terms. The resulting analysis can identify a minimum upfront payment, an acceptable contribution cap or a requirement for additional security; those are transaction-specific negotiating positions, with no universal amount established here.

22 Evidence programme and board decisions

The work programme should follow the dependencies that determine whether an option is available. Management first defines the asset and liability perimeter and assembles the operating records. The technical adviser then scopes the remaining-life assessment and identifies missing evidence. Legal advisers review the relevant consent, land, grid and contractual rights in parallel. Neither workstream should silently adopt the other's assumed end date. A common expiry register lets the project model use a supported operating horizon and exposes any period that depends on a future approval.

The next board decision concerns limited development expenditure. The submission should explain which uncertainty the expenditure addresses, what evidence it should produce and what management will do if the answer is adverse. For example, a connection study may establish whether the proposed export arrangement is technically available, while an inspection may narrow an intervention scope. The model should show the amount at risk before these findings arrive. A board can then approve the next defined work package without treating the whole repowering investment as committed.

Before construction commitment, management should reconcile the current engineering design, permissions, supplier terms, operating outage, finance assumptions and removal programme. Named advisers should review the relevant evidence within their own scope. Unresolved conditions should remain visible in the decision record with their possible cost, timing and exit consequences. After commitment, reporting should compare actual spending, generation interruption and approvals with the accepted baseline. A material change should trigger a fresh option comparison using the remaining choices at that date.

Any generic timetable used for this process is a management planning assumption. The Ofgem T-6 and T-5 reviews described earlier are a specific offshore transmission process tied to the initial revenue stream. They do not establish a universal deadline for an onshore owner or another jurisdiction. [4]

23 Limitations and evidence needed for an asset decision

No farm-specific engineering certificate, operating dataset, consent, lease, grid agreement, PPA, debt document, removal quotation or binding purchase offer was supplied for this study. The numerical cases are hypothetical and illustrate calculation and decision methods. Their input levels are not cost benchmarks, market valuations, financing offers or forecasts. Changing a project's output, contract structure, tax position, rights, financing or closure requirements may change both the ranking and the ability to fund an option.

The public DNV standard synopsis supports its stated scope; the complete standard was not inspected. The DESNZ study combines literature, interviews and modelling, and its reuse assumptions contain stated evidence limitations. The Muel example is an attributed operator disclosure. The current German provisions were checked on 11 October 2026. European directive provisions require national implementation and project-applicability checks. These sources provide context for the decision method, without determining an unnamed farm's remaining technical life or granting it permission to operate. [1; 2; 11; 7; 9]

Tax in the numerical model follows explicit simplified assumptions. Actual deductibility, capital allowances, loss relief, interest restrictions, asset or share disposal treatment and transfer taxes require jurisdiction-specific advice. The financing illustration also omits contractual features unless expressly included in its assumptions. A financing decision needs an agreed term sheet and a fully reviewed project model.

24 Conclusion

A wind farm's next ownership and investment decision should begin with a supported operating horizon and a defined allocation of obligations. Extension depends on an acceptable technical assessment, maintainability and continuing rights. Repowering also depends on a deliverable development and construction programme whose additional output can support its capital cost and interruption of existing cash flow. A sale depends on the consideration actually payable, completion adjustments and the liabilities that remain with the seller.

The numerical comparison should keep these pathways on a common valuation date, carry each to an explicit closure outcome and show project cash flow separately from financing and shareholder proceeds. Restricted security has a funding date and a release condition. Removal expenditure has a scope and an owner. Conditional development receipts have a trigger and may arrive late or fail to arrive. Recording those items explicitly gives a board a clearer basis for choosing the next assessment, investment or transaction step.

For an actual asset, the decision remains conditional until the relevant engineering, legal, commercial and financing evidence has been reviewed. The practical output is an executable next action with its cost, responsible party, decision date and adverse-outcome response recorded.

References

  1. DNV. DNV-ST-0262 Lifetime extension of wind turbines. Edition 2016-03; amended 2021-11. https://www.dnv.com/energy/standards-guidelines/dnv-st-0262-lifetime-extension-of-wind-turbines/. Locator: Public synopsis beneath the edition date; Objectives list. Accessed 11 October 2026.
  2. UK Department for Energy Security and Net Zero. Lifetime extension, reuse and material recovery opportunities for onshore and offshore wind assets. 2026-07-30. https://assets.publishing.service.gov.uk/media/6a5f8a530dd52549f5f96c83/lifetime-extension-reuse-material-recovery-opportunities-for-onshore-and-offshore-wind-assets.pdf. Locator: PDF pp.35-36; section 2.1.1.2; PDF p.35; spare-parts stakeholder findings; PDF pp.107-108; reuse assumptions and empirical limitations. Accessed 11 October 2026.
  3. UK Department for Energy Security and Net Zero. National Policy Statement for renewable energy infrastructure (EN-3), 2025. 2026-01-06. https://www.gov.uk/government/publications/national-policy-statement-for-renewable-energy-infrastructure-en-3-2025/national-policy-statement-for-renewable-energy-infrastructure-en-3-2025-accessible-webpage. Locator: Sections 1.4 and 1.6; geography and statutory scope; Paragraphs 2.8.74-2.8.75; offshore wind repowering; Paragraphs 2.12.11-2.12.15; network capacity; Paragraphs 2.12.36-2.12.38; consent expiry and removal; Paragraphs 2.12.43-2.12.45; onshore repowering. Accessed 11 October 2026.
  4. Ofgem. Offshore Transmission: Guidance for Health Reviews. 2024-11-14. https://www.ofgem.gov.uk/sites/default/files/2024-11/Guidance_health_reviews.pdf. Locator: Paragraph 2.1; PDF p.8; Paragraphs 2.7-2.8; PDF p.9; Paragraph 3.1; PDF p.12; Appendix rights and decommissioning items; PDF p.36. Accessed 11 October 2026.
  5. Ofgem. Extension of Tender Revenue Stream (EoTRS) and Tender Revenue Periods. 2025-07-10. https://www.ofgem.gov.uk/sites/default/files/2025-07/Decision-Doc-April-2025.pdf. Locator: Cover; publication date; Paragraph 1.3; PDF p.7; Paragraph 1.5; PDF p.8. Accessed 11 October 2026.
  6. UK Department for Business, Energy and Industrial Strategy; Department for Energy Security and Net Zero publication page. Decommissioning of offshore renewable energy installations under the Energy Act 2004: guidance notes for industry. Updated 2019-03-21; landing page first published 2011-01-07. https://assets.publishing.service.gov.uk/media/5f5b2724e90e0718e212a22d/decommisioning-offshore-renewable-energy-installations-energy-act-2004-guidance-industry__1_.pdf. Locator: Paragraphs 5.7.7-5.7.9; PDF p.20; Paragraphs 5.7.12-5.7.15; PDF p.21; Paragraph 8.7; PDF p.31. Accessed 11 October 2026.
  7. German Federal Ministry of Justice and Federal Office of Justice; Gesetze im Internet. Bundes-Immissionsschutzgesetz §16b: Repowering von Anlagen zur Erzeugung von Strom aus erneuerbaren Energien. https://www.gesetze-im-internet.de/bimschg/__16b.html. Locator: Paragraphs 1-2; Paragraph 4; Paragraph 10. Accessed 11 October 2026.
  8. German Federal Ministry of Justice and Federal Office of Justice; Gesetze im Internet. Baugesetzbuch §35: Bauen im Außenbereich. https://www.gesetze-im-internet.de/bbaug/__35.html. Locator: Paragraph 1(5); Paragraph 5. Accessed 11 October 2026.
  9. European Parliament and Council of the European Union; EUR-Lex. Directive (EU) 2023/2413 amending the Renewable Energy Directive and related legislation. 2023-10-18. https://eur-lex.europa.eu/legal-content/EN/TXT/?uri=OJ:L_202302413. Locator: Amending text introducing Article 16c(1); Article 16c(2). Accessed 11 October 2026.
  10. Offshore Renewable Energy Catapult. Pioneering testing suggests route to significant life extension for turbine blades. 2025-09-16. https://ore.catapult.org.uk/media-centre/press-releases/pioneering-testing-suggests-route-to-significant-life-extension-for-turbine-blades. Locator: Paragraphs identifying 20 years of onshore blade operation; Physical testing and accelerated loading paragraphs; Conclusion and RWE intended application. Accessed 11 October 2026.
  11. RWE Renewables Europe & Australia. Zero-waste repowering: RWE commissions its Muel wind farm in Aragon. 2025-12-10. https://www.rwe.com/en/press/rwe-renewables-europe-australia/2025-12-10-zero-waste-repowering/. Locator: Opening commissioning and configuration paragraphs; Innovative solutions for circularity and zero waste; PPA disclosure. Accessed 11 October 2026.
  12. Scottish Government; Marine Directorate. Offshore renewable energy: decommissioning guidance for Scottish waters; chapter 9 Financial security. 2022-08-02. https://www.gov.scot/publications/offshore-renewable-energy-decommissioning-guidance-scottish-waters/pages/9/. Locator: Paragraph 9.6; Paragraph 9.8; Paragraphs 9.10-9.14. Accessed 11 October 2026.
  13. DNV. Wind farm life-extension. https://www.dnv.com/services/wind-farm-life-extension-5383/. Locator: In-depth capability; Tailor-made service. Accessed 11 October 2026.
  14. DNV. Wind turbine inspections. https://www.dnv.com/services/wind-turbine-inspections-3845/. Locator: Key services: end-of-warranty/end-of-contract inspections; Due diligence inspections; Life extension inspections. Accessed 11 October 2026.

About the Author

Chennakeshav (CK) is a corporate finance and investment banking executive with 25+ years of global experience in deal origination, structuring and execution across M&A, growth capital and corporate strategy. He has led value-creation mandates for founders, corporates and funds — bridging the boardroom view to hands-on execution and close.

His career spans Morgan Stanley, HSBC, Lloyds Banking Group, EWEC, ADQ portfolio companies and Emirates Growth Fund, across TMT, real estate, fintech, deeptech, cleantech, infrastructure and energy. He has partnered with C-suite leaders, private equity and venture funds, sovereign wealth funds and family offices to finance complex fund raises and scale-up ventures, and has led M&A due diligence, post-merger integration and business-transformation initiatives to create value.

At Matchpoint Partners he is Managing Partner, leading the firm's corporate finance, M&A and capital-raising practice. He holds an MBA from London Business School, an engineering degree from VTU and a Master of Laws (LLM, in progress) from UCL London.

An active start-up mentor, CK mentors at Techstars, DIFC FinTech Hive, Startup Grind, Founder Institute and IN5, serves as Entrepreneur Mentor in Residence (EMiR) at London Business School, and judges the Entrepreneurship World Cup.

https://www.linkedin.com/in/ckadya/

https://www.matchpoint-partners.com/team/ck-adya.html

Disclaimer

This paper is part of a continuing series on the structure of private and alternative markets. The views expressed are the author's own. The paper is for information only, describes market structure in general terms, and does not constitute investment, legal, tax or regulatory advice or a recommendation in respect of any security, vehicle or counterparty.

Questions, answered

The Second Life of a Wind Farm: frequently asked questions

The owner needs an assessment covering the intended configuration and additional operating period, together with the interventions, restrictions and continuing rights on which operation depends. The proposed framework reviews technical condition, supportability, revenue and funding together. An illustrative duration in a model supplies no engineering permission.

The proposed configuration needs a jurisdiction-specific consent and connection review. EN-3's specified wind provisions address new repowering applications, while the German and EU examples have their own scope and conditions. An existing agreement should be examined against the revised use before assigning value to retained infrastructure. [3; 7; 9]

Restricted cash has a deposit date and release condition. Gross removal expenditure has its own scope and payment date. The model records both, with any salvage receipt separately identified. This allows the owner to see funding needs and avoids treating restricted money as freely distributable cash.

The comparison should identify whether an offer is enterprise or equity value, then reconcile the specified debt, cash, fees, tax and retained obligations once. Conditional payments need separate timing and trigger assumptions. The hypothetical sale in this paper is an analytical example; no actual bid was verified.

The model carries separate failure-with-extension and failure-with-closure cases. Its delay case retains the same absolute rights-expiry year, so later commissioning leaves fewer operating years. Actual fallback rights, technical suitability, costs and funding would need supporting project evidence.

Every numerical input is hypothetical. The cases explain the method, including full-life cash flows, security, debt and liquidity. Actual valuation and financing require project records, independent assessments, applicable tax advice, current commercial terms and agreed financing assumptions.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.
