Debt · Wind and Offshore Energy

Who Carries the Wind Shape? Basis, Volume and Credit Risk in Corporate PPAs

A bankability framework for allocating wind-generation and corporate-offtaker risks across the PPA, financing model and operating controls.

Who Carries the Wind Shape? Basis, Volume and Credit Risk in Corporate PPAs
Quick answer

Decompose volume, shape, basis, imbalance and corporate-credit exposure; model the resulting cash flow and align the PPA, collateral package and debt case.

Abstract

Corporate wind power purchase agreements allocate generation, delivery-profile, price-reference and counterparty exposures through different payment mechanisms. This paper develops a framework for tracing those obligations into project cash flow, debt capacity, reserve funding and dated liquidity needs. It addresses sponsors, corporate procurement teams and project-finance lenders assessing a proposed wind offtake arrangement.

The analysis reviews fourteen institutional and official references and constructs a transparent 100 MW example. Four product/reference combinations are evaluated using two deterministic annual scenarios, five financing equations and a separate dated credit-stress exercise. Generation, prices, costs, loan terms and recovery dates are authored hypothetical assumptions. They contain no empirical calibration, generation percentile or default probability.

In the stated adverse scenario, annual cash available for debt service is $10.1474m under pay-as-produced/node settlement and $0.0296m under baseload/buyer-reference settlement. The specified twelve-year annuity method supports approximately $65.442m and $0.191m debt respectively. Sources and uses include the reserve required by each sized debt amount. The independent liquidity exercise reaches an $8m unrestricted cash deficit before any permitted reserve draw.

The framework connects each calculated difference to a contract term, evidence requirement and funding decision. It distinguishes production-dependent revenue, profile mismatch, reference basis, restricted collateral and collected cash. Jurisdiction, accounting, credit support and environmental claims require transaction-specific confirmation. The results apply solely to the stated assumptions; they establish no market price, actual financing offer or universally preferred PPA.

JEL Classification: G32, G33, L94, Q42, Q48

Keywords: corporate PPA, wind power, shape risk, basis risk, volume risk, credit support, project finance, debt sizing, collateral, liquidity

This Matchpoint Insight presents the web edition of Matchpoint Partners' research. The supporting paper contains the full framework, structures, worked examples and source material.

Register Before Download   Explore our Renewable Energy & Infrastructure Financing practice

1 The financing decision inside the wind contract

A corporate wind power purchase agreement connects a variable physical asset with a buyer's procurement objective and a project's debt-service calendar. The contract specifies a price, a quantity rule, a settlement reference and a set of obligations extending through ordinary operations, credit deterioration and early termination. A financing review should examine these elements together. Each changes the amount, timing or recoverability of cash available to the project company.

The institutional literature provides a foundation for this review. NREL explains the separate physical sale and difference settlement in a financial PPA, including exposure arising when generation and consumption occur in different markets. The EIB's commissioned market study identifies tensions between buyer business cycles, creditworthiness, price-risk appetite and generator financing requirements. ACER's official resources distinguish available contractual templates by jurisdiction and conclude that additional voluntary templates were unnecessary following its 2024 assessment. These sources establish mechanisms and contracting context; they provide no underwriting conclusion for an individual wind farm.[1,7,8]

This paper proposes a transaction-analysis framework built around the route from metered output to collected revenue. Its contractual recommendations are structuring considerations for project-specific assessment. The numerical cases are constructed examples with stated assumptions. They do not describe observed prices, actual loan terms, client transactions or future market performance. Legal, technical, tax, accounting and credit opinions remain necessary for a proposed financing.

Begin the commercial discussion with a precise statement of the buyer's objective. Annual renewable procurement, wholesale price hedging, retail budget stability and matching an operating load create different obligations. Then state the project's financing objective: the required operating term, debt maturity, expected cash-flow distribution and permitted residual market exposure. Negotiation can proceed by identifying the services needed to connect those objectives, their contractual providers and the capital required to support them.

The investment committee's working question should be practical: which cash flows remain exposed after every PPA settlement, route-to-market charge, certificate obligation and credit-support requirement has been applied? A useful submission would attach an interval-level settlement example, an annual financing bridge and a cause-based risk matrix. Where evidence is incomplete, the submission should identify the unresolved exposure and withhold the associated financing conclusion. That discipline gives the commercial team a clear basis for pricing a requested allocation and gives lenders a traceable route into the downside model.

2 Give each risk a measurable definition

Volume risk needs two separate descriptions. The seller's revenue depends on how many eligible megawatt-hours the wind farm produces. The buyer's procurement position depends on how those megawatt-hours compare with its required consumption. A pay-as-produced contract can leave the buyer procuring replacement electricity in a low-output period while the seller receives less total revenue. Both parties therefore retain an exposure to weather, expressed through different cash flows. The Commission's 2026 recommendation describes pay-as-produced quantity and profile exposure from the offtaker's perspective.[6]

For this framework, shape means the difference between interval production and the contracted or required interval profile. Basis means the price difference between the location or index where physical energy is monetised and the location or index used in the PPA. Capture price is the output-weighted market price. Imbalance concerns the deviation between the position submitted into the market and the position subsequently measured. Curtailment concerns available production that an instruction, constraint or contractual dispatch choice stops from becoming metered export.

These working definitions should appear beside the actual calculation inputs. A monthly energy shortfall belongs in the volume calculation. An interval shortfall against a flat obligation belongs in the shaping calculation even when annual production equals annual contracted energy. A lower node price belongs in the location bridge. A difference between day-ahead and real-time valuation needs its own time-reference bridge. Combining these effects into one unexplained discount makes it difficult to identify the clause that changes the loss.

The model team should prepare a dependency map before selecting stresses. Use the same timestamp and weather case when calculating generation, reference prices and replacement purchases. Examine a high-output period with weak local prices, a low-output period with expensive replacement energy, and a constrained-network period with both reduced export and adverse location spreads. These are proposed stress combinations; their probabilities and severity require project evidence. The purpose is to expose the contractual transmission of each event into cash flow.

Table 1. Working risk definitions and the evidence needed to allocate them

ExposureMeasured differenceRelevant unitDrafting decisionFinancing evidence
Seller volume revenueActual versus forecast eligible outputMWh per debt-service periodProduction basis and exclusionsIndependent energy assessment
Buyer procurement volumePPA quantity versus loadMWh per consumption periodReplacement purchasing responsibilityVerified load profile
ShapeProduction versus promised interval profileMWh per intervalDelivery bands and firming obligationJoint price-output series
Location basisPhysical price versus PPA referenceCurrency per MWhNode, hub or zone referenceComparable location-price history
ImbalanceNominated versus metered positionMWh per settlement intervalScheduling and pass-throughBalancing service terms
CurtailmentAvailable versus permitted productionMWh by causeDeemed-energy eligibilityInstructions and availability records
CreditRecoverable support versus exposureCurrency at valuation dateCollateral and default mechanicsObligor and guarantor assessment

Proposed analytical taxonomy; contractual definitions and market rules govern each transaction.

3 Trace physical energy and financial settlement separately

The physical-delivery route determines who takes title, who schedules energy and who interfaces with the relevant market. The financial route determines which party pays when the reference price moves above or below the strike. In NREL's description of a financial PPA, the generator sells into the wholesale market and separately settles the difference with the corporate buyer. The buyer's electricity supply remains a separate arrangement.[1]

Consider a constructed interval with production Q, physical price N, reference price H and strike K. Assume every produced unit is eligible, the same quantity is used for both legs, and there are no charges or exclusions. Physical revenue is Q multiplied by N. The difference settlement received by the project is Q multiplied by K minus H. Their sum is Q multiplied by K plus N minus H. This algebra identifies the residual location spread. Its result depends on the stated quantity and eligibility assumptions; an annual-average reference, fixed contract volume or excluded negative-price interval changes the calculation.

The buyer's review should add the separate retail bill. Suppose its supplier charges a consumption-weighted market component and network, service and tax charges. A financial settlement tied to wind generation and a wholesale index must be mapped against each component. Record the buyer's retained load mismatch, location mismatch and non-energy charges. Any claim of budget protection should identify the specific component and quantity to which the protection applies.

A sleeve introduces another contractual layer. The diligence package should state which licensed entity receives generation, which entity supplies the load, how residual electricity is purchased and how balancing fees are calculated. Require examples of an excess-output interval, a shortfall interval and a negative-price interval. Compare the sleeve's notice periods and termination rights with the longer PPA obligations. A review should separately cost the operational handover and replacement of the sleeve.

For project financing, compile a cash-flow ledger with the market sale, corporate settlement, service charges, attribute proceeds and collateral movements on distinct lines. Record invoice dates, payment dates and permitted set-off. This allows treasury to test liquidity between settlement and collection and allows lenders to identify which receipts are available under the financing waterfall.

Table 2. Delivery routes and the resulting financing questions

RoutePhysical energy arrangementCorporate payment referenceService dependencyResidual review
Direct physical PPADefined generator-to-buyer deliveryAgreed delivered quantity and priceScheduling and grid accessDelivery point and losses
Sleeved physical PPASupplier receives and resuppliesPPA price plus sleeve termsSupplier and balancing providerSleeve fee and replacement
Output-linked financial PPAProject sells into wholesale marketStrike minus index times eligible outputMarket-access providerLocation and index mismatch
Fixed-volume financial PPAProject sells actual outputStrike minus index times fixed quantityReplacement market liquidityQuantity mismatch and collateral

Structures are simplified analytical descriptions. Licensing and market participation require local review.

4 Design quantity obligations around the evidence

Pay-as-produced gives the project a settlement quantity linked to eligible generation. The financing model should retain the full distribution of production-dependent revenue. Availability commitments, exclusions, minimum-delivery clauses and damages can add separate obligations. Review each on its own measurement period and cause. An availability promise should define the machinery or capability being measured, the permitted outage treatment and the records required to distinguish weather from controllable performance.

A baseload commitment specifies a quantity in every agreed interval. A shaped commitment specifies another profile, such as time-of-day blocks or a buyer's nominated schedule. The Commission's 2026 recommendation identifies the shift of profile and balancing exposure towards a generator or intermediary in these arrangements.[6] For the project model, represent the promised profile as an interval series. Compare it with available output before calculating excess sales and shortfall purchases.

In a constructed example, suppose a project promises 10 MWh in each of two intervals and produces 15 MWh followed by 5 MWh. Total output and total promised energy both equal 20 MWh. The project still needs to monetise a 5 MWh surplus in the first interval and cover a 5 MWh shortfall in the second. If the two relevant prices are 20 and 100 currency units per MWh, the combined adjustment is 100 received less 500 paid, or a 400-unit cash cost. Charges, losses and trading restrictions are excluded. The example shows the calculation that annual netting would conceal.

Volume bands can be assessed by defining the lower and upper eligible quantities, the reconciliation period, the settlement price outside the band and any carry-forward right. Test the edges of the band explicitly. A one-unit movement across a threshold should produce the economic effect intended by the drafting. If banking is permitted, maintain a dated balance and calculate expiry, priority of use and settlement following termination.

Firming through a separate service should be presented as a defined purchase of risk capacity. Ask the provider to specify covered intervals, volume limits, exclusions, price escalation and support obligations. The project review should then examine provider failure during a stressed replacement period. Any diversification benefit claimed by an intermediary requires evidence of joint production and load behaviour. Geographic separation alone supplies no quantified financing benefit.

5 Locate every price reference and its fallback

FERC explains that locational marginal prices in US organised markets contain energy, congestion and loss components. A price at one point can therefore differ from a price elsewhere on the network.[2] A corporate PPA that links its difference settlement to a hub while physical sales occur at a node needs a separately measured node-to-hub exposure. Similar analytical work is needed for different bidding zones, trading intervals or settlement methodologies, using the rules of the relevant market.

The contract schedule should identify the price publisher, market, product, settlement interval, currency and time convention. State whether the reference uses day-ahead prices, real-time prices or another calculation. Define how revised prices affect an already-issued invoice. Where a monthly weighted average is used, identify the weights and demonstrate the result with an interval-level example. Any mismatch between the physical sale and contractual valuation should have an explicit owner in the financing bridge.

Historical analysis should preserve distributions and timing. Review spreads during high-output hours, grid outages and constrained-export periods. Record the date range, missing-data treatment and changes to market boundaries. Forward assumptions should be labelled by provenance: quoted market data, independent modelling or a management estimate. A proposed grid upgrade should enter a scenario with its evidence and timing conditions. Its expected benefit should remain identifiable if the upgrade is delayed.

Available hedging instruments require a separate due-diligence line. Test tenor, volume, location, collateral and settlement alignment with the PPA. A congestion instrument may cover a particular spread while leaving losses, real-time deviations or generation mismatch. The paper's proposed analysis treats each uncovered component as a residual exposure. Confirm actual instrument availability and eligibility with the relevant operator and trading counterparties before incorporating its benefit.

For benchmark disruption, prepare an ordered fallback hierarchy with objective triggers. Address temporary missing publication, permanent discontinuation, market splitting and currency change separately. Compare candidate replacement indices against the original economic relationship. A valuation expert can be assigned a defined mandate, evidence standard and timetable. Model cash flow during the dispute period so that a technically workable fallback also has a funded payment path.

Table 3. Price-reference choices and the mismatch each requires the parties to measure

PPA referencePhysical sale referenceMismatch to modelEvidence requiredContract control
Same node and same intervalSame node and intervalFees and eligibility exclusionsSettlement statementsQuantity reconciliation
Regional hubProject nodeNode-to-hub price spreadMatched location pricesExplicit basis owner
Neighbouring zoneProject bidding zoneCross-zone spreadZone prices and access rightsZone-change mechanism
Day-ahead indexReal-time realisationTiming spread and deviationsScheduled and actual positionsTiming allocation
Monthly averageInterval salesWeighting differenceComplete interval seriesExact averaging formula

Proposed comparison; no market liquidity or hedge availability is assumed.

6 Model capture prices and negative-price clauses together

For the proposed analysis, calculate capture price as total market revenue divided by eligible generation over the same period. Compare it with the relevant time-weighted reference using consistent intervals and missing-data treatment. This distinguishes the price received during production from a general market average. Then apply the PPA settlement. Under the simplified same-reference, same-quantity algebra in Section 3, market revenue and the difference settlement combine into strike-linked revenue for eligible units. Exclusions and quantity mismatches need separate calculations.

ACER's 2025 monitoring report presents qualitative cases in which difference contracts continuing to pay the strike at negative prices encourage generation despite surplus conditions. It recommends clear negative-price allocation in private PPAs. Its figures are analytical examples.[5] Their relevance to underwriting is the need to model the exact trigger and resulting dispatch incentive. They supply no observed negative-price duration for a proposed project.

Prepare a clause test using an isolated negative interval, successive negative intervals, zero price, a brief positive interruption and a price correction after invoice issue. Specify whether the trigger applies to project price or contract reference. Record whether settlement stops immediately, after a duration threshold or after an annual allowance. Identify who can instruct shutdown and who bears restart costs, minimum operating constraints and associated imbalance. Test how the same instruction affects certificate delivery and availability calculations.

A constructed case can compare two possible contract designs without asserting market practice. Assume ten eligible MWh, a strike of 70 and a reference price of minus 10 currency units per MWh. A full difference settlement is 800 and the physical sale at the same price is minus 100 currency units, leaving 700 before costs. If the contract instead suspends the difference settlement, continuing to produce yields minus 100 before costs. Curtailing yields no metered sale in the simplified example; any deemed-energy payment requires a separate express assumption. This arithmetic clarifies why dispatch rights and payment rules need to be examined together.

The financing report should separate gross negative-price exposure, contractual relief, foregone production and operational cost. Review potential double counting where a market-price curve already incorporates low-price production hours and a further capture discount is proposed. State the purpose of each adjustment. The sponsor and lender can then discuss which risk remains in debt sizing and which risk is transferred through a separately priced service.

7 Connect balancing responsibility to operational control

Elexon's guidance describes Great Britain's comparison of contracted and metered energy within settlement periods and the charges applied to deviations. It explains that System Buy and System Sell prices are calculated as a single price for each period. These are GB arrangements.[3] EU Regulation 2019/943 separately sets out balance responsibility and delegation, subject to specified derogations.[4] A transaction in another jurisdiction requires the corresponding market rules and participant agreements.

The contract review should identify the entity that submits forecasts, the entity that trades revisions and the entity whose settlement account receives imbalance charges. Assign responsibility for the data each entity needs and the deadlines it must meet. Document authority to act when forecasts change, communications fail or the corporate buyer changes its schedule. An operational-control map is useful because a commercial payment obligation can depend on an action undertaken by a separate service provider.

A fixed balancing fee can be assessed against its exclusions and renewal rights. A capped fee needs a defined cap period, eligible cost category and treatment of cumulative losses. A pass-through arrangement needs supporting records, an audit procedure and a timetable for challenging disputed charges. In every case, reproduce the calculation using a normal interval and an interval with a forecast revision close to market closure. Require the service proposal to identify charges that remain outside its quoted fee.

For lender review, compare the service term with the PPA and loan maturities. If renewal is required, identify the next decision date, contractual exit notice and expected transition work. Test an illustrative replacement period in which fees rise, security must be posted and operational access changes. The assumed duration and replacement price should be clearly identified as modelling inputs until supported by market evidence.

The same approach applies to a shaping intermediary. Map the payment obligations that survive provider termination and the rights needed to transfer data, market registration and scheduling authority. Consider whether collateral is available for the costs that arise during the transition. A completed operating handover plan would name the project officer, service provider and lender contact for forecast exceptions, settlement disputes and emergency nominations.

Table 4. Route-to-market service terms and the controls needed for debt review

Service termProject cash exposureProvider obligationEvidence for reviewReplacement issue
Fixed feeQuoted fee plus exclusionsAbsorb defined balancing costExclusion scheduleNew fee after expiry
Cost capCharges up to specified capAbsorb eligible excessCap ledger and periodReset and carry-forward
Actual-cost pass-throughEligible realised chargesSchedule and account accuratelyMarket statements and audit trailAccess to historical records
Revenue shareVariable deduction from receiptsApply agreed revenue definitionGross-to-net reconciliationOwnership of open trades
Profile firmingFee and uncovered shortfallsDeliver specified profileInterval performance seriesSurviving delivery obligation

Proposed service comparison. Actual offers and market rules require verification.

8 Allocate curtailed production by cause and receipt

Curtailment analysis should begin with the event record: who issued the instruction, the operating condition, the affected turbines, the duration and the available production. Separate network restriction, buyer instruction, economic dispatch and project outage. Define the evidence needed for each category. This allows the contract team to connect payment eligibility with a verifiable cause and allows the financing team to estimate the time between lost output and any replacement receipt.

For EU projects, Article 13 of Regulation 2019/943 addresses redispatching, including compensation rules and qualifications. Non-market-based redispatch compensation has a specific exception for certain non-firm connection arrangements.[4] A corporate PPA therefore needs project-specific legal analysis before assuming a statutory receipt. The model should identify the beneficiary, calculation, claim procedure and timing under the applicable connection and market arrangements.

Deemed energy is a proposed contractual measurement of eligible output that was available during an affected period. The schedule should specify turbine availability, wind readings, relevant power curves and the treatment of unavailable equipment. Select fallback data before an incident occurs. Require records sufficient to reconstruct the calculation after a meter correction or disagreement over the instruction. Review the method with the independent technical adviser and test it against actual historical operating periods where available.

The payment waterfall should reconcile statutory compensation, market settlement and contractual deemed-energy amounts. Assume a constructed curtailment loss valued at 1,000 currency units and a contractual entitlement that explicitly offsets 300 units of operator compensation. The remaining contractual amount is 700 units under that assumed rule. If the agreement uses a different offset or assigns the compensation to another party, the calculation changes. The example illustrates the need to state the receipt and offset mechanism; it establishes no legal entitlement.

Credit and liquidity remain relevant after the entitlement is established. Test delayed approval, partial dispute and late collection. Record any obligation to continue debt service while the claim is unresolved. A reserve can be evaluated against this collection delay, with a separate treatment for permanent lost revenue. The financing memorandum should distinguish eligible claims, invoiced claims and collected cash. A claim that remains subject to evidence review should retain that status in the cash-flow forecast.

Table 5. Curtailment causes, measurement and receipt allocation

EventPrimary evidenceQuantity basisPotential receipt to investigateContract question
Network instructionOperator dispatch recordAvailable eligible outputRedispatch compensationRecipient and offset
Buyer-requested reductionAuthenticated buyer noticeAgreed deemed-energy formulaBuyer paymentInstruction limit and price
Negative-price shutdownReference prices and dispatch logExcluded or deemed quantityClause-specific settlementTrigger and restart cost
Turbine unavailabilityMaintenance and fault recordsUnavailable outputWarranty or insurance claimExclusion and damages
Environmental restrictionPermit condition and instructionRestricted eligible outputContract-specific allocationBaseline operating assumption

Proposed cause-based drafting matrix; compensation depends on the governing rules and executed contracts.

9 Measure counterparty exposure through the replacement period

The credit assessment should identify the legal buyer, any guarantor and the entities receiving the commercial benefit. Obtain the relevant financial statements and examine the buyer's obligation within its group structure. Record debt priorities, restrictions on guarantees and transfer rights. A brand name or group affiliation supplies no substitute for identifying the entity legally responsible for payment.

The EIB's 2022 market study identifies creditworthiness and business-cycle mismatch as constraints on corporate contracting. Its 2025 approved Pan-EU guarantee lending envelope provides an institutional example of risk sharing through acceptable intermediaries supporting midcaps and larger corporates. The stated geography includes EU countries, Norway and Iceland.[8,9] Programme approval establishes neither a proposed buyer's eligibility nor an issued guarantee. Any financing case using such support needs the individual instrument, conditions and claim rights.

The proposed credit model separates unpaid invoices, current replacement value, prospective exposure during a cure period and costs of remarketing. Apply collateral only to the obligations it legally supports. Establish valuation frequency, thresholds, minimum transfer amounts, eligible instruments, haircuts and dispute procedures. Describe letter-of-credit expiry, renewal, issuing-bank downgrade and drawing conditions. Ask counsel to assess enforcement and netting under the relevant law and insolvency regime.

Review both payment directions in a financial PPA. When the reference price rises above the strike, the project can owe the difference settlement. The corresponding physical-sale receipt may arrive at a different time or reflect a different location price. Treasury should test peak funding needs under those timing differences, including simultaneous margin calls. Restricted collateral should be tracked separately from unrestricted operating cash in the financing model.

For a constructed collateral test, assume replacement exposure of 10 million currency units, an unsecured threshold of 2 million and 8 million of eligible support. The support covers the amount exceeding the unsecured threshold under those assumptions; 2 million remains unsecured. A subsequent 3 million exposure increase creates a 3 million call under a variable collateral obligation before any haircut or transfer minimum. If the support is a guarantee capped at 8 million, its nominal amount does not automatically grow. The example calls for a tested mechanism governing the next valuation and posting deadline.

The lender's credit package should also identify the practical replacement route. Set out required consents, market access, attribute commitments, likely transition tasks and the evidence supporting the assumed remarketing period. Quantified replacement timing should remain a stated scenario assumption until supported. A funded bridge can then be compared with that assumption and the contractual cure calendar.

10 Specify default, termination and lender continuity

Termination review should distinguish the event permitting termination from the method for calculating the resulting amount. Define payment default, support failure, insolvency, prolonged force majeure and material performance breach separately. Examine notice, cure and dispute periods for each. Map the rights that survive termination, including confidentiality, accrued payments, certificate delivery, collateral return and unresolved settlement adjustments.

The institutional Understanding Power Purchase Agreements handbook discusses guarantor quality, liquidity support, reserve accounts and lender direct agreements, including assignment and substitution. Its state-utility and project-development examples require adaptation for a private corporate wind transaction.[10] For this paper's proposed framework, the important task is to identify which contractual right can be exercised by which entity at each stage of a distressed situation.

A replacement-value formula should state the remaining quantity profile, market reference, valuation date, discounting convention and eligible costs. It should also address illiquid periods and unavailable quotations. Require a numerical appendix showing outcomes when forward prices move in either direction. Where the parties negotiate a debt-linked floor or another protection, identify its beneficiary, exceptions, cap and interaction with ordinary replacement value. No such floor is assumed in this analysis.

Review the lender's ability to receive notice, cure a specified breach and transfer the project or contract to an eligible substitute. The buyer needs an objective standard for the substitute's operational and credit capability. The security package and direct agreement should use consistent assignment language. Local legal advice should address the enforceability of these arrangements, particularly during insolvency and security enforcement.

The liquidity case should cover the sequence from missed payment to support call, cure expiry, termination valuation and replacement collection. Use actual contractual dates and supported administrative assumptions. Test a disputed amount that remains unpaid through the next debt-service date. Decide how reserves, distribution restrictions and sponsor commitments operate during that interval. The financing memorandum should disclose the remaining shortfall if all available support is applied.

At execution, obtain the completed instruments and direct agreements. Verify beneficiary names, authorised signatures, notice addresses and expiry dates against the financing documents. The operating handover should identify the person responsible for each renewal and support test. This makes the credit analysis usable after closing and provides an auditable record when the buyer, issuing bank or guarantor changes.

Table 6. Distress mechanisms and the separate obligations they address

MechanismObligation addressedTrigger to defineTiming to testResidual exposure
Payment cureOverdue invoiceValid notice and non-paymentCure versus debt dateCash gap during cure
Support callCovered credit exposureValuation or downgradePosting and dispute deadlineUnsecured threshold
Letter-of-credit drawSpecified supported amountDocumentary drawing eventExpiry and bank processingCap and issuer risk
Termination valuationRemaining contract economicsEffective terminationQuote and expert timetableIlliquid replacement period
Lender step-inContinuation after project distressNotice and permitted cureStandstill periodUncured performance breach
Contract transferSubstitute performanceEligible transferee and consentMarket registration handoverInterim route-to-market cost

Proposed negotiation checklist. Enforceability and insolvency treatment require governing-law advice.

11 Apply the 2026 accounting changes to the actual contract

The IASB issued Contracts Referencing Nature-dependent Electricity in December 2024, amending IFRS 9 and IFRS 7 for annual reporting periods beginning on or after 1 January 2026. The scope concerns variability in the underlying electricity amount caused by uncontrollable natural conditions; application by analogy is prohibited. Specified own-use guidance considers unavoidable oversupply sales and net purchasing in the same market, using a reasonable assessment period capped at 12 months. The amendments permit a variable nominal hedged item aligned with expected nature-dependent output and retain other hedge-accounting requirements. Additional disclosures address contract features, commitments and financial effects.[11]

The UK Endorsement Board reports approval of these amendments in July 2025 and an effective date of 1 January 2026. Its project page records completion on 29 September 2025.[12] That evidence establishes the UK adoption position described by that resource. Another reporting jurisdiction requires its own adoption review.

The proposed transaction process should begin with a written accounting assessment attached to the exact contractual draft. Ask the reporting team to identify the entity applying the standard, the relevant electricity market, the nature of the quantity variability and the intended receipt or financial settlement. Prepare the supporting consumption and resale records in the same time convention used by commercial settlement. Require the assessment to state which facts would change its conclusion.

Procurement, treasury and financial reporting should review proposed contract amendments together. A change in delivery profile, net-settlement right or permitted resale may require reassessment. The financing model should separately show cash settlement, reported valuation effects and restricted collateral. Proposed covenant definitions need an explicit treatment of each. A non-cash valuation movement and a current payment obligation should appear on separate lines so that the credit committee can follow their respective consequences.

The buyer's approval paper should record the ongoing evidence burden and the responsible reporting owner. Establish a calendar for refreshing load forecasts, reconciling sales of unused electricity and reviewing commitment disclosures. Where hedge accounting is sought, document the intended relationship and obtain specialist confirmation of the required designation and testing. The amended standard supplies specific permissions and conditions; an individual contract still needs a supported accounting conclusion before that treatment enters the transaction's base case.

12 Set jurisdiction and evidence limits before debt sizing

Market access, financial regulation and attribute treatment need separate legal workstreams. NREL's procurement review explains that local policies determine available purchasing mechanisms.[1] The US CFTC/SEC 2012 definitions rule discusses the nonfinancial-commodity forward exclusion and the importance of intended physical settlement. An index used to determine price can be consistent with an otherwise qualifying physical forward.[13] This foundational US interpretation supplies a diligence question. Current rules, amendments, exemptions, counterparty status and cross-border effects require qualified review for the proposed transaction.

For a cross-border structure, prepare a jurisdiction map showing the project company, buyer, guarantor, trading market, settlement account and governing law. Ask counsel to identify necessary licences, registrations and reporting, together with the treatment of financial settlements, security and enforcement. Commission Recommendation 2026/917 identifies additional cross-zone price exposure in cross-border PPAs.[6] The commercial model should quantify that exposure separately from the legal permission to enter the contract.

Attribute rights require their own schedule. The identified 2015 GHG Protocol Scope 2 Guidance sets quality criteria for contractual instruments used in market-based reporting, including ownership and claims-related requirements. Certificates represent attributes separately from electricity.[14] The parties should obtain advice on the reporting framework and version applicable to the buyer. The 2015 source is cited by date because a revision process has been under way; no completed replacement standard is assumed here.

The proposed schedule should identify issuing registry, eligible technology, geography, vintage, transfer and retirement responsibilities, and treatment of unavailable certificates. Test curtailment, negative-price shutdown and project delay against the attribute obligation. If replacement certificates are permitted, specify their eligibility and who pays. Keep evidence of issuance, transfer and retirement with the relevant settlement records. Any environmental statement should refer to the actual instrument and supporting reporting assessment.

Before debt sizing, assemble an evidence register that separates verified documents, independent forecasts, management estimates and constructed stress assumptions. Record the author, date, units and limitation of each input. An unresolved licence, unsupported guarantee or unagreed deemed-energy definition should remain an open condition. The next stage can then quantify sources and uses, financing reserves and debt-service sensitivities against a contract whose measurable obligations, jurisdiction and remaining uncertainties are visible.

Table 7. Jurisdiction-specific evidence and the boundary of its use

SourceJurisdiction or frameworkSupported useBoundary requiring additional advice
FERC Energy PrimerUS organised power marketsLocation-price mechanicsIndividual ISO tariff and hedge eligibility
Elexon imbalance guidanceGreat Britain BSCContracted-metered settlement explanationProject service allocation and registration
Regulation 2019/943EU electricity marketBalance responsibility and redispatch rulesNational application and connection exceptions
CFTC/SEC 2012 ruleUS derivatives classificationPhysical-forward diligence questionCurrent transaction-specific classification
IASB 2024 amendmentsIFRS accountingNature-dependent contract requirementsEntity facts and local endorsement
UK Endorsement BoardUK-adopted IFRSUK adoption and effective dateOther jurisdictions' adoption
GHG Protocol 2015 guidanceIdentified reporting frameworkAttribute quality and claims assessmentApplicable version and buyer compliance

Evidence reviewed for this paper. Each proposed project requires current local confirmation.

13 Define the energy product before comparing prices

The following model is an authored hypothetical decision exercise for a 100 MW wind project. Every generation, price, cost, financing and timing input is invented for transparent arithmetic. The results contain no empirical calibration, market quotation, forecast, probability of default or generation percentile. The normal and adverse labels identify two deterministic assumptions. Each case contains four representative states of 2,190 hours, totalling 8,760 hours. These annual buckets represent generation-price combinations; their order has no chronological meaning.

Table 8 gives the complete energy and price inputs. Generation is power in MW; multiplying it by state hours produces MWh exactly once. Annual generation is 350,400 MWh in the normal case and 208,050 MWh in the adverse case. A constant 40 MW baseload commitment requires 87,600 MWh in every state, totalling 350,400 MWh. The strike is $70/MWh for every comparison. The buyer-reference price is a separate hypothetical electricity reference; no retail tariff, network charge or tax is embedded in it.

Table 8. Authored representative-state assumptions

State; hoursNormal output MWNormal node/buyer $/MWhAdverse output MWAdverse node/buyer $/MWh
A; 2,1907035 / 454550 / 62
B; 2,1905050 / 583070 / 80
C; 2,1903075 / 8015100 / 107
D; 2,19010100 / 1025140 / 144

All inputs authored hypothetical; strike $70/MWh; constant baseload 40 MW.

R=∑s[gₛnₛ + qₛ(K − rₛ)] = KQ + ∑s(gₛ − qₛ)nₛ + ∑sqₛ(nₛ − rₛ)

Equation 1.

In the equation, generated energy g earns the node price n. Contract energy q settles the difference between strike K and reference r. Pay-as-produced uses q equal to g. Baseload uses the constant commitment in each state. The node-reference version sets r equal to n; the buyer-reference version uses the separate buyer column. This financial settlement representation assumes unrestricted sale of generated power and purchase or sale of residual positions at the stated node prices. It contains no additional physical balancing obligation or delivery penalty.

Normal node spot receipts are $17.958m. PAP/node adds $6.570m of contract settlement, producing $24.528m revenue. PAP/buyer adds $3.7887m, producing $21.7467m. The difference is the generation-weighted node-to-buyer basis of $2.7813m. Baseload/node adds $1.752m to spot receipts; baseload/buyer pays $0.438m, producing $19.710m and $17.520m respectively. These cash-flow maps give the commercial team a specific question: which party funds each reference and quantity mismatch? A higher quoted strike requires recalculation through the complete map before financing implications can be assessed.

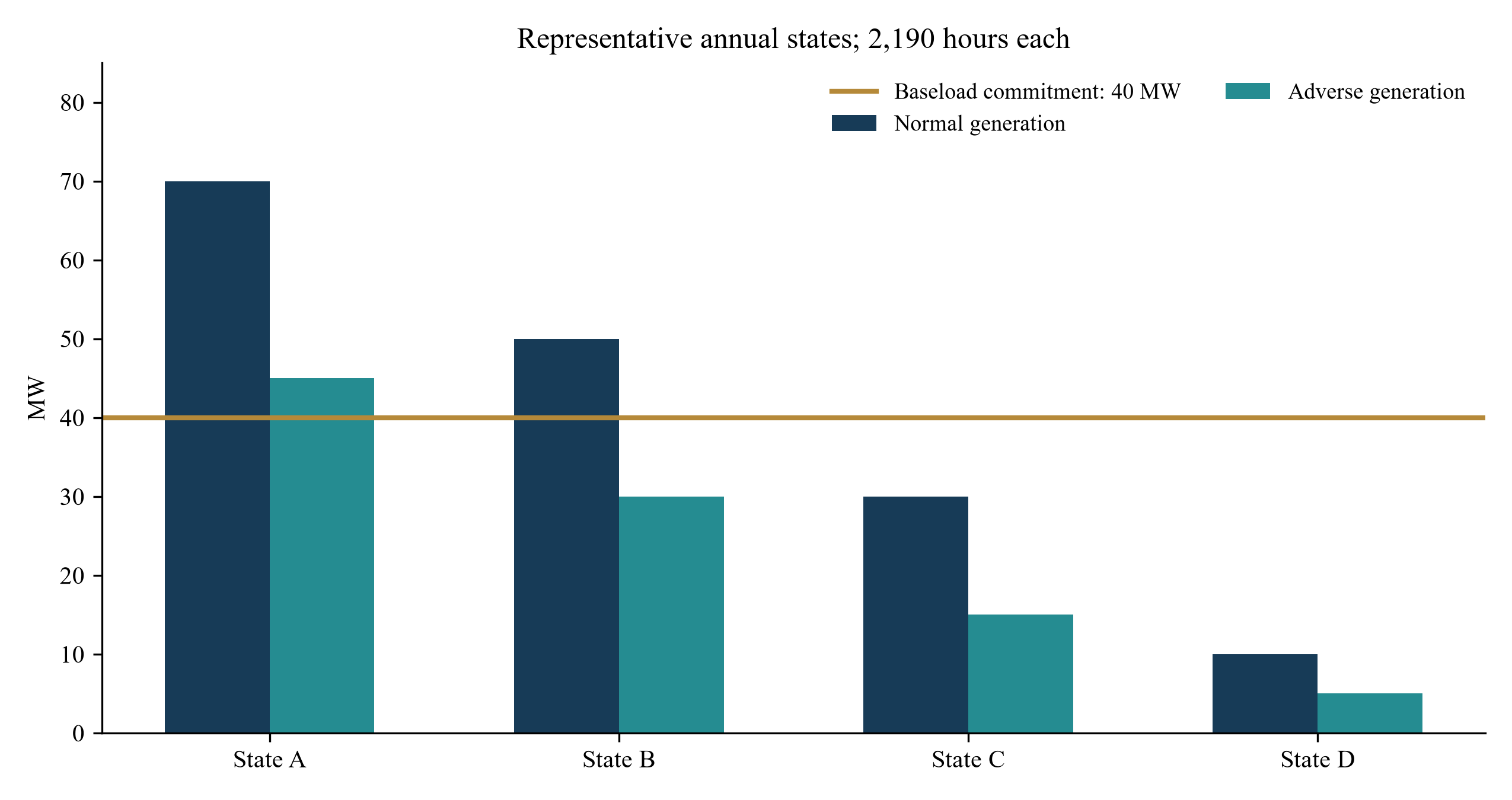

Figure 1. Generation and constant baseload commitment across representative states.
Figure 1. Generation and constant baseload commitment across representative states.
View figure at full size; scroll horizontally on smaller screens.

All inputs authored hypothetical; each state represents 2,190 annual hours. States are unordered weighted buckets and have no probability interpretation.

14 Reconcile capture, shape, volume and basis once

The time-weighted node price averages each state by its hours. The capture price weights node prices by generated MWh. Normal values are $65/MWh and $51.25/MWh respectively. Adverse values are $90/MWh and $68.9474/MWh. The hypothetical output is concentrated in lower-price states. That concentration creates a negative capture/shape term when the project promises constant baseload energy.

R = KQ + n̄(G − Q) + G(cₙ − n̄) + B; n̄ = ∑shₛnₛ∑shₛ; cₙ = ∑sgₛnₛG; B = ∑sqₛ(nₛ − rₛ)

Equation 2.

For constant-MW baseload, the equation separates strike revenue on committed quantity, aggregate generation shortfall or surplus valued at the node time price, the covariance between generation and node prices, and the contractual reference basis. The covariance is G multiplied by capture price less time price. This term already includes the capture effect; adding a further capture-rate haircut would charge the same price-generation interaction twice. Basis is weighted by contracted quantity. PAP basis therefore uses generated energy; constant-baseload basis uses committed energy.

Table 9. Exact revenue decomposition; USD million

CaseStrike on QVolumeCapture/shapeReference basisRevenue
Normal PAP/node24.528000024.5280
Normal PAP/buyer24.528000-2.781321.7467
Normal baseload/node24.52800-4.8180019.7100
Normal baseload/buyer24.52800-4.8180-2.190017.5200
Adverse PAP/node14.563500014.5635
Adverse PAP/buyer14.563500-2.1133512.45015
Adverse baseload/node24.5280-12.8115-4.380007.3365
Adverse baseload/buyer24.5280-12.8115-4.3800-2.89084.4457

Authored hypothetical; PAP strike quantity varies with generation; baseload capture is included once in shape.

The PAP rows follow the general identity in section 13: residual generated less contracted energy is zero. Their strike term changes with generation. The $9.9645m reduction in PAP/node revenue between the two scenarios is $70 multiplied by 142,350 fewer MWh. A zero residual-volume column therefore does not imply weather-independent revenue. The column represents the mismatch against contracted quantity inside each case.

Normal generation equals annual baseload quantity, yet the $4.818m shape cost remains because production and commitment differ within the states. In the adverse case the baseload volume term is negative $12.8115m and shape is negative $4.380m. Their sum equals the direct value of all residual node positions. This exact reconciliation permits negotiation of a shaping service or basis collar against an identified exposure. The exercise supplies no shaper quote, hedge availability or cost of protection; those require separate evidence.

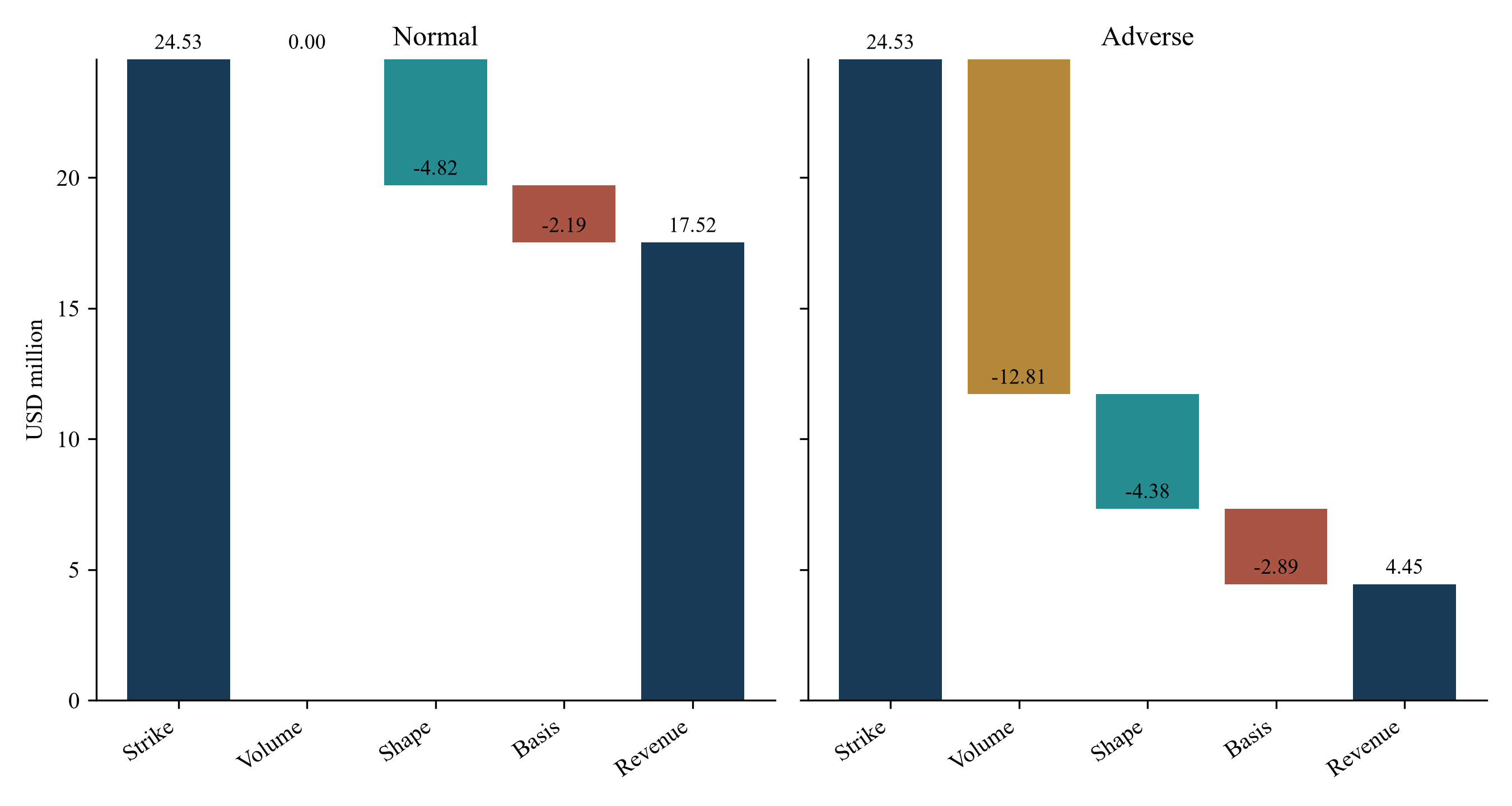

Figure 2. Exact baseload/buyer-reference revenue bridge.
Figure 2. Exact baseload/buyer-reference revenue bridge.
View figure at full size; scroll horizontally on smaller screens.

Hypothetical USD million; volume, capture/shape and reference basis reconcile once to revenue. Capture is included in shape and receives no additional haircut.

15 Trace annual cash into coverage tests

The operating calculation deducts $4m fixed annual costs and a $2/MWh variable fee from revenue. These authored assumptions cover the simplified operating boundary. Taxes, major maintenance, working-capital changes, certificate income, inflation, depreciation and negative-price suspension are absent. The variable fee is a single model charge; additional imbalance or sleeve deductions would require explicit assumptions and separate reconciliation.

C = R − O − vG; DSCR = CA

Equation 3.

Annual debt service is initially fixed at $8m so that contractual comparisons use an identical denominator. Normal operating deductions total $4.7008m; adverse deductions total $4.4161m. Table 10 presents adverse coverage at three alternative annual service amounts alongside normal and adverse CFADS. Each sensitivity changes debt service alone. It does not resize construction funding or imply that a lender offers any of those amounts.

Table 10. Operating cash and annual service sensitivities

AllocationNormal CFADS $mAdverse CFADS $mAdverse DSCR; $6m service$8m service$10m service
PAP/node19.827210.14741.6912x1.2684x1.0147x
PAP/buyer17.04598.034051.3390x1.0043x0.8034x
Baseload/node15.00922.92040.4867x0.3651x0.2920x
Baseload/buyer12.81920.02960.0049x0.0037x0.0030x

Authored hypothetical; fixed opex $4m and variable fee $2/MWh; each sensitivity changes service alone.

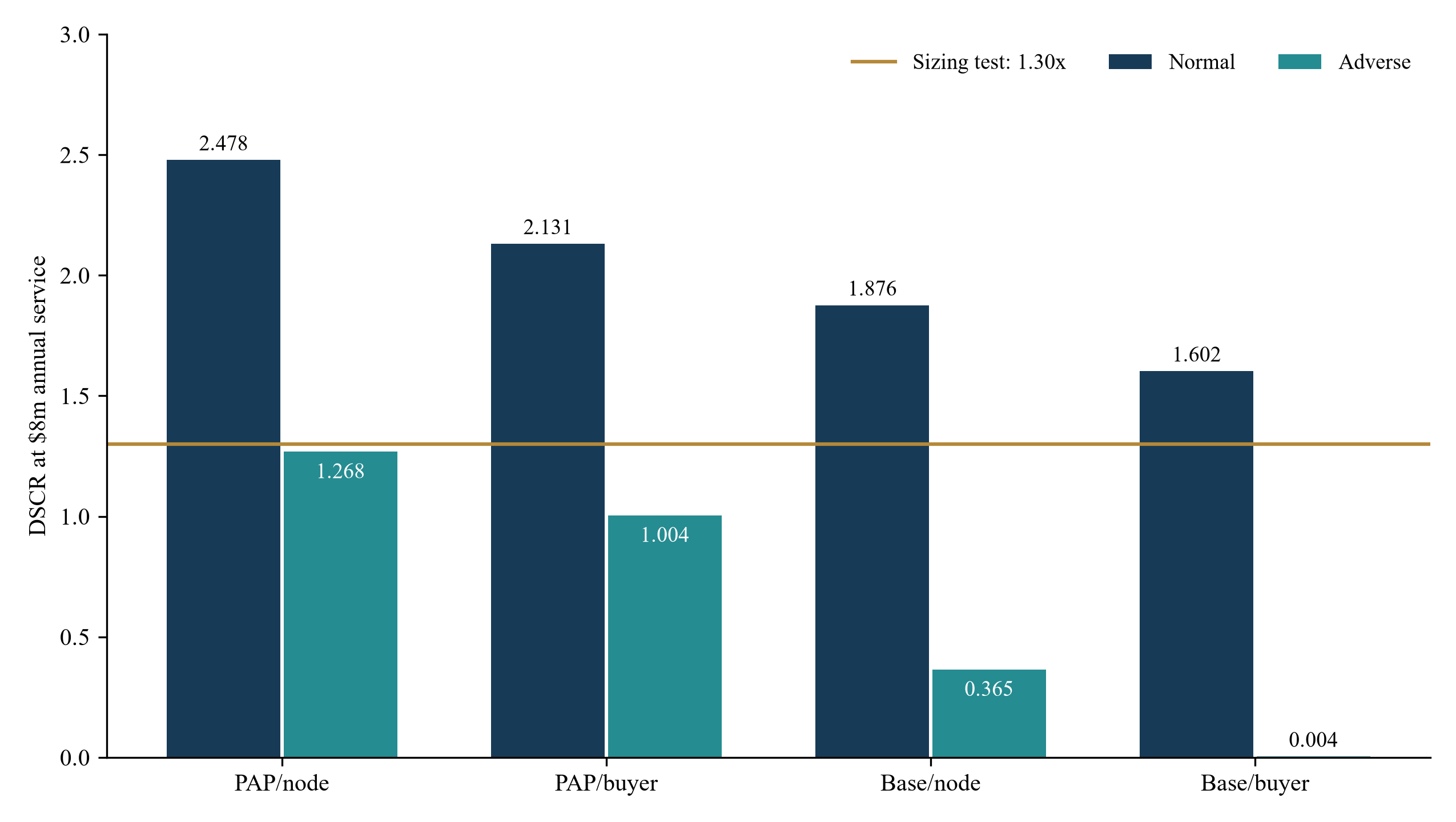

At $8m service, normal coverage is 2.4784x for PAP/node, 2.1307x for PAP/buyer, 1.8762x for baseload/node and 1.6024x for baseload/buyer. The adverse results expose the effect of selling a flatter product from a variable generator. Annual generation-price dependence is preserved in the state calculation; no independent percentage losses are added afterwards.

The baseload/buyer adverse result leaves only $29,600 before debt service. An additional $29,600 operating cost reaches zero CFADS. The model tests zero and negative CFADS separately and sets supported debt capacity to zero in both cases. A negative operating cash balance still requires funding even when no debt is raised. The debt-capacity floor does not finance operating losses. For a real decision, the sponsor would obtain interval-level production, market-access rules and executable protection terms, then test whether a volume cap, lower commitment or separately funded shaping agreement changes these cash outcomes.

Figure 3. Annual debt-service coverage across contractual allocations.
Figure 3. Annual debt-service coverage across contractual allocations.
View figure at full size; scroll horizontally on smaller screens.

Hypothetical $8m fixed annual service test; 1.30x is an authored sizing threshold. Normal and adverse are deterministic scenarios.

16 Convert coverage into reconciled sources and uses

Debt sizing uses the lesser annual CFADS from the two stated cases divided by an authored 1.30x minimum coverage ratio. The resulting constant annual service is capitalised at 6% over twelve annual end-of-year payments. The annuity factor is 8.38384394. This calculation assumes the limiting cash amount is available in every debt year. It contains no construction interest, refinancing, balloon, amortisation sculpting, debt gearing limit or change in operating performance over time.

A*=max(0, minj Cⱼ)m; F = 1−(1+i)−Ni; D = A*F; S = αA*; E = U + S − D

Equation 4.

Fixed funding uses are $120m construction expenditure plus $3m fees. Initial restricted DSRA equals half of sized annual service and is funded at closing. Equity is total uses including that reserve less debt proceeds. The reserve feedback matters: stronger cash flow supports more debt and also requires a larger initial reserve. Reserve funding is a balance-sheet use; the annual CFADS calculation contains no second reserve expense.

Table 11. Hypothetical financing and sources/uses; USD million

AllocationSized annual serviceDebt sourceEquity sourceFixed usesDSRA useTotal sources/uses
PAP/node7.80569265.44170661.461140123.0000003.902846126.902846
PAP/buyer6.18003851.81247874.277541123.0000003.090019126.090019
Baseload/node2.24646218.833983105.289248123.0000001.123231124.123231
Baseload/buyer0.0227690.190894122.820491123.0000000.011385123.011385

Conditional authored financing; 1.30x stated-case coverage, 6%, twelve years; half-year service reserve; values rounded.

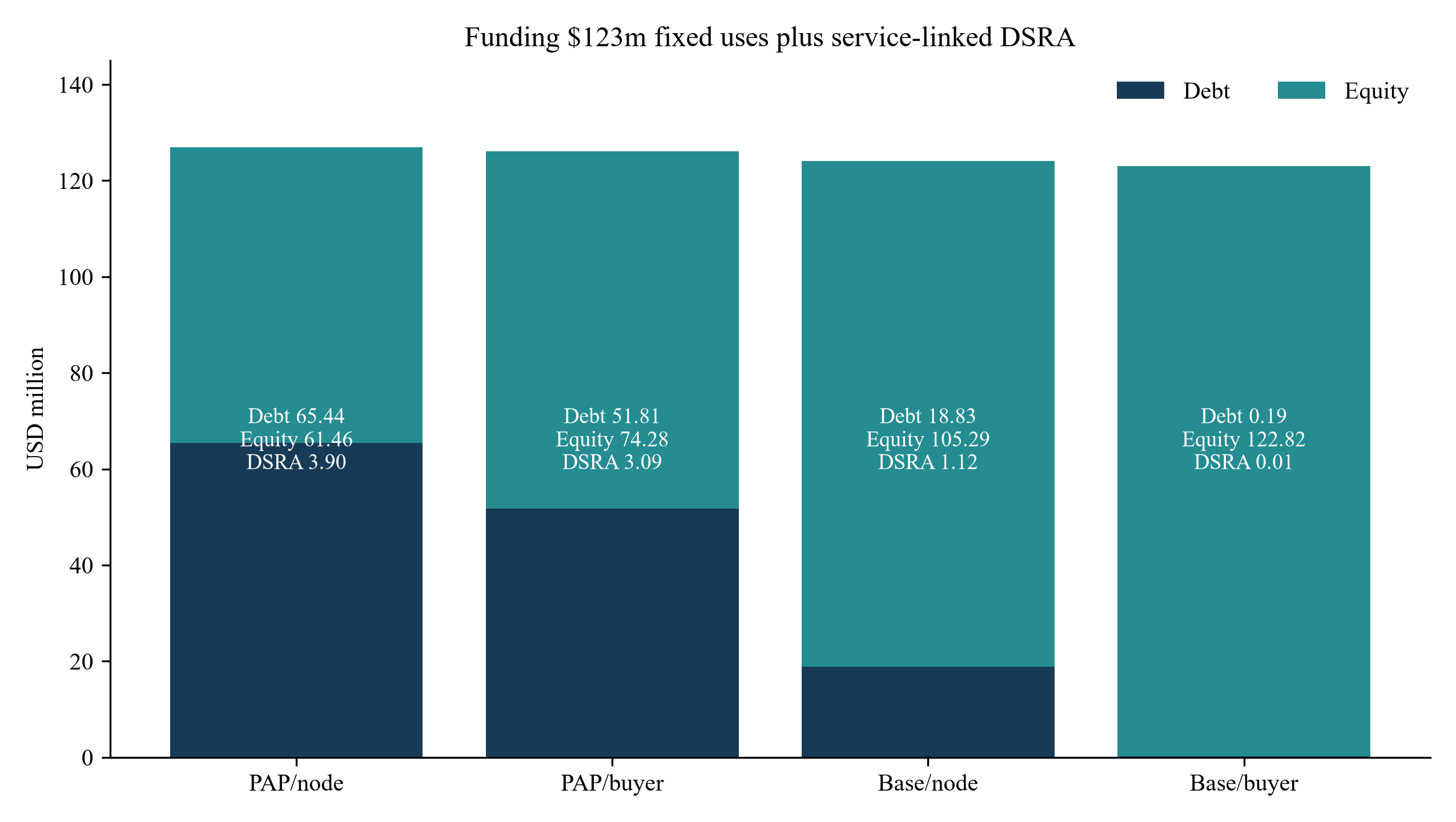

Moving from PAP/buyer to PAP/node increases illustrative debt by $13.629228m. Additional DSRA is $0.812827m, so required equity decreases by $12.816401m. The commercial value of changing the settlement reference must also consider any requested strike reduction, hedge fee, buyer pricing response and legal terms; none is supplied here. Sources equal uses for every structure before rounding.

These are conditional financing capacities under authored assumptions. The exercise does not establish a generation P90, lender downside percentile, credit rating or financing commitment. The adverse case combines lower output, higher node prices and a different reference spread through explicit vectors. Their occurrence likelihood is unspecified. An investment committee can use this table to identify funding consequences requiring evidence, while separately obtaining debt terms, technical yield analysis, tax advice, credit assessment and the enforceable collateral package.

Figure 4. Debt, equity and service-linked reserve funding.
Figure 4. Debt, equity and service-linked reserve funding.
View figure at full size; scroll horizontally on smaller screens.

Hypothetical financing; debt sized to the lesser stated CFADS at 1.30x, 6%, 12 years; fixed uses $123m plus six-month service reserve. No market debt quotation.

17 Fund the dated credit and collateral gap separately

Annual representative states cannot establish liquidity timing. A separate authored 90-day cash path runs from 1 January to 1 April 2027. It begins with $2m unrestricted cash and a separately restricted $4m DSRA associated with the original $8m service test. This opening reserve differs from the structure-specific reserves in Table 11; the liquidity example is an independent illustration. Its receipts and payments are directly specified and are not disaggregated from the annual states.

Lₜ = L₀ + ∑u≤t(Iᵤ − Pᵤ − Mᵤ + Tᵤ); W = max(0, −mint Lₜ)

Equation 5.

Table 12. Dated liquidity sequence; USD million

DateActual cash movementUnfinanced unrestricted balanceBalance with $8m bridge
1 Jan 2027Opening cash 2.02.010.0
16 JanOperating payment -0.81.29.2
31 JanOperating payment -0.8; invoice due 1.5 unpaid0.48.4
15 FebReplacement collateral -3.0; replacement fee -0.6-3.24.8
2 MarOperating payment -0.8; debt payment -4.0-8.00.0
1 AprSales receipt 2.0; collateral return 1.5; arrears recovery 0.5; operating payment -0.8-4.83.2

Independent authored cash path; same-day netting; opening restricted DSRA excluded; bridge available at opening.

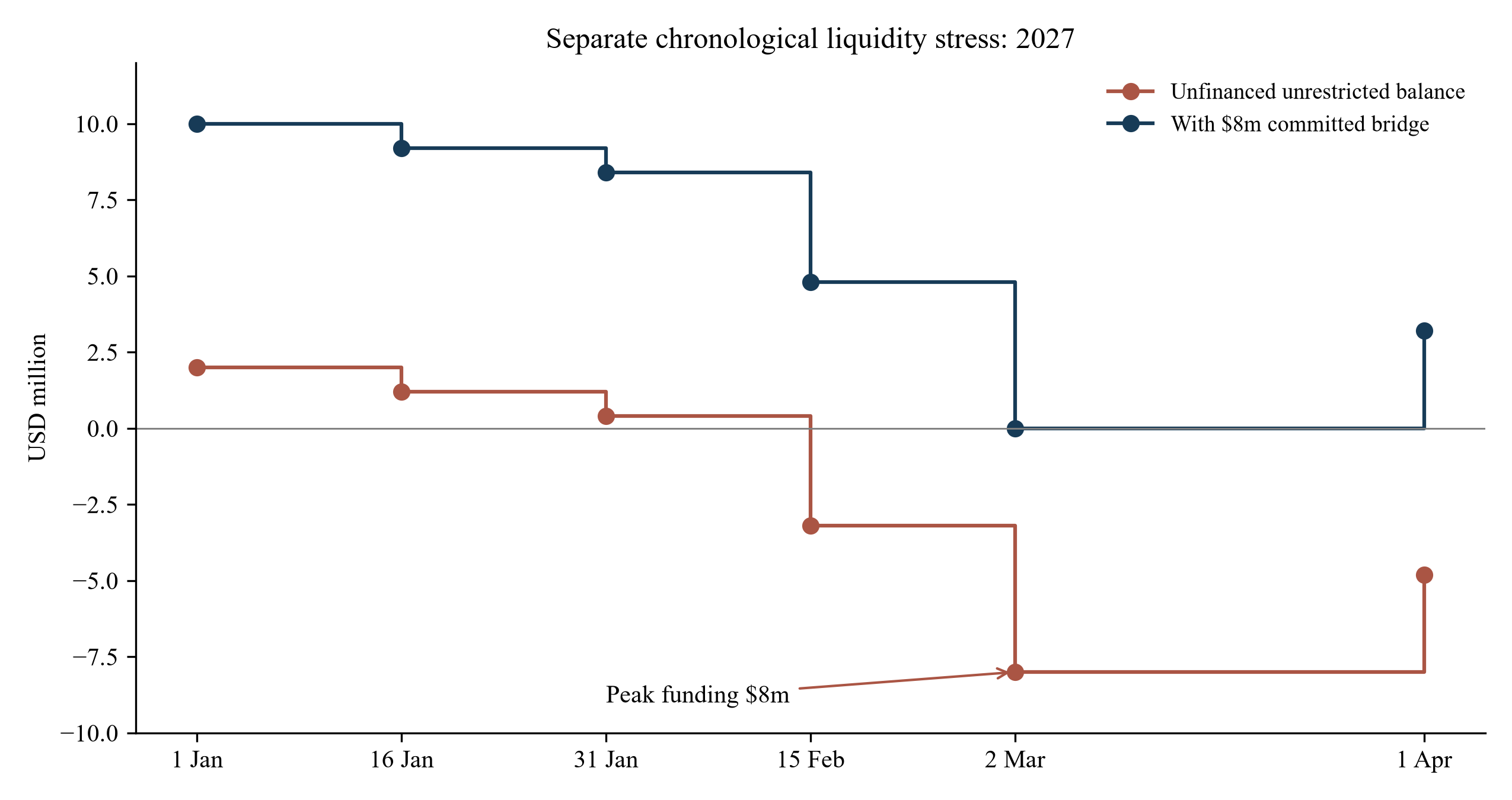

The peak unrestricted deficit is $8m on 2 March. An $8m committed bridge available at opening keeps the displayed balances non-negative and leaves $3.2m cash on 1 April. The table nets events on each date; intraday settlement restrictions could require a different amount. With an expressly permitted $4m DSRA draw against the March debt payment, the additional unrestricted funding gap falls to $4m. The reserve then requires replenishment under whatever terms apply; this exercise provides no replenishment deadline or facility pricing.

The unpaid invoice contributes zero cash on its due date. Only the $0.5m actual recovery enters receipts; $1m remains overdue. Cash collateral of $3m is restricted when posted, $1.5m returns on 1 April and $1.5m remains restricted. Posting collateral is excluded from operating expense and is not assumed to be an incurred termination loss. The separate $0.6m replacement fee is an actual cash cost in this path. No further termination claim or recovery is added.

Liquidity sources of $14.5m comprise opening cash, the bridge and $4.5m actual receipts including collateral return. Uses comprise $3.2m operating payments, $3m posted collateral, $0.6m replacement fee, $4m debt service and $3.2m closing unrestricted cash. This reconciliation supports decisions on committed facility size, collateral eligibility, invoice cure periods and lender access to reserves. It provides no buyer default probability, enforcement timetable or assurance of recovery. Those contractual and credit facts require independent diligence before any commercial commitment.

Figure 5. Separate 90-day collateral and counterparty liquidity stress.
Figure 5. Separate 90-day collateral and counterparty liquidity stress.
View figure at full size; scroll horizontally on smaller screens.

Authored hypothetical dated cash path, 1 January to 1 April 2027; initial unrestricted cash $2m. Opening restricted DSRA $4m excluded; same-day netting assumed.

18 Interpret credit support through the dated funding gap

The dated example separates three questions for the credit committee. How much unrestricted cash must be available before the next collection? Which asset remains recoverable after support is applied? What permanent cost survives replacement? The $8m peak deficit answers the first question under the stated dates. The remaining $1m receivable and $1.5m restricted collateral identify assets whose recovery or release remains unresolved. The $0.6m replacement fee is a separately specified cash cost. Treating all four amounts as an immediate economic loss would give a different calculation with unsupported assumptions.

The project should prepare a collection calendar alongside its valuation of the outstanding contract. A termination claim can have a substantial calculated amount while producing no receipt by the next debt-service date. A guarantee can support a defined claim while requiring a notice, evidence package and processing period. Each proposed receipt therefore needs a beneficiary, permitted claim, supporting document, assumed payment date and fallback if disputed. These are recommended diligence fields; their completed values depend on the executed instruments and legal advice.[10]

Consider the project and buyer exposures jointly when negotiating collateral. In the constructed annual adverse case, higher reference prices increase the fixed-volume settlement payment while lower production reduces physical-sale receipts. If its separate support arrangement also requires cash margin, treasury needs both obligations on the same dated schedule. The two scenario vectors establish this mechanism for the constructed case. They supply no evidence about the likelihood of a buyer downgrade, a margin call or simultaneous events in a particular market.

Support can be compared through its usable cash timing. For a proposed letter of credit, ask the issuing bank and counsel to verify the beneficiary, draw documents, availability period and covered amounts. For a guarantee, review the supported obligations, cap, defences and enforcement route. For cash security, identify the account holder, permitted investments, withdrawal conditions and release test. An instrument's face amount should enter the financing case only to the extent that its assumed use is consistent with those reviewed terms.

The optional DSRA draw in the liquidity example illustrates a funding choice requiring lender permission. Drawing $4m against the March payment reduces the immediate additional funding requirement to $4m and exhausts that specified reserve. A replenishment obligation remains open. A distribution decision made after the draw should therefore consider upcoming receipts, operating payments and the agreed reserve-restoration calendar. The example provides no available revolving facility, permitted reserve draw or sponsor commitment for a real project.

19 Reconcile accounting judgements with financing definitions

Section 11 describes the identified IFRS amendments and their scope. The transaction team should connect the resulting accounting assessment to the financing documents through an explicit reconciliation. Three records are needed: the financial-reporting assessment, the contract's cash-settlement schedule and the lender's defined cash-flow calculation. Their purposes and measurement dates should be stated in the approval package. An accounting conclusion requires the reporting entity's facts and applicable framework.[11,12]

For each proposed covenant, ask the lender and reporting team to work through a sample reporting period using identical transactions. Show collected market receipts, corporate settlements, unpaid invoices, disputed claims, cash margin and reserve movements. Record the contractual treatment of each within CFADS, permitted debt, minimum liquidity and distribution tests. A disagreement over classification should remain an open drafting item until the relevant parties approve the definition. This is a recommended financing-control process; it supplies no universal covenant treatment.

The model's CFADS boundary deliberately excludes initial reserve funding and cash collateral. Those items appear in separate funding reconciliations. A real facility may use additional deductions or eligibility restrictions. Before comparing its quoted coverage ratio with Table 10, reproduce the facility's numerator and denominator. Check the treatment of capital maintenance, tax, working capital, fees, interest hedges and any contingent payments. A nominally identical minimum ratio can correspond to a different permitted debt amount when those definitions change.

Maintain a change log from the approved contract to the reporting and financing cases. A change in quantity profile, settlement point, payment lag or credit support should trigger a documented assessment by the relevant owner. Attach the resulting model version and approvals to the executed amendment. This creates a record of why the reported position and funding requirement changed. Any claimed financing improvement should identify the cash effect, financing constraint and additional cost.

20 Build a settlement record that supports human review

The proposed operating design starts with interval records that can be reproduced from their source. Each record should contain the production meter identifier, interval start and end, timezone, generated MWh, contracted MWh, physical price, reference price, strike and applicable exclusion flag. Keep units explicit. A price stored per kWh and a quantity stored in MWh require a visible conversion before multiplication. Preserve original source values when corrected market data or meter revisions arrive.

A reconciliation should connect those records to the invoice and bank receipt. Calculate the physical-sale leg and corporate settlement separately, then apply the agreed fees and adjustments. Record the responsible reviewer and evidence for every manual override. A late receipt should update the cash record without rewriting the original due date. A collateral transfer should update both unrestricted cash and the relevant restricted balance. These are proposed controls for a transaction team to implement and test.

Table 13. Proposed settlement and funding control record

RecordRequired reconciliationReview ownerException to escalateRetained evidence
Metered outputOriginal and corrected interval MWhOperationsMissing interval or changed meterMeter statement and revision log
Market pricePublisher, location and intervalCommercial settlementMissing or revised referencePublished price extract
PPA invoiceQuantity, strike and index calculationFinanceDisputed fee or excluded outputCalculation and signed clause
Bank receiptDue amount against cleared cashTreasuryLate or partial paymentBank record and collection notice
Credit supportExposure against eligible supportCredit and legalExpiry, cap or disputed valuationInstrument and valuation record
Restricted cashPosting, return and balanceTreasuryUnauthorised use or delayed releaseAccount statement and consent

Recommended operating design. Contractual deadlines, tolerances and signatories require project-specific approval.

AI-assisted review can be evaluated within this record design as a proposed workflow. A document model could suggest the clause associated with an exclusion, identify inconsistent names across instruments or flag an invoice whose reference differs from the approved schedule. Every suggestion should retain the supporting text, document version and calculation input for human verification. This paper has tested no AI system and claims no accuracy, productivity improvement or realised savings from its use.

Arithmetic should remain in a reproducible calculation with explicit inputs. A reviewer should be able to recalculate an invoice without relying on a generated explanation. Before any proposed automation affects payments or notices, test normal, missing-data, revised-price, negative-price and disputed-invoice examples against approved expected outputs. Set access permissions, approval limits and a manual fallback. A model-generated interpretation should enter the operative rule set only after a qualified reviewer approves the underlying contractual meaning.

The same records support financing surveillance. Compare actual and assumed payment lags, amounts under dispute, collateral restricted and the remaining service term. Investigate an unexplained difference before changing the debt forecast. A useful monitoring report would identify the affected cash date and the decision required, with a link to the source record. No threshold or automated enforcement right is assumed by this proposed architecture.

21 Translate the financing structure across markets

The analytical identities in sections 13 to 17 can organise a transaction review wherever the relevant cash flows can be defined. Their numerical inputs and assumed trading permissions need local validation. The model assumes generated energy can be sold at the specified node price and a residual position can be valued at that price. A project whose market access, contract quantity or settlement mechanism differs needs a revised representation before these results are used. Procurement-policy and market-design references explain why available routes differ.[1,2,3,4]

Prepare the local version by tracing an actual unit of output and its associated payment. Identify the legal seller, market participant, price publisher, balancing party and recipient of any compensation. Obtain the relevant tariff, connection agreement, market registration and supply documents. Then map the corporate payment obligation onto that physical route. A reference described commercially as a hub may require a specific published definition, while a buyer-location reference may exclude parts of the retail bill. The modelling team should use those actual definitions.

Next, test the legal entity and jurisdiction connections. A project company, corporate buyer, guarantor and collateral bank can operate under different laws. Ask the appointed advisers to address permissions, classification, security and enforcement for the complete arrangement. An opinion on the governing-law contract does not by itself supply findings on a foreign guarantor or market-access licence. Record the scope of each opinion and the unresolved dependencies in the closing register.[10,13]

The financing case should also preserve its currency boundary. The present example uses one hypothetical US-dollar unit of account for all prices, costs and debt. It supplies no exchange-rate exposure. If physical receipts, the PPA, collateral and debt use different currencies, create a dated conversion schedule and identify the responsible hedging party. Obtain executable terms for any hedge before treating its benefit as committed. Include its collateral and termination requirements within the same funding analysis.

Environmental claims require a separate evidence chain linking eligible production, the contractual attribute entitlement and the buyer's reporting assessment. Use the identified reporting version and relevant registry rules. Record what happens when energy is curtailed, excluded or replaced. A financially settled MWh should not enter an environmental claim solely because it appears in the revenue calculation. The relevant attribute and reporting requirements need their own confirmation.[14]

22 Decide with a contract-to-funding approval record

The investment committee should receive alternatives calculated on a common scope. For the constructed case, the four alternatives use identical strikes, operating assumptions and financing methodology. Their differences arise from quantity obligation and settlement reference. A proposed transaction may quote different prices, fees, collateral thresholds or delivery terms for each alternative. Enter those differences explicitly before comparing required equity, liquidity and retained exposure. The available examples establish conditional results for their stated inputs.

Request a commercial comparison showing the benefit being purchased in each proposed clause. A lower fixed-volume commitment can reduce shortfall exposure; a node-based reference can change basis allocation; a shaping service can exchange a defined fee for specified coverage. Each change needs its revised price, exclusions, provider support and replacement terms. Recalculate both the annual financing case and dated cash schedule. A negotiated improvement is financeable only to the extent accepted in the reviewed financing terms and supported by the remaining evidence.

Table 14. Proposed investment-committee decisions and evidence

DecisionEvidence requiredFunding consequence to calculateCondition remaining if absent
Select quantity profileInterval output and executable product termsResidual purchases and CFADSProduct remains provisional
Select settlement referenceVerified index and physical-sale routeBasis and reference fallbackLocation exposure unresolved
Accept corporate supportReviewed obligor and completed instrumentsRecoverable amount and cash timingSupport benefit excluded
Approve debt caseAgreed definitions, tenor and downside methodologyDebt, reserves and equityFinancing capacity conditional
Approve liquidity facilityDated cash schedule and committed availabilityPeak funding and replenishmentFunding gap remains open
Authorise closingExecuted contracts and scoped opinionsFinal sources and usesDrawdown remains conditional

Decision record for project-specific approval; the paper provides no finding that any condition has been satisfied.

Conditions precedent should identify the document, responsible party, reviewing adviser and required completion date. Typical items to investigate include the executed PPA, market-access and balancing agreements, credit instruments, direct agreements, metering procedures and required approvals. The actual facility and legal advisers determine the applicable conditions. Keep an unresolved item visible through the drawdown process. A signed commercial term sheet supplies no evidence that the associated collateral has been issued or a required registration completed.

Before closing, reproduce a sample invoice from the executed schedules and reconcile the final model to the agreed debt and equity sources. Identify the cash account for every restricted amount. Confirm the first service payment and notice calendars, then assign operational responsibility for subsequent tests. The handover should include the current contract versions and an escalation route for data, payment and support exceptions. Proposed control owners should accept their responsibilities explicitly.

After closing, monitoring should compare realised cash with the mechanism used to finance it. Distinguish production variation, reference-price movement, invoicing error, disputed entitlement and collection delay. Their remedies involve different parties and documents. Update the dated funding schedule when a material receipt or support call moves, and test any proposed distribution against the agreed financing conditions. This is a recommended management process; its effectiveness and financing permissions require verification in use.

23 Conclusion

Wind PPA financing depends on the contractual transformation from generated energy to usable project cash. The proposed framework links the quantity promise and reference price to annual coverage, funding uses and the timing of collections. Each exposure needs a defined measurement, an allocated obligation and a supported assumption about the cash that remains available.

The constructed comparisons quantify the effect of four product and reference combinations. In the stated adverse case, supported debt ranges from approximately $0.191m for baseload/buyer settlement to $65.442m for PAP/node settlement under the specified annuity method. These values depend entirely on the authored assumptions and financing boundary. The separate cash path requires $8m of additional unrestricted funding before a permitted reserve draw. It demonstrates why an annual capacity calculation needs a separate dated liquidity review.

Sponsors, buyers and lenders can use the framework to identify the evidence required for a proposed allocation. Obtain the executable product terms, local market permissions, independent generation analysis and completed support package. Then reconcile settlement, financing and operational controls using the same contract and input versions. The resulting record gives the committee a defined basis for approving the remaining exposure and funding requirements.

24 Limitations and further testing

The numerical exercise uses four representative annual states and two deterministic scenarios. The states have equal hours and no chronological sequence. Their generation and price vectors, operating costs, interest rate, minimum coverage and funding uses are authored hypothetical inputs. They are not observations, market quotes, forecasts, technical yield percentiles or lender terms. No scenario probability, statistical dependence estimate, default probability or empirical valuation conclusion can be drawn from them.

The debt calculation assumes a constant limiting annual CFADS amount and twelve annual payments. It omits taxes, inflation, major maintenance, working-capital movements, gearing limits, interest hedging, sculpted amortisation and refinancing. It also omits construction interest and project delay. The reported capacity therefore applies solely to the simplified financing definition. A real transaction needs a dated project model and the proposed facility's actual terms.

The independent liquidity illustration specifies dates, cash movements, an opening reserve and assumed partial recoveries. It does not derive daily receipts from the annual energy states. Events within each date are netted. Actual intraday timing, support eligibility, enforcement delays, insolvency treatment and reserve permissions remain project-specific questions. The remaining overdue receivable and restricted collateral carry no assumed recovery value or release date beyond the explicitly stated receipts.

Public institutional references establish identified market mechanisms, historical contracting context and stated regulatory or accounting provisions. They do not confirm the permissions, tax treatment, environmental claims, credit quality or enforceability of any proposed transaction. The EU recommendation is policy guidance within its identified scope. The US definitions reference is foundational and requires current specialist review. The environmental guidance is cited by its identified version; subsequent developments require checking before use.

Further research could test the proposed decomposition against timestamp-aligned project generation, actual market prices, buyer load and executed clauses, with the necessary permissions and confidentiality protections. A statistical exercise would need a stated sampling period, data-cleaning rules, out-of-sample assessment and treatment of market changes. Any future AI-assisted operating workflow would need separate performance and control testing. This paper supplies the analytical structure and reproducible hypothetical comparisons; it reports no completed empirical validation of those extensions.

References

  1. National Renewable Energy Laboratory. Policies for Enabling Corporate Sourcing of Renewable Energy Internationally: A 21st Century Power Partnership Report. 2017. NREL/TP-6A50-68149, printed pp. 12-13. https://www.nlr.gov/docs/fy17osti/68149.pdf
  2. Federal Energy Regulatory Commission. 2024 Energy Primer: A Handbook of Energy Market Basics. 17 January 2024. Printed pp. 69-71. https://www.ferc.gov/sites/default/files/2024-01/24_Energy-Markets-Primer_0117_DIGITAL_0.pdf
  3. Elexon. Imbalance Pricing. Undated live guidance; accessed 11 October 2026. https://www.elexon.co.uk/bsc/settlement/imbalance-pricing/
  4. European Parliament and Council. Regulation (EU) 2019/943 on the internal market for electricity. 5 June 2019; consolidated text 16 July 2024, Articles 5 and 13. https://eur-lex.europa.eu/legal-content/EN/TXT/PDF/?uri=CELEX:02019R0943-20240716
  5. ACER. Progress of EU Electricity Wholesale Market Integration: Monitoring Report 2025. 2025. Pp. 19-20, Figures 6-7. https://www.acer.europa.eu/sites/default/files/documents/Publications/ACER-2025-Electricity-market-integration.pdf
  6. European Commission. Commission Recommendation (EU) 2026/917 on removing barriers to the development of power purchase agreements and other energy purchase agreements. 22 April 2026; Official Journal 24 April 2026. Recitals 9-10 and recommendations 5-10. https://eur-lex.europa.eu/legal-content/EN/TXT/PDF/?uri=OJ:L_202600917
  7. ACER. Power Purchase Agreements (PPAs). Undated official resource; accessed 11 October 2026. Assessment and PPA Templates. https://www.acer.europa.eu/electricity/market-monitoring/ppas
  8. European Investment Bank / European Investment Advisory Hub; report prepared by Baringa. Commercial Power Purchase Agreements: A Market Study including an assessment of potential financial instruments to support renewable energy Commercial Power Purchase Agreements. Published 17 March 2022. https://advisory.eib.org/files/publications/attachments/commercial-power-purchase-agreements.pdf
  9. European Investment Bank. Pan-EU Power Purchase Agreement Guarantee LE. Project 20250202; released 5 May 2025, approved 19 June 2025. https://www.eib.org/en/projects/all/20250202
  10. Commercial Law Development Program, African Legal Support Facility and institutional partners. Understanding Power Purchase Agreements. Version 1.3; n.d. Credit support pp. 72-85; direct agreements pp. 160-163. World Bank-hosted copy accessed 11 October 2026. https://ppp.worldbank.org/sites/default/files/2021-09/Understanding_Power_Purchase_Agreements.pdf
  11. International Accounting Standards Board. Contracts Referencing Nature-dependent Electricity: Amendments to IFRS 9 and IFRS 7. December 2024, issued 18 December 2024. IFRS 9 paragraphs 2.3A-2.3B, B2.7-B2.8, 6.10.1-6.10.2 and 7.1.15; IFRS 7 paragraphs 30A-30C. https://www.ifrs.org/content/dam/ifrs/publications/amendments/english/2024/iasb-2024-3-crne-ifrs7-ifrs9.pdf
  12. UK Endorsement Board. Contracts Referencing Nature-dependent Electricity. Project completed 29 September 2025; effective date 1 January 2026. https://www.endorsement-board.uk/projects/contracts-referencing-nature-dependent-electricity/
  13. Commodity Futures Trading Commission and Securities and Exchange Commission. Further Definition of Swap, Security-Based Swap, and Security-Based Swap Agreement; Mixed Swaps; Security-Based Swap Agreement Recordkeeping. 13 August 2012. 77 FR 48207-48366, Part II.B.2. https://www.cftc.gov/LawRegulation/FederalRegister/FinalRules/2012-18003.html
  14. World Resources Institute / World Business Council for Sustainable Development. GHG Protocol Scope 2 Guidance: An amendment to the GHG Protocol Corporate Standard. 2015. Chapter 7, Table 7.1. https://ghgprotocol.org/sites/default/files/2023-03/Scope%202%20Guidance.pdf

About the Author

Chennakeshav (CK) is a corporate finance and investment banking executive with 25+ years of global experience in deal origination, structuring and execution across M&A, growth capital and corporate strategy. He has led value-creation mandates for founders, corporates and funds — bridging the boardroom view to hands-on execution and close.

His career spans Morgan Stanley, HSBC, Lloyds Banking Group, EWEC, ADQ portfolio companies and Emirates Growth Fund, across TMT, real estate, fintech, deeptech, cleantech, infrastructure and energy. He has partnered with C-suite leaders, private equity and venture funds, sovereign wealth funds and family offices to finance complex fund raises and scale-up ventures, and has led M&A due diligence, post-merger integration and business-transformation initiatives to create value.

At Matchpoint Partners he is Managing Partner, leading the firm's corporate finance, M&A and capital-raising practice. He holds an MBA from London Business School, an engineering degree from VTU and a Master of Laws (LLM, in progress) from UCL London.

An active start-up mentor, CK mentors at Techstars, DIFC FinTech Hive, Startup Grind, Founder Institute and IN5, serves as Entrepreneur Mentor in Residence (EMiR) at London Business School, and judges the Entrepreneurship World Cup.

https://www.linkedin.com/in/ckadya/

https://www.matchpoint-partners.com/team/ck-adya.html

Disclaimer

This paper is part of a continuing series on the structure of private and alternative markets. The views expressed are the author's own. The paper is for information only, describes market structure in general terms, and does not constitute investment, legal, tax or regulatory advice or a recommendation in respect of any security, vehicle or counterparty.

Questions, answered

Who Carries the Wind Shape? Basis, Volume and Credit Risk in Corporate PPAs: frequently asked questions

The project's total revenue still depends on eligible generation. In the hypothetical same-node fixed-strike case, each generated MWh earns the strike before costs. Lower output reduces aggregate revenue. The buyer separately retains a procurement shortfall when contracted production falls below its load.

Equal annual generation and contracted MWh can conceal interval differences. A project may sell surplus production during cheaper intervals and fund shortfalls during more expensive intervals. The worked model measures this interaction using matched generation and price states.

Basis is the difference between the price used to monetise physical energy and the PPA settlement reference, weighted by contracted energy. Pay-as-produced uses generated energy for that weight. The constant-baseload contract uses its promised interval quantity.

They are conditional calculations using two authored scenarios, a 1.30x coverage minimum, twelve annual payments and a 6% interest rate. No lender commitment, generation probability or empirical downside percentile is supplied. Actual financing requires the project's evidence and executable facility terms.

They restrict cash and create funding uses under the stated assumptions. Posting collateral is separately tracked from operating expenses and permanent replacement costs. The initial reserve increases financing uses, and an authorised draw can reduce an immediate liquidity gap while leaving a replenishment obligation.

The proposed approval record includes the executed quantity and settlement schedules, market-access route, independent generation analysis, reviewed obligor and support instruments, scoped legal and accounting assessments, agreed debt definitions and a dated liquidity plan. Unresolved items remain explicit conditions.

This publication is general information for professional audiences. It is not investment, legal or tax advice, and it is not an offer or solicitation. Readers should verify current legal, regulatory and tax requirements with qualified advisers.

Apply this insight to a live decision

Discuss the financing, capital allocation or transaction implications with a Matchpoint partner.

WhatsApp
